TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen

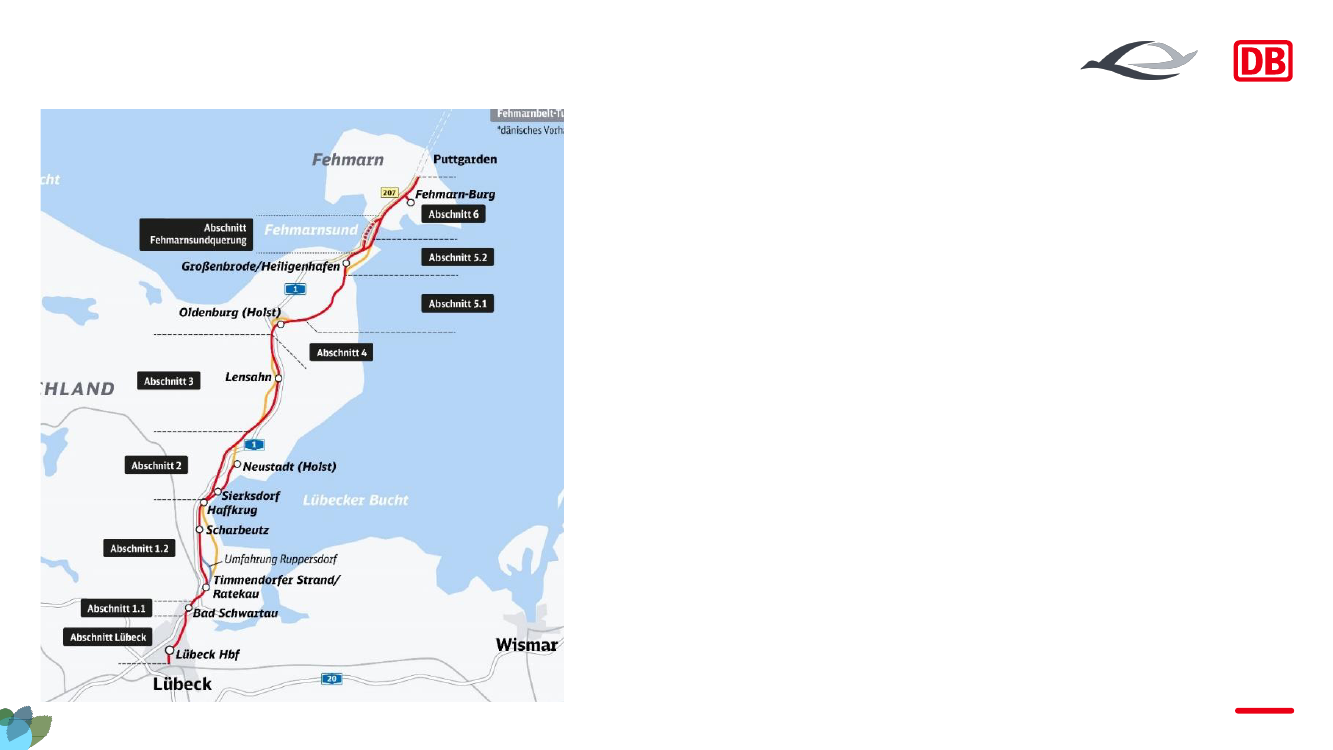

New connections between Denmark and Germany
The German rail link as part of a bigger picture
In September 2008 Denmark and Germany signed a
State Treaty to build a fixed link over the Fehmern
Belt
o
Germany has pledged to provide an efficient road-
and rail connection on the German side
Current situation between Lübeck and Puttgarden:
88 km, one track, not electrified
Maximum speed: 140 km/h
Average speed: ca. 100 km/h
Project scope:
2 tracks, electrified route with maximum speed of
200 km/h
55 km new tracks
10 sections
Opening together with the Fehmarnbelt-Tunnel
Source: Femern A/S
DB InfraGO | 23 September 2024
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen
160 km of new tracks are just the beginning
Key figures of the construction project
More than
80 new
bridges
7 new railway
stations
Adjustment and renewal
of
5 motorway
connections
More than
40 km
noise protction walls
Equipped with
European Train Control
System (ETCS)
Extensive measures for
compensation, species
conservation and
environmental protection
… und
many more
DB InfraGO | 23 September 2024
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen
The long journey from the state treaty to construction start
Now we are picking up speed!
2010-2014:
Result og regional planning procedure:
55 km newly build tracks, bypass Bay of Lübeck,
Oldenburg i.H. and Großenbrode
2013:
Extended project scope with commisioning of a
new Fehmarnsound crossing based on heavy weight tests
in 2010
2020:
Immersed tunnel as the result of the comparison
of variants in combination with the existing bridge for
slow traffic
2017
2020:
Parliamantary consultation and resolution
summing up to 232 Mio. Euros extra for designated
measures
Since 2020:
Integration of the parliamentary resolution
in the approval documents, incl. consultation with
Eisenbahn-Bundesamt und hearing agency
Additional noise protection
Additional protection against
vibration
Changes in alignment
DB InfraGO | 23 September 2024
4
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen
Acceleration measures to stabilize the time schedule
Goal: Realization of all 10 sections by opening of the FBFL
In December 2022, the Federal Ministry of Transport (BMDV)
decided to accelerate the planning in certain sections of the
project
The measures is to compensate delays due to the later inclusion
of a new Fehmarnsound crossing into the existing planning and
necessary new planning, resulting from the Bundestag decision in
2020.
2 measures are therefore currently implemented in the project:
1)
Railway Partnership Model (Partnerschaftsmodell Schiene)
DB project team, planning and construction companies are
brought together early and work together to ensure rapid
implementation and efficient construction
resemblance
with Design and Build approach
2)
Optimized plan approval procedure
Shared committment with federal authority
Eisenbahn-
Bundesamt
to cut the time in which approvals are issued
in half
DB InfraGO | 23 September 2024
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen

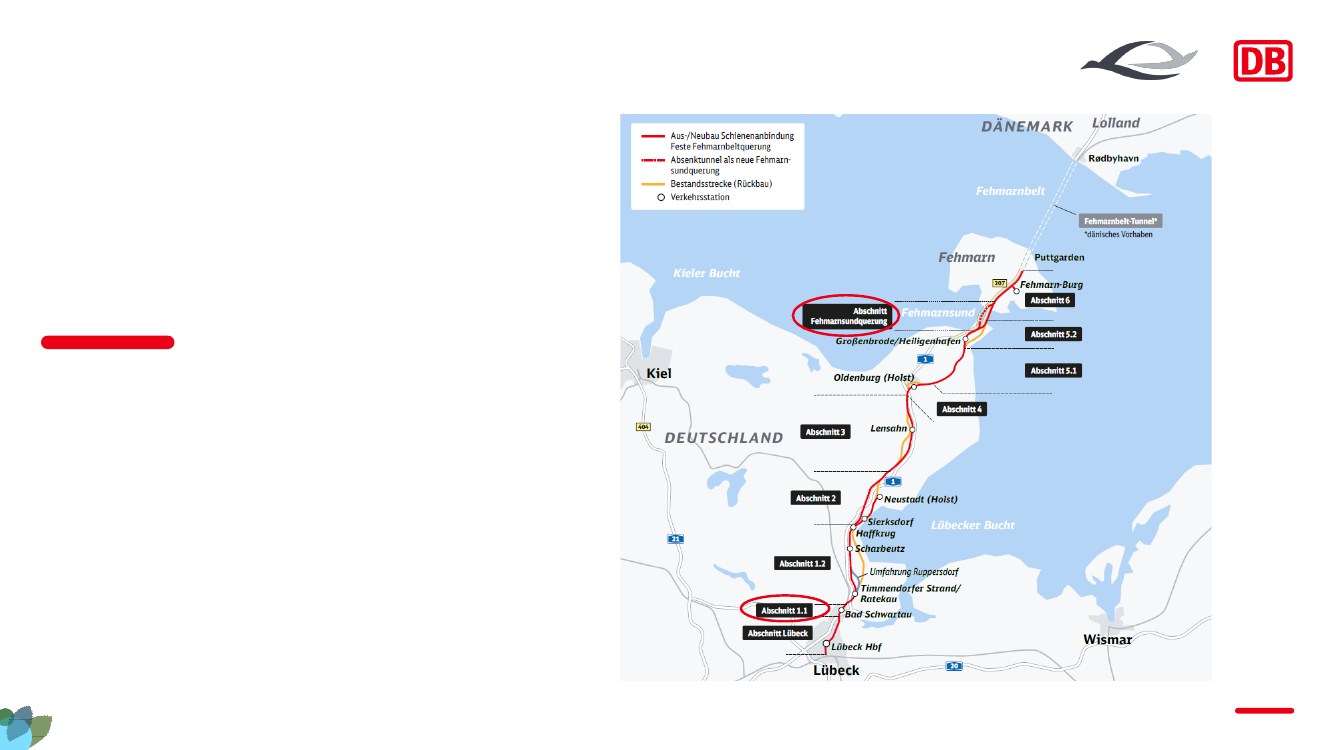

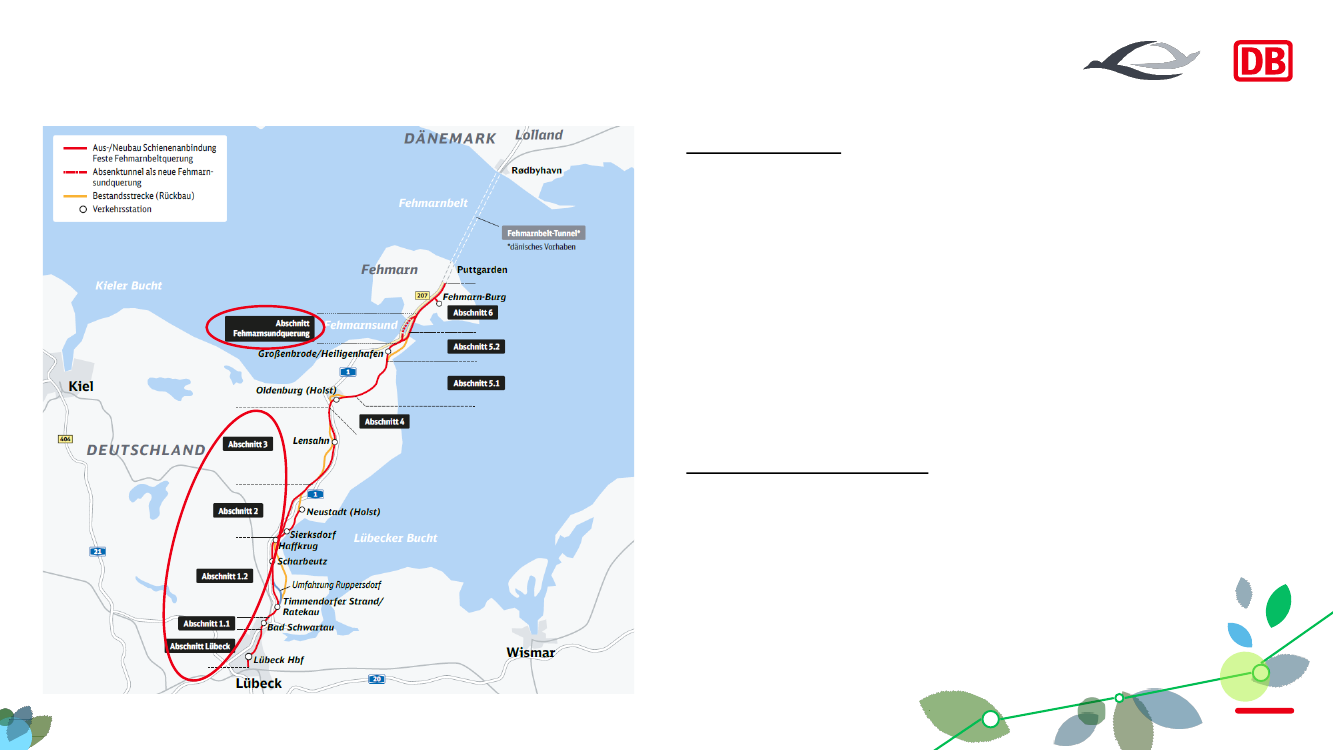

Six sections will be implemented in this model
Split up into two alliances
Alliance South:
Market dialogue took place on July 4th 2023; tendering
took place, assessment centres currently running,
contracts to be awarded in October
Section
Section
Section
Section
Section
Lübeck
1.1 Bad Schwartau,
1.2 Ratekau to Haffkrug,
2 Sierksdorf to Altenkrempe
3 Schashagen to Damlos
Alliance Fehmarnsound
Market dialogue took place on April 8th 2024,
preparation of tender documents underway
Section Fehmarnsound crossing
DB InfraGO | 23 September 2024
6
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen

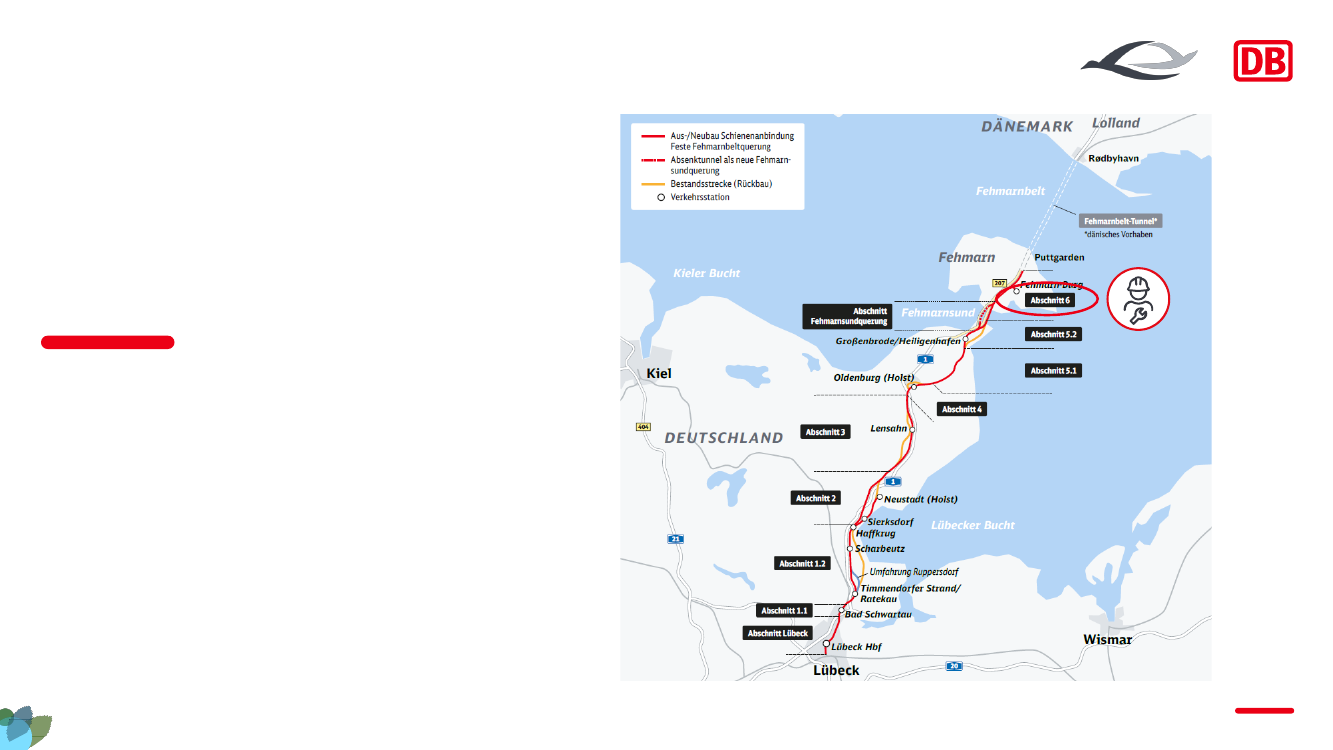

Moving forward: Status of the sections (September 2024)
Section under construction
6 (Fehmarn):
Since December 2023
Sections in approval procedure
5.2 (Großenbrode):
Hearing in June 2024,
approval awaited in Q4 2024
5.1 (Heringsdorf, Neukirchen):
Hearing phase started on 9th
September 2024
4 (Oldenburg i.H. /Göhl):
Hearing in November 2024
3 (Altenkrempe, Lensahn):
Second round of hearing phase in
Q1 2025
Lübeck:
Currently in hearing phase
Sections in planning phase
2 (Sierksdorf, Neustadt i.H.):
Hearing phase starts in October
2024
1.2 (Ratekau-Haffkrug):
Hearing phase starts in Q1 2025
1.1 (Bad Schwartau):
Hearing phase starts in Q1 2025
Fehmarnsound crossing:
Hearing phase starts in Q2 2025
DB InfraGO | 23 September 2024
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen
Focus topics
Section 1.1 (Bad Schwartau)
Section FSQ (Fehmarnssound crossing)
DB InfraGO | 23 September 2024
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen

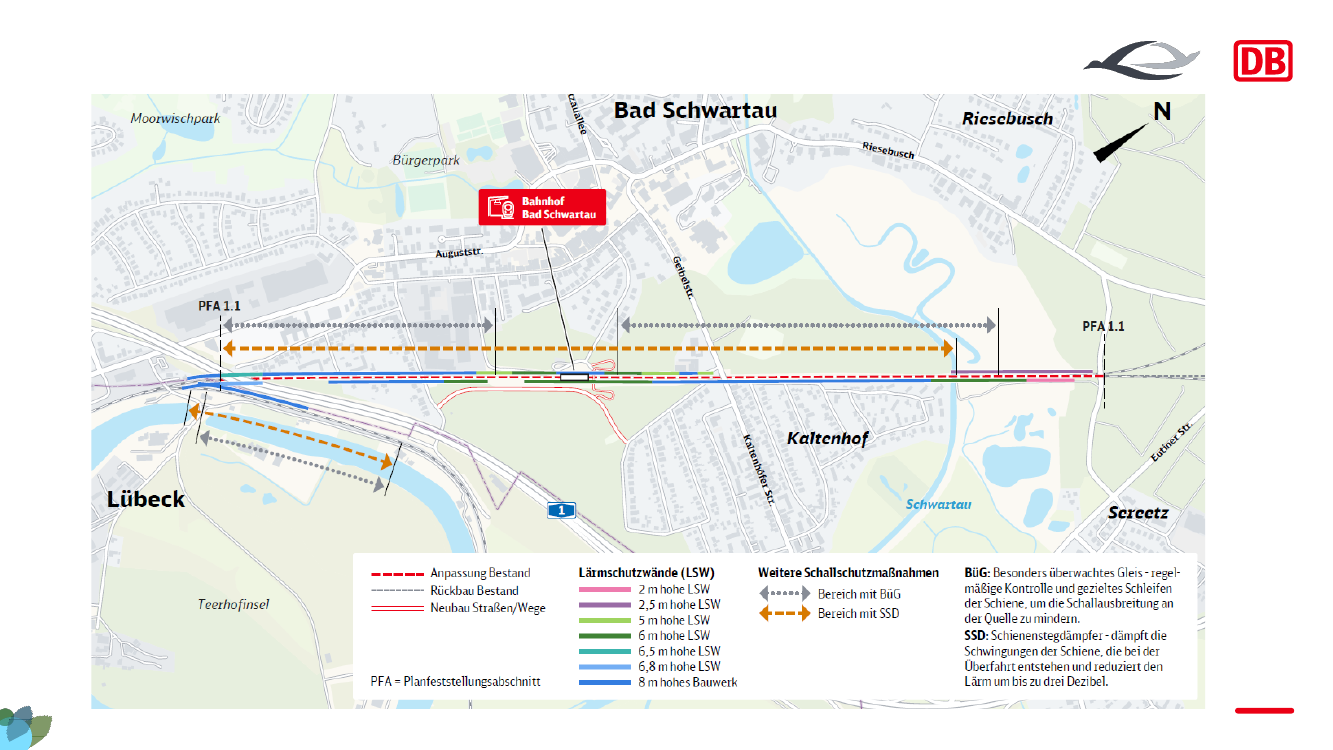

Section Bad Schwartau
13 years of planning and discussion
Planning of the
expansion
of the existing
track
Planning of the
„acceptance
proposal“:
Lowering of the track
( 3,20 meters)
Additional noise protection
Maximum vibration protection
Result of variants study
Planning approval procedure
includes variants study
Based on the current planning status,
including the variants study, 3,20 m
is the preferred solution
2011 - 2014
2014 - 2017
2017 - 2020
2020 - 2023
2024
2025
2026
Regional planning procedure:
Investigation of numerous
routes through Bad Schwartau
as well as different variants with
bypasses of the city
Result: Expansion of the
existing track is preferable
Bad Schwartau is demanding
for
the rail to be lowered by 7 meters.
Mediation procedure
for the
parliamentary consultation:
Bundestag adopts the
“acceptance proposal”
(3,20 meters lowering of the
track)
Bad Schwartau sticks to its 7
meters demand
The
city‘s
latest demand:
After 10 years and many discussions,
the town of Bad Schwartau is once
again calling for the town area to be
bypassed via the neighboring town of
Lübeck and the municipality of
Ratekau
(“X-Trasse”)
DB InfraGO | 23 September 2024
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen
We can go beyond the legal requirements to
protect people against noise and vibrations
Additional
protective measures thanks to funding from the Bundestag
Noise
The required
protective measures
are met in Bad
Schwartau
Additional noise
protection ressolves all
cases of noise disturbance
Vibration
Maximum vibration
protection for residents
DB InfraGO AG | Schienenanbindung FBQ | Arbeitsstand April 2024
10
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen
Additional noise protection
DB InfraGO | 23 September 2024
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen
Without railroad barriers through Bad Schwartau
Kaltenhöfer Straße
DB InfraGO | 23 September 2024
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen

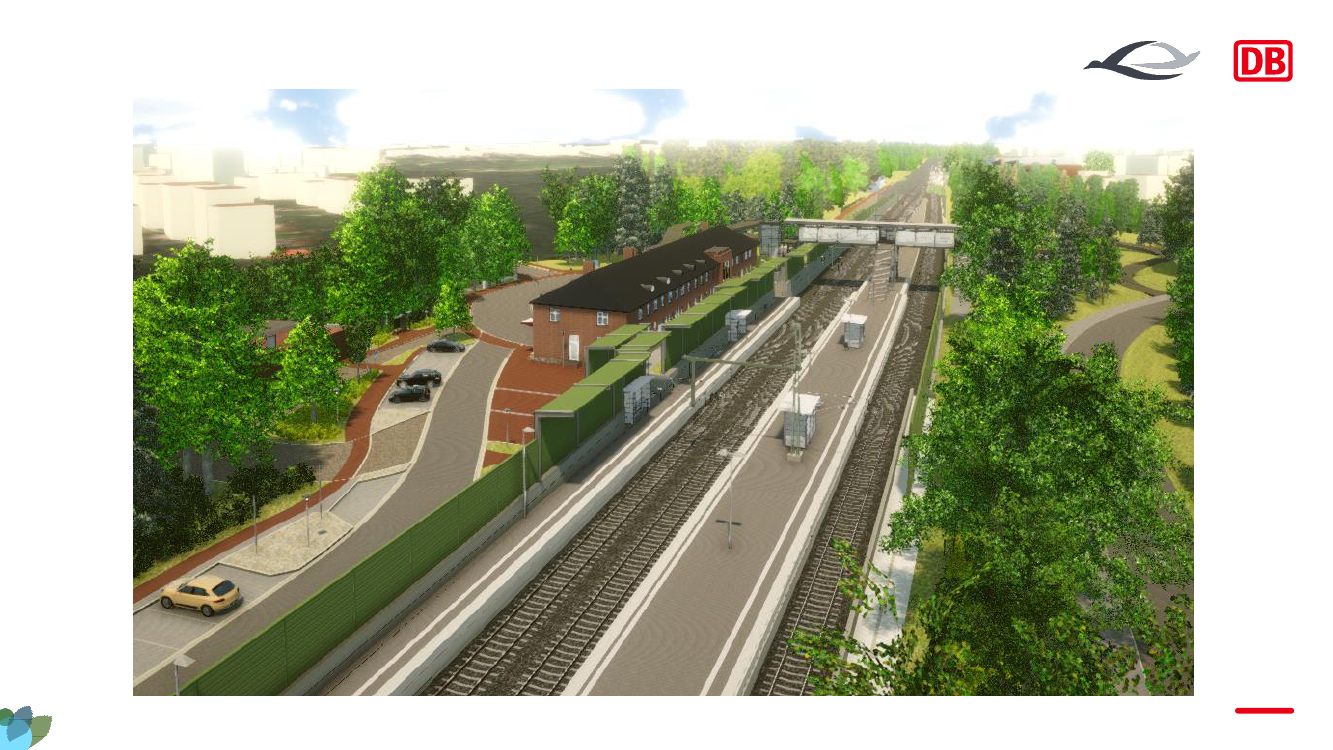

The new station
DB InfraGO | 23 September 2024
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen

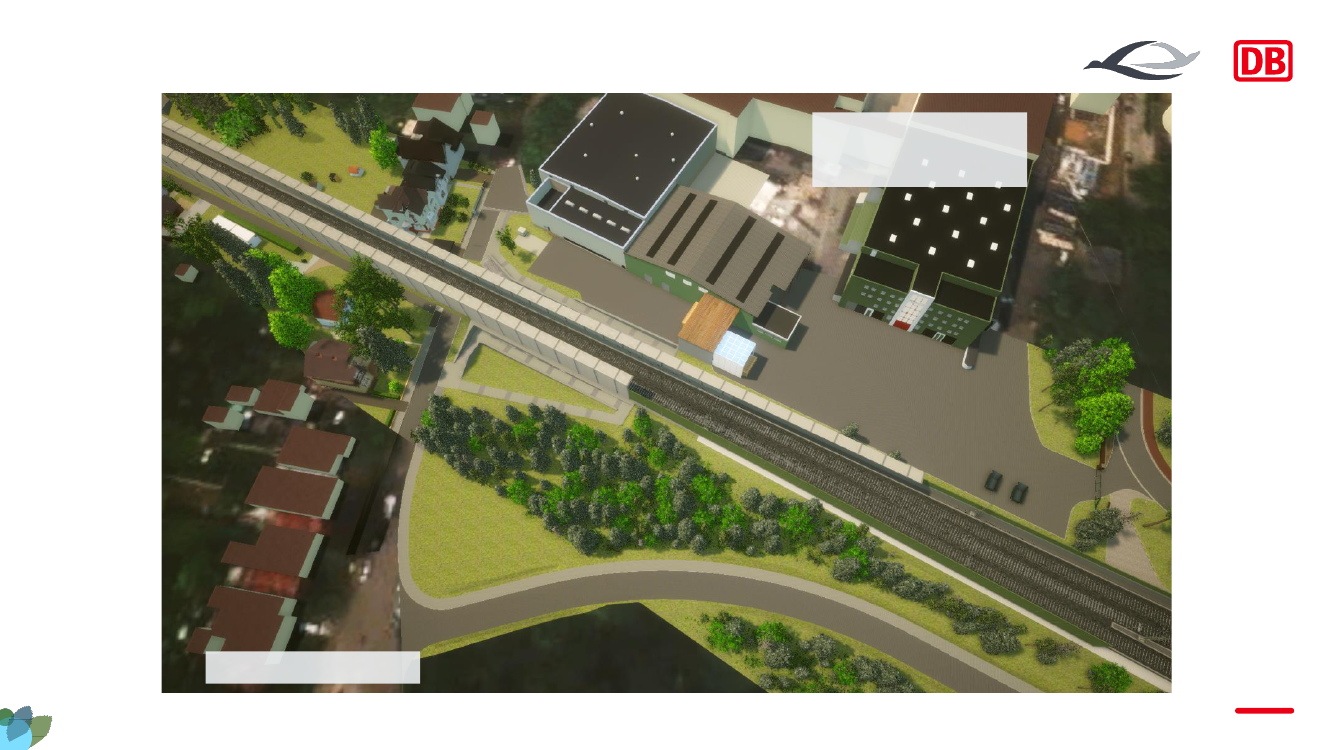

Noise protection for residents
Local industrial
area
Elisabethstraße
DB InfraGO | 23 September 2024
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen

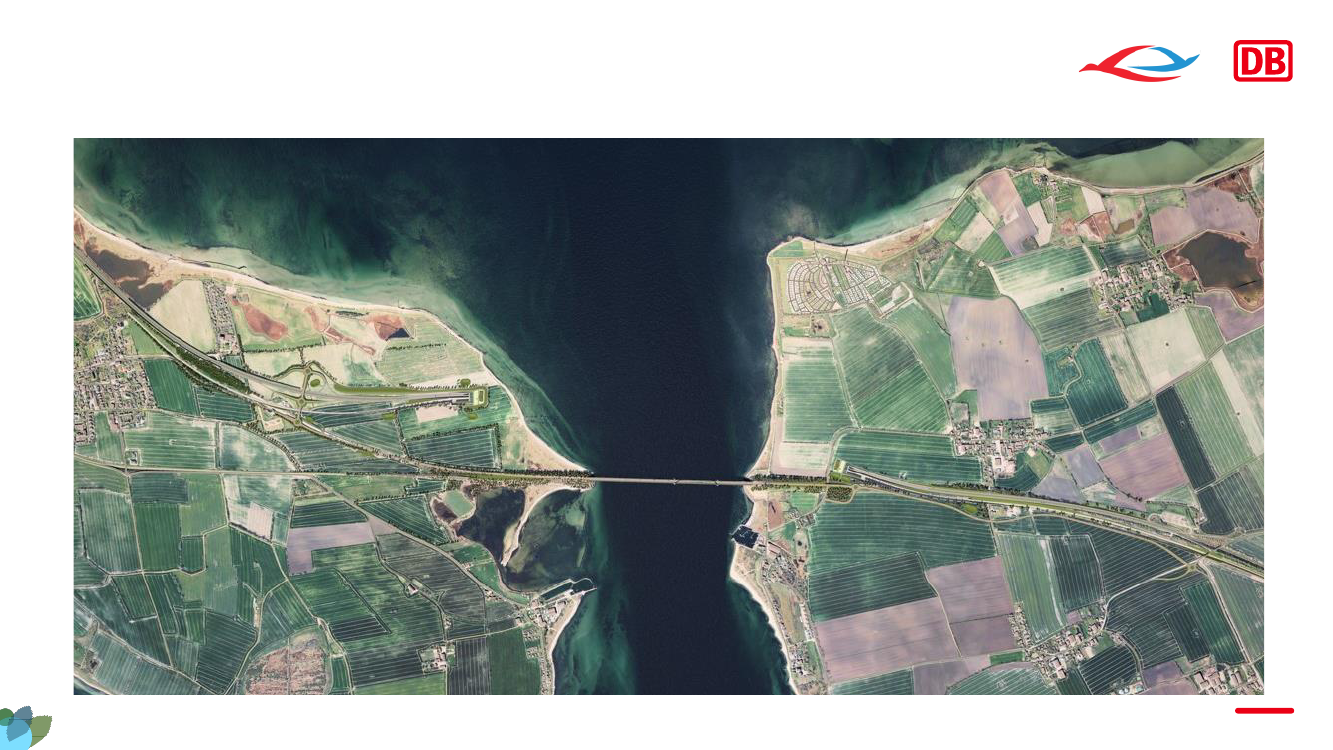

Combined and immersed Fehmarnsound tunnel
Current state of planning
DB InfraGO | 23 September 2024
15
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen

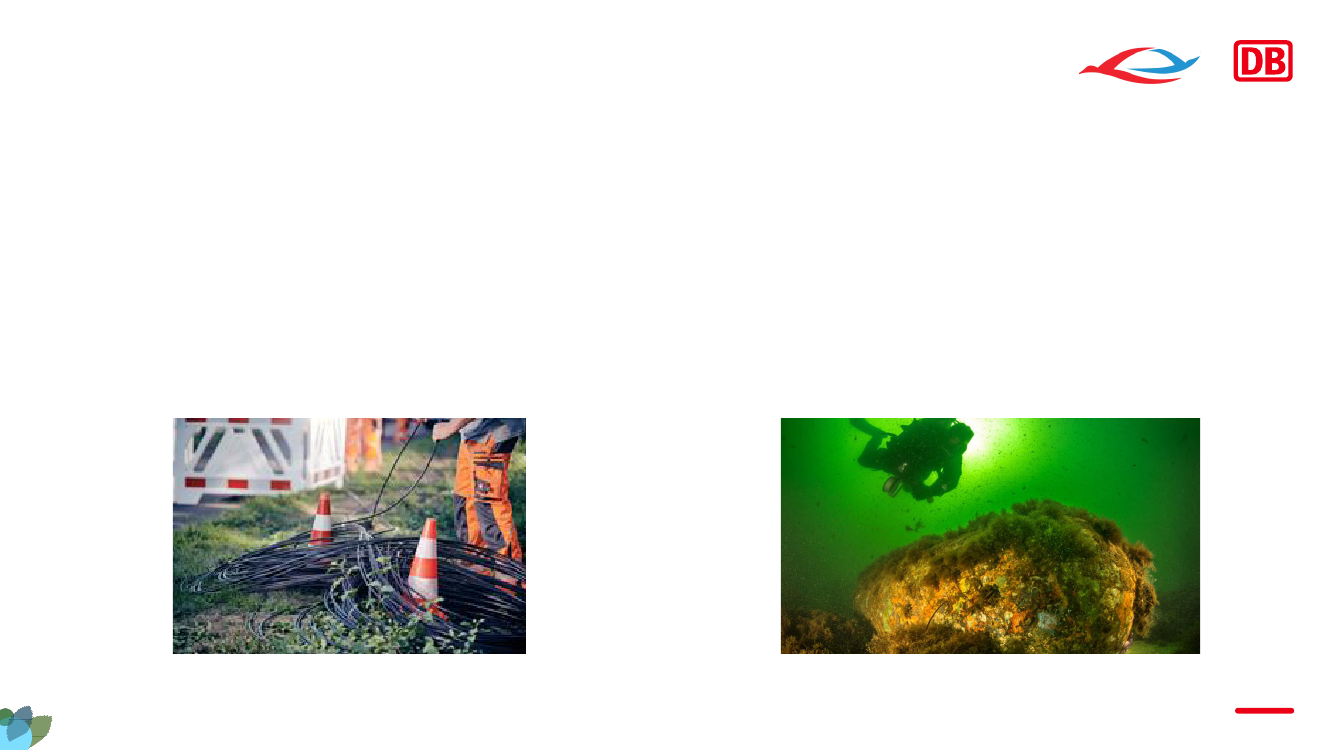

Preparatory measures
Precondition for the actual construction works
Main archaeological investigation
Started in August 2024 on the mainland (carried out by
the Archaeological State Office SH)
Relocation of further cables and lines by the local line
operators
Commencement of work: 3rd quarter 2024
Relocation of the 110 kV-line in the Fehmarnsound
Works started in August 2024 by Fehmarn Netz
GmbH
Explosive ordnance exploration and recovery in the
Baltic Sea
Commencement of work expected in 2025
Source: bildwerkeins paulwalther
Source: Christian Howe, www.h2owe.de, Christian-
Albrechts-Universität zu Kiel
16
DB InfraGO | 23 September 2024
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen

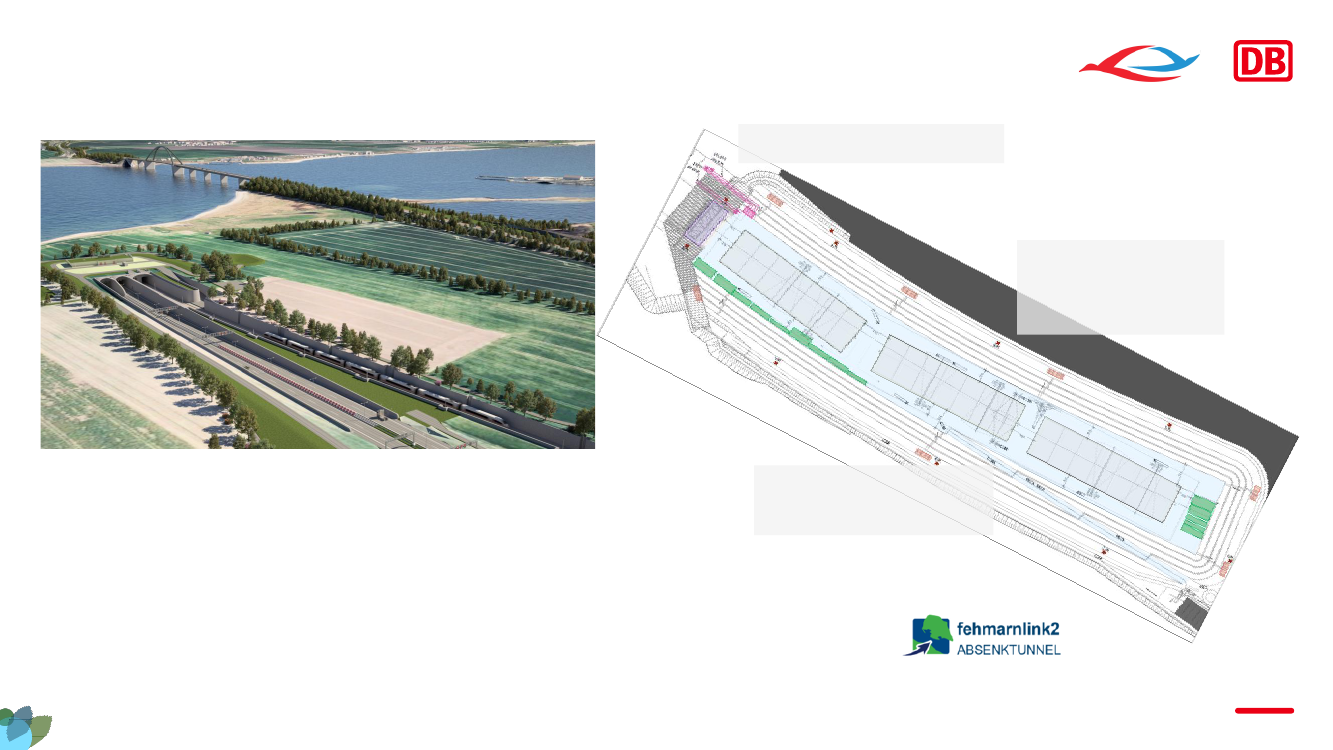

How we build the tunnel elements
Production in dry dock on the mainland
Lock with floating gate
Curved shape
according to the
course of the track
Construction of a dry dock on the mainland west of the
Fehmarnsound bridge
The 12 tunnel elements will be produced here
The dry dock will later be converted into a tunnel portal
(entrance and exit)
This way, the required amount of land use is minimised
DB InfraGO | 23 September 2024
3 elements are built
at the same time
- Subject to alterations -
17
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen
We produce our tunnel elements at the Sound
Swimming in involves exclusion criteria, e.g. major interventions in the FFH area
A feasibility study is available for swimming in the tunnel
elements, e.g. from Denmark
Due to the shallow water depth in the Sound, swimming in
requires excavation of the navigation channel
As the production in the dry dock is an alternative to
this intervention, the production outside the
Fehmarnsound will not be approved by the
authorities
The production of the Sound elements in Rødbyhavn
The excavation is a major intervention in the FFH area in the
requires adjustments to the production facility
Fehmarnsound and exceeds the limited excavation for the
tunnel by a multiple
Swimming in the tunnel elements also extends the
construction time
Source: Ramboll
DB InfraGO | 23 September 2024
18
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen
Outlook: Fehmarnsound crossing
Implementation of the partnership model (“Partnerschaftsmodell”) for the Alliance
Fehmarnsound for rail and road
Submission of approval documents in Q1 2025
All plans and measures by DB and DEGES are aimed at connecting the Fehmarnsound tunnel directly to the
connection areas on Fehmarn and the mainland
Source: DB InfraGO/DEGES
DB InfraGO | 23 September 2024
19
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen
Construction
progress
Section 6 (Fehmarn)
DB InfraGO | 23 September 2024
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen
Overview of construction works on Fehmarn
Scheduled to be completed in 2027
Clearing (removing trees and bushes)
Establishing construction roads (started in November 2023)
Main construction works/track superstructure construction section 6.1b-6.3:
Construction work
on Fehmarn
Removal of tracks
Earthwork: dismantling
Earthwork: superstructure
New track construction
Road dismantling
2024
2025
2026
2027
Completion
DB InfraGO | 23 September 2024
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen
Main works are progressing
Removal of tracks have been completed (bridge connection excluded)
Quelle: LN / Manuel Büchner
Source: DB AG
Source: LN / Manuel Büchner
Source: DB AG
Source: DB AG
DB InfraGO | Schienenanbindung FBQ | September 2024
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen
Communication during the construction phase
for the municipalities and ist citizens and visitors
Monthly meeting with city of Fehmarn about
the construction works
since December 2023
together with the team for the maintenance of the
Fehmarnsound bridge
Information about start of main construction
received by all households by mail on Fehmarn
Source: DB AG
Regular
opening hours
in our info center:
Every Tuesday from 13:00 -16:00 h
Information about the main construction works at
open house event
„Baustellen-Fest“
on July 5th
2024
Since December 2023:
Comunication on
contruction activities:
o
Construction-Blog
o
Newsletter-Sign-Up
DB InfraGO | 23 September 2024
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen
Thank you for your attention!
DB InfraGO | 23 September 2024
TRU, Alm.del - 2024-25 - Bilag 22: Præsentation fra udvalgets møde med DB 23/9-24 vedrørende Femern Bælt forbindelsen
You‘ll
find more information at
www.anbindung-fbq.de
DB InfraGO | 23 September 2024
