Welkom
Redesigning the
railways of the
Netherlands
Wout Knijnenburg
Klaas Hofstra
Utrecht, October 2023
Eigenaar: Klaas Hofstra
14 april 2016
Status: Definitief
TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23
Train Punctuality Netherlands (measured at 2'59" )
94
93
92
91
90
89
88
87
86
85
84
83
82
81
80
COVID
79
2001 2002 2003 2004 2005 2006 2007 2008 2009 2010 2011 2012 2013 2014 2015 2016 2017 2018 2019 2020 2021 2022
2
TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23
The lesson from Japan
We designed a railway system that is impossible to operate
punctually. And if it goes wrong, we blame our operational staff.
We cannot expect our operational staff
to solve the problems we created.
Instead we should enable them to do their job.
3
TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23
Japanese Traffic Control
4
TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23
Dutch Traffic Control
(Amsterdam)
5
TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23
First better, then more
We want to run more trains. But that only works with a stable system. So we
took hundreds of steps in improving timetable, infrastructure and
operations. Most small, some big.
Most ideas are no-brainers, but get lost in a debate on how much it will
help exactly. “Cash is King” => If it helps punctuality, implement it ASAP!
Some ideas are good for punctuality, but hurt on other aspects. In these
cases, obviously a good balance needs to be found.
Bear in mind: punctuality measures should always contribute to
increasing capacity and/or lower operational cost.
6
TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23
Integrated “Taktfahrplan” is
the foundation
• Recognizable and easy to use
for passengers as well as
operational staff
•Optimal deployment of
personnel and rolling stock
• Better optimization possibilities
for infrastructure
• Basis for punctuality
improvements on a busy
network (NL, CH, DE)
Redesigning the Dutch Railways
7
TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23
Nobody creates delays for fun
Delays occur if the dispersion in the operation is larger than the
buffers in the timetable.
This is why most punctuality improvement plans in European Railway
companies do not work. Intensive research taught us that there are only a
few ways to improve punctuality. They are heavily dependent on each other:
1. Reduce the amount of crossing movements
2. Validate process times used for the timetable design
3. Allow for enough (but not too much) buffer in the timetable
4. If the timetable is good, then reduce dispersion in everyday operation
5. Improve the infrastructure where-ever possible
8
TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23
1. Reduce crossing movements
The best headway is no headway
If trains can run parallel instead of crossing each other, that is always the
best choice. Even without changing the timetable, the routing on the nodes
can solve or create a lot of problems.
No timetable change!
Only routing in the node
Common railway practice:
Trains separated in time
More important:
Trains separated in space
9
TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23
2. Validate process times
It is not possible to plan enough
buffer if you don’t know the exact
process times
The calculation of running, dwell and
turnaround times contains many errors.
Running time calculations are therefore
constantly validated with each other
(Donna/OT) AND with the realisation of
thousands of trains (Trento).
Differences are analysed and used to
improve the calculation.
Minimum running times are based on the
10
th
percentile, minimum dwell times are
based on the median.
Ekz
Bkf
Bkg
Hks
Hnk
Hn
Hn
Hna
Pmo
Whe
Pmr
Nhk
Pmw
Zdk
Zdb
Zd
V
K
K
K
K
A
V
D
D
D
D
D
D
D
D
D
Donna Trento OT
VIRM VIRM VIRM
3,1
2,2
3,3
5,9
2,9
17,3
1,2
8,8
0,7
0,4
0,5
0,6
4,0
0,9
1,5
18,5
2,9
2,1
3,3
6,0
2,9
17,2
0,0
9,8
0,0
1,1
0,0
1,1
4,4
0,0
2,0
18,4
3,1
2,1
3,5
6,0
3,0
17,7
9,7
1,1
1,2
4,4
1,9
18,3
10
Kaal
IC
3,0
2,1
3,3
6,0
2,9
17,3
1,2
8,7
1,1
1,1
4,4
2,1
18,6
TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23
Examples of mistakes we found in the
“perfect” travel time calculation
Stopping locations are not correct
Starting trains start at the signal instead of at the platform
Signal aspects were calculated incorrectly
Arrival at a red/green signal at a stopping station
Rolling stock characteristics had multiple mistakes
Same characteristics were used for trains with different engines
Catenary-free sections (incl. bridges) were not taken into account
Gradients were not taken into account for passenger trains
Catenary voltage incorrect
Braking in the calculation was not according to actual driver behaviour
Bug in the calculation of freight trains
11
Etc.
TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23
3. Enough (but not too much) buffer
We need to know whether we planned enough buffer. At the
second precise. Always. Everywhere.
The only way to do this is to run one nationwide
deterministic
simulation,
with buffers:
We use “93% reduced performance” to simulate running time margin of
7%. So each train always runs 7% slower than technically possible.
We use “additional track occupation of 60s” to simulate headway buffer
Why deterministic simulation is better than conflict detection?
Continuous check for all trains, everywhere
Not only detection of the conflict, but also the resulting delays (if any)
Hindered headways instead of unhindered
Second opinion / double check (addition to the planning system)
12

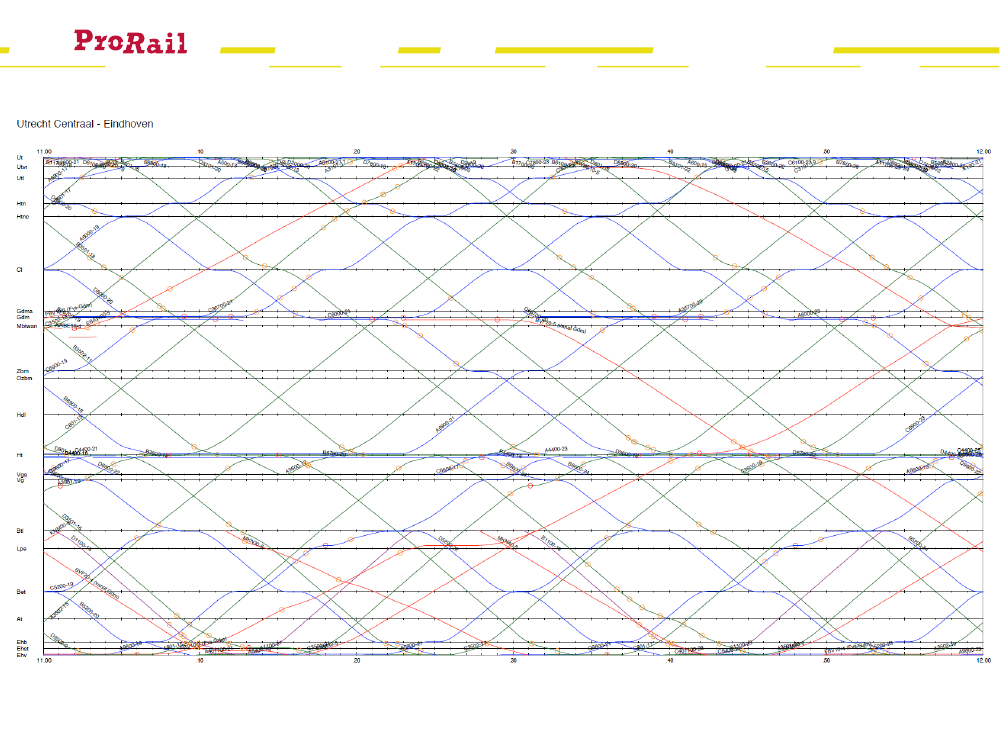

TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23

Example of simulation result
If the simulations shows delays (>15s) and/or unplanned
stops, there is not enough buffer in the timetable.
13
TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23

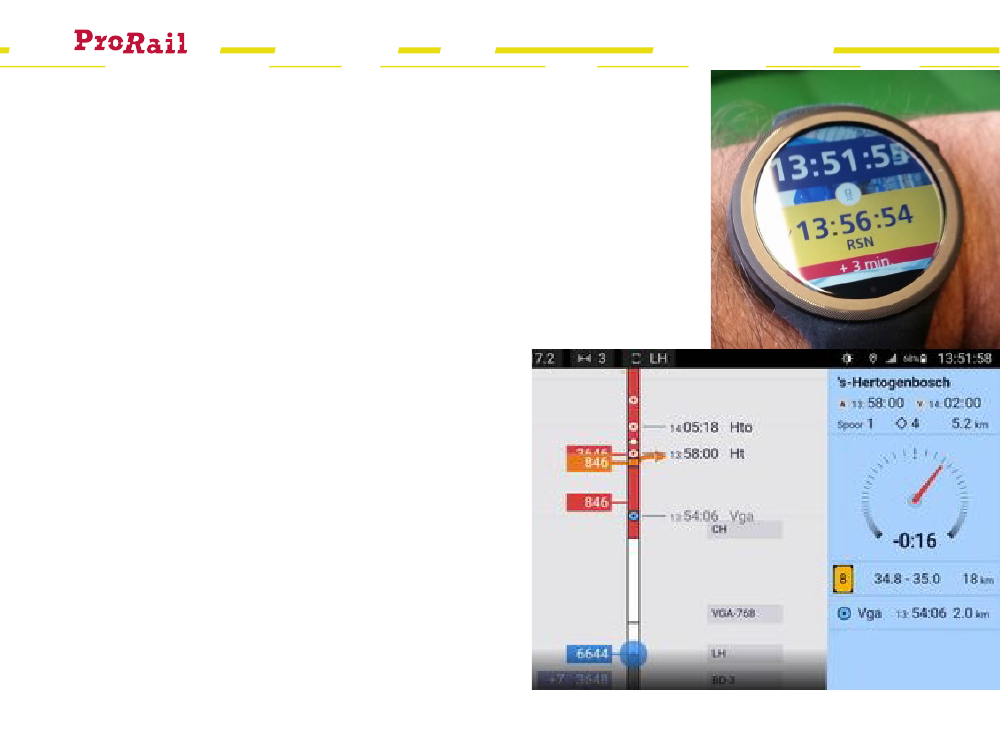

4. Operational Quality
If we would like our trains to arrive on time,
it might just help to tell the onboard staff
what we mean by “on time”.
After an open discussion with
staff members, NS decided to give
all their onboard staff extra
training, tooling (watch/tablet)
and an updated performance
measurement.
IMPORTANT:
the success of these
measures depends on the quality
of the timetable.
14
TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23
5. Improve the infrastructure
Focus existing and new infrastructure projects on simplification
In all infrastructure projects (newly built or maintenance) we try to
add punctuality/capacity scope:
Improving signal aspects and/or placement
Improve speeds
Reduce crossing movements
If infrastructure capacity starts to become a serious problem, the best
option might be to start a large infrastructure project, in which the
complete layout of a node is optimised (“greenfield”).
15
TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23
16
TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23
Utrecht Central Station
Several big rail projects integrated into one mega-project:
Widening of platforms 1-4
New Public Transport terminal (“OVT”)
Track layout south side (“Vleugel / Randstadspoor”)
Track layout north side (“Doorstroomstation Utrecht”)
+ major urban redevelopment around the station
17

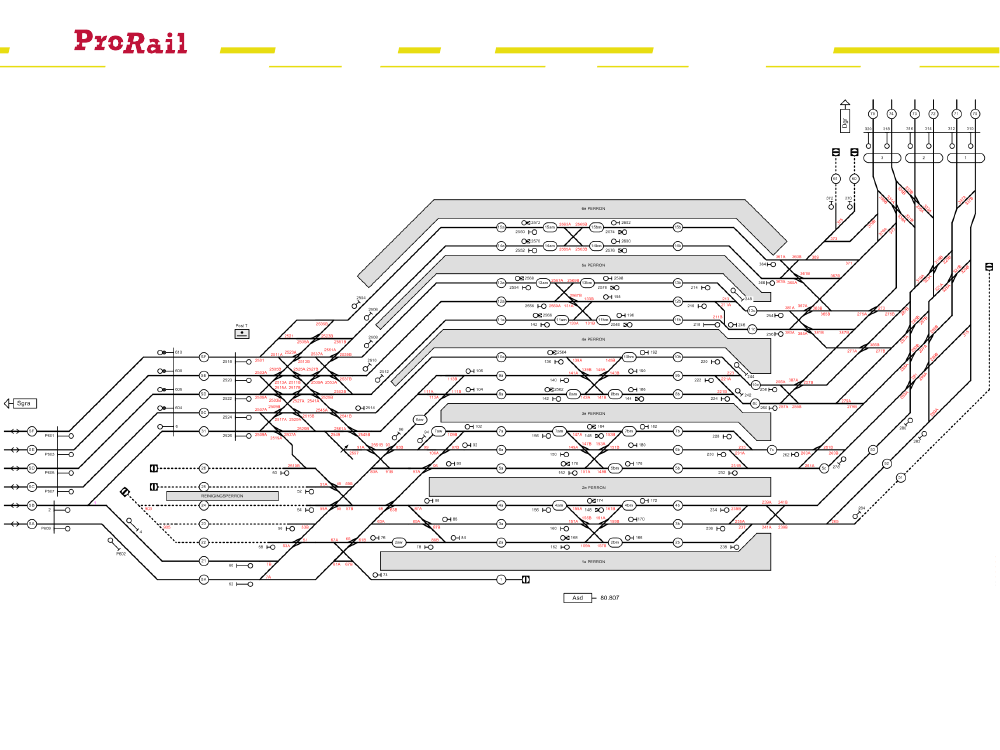

TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23
Platforms1-4
Platform 5/7
Platforms 8-11
Platform 14/15
Platform 18/19
Platform 20/21
18
TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23

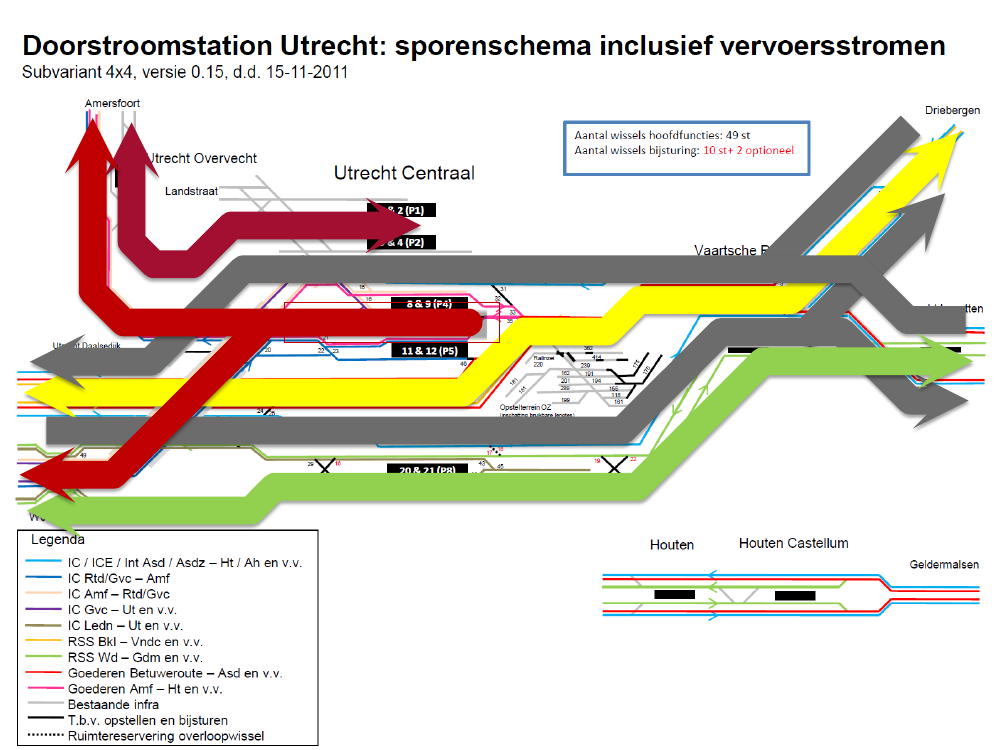

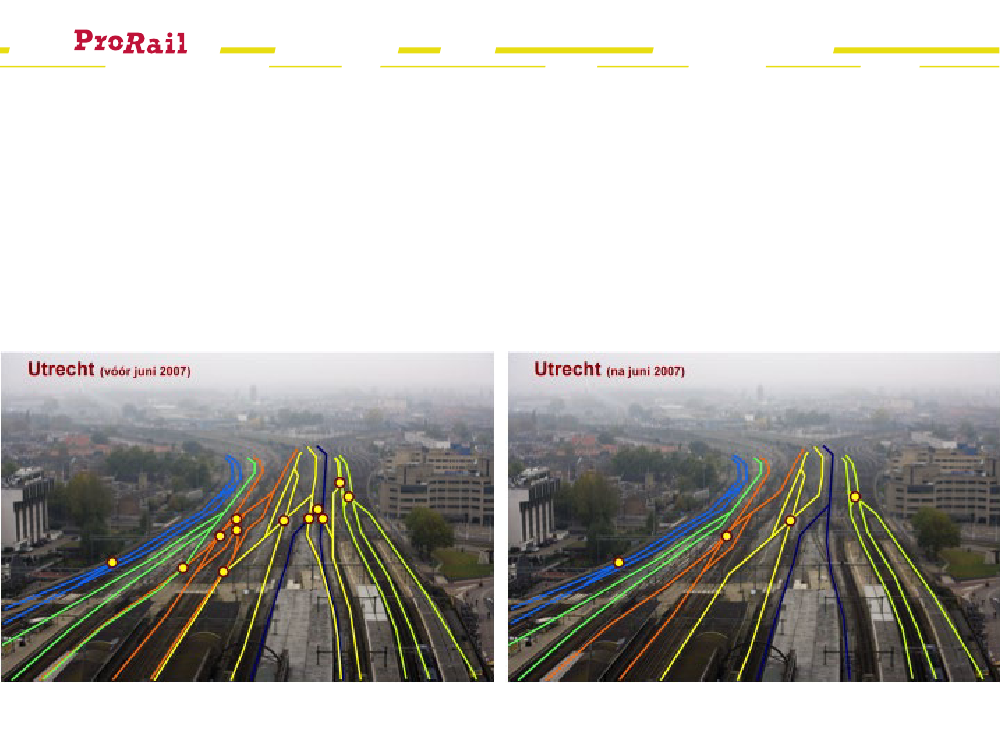

Design of track layout
Old
A lot of simultaneous routes
Flexible platform allocation
Large distance between signals
40 km/h
High flexibility in operation
Many switches & crossings
Unreliable diamond crossings
New
Conflict free corridors
Dedicated platform allocation
Short headways
80 km/h
Limited flexibility in operation
Elimination of switches & crossings
Standardised 1:15 switches
19
TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23

In service since december 2016
Utrecht C.
2015 2018
Infra failures
83
10 -85%
Delay mins 20.085 2.964 -85%

Train punctuality Utrecht vs. the rest of the NL (2'59'')
96,0%
94,0%
92,0%
90,0%
88,0%
86,0%
84,0%
82,0%
80,0%
2015 Q1
2015 Q2
2015 Q3
2015 Q4
2016 Q1
2016 Q2
2016 Q3
2016 Q4
2017 Q1
2017 Q2
2017 Q3
2017 Q4
2018 Q1
2018 Q2
2018 Q3
2018 Q4
2019 Q1
2019 Q2
2019 Q3
2019 Q4
Utrecht
NL excl. Utrecht
20
20
TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23

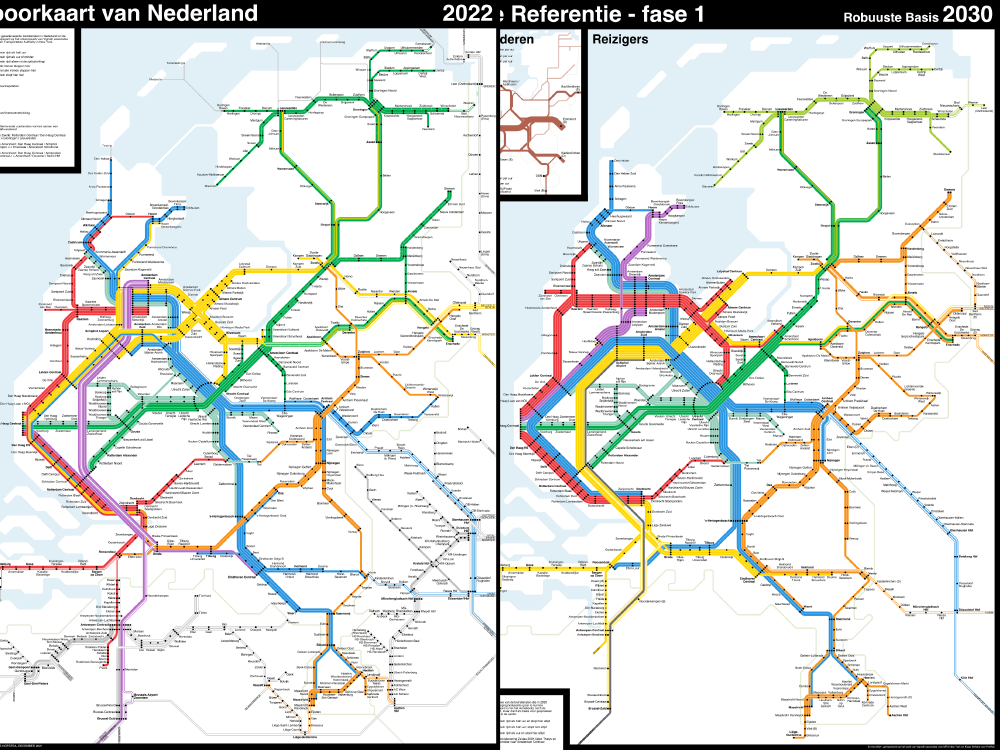

“From Utrecht to the whole country”
Main themes for network optimisation
Operational cost
Reduce the amount
of assets, mainly
switches
Reduce switch-
heating
Phase out non-
standard assets
Reduce slack in the
timetable
Operational
performance
Capacity /
Frequency
Sustainablity Safety
Reduce and
reuse materials
and assets
Reduce switch-
heating
Remove local
speed
restrictions
Timetable for
energy
efficiency
Simplify the
track layout
Remove and
improve level
crossings
Phase out non-
compliant
signalling
Enough margin
in the timetable
Reduce the amount Shorter blocks,
of possible routes
higher speeds
and “derusting”
Reduce disruptions ETCS, but only
and possessions for on decent
maintenance
infrastructure
Longer/wider
Enough margin in
the timetable:
platforms,
always, everywhere 740m
Give train drivers
more precise
information
Match
timetable and
infrastructure
ESSA: Eliminate, Simplify, Standardize and Automate
21
TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23
Example business case
Maintenance cost
2025 2026 2027 2028 2029 2030 2031 2032 2033 2034 2035 2036 2037 2038 2039 2040 Total 15yrs Total 20yrs
yearly maintenance cost s10k/swit #### #### #### #### #### #### #### #### #### #### #### #### #### #### #### #### -1.500.000 -2.000.000
Renewal of points (every 20k/switch
Renewal costs
Renewal of switch heating
50k/switch
Renewal cost of switch
Total
Not included:
Grinding of switches
Catenary renewal
Renewal of Interlocking
250k/sw ####
####
-200.000
-200.000
####
-500.000
-500.000
-2.500.000 -2.500.000
#### #### #### #### #### #### #### #### #### #### #### #### #### #### #### ####
-4.700.000 -5.200.000
22
TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23
Current status
Number of switches
1-1-2018
New built since 2018
Keep / renew
Potential removal
Removed
In projects
Urgent
Not urgent
Mainline
3898
107
2149
1856
397
911
41
507
(excl. Rtd Port)
Hoofdspoor
Yards
2339
89
1381
1047
395
324
124
204
Behouden
Is gesaneerd
Wordt gesaneerd
Urgent
Niet urgent
Zijspoor
This table excludes around 300 new mainline switches
being built in optimised track layouts.
Behouden
Is gesaneerd
Wordt gesaneerd
Urgent
Niet urgent
23
TRU, Alm.del - 2023-24 - Bilag 52: Diverse præsentationer fra besøg i forbindelse med udvalgets studietur til Holland og Tyskland d. 30/10-2/11-23
Questions?
24
