VfM Evaluation of GGGI
2013-2014 v.7
April 03 2015
KPMG
Risk Consulting Service Group
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Contents
Global Green Growth Institute
19F Jeongdong Bldg.
15-5 Jeong-dong, Jung-ju
Seoul 100-784
Republic of Korea
April, 03, 2015
This report is prepared solely for the Global Green Growth Institute (GGGI) under the
terms of the engagement contract dated February 06 2015 and cannot be copied or
circulated, either in whole or in part, to any other parties or for other purposes other
than those stated in the Engagement Letter, without KPMG Samjong Accounting Co
p. s
prior written consent.
The data included in this report was obtained from GGGI, by April 03 2015. We have
no obligation to update our report or to revise the information contained therein to
reflect events and transactions occurring subsequent to April 03 2015
1
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Contents
Contents
List of acronyms and
abbreviations
Executive Summary
I. Objective, Scope &
Methodology
2
4
12
1. Objective
2. Scope and General Approach
3. Professional Standard Used
4. Procedures Taken
II. Limitations
III.
GGGI’s Gove a e
1. Institutional Systems
2. Staffing
3. Facilities
16
18
IV.
GGGI’s Co e Fu d
Project Management
23
1. Strategy and Planning
2. Mongolia Program
3. Rwanda Program
V.
GGGI’s Ope atio s
Management
53
1. Procurement Management
2. Human Resource Managemen
t
3. Finance Management
VI. Enterprise
Resource Planning
VII. Conclusion
75
1. ERP
2. General IT
93
95
1. List of Document Required
2. Interviews
3. Simplified Process Maps
Appendix
1
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
List of Acronyms and Abbreviations
List of Acronyms and Abbreviations
No.
1
2
3
4
5
6
7
8
9
10
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
26
27
28
29
30
31
32
33
34
35
36
37
38
39
40
41
42
43
44
Abbreviation
3Es
AFSC
BPG
BPM
COBIT
COP
COSO
CPF
CSU
CV
DDG M&A or DDG
DG
DoA
DP
EAC
EDPRS2
ERP
FCPA
GGGI
GGP&I
GIS
GL
GTC-K
HCA
HOL
HQ
HR
INTOSAI
IWG
KDM
KSD
LDC
LE
M&E
Mgt
MNET
MOU
NGDP
ODU
PAI
PAL
PH
PO
PPC
Meaning
Efficiency, Economy and Effectiveness
Audit and Finance Sub-Committee
Business Process Group
Business Process Management
Control Objectives for Information and Related Technology
Core Operating Process
Committee of Sponsoring Organizations of the Treadway Commission
Country Planning Framework
Corporate Service Unit
Curriculum Vitae
Deputy Director-General Management &Administration
Director-General
Delegation of Authority
Direct Contract
East African Community
Second Economic Development and Poverty Reduction Strategy
Enterprise Resource Planning
Foreign Corrupt Practices Act
Global Green Growth Institute
Green Growth Planning and Implementation
Green Investment Services
General Ledger
Green Technology Center Korea
Host Country Agreement
Honorarium
Headquarter
Human Resource
International Organization of Supreme Audit Institutions
Informal Working Group
Knowledge Development and Management
Knowledge Solutions Division
Least Developed Countries
Limited Evaluation
Monitoring and Evaluation
Management
Ministry of Nature, Environment and Tourism of Mongolia
Memorandum of Understanding
National Green Development Policy
Organization and Delivery Unit
Open Competition, $200.000-500.000
Process Asset Library
Open Competition, $500.000>
Purchase Order
Public-Private Cooperation
2
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
List of Acronyms and Abbreviations
No.
45
46
47
48
49
50
51
52
53
54
55
56
Abbreviation
PR
QIR
QPR
R&R
RBM
SPC
UAE
UB
UNEP
VfM
WPB
YTD
Meaning
Procurement request
Quarterly Implementation Report
Quarterly Portfolio Report
Roles and Responsibilities
Results Based Management
Strategy, Policy and Communications
United Arab Emirates,
Ulaanbaatar
United Nations Environment Programme
Value for money
Work Plan and Budget
Year To Date
3
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Executive Summary
Executive Summary
GGGI is a relatively new international organization, gaining its status as an international organization in October
2012. Therefore, in early 2014 GGGI experienced problems in cash flow due to the timing of replenishments
by the donors. Although previously issued appraisal and / or evaluation reports of GGGI mention that GGGI
lacks internal control structures such as relevant policies and procedures, GGGI has implemented necessary
revisions to follow up on the comments so far.
Evaluation Criteria
Even though the project evaluation covers the period 2013
2014, evaluation ratings based on the sampling
tests heavily focused on results from the second half of 2014, because GGGI is a relatively new international
organization, and many changes and improvements have been observed during the fieldwork. For example, if
deficiencies previously noted in the Danish Appraisal Report were noted again in the test results, we
considered whether remedies and improvements have been implemented. If properly remedied, more value
and weight was put on the current operation and transactions status; therefore, if equal value and weight is
applied to the evaluation period, evaluation ratings would be lower than the ratings provided in this report.
Only the procurement, human resources, and finance management functions relevant to the Mongolia and
Rwanda programs were evaluated; we did not evaluate the entire procurement, HR, and finance management
performed in Seoul HQ. Furthermore, the transactions relevant to Mongolia and Rwanda were tested on a
sampling basis, and not all transactions were tested. For HR management, only one sample was selected and
tested due to the confidential nature of HR information. Although only one sample was tested the deficiency
indicated in the results was
dee ed to e e se ious a d thus HR a age e t as ated as
PARTIALLY
SATISFACTORY . Please ote that a e o se ati e app oa h as used to e aluate
the functions of GGGI.
The definition of evaluation rating is described below:
Satisfactory
- Internal controls, governance and procedures/processes were adequately established and
functioning well. No issues were identified that would significantly affect the achievement of the objectives
of the evaluated entity.
Partially Satisfactory
- Internal controls, governance and procedures/processes were adequately established
and functioning well. One or several issues were identified that may negatively affect the achievement of the
objectives of the evaluated entity.
Not Satisfactory -
Internal controls, governance and procedures/processes were either not established or
functioning well. The issues were such that the achievement of the objectives of the evaluated entity could
be seriously compromised.
I.
Strategy and Planning Management
Satisfactory
Overall, 2013 and 2014 was a transformative phase for GGGI, which resulted in different planning document
e ui e e ts du i g the t o ea pe iods. GGGI s St ategi Pla
-2020 and Biennium Work Program and
Budget (WPB) 2015-2016 reflect a shift in organizational thinking and priorities, built on a common recognition
amongst donors and in-country stakeholders to demonstrate the case for green growth and deliver results on
the ground.
4
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Executive Summary
A clear set of guiding principles, strategic priorities, and an integrated delivery model emerged from an
intensive strategic planning process through consultative platforms and intensive discussions, which included
six country visits, two Informal Working Group meetings, informal Donor Consultative Group meeting, and the
joint Audit and Finance Sub-Committee and Project Sub-Committee, and staff surveys
in order to reflect
lessons learned and build on bottom-up input.
The WPB is the operational tool for the Strategic Plan. The shift to a biennium timeframe allows for the
anchoring of project planning in a longer term horizon.
The launch of the Country Planning Framework, the derivative planning document for in-country programming
and any new project design, is aimed at delivering in-country results aligned to national priorities, and
GGGI s
corporate strategy and Results Framework. Going forward, the draft GGGI Results Framework will require
further refinement of outcomes/outputs (based on the aggregation of biennium project-level results),
inclusion of baseline, indicators, and target. At the project level, all project-level logical frameworks should be
completed, finalized, and nested within the corporate Results Framework. A methodology will have to be
developed to ensure nesting between project logical frameworks and corporate results framework for
meaningful aggregation of results
II. Project Management
A. Mongolia Project Management
Not Satisfactory
I ge e al, the Mo golia P oje t a hie ed its ai o je ti es. I li e ith GGGI s alue p opositio as the o l
international organization exclusively focused on green growth, GGGI provides integrated demand driven
suppo t fo Mo golia s p o-poor
green growth initiatives. Mongolia became a full member of GGGI in June
, i di ati g the alue the pla e o GGGI s se i es. Mo golia
was identified in the Strategic Framework
as the first country to proceed with the Country Planning Framework, and commitments were made to donors
to move the process forward vigorously. During a time of uncertainty with a change of government, GGGI was
still able to convene a key meeting that provided critical country driven content to both the CPF and a
government policy paper on green growth. It is because this meeting was convened that the CPF is still on
track.
However, even though the Mongolia project achieved its core big picture objectives, project management
process was not performed in a satisfactory manner throughout the project. During 2013 and first half of 2014,
issues existed but were unclear. However, review of Mongolia project management in the second half of 2014
indicated significant issues, as two abnormal transactions were noted from the Mongolia programs.
First, the Procurement and Recruitment process of the Mongolia Country Representative showed irregularities.
By tracing all relevant documents, the procurement process was shown to use both the procurement and the
HR processes. Violations also occurred in the budget check and approval process.
Second, 52 consultant contracts formed during the Mongolia program in December 2014 (34 consultants for
the Green Development Roadmap Project and 18 consultants for the Green Indicators Development Project)
showed deficiency in their effectiveness and efficiency. All of the 52 transactions violated the proper
Procurement sequence, as the final approval by the Head of Procurement was given right before the ending
date of the contract. Causal analysis did show that the issue was due to the Mongolia Program Country
Rep ese tati e s poo p epa atio of the P o u e e t Re uest; the Head of P o u e e t atte pted to e su e
that all required request documents were of proper quality. Furthermore, 83% of consultants procured were
related to the Mongolian Government, and were counterparties of the Mongolia program. Even so, payments
of USD 200
500 were provided to the consultants for participating in GGGI workshops without maintaining
5
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Executive Summary
detailed record of the reason for doing so. Providing payments is especially significant when dealing with a
government/government related party. Lastly, the regional director was found to have given Mongolia
Country Representatives permission to work during the weekends without documenting the reason
first
countries to proceed
s, which might be seen as a preferential treatment.
(Note: According to GGGI, the 52 consultant procurement contracts are related to two projects: 1) Green
Development Roadmap Project and 2) Green Indicators Development Project. The descriptions of services for
the Green Development Project was as follows:
Written contributions to the review and/or development of green development implementation plans
(i.e. roadmap)
Participation in working group sessions
These se i es ill ake up a iti al o po e t of the Go e
e t of Mo golia s a ilit to i ple e t its
National Green Development Policy. These services will also assist in the formulation and multi-stakeholder
o
it e t to GGGI s
-2020 strategic country framework for Mongolia.)
In conclusion, despite the overall satisfaction of the project by the client, definite room for improvements in
the Mongolia Project Management process were identified during the VfM procedure. Accurate and thorough
internal documentation that depicts the activities and the reasons behind the decisions made in country team,
including the changes in the budget, should be maintained in order to achieve effective project management.
The i te al p o edu e should also e follo ed to e su e that p oje t s isk is ei g a aged effe ti el
Therefore, it is hard to conclude that the Mongolia project management was performed in an effective manner.
B. Rwanda Project Management
Satisfactory
In Rwanda GGGI provides policy advice and technical support to the government to implement its Economic
Development and Poverty Reduction Strategy (EDPRS2), which is currently in the second phase of
implementation (2013-2
8 . R a da s Ca i et i Ap il
app o ed GGGI s Esta lish e t Ag ee e t to
show its commitment to work together with GGGI to achieve the development of secondary cities as green
cities with green economic opportunities.
The Government of Rwanda (GoR) has decided to strengthen six secondary cities as poles of growth through
EDPRS 2. This is to transform the economic geography of Rwanda by facilitating and managing urbanization
and promoting secondary cities as poles of economic growth. At the same time,
EDPRS i o po ates a g ee
e o o
app oa h to e o o i t a sfo atio , ith t o i te e tio s elated to the p o otio of g ee
urbanization as well as green innovation in the industrial and private sectors.
I li e ith GGGI s alue p opositio a d
strategy to move closer to implementation, GGGI as part of its 2015
and 2016 work is currently in discussion with the GoR to develop the institutional structures and capacity
needed to develop a Green City Investment Strategy and pipeline of bankable projects.
We found some delay of the project schedule and deliverables. This was neither due to lack of project
management skills nor due to the incompetency of the consulting firm. It was due to a combination of reasons:
the considerable time associated with consultation, and the lack of the presence of a permanent Rwanda team.
Even though we found some minor exceptions, the overall evaluation result of the Rwanda program
management is satisfactory. However, the Rwanda team needs to improve internal document management
skills and be cautious not to violate procurement procedure.
III.
Procurement Management
(For Mongolia and Rwanda Programs)
Partially Satisfactory
6
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Executive Summary
To safeguard best Value for Money, the procurement for GGGI has constantly been managed by the
P o u e e t U it, i ludi g ea l i ol e e t i the TOR s a d spe ifi atio s, to e ha e o petitio , se u e
clear criteria that are possible to evaluate, chair and coordinate evaluation meetings, and perform quality
assurance on the contracts. Contract management has been introduced, to ascertain quality performance with
the suppliers, including requiring improved performance or contract termination, if necessary. Terminating
the Rwanda contract is a good example of such effective contract management.
FINDINGS
Procurement management was decentralized until September 2013, with each division independently
managing procurement functions
si e p o u e e t u it did ot e ist as pa t of GGGI s Ma age e t a d
Administration division.
The main function of the procurement unit is to acquire goods and services at the best possible cost to meet
the needs of the acquirer in terms of quality, quantity, time, and location. Individual Consultants are procured
by the procurement unit and not the Human Resources unit.
Internal Controls of the procurement process were verified to be well designed with respect to authorization,
review, and segregation of duties. However, some exceptions were identified in following these controls
during the practical implementation of procurement processes. The procurement team has taken remedial
actions in the past by notifying staff of the needed compliance measures.
RECOMMENDATION
There is definite room for improvements for the procurement management of GGGI. First and foremost, it is
highly recommended to explicitly state the standard language to be used for the deliverables in the
p o u e e t o t a t. Fu the o e, the p o u e e t p o edu e s o plia e status fo ea h ou t should
be used as one of the standards of measuring Project and individual performance. Lastly, considering the
inherent high risk of the procurement function, it is strongly recommended that the number of procurement
staff be increased to ensure that work is performed in a more stable manner.
CONCLUSION
Overall the performance of the Procurement Management related to the Mongolia and Rwanda programs is
partially satisfactory. Although the Head of Procurement and the procurement staff appropriately followed the
organizational policies, exceptions in procurement processes were found in practice. However, this was due to
the procurement request itself and not due to a fault by the procurement staff. The efficiency of procurement
management was affected because procurement requests were often submitted very near the deadline by the
end users. Consequently the quality of procurement requests and the relevant supporting documents were
poor, forcing the procurement staff to repeat the same requests to the end user. On the other hand,
procurement management function was effective in accomplishing its main objective of acquiring the goods,
services, and outsourcing at the best possible price in order to meet the needs of the acquirer in terms of
quality, quantity, time, and location, despite the frequent sequence violations by the end user and the lack of
manpower in the Procurement Unit.
IV.
Human Resource Management
(For Mongolia and Rwanda Programs)
Partially Satisfactory
The main objective of evaluating Human Resource (HR) Management is to assess the economy, efficiency, and
effectiveness by reviewing the Design of Process and the quality of deliverables in each step. The scope of the
HR process evaluation is limited to supporting processes related to the Mongolia and Rwanda Country
programs which happened in 2013 and 2014.
7
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Executive Summary
As of now, the Human Resources Unit is entrusted with matters relating to staff members. Matters relating to
consultants are entrusted to the Procurement Unit.
During 2013, the HR work focused on implementation of the April 2013 approved Staff Regulations and Rules,
and the recruitment of a significant number of positions created for the new organization. At the same time
the HR function adapted to the change in the culture of the organization, moving from K-GGGI (a Korean
organization) to an international organization. In January 2014, responding to expected future needs GGGI
provided four positions for the Human Resource Unit, and recruited two international staff, the Head of HR
and the Compensation and Benefits Specialist.
The HR Team functions under four pillars: Talent Acquisition; Talent Management; Rewards and Recognition;
and Good Governance. The impact in bringing these skills and clarifying its accountability resulted in significant
cost savings for GGGI and its staff, hence Value for Money; and enhancing recruitment and performance
management modality, hence contributing to workforce effectiveness. The examples of cost savings include:
elimination of Payroll administration fee, restructuring benefit schemes in a legally proven tax effective
manner, clarifying GGGI obligations to participate in national social security programs for expatriates, and
negotiating lower premiums with service providers. More rigor and due process was brought into staff
recruitment, which resulted in wider outreach to the talent pool and better match of skills to the requirements
of the position. Quality of performance management mechanisms improved significantly by bringing in the
discipline to evaluate against annually agreed individual targets. Further, the discipline to cascade
Departmental and Organizational goals in the Biannual Work Program Budget, approved by the Council, to
individual goals was introduced in late 2014, to enhance organizational effectiveness.
FINDINGS
The Human Resources Unit currently does not manage the manpower in project management processes. HR
neither provides guidance nor enforces strict directions on the consultant progress report, and does not make
enough effort to ensure that the hours worked and the tasks performed by the consultant are accurate.
Furthermore, we observed that the role of the Procurement Unit becomes very similar to that of HR's for
procurement of consultants with a total amount over 80,000 USD. In addition, the number of procurement
staff was found to be very low considering the number of procurement contracts processed.
RECOMMENDATION
As suggested from the findings, there is definite room for improvements for the human resources function of
GGGI.
HR needs to engage more actively when dealing with manpower in the project management process. The
timesheets of time-based consultants are not being managed properly; lo delivery-based consultants, which
requires expertise of the reviewer, was made more difficult because the final output was in the local language.
Since the quality assurance procedure is ineffective, procurement contracts almost always lead to payment
which indicates high risk.
With o sulta ts o stituti g % of GGGI s o kfo e, if HR fails to e fo e st i t
directions and guidelines on consultants working hours and progress reports efficiency and effectiveness could
be critically affected, which could possibly lead to the risk of fictitious employment.
Furthermore, considering the number of members in the Procurement team and the number of procurement
contracts, some roles performed by the Procurement team should be transferred to the Human Resources Unit
to improve overall efficiency. For example, when the contract amount for an individual consultant is above USD
80,000, the hiring process of a consultant becomes similar to that of a general staff member. The combination
of roles will reduce the burden of workload felt by the Procurement team.
CONCLUSION
8
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Executive Summary
We have selected and evaluated one sample because the Human Resources Unit deals with confidential
personal information. The Mongolia country program hired an Ulaanbaatar (UB) -based, national senior
program officer in September 2013. In May 2014, the half-time Seoul-based country program manager
transitioned from GGP&I to KDM at which point, the regional director was officially assigned the role of Acting
Country Program Manager in addition to her other duties. The recruitment process—as approved by GGGI
s
Council in December 2013—fo
GGGI s fi st UB-based
Mongolia country representative began in Q1 of 2014,
but suspended due to the freezing of new hires related to austerity budgets. A second recruitment process
began in Q2, after confirmation that sufficient funds were available into the future for the full-time, in-country
representative.
The
test esult i di ated that GGGI s
Human Resources Unit was not acquiring the appropriate number and
quality of staff at the appropriate cost.
E e though p o u e e t of a o sulta t s se i e is do e
the
Procurement Unit,
a agi g the o sulta t should ha e ee HR s espo si ilit ; ho
ever, HR failed to
provide guidance to consultants on the periodic submission of timesheets and progress reports, and also did
ot o ito the epo ti g p o ess effe ti el
he o sulta ts o pose % of GGGI s o kfo e, hi h
raises doubts on the quality of their final deliverables. On the other hand, improvements have been made in
the area of payroll and compensation management. Despite the improvements, it was still hard to conclude
that the recruiting function operated efficiently because the function was divided between Procurement and
HR. Even though large international organizations divide the HR and procurement function, doing so at GGGI
as a relatively new and small international organization - does not necessarily lead to a better result. In
co
lusio , GGGI s HR fu tio is ot ope ati g effi ie tl o effe ti el .
V.
Finance Management
(For Mongolia and Rwanda Programs)
Satisfactory
The main objectives of evaluating the finance procedure is to assess its economy, efficiency and effectiveness
by reviewing the process design and the quality of deliverables in each step. The scope of finance process
evaluation is limited to the supporting processes related to Mongolia and Rwanda Country programs in 2013
and 2014.
FINDINGS
No deficiency or flaws were found in the budget policy. The overall internal control of the budget process
was well designed with respect to Authorization, Review and Segregation of Duties. However, we observed
that exceptions to the process were made in actual practice in some cases.
GGGI s t a el poli e ui es staff a d Co sulta ts to su it
a mission report within seven days from the
completion of the journey in order to apply for expenses reimbursement. However, there were delays in
submission of mission reports in some instances. Furthermore, the budget check process is unclear.
CONCLUSION AND RECOMMENDATION
Overall, performance of the Finance department related to the Mongolia and Rwanda programs is
satisfactory. GGGI has put in considerable effort to improve the efficiency and effectiveness of the Finance
department. Updating details of the travel expense management policies, improving the quality of work plan
and budget, and practicing of prudent cash planning are
so e of the e a ples of GGGI s a o plish e ts.
However, room for improvement still exists. The budget check function can be improved by ensuring that
only transactions with sufficient documental evidence are processed, and recording the budget check
process in more detail to facilitate completeness and effectiveness and to prevent miscommunications
between departments.
9
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Executive Summary
VI.
Enterprise Resource Planning (ERP)
Satisfactory
The main objective of evaluating the ERP development project and the general Information Technology (IT) is
to assess hethe the p oje t e e utio a d IT a age e t e e e e uted a o di g to the Es e o o ,
efficiency and effectiveness) by reviewing the development of progress, project management and general IT
management in 2013 and 2014.
Professional Standards such as COSO
internal control framework and COBIT-5-IT management framework
were used as references to determine whether GGGI is following the appropriate operating and procurement
procedures.
FINDINGS
The fi di gs o GGGI s ERP p oje t a e as follo s:
-
-
-
The extension of the project schedule is a result of the phased roll out of the ERP system
Approximately 90% of the total expenditure disbursed consists of capitalized assets in accordance
with International Finance Standards (IFS)
The change of the project manager was factored into the rescheduling as a risk mitigation measure
CONCLUSION AND RECOMMENDATION
Regarding overall project management, there is a need to continuously ensure that appropriate review has
been conducted on project details (ex. Project leader, budget estimate vs available resources
including HR
and Equipment, procurement plans for required resources, and overall schedule for developing the systems)
during the planning phase in order to factor in the economy, efficiency and effectiveness of the overall project.
Immediate follow up measures based on analysis of potential risk should be implemented when a change is
made, to increase effectiveness.
Assurance is also needed to confirm whether resources invested in the project are being managed
appropriately. Resource management should include both HR management (such as change of project
manager or team member) and asset management (capitalization), to increase the overall efficiency of the
project.
According to the result of analysis of documents and interviews and evaluation based on the international
standard, COBIT-5, it
is oted that GGGI s ERP de elop e t p oje t has ee
meeting the 3 Es
notwithstanding minor issues such as rescheduling and project manager change. It is expected that the ERP
system will contribute to enhance the 3 Es of the entire organization once finalized in June 2015.
10
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
I. VfM Objectives, Scope, and Methodology
I.
VfM Objectives, Scope & Methodology
11
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
I. VfM Objectives, Scope, and Methodology
VfM Objectives, Scope, and Methodology
Objective
We performed the procedures that were agreed with Global Green Growth Institute
GGGI
with regards to
Value fo Mo e VfM e aluatio to e ie the E o o ,
Efficiency, and Effectiveness of GGGI in regards to the agreed-upon sectors during the
period of two years (from January 1 2013 to December 31 2014), in accordance with
the terms of the contract between us dated February 06 2015.
As a result of the VfM evaluation, findings and recommendations have been made
which may be considered to improve on the efficient and effective green development
program performance in this area.
This VfM evaluation covered the period of two years from January 1, 2013 to
December 31, 2014. The VfM evaluation method included interviewing various
stakeholders, reviewing documents, and analysis of the financial data provided by
GGGI as considered necessary in the circumstances, to obtain reasonable assurance
with regards to:
-
Appropriateness and effectiveness of operating and procurement procedures;
-
Efficiency and effectiveness of internal management, institutional systems,
poli ies a d p o edu es i ega ds to deli e of GGGI s o je ti e;
-
E o o a d effi ie
of GGGI s esou es su h as staff,
equipment and facilities;
-
Effe ti e ess of GGGI s g ee de elop e t p og a s;
To fulfill the requirements stated in terms of reference, the VfM evaluation was
conducted with focus on the Economy, Efficiency, and Effectiveness of the following
management functions of GGGI
-
GGP&I: Mongolia program and Rwanda program
-
Strategy development
-
Finance,
-
Procurement
-
Human resource
-
IT & facilities
-
Business process
GGGI selected the Mongolia and Rwanda programs for review based on the following
criteria: 1) The programs are funded by core support, which is the support modality
used by Denmark; 2) One program conducted in a country geographically far apart
from GGGI headquarters, and one program conducted in a country situated closer to
Seoul; 3) The programs selected should have activities at country level on-going since
2012; 4) Country activities should have a certain volume; and 5) In-country staff are
available for meetings.
Relevant documents necessary to evaluate the sectors above were requested,
reviewed, and analyzed (refer to Appendix 1 for the list of documents requested and
reviewed). Interviews were conducted in addition to analysis of the documents; the
process owners and related employees were interviewed to obtain a better
u de sta di g of GGGI s p o edu es
(refer to Appendix 2 for list of GGGI interviewees).
Lastly, several counterparts in Mongolia were also interviewed in order to obtain the
comments, suggestions, and overall proje
t satisfa tio ith ega ds to GGGI s g ee
development program; due to the limited time in Mongolia (two days), it was not
possible to meet with all program counterparts.
12
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
Scope and General
Approach
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
I. VfM Objectives, Scope, and Methodology
Professional
Standard Used
The VfM Evaluation was conducted in accordance with ISSAI300 (Standards and
Guideli es fo Pe fo a e Auditi g ased o INTOSAI s Auditi g Sta da ds a d
Practical Experience), an audit standard issued by the International Organization of
Supreme Audit Institution (INTOSAI). The Performance Audit standard mainly focuses
on examining the economy, efficiency and effectiveness of the functions and activities
performance of the audited entity, but also includes the verification of the audited
e tit s o plia e ith
established legislation and regulations in its scope. The
standards require that auditors plan the VfM evaluation and report on the economy
and efficiency with which resources are acquired and used, and the effectiveness with
which the objectives are met.
The VfM Evaluation was conducted to achieve the objectives stated in the terms of
reference; the procedures taken to evaluate performance of each sector are described
below:
1.
2.
3.
Re ie GGGI s p o edu es a d
manuals to determine whether GGGI is using the
appropriate operating and procurement procedures;
Perform tests to ascertain whether documented procedures are operating
effectively in practice;
Review the internal management, institutional systems, policies and
procedures to determine the efficiency and effectiveness of delivering the
o ga izatio s o je ti e;
Examine whether GGGI is acquiring the appropriate type, quality and amount
of resources (staff, equipment and facilities) at an appropriate cost (economy);
Examine whether GGGI is using the resources (staff, equipment and facilities)
optimally in delivering the appropriate quantity and quality of services in a
timely manner (efficiency);
Examine if the organization is avoiding issues overstaffing, idleness, duplication
of effort by employees and work that serves little or no purpose (efficiency);
E a i e GGGI s a hie e e ts effe ti e ess ;
Examine the systems and processes that were placed during 2014 to improve
the effi ie , effe ti e ess a d e o o
of GGGI s ope atio s; i ludi g,
Enterprise Resource Planning (ERP) system and new policies (human resources
and procurement); and Examine the above aspects with regards to the two
country programs funded by
GGGI s Co e Fu ds R a da a d Mo golia .
Examine the above aspects with regards to the two country programs funded
GGGI s Co e Fu ds R a da a d Mo golia .
Tasks in the Terms
of Reference
4.
5.
6.
7.
8.
9.
13
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
I. VfM Objectives, Scope, and Methodology
Evaluation
Methodology
Many publicly available external reports were reviewed. Most of the report covered
the periods of 2013 and early 2014; the latest report was the 'Appraisal of Danish core
contribution to Global Green Growth Institute 2014-2016', which was issued on April
28 2014, approximately one year ahead of the current External Value for Money
Evaluation project.
Both interviews with the Head of Department and review of documents have been
used as methods to conduct the evaluation. We only conducted interviews with
selected Head of Departments necessary to conduct the evaluation. Furthermore,
most of the interviewees have joined GGGI as of the second half of 2013. The purpose
of the interview was to obtain a thorough understanding of the GGGI processes and
procedures and GGGI's achievements in 2013 to 2014. Interviews also covered follow-
up questions on the Danish Report. Each interview was summarized and the contents
were confirmed by the interviewees.
Policies, procedures, and manuals provided by GGGI has been reviewed thoroughly.
Sample documents were requested and reviewed to be used as supporting evidence
for the Management level interviewee's assertions, and to obtain information from
the period before the interviewees joined GGGI.
Samples were selected from transactions conducted in the second half of 2014 in order
to check the improvements implemented by GGGI. After reviewing the transaction
samples and the relevant documents, a Findings Report was produced and confirmed

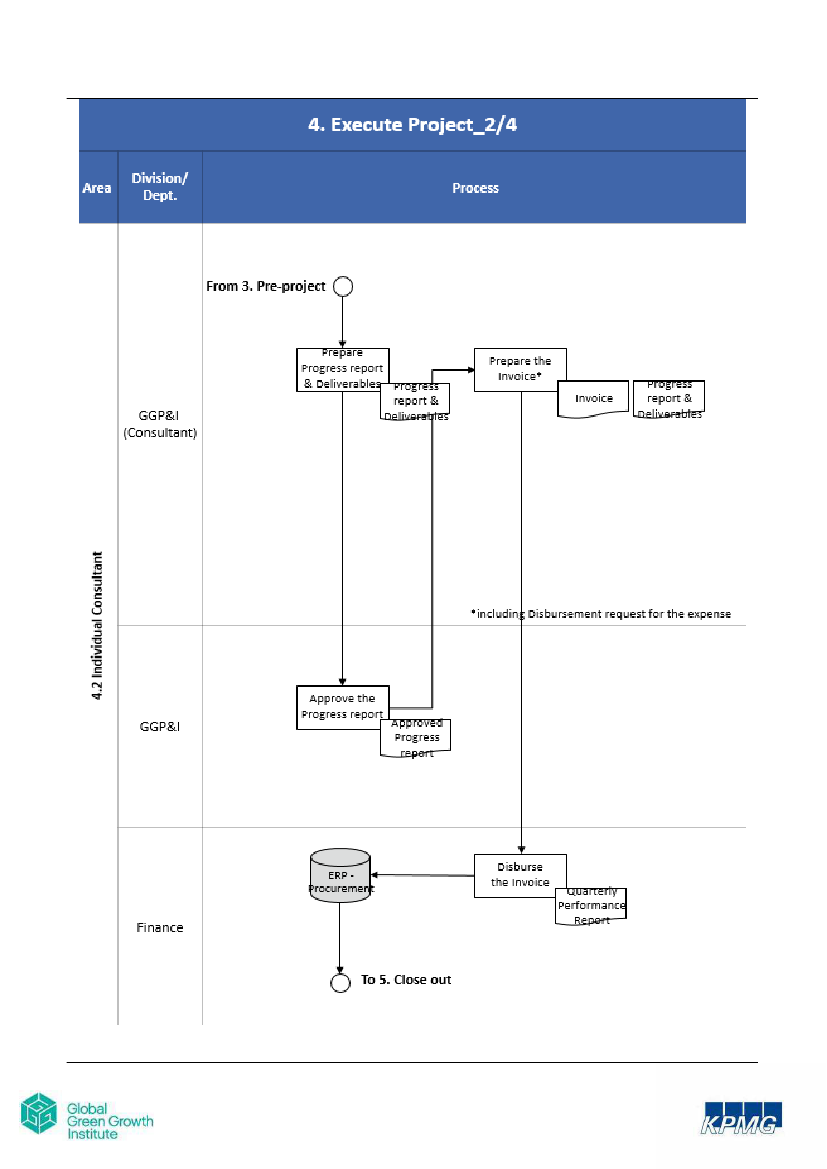

by GGGI. A simplified process map which depi
ts ou u de sta di g of GGGI s i te al
procedures (from reviewing the input & output document and conducting interview)
has been drafted and included in the Annex section 3.
Lastly, we included in our report the improvements implemented by GGGI in 2014 to
follow up on the deficiencies noted in the Danish Appraisal Report, even if the actual
impact of the revision showed after 2015. Doing so would impose additional weight
on the interview summary confirmed by the GGGI personnel, since we did not check
the quality of documents produced during 2015.
14
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
II. Limitations
II.
Limitations
15
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
II. Limitations
Limitations
Basis of
information
The procedures performed are limited in nature and extend to those that GGGI
determined best fit
GGGI s
informational needs. As such, the report may not
necessarily disclose all significant matters about the review or reveal errors and
irregularities, if any, in the underlying information. These procedures do not constitute
an audit of the specific elements, accounts, or items, for which the objective would be
the expression of an audit opinion. Had we performed additional procedures, other
matters might have come to our attention that would have been reported to GGGI.
Furthermore, the sufficiency of the procedures performed is solely
GGGI s
responsibility. Consequently, we make no representation regarding the sufficiency of
the procedures described in the contract dated Feb 6 2015 for the purposes for which
this report has been requested and for any other purposes.
The information gathered or contained in the report was not independently verified;
accordingly, we do not express any opinions or make any representations concerning
the accuracy or completeness of the report. The data included in this report has been
obtained from the information provided to us during the VfM evaluation.
This report is intended solely for the use of GGGI and should not be used by those who
have not agreed to the procedures and taken responsibility for the sufficiency of the
procedures for their purposes. Additionally, our report reflects events and
circumstances as they currently exist. We have no obligation to update our report, or
to revise the information contained herein because of events and transactions
occurring subsequent to April 3, 2015.
-
The document forms and required information in many documents were
modified between year 2013 and 2014; thus, our analysis and review are limited
by this factor.
As most process owners joined GGGI in the second half of 2013, and some joined
GGGI in 2014, information regarding activities which took place before their GGGI
joining date are limited.
As the scope of the review was from the
pe iod
to
, GGGI s a ti ities
and the relevant documents in 2015 that were mentioned, commented, or stated
through the interview were not reviewed.
The VfM evaluation mainly focuses on reviewing the finance functions relevant to
t o of GGGI s
ou t p og a s,
and does not necessarily review all
of GGGI s
finance functions.
Government counterparty interviews regarding cooperation with GGGI in 2013
and 2014 for the Mongolia program were not fully available due to the
government reconstruction of Mongolia.
Reliance on
information
Restriction on
circulation
Other restriction
of the VfM
evaluation
-
-
-
-
16
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
III. GGGI’S Governance
III.
GGGI’s Gove a e
17
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
III. GGGI’S Governance
Institutional
Systems
The Global Green Growth Institute (GGGI) was first established in 2010 as a Korean
non-profit organization, and was converted into an international organization at the
Rio+20 United Nations Conference on Sustainable Development. Since its
establishment, GGGI has been dedicated to supporting the transition of developing
countries and emerging economies towards a green growth model by developing and
implementing strategies that simultaneously achieve poverty reduction, social
inclusion, environmental sustainability and economic growth. As of 2014, GGGI has
launched 35 projects in 22 countries.
GGGI originally operated based on three
pilla s
composed of Green Growth Planning
& Implementation, Research, and Public-Private Cooperation (PPC; PPC has been
replaced by Green Investment Service). In late 2013, the
th ee pilla s e e
converted
to work streams of GGP&I, PPC and Knowledge Development & Management (KDM).
The system was further converted into GGP&I and the Knowledge Solutions Division
(KSD)
follo i g Cou il s app o al i No e e
.
Currently GGGI supports
stakeholders through the two complementary and integrated workstreams of GGP&I
and KSD that deliver comprehensive products and services designed to assist in
developing, financing and mainstreaming green growth in national economic
development plans.
GGGI s o je ti es a d a ti ities that suppo t de elopi g
countries and emerging
economies are described in detail in the Establishment Agreement ratified by Member
ou t ies i
. GGGI s go e a e st u tu e, as outli ed
in the Agreement,
includes the Assembly, Council, Advisory Committee, and Secretariat. The Assembly,
composed of all GGGI members, meets every two years and advises on the overall
di e tio of GGGI a d e ie s the o ga izatio s p og ess i
eeti g its stated
objectives. The Assembly also elects Council members, appoints a Director-General,
a d e ie s the o ga izatio s p og ess i
eeti g its stated o je ti es. The Cou il
se es as the e e uti e o ga of GGGI a d thus app o es the o ga izatio s st ateg ,
budget, admission of new members, and criteria for green growth planning and
implementation programs. The Advisory Committee is a consultative body consisting
of leading, relevant experts and non-state actors. It is responsible for advising on the
strategy and activities of GGGI and serves as a Public-Private Cooperation forum for
green growth.
I No e e
, GGGI s Asse l a d Cou il app o ed the e ge
of the leadership of the Assembly and that of the Council into one, thus creating office
of the President of the Assembly and Chair of the Council. The Secretariat acts as the
chief operational organ of the Institute and is headed by the Director-General, who
represents GGGI externally and provides strategic leadership for the organization to
carry out its objectives.
18
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
III. GGGI’S Governance
Staff
In-country staff have slightly increased since 2013.
as of December, 2013 as of December, 2014
Location
Korea
# of In country
staff
Mongolia
Rwanda
China
Colombia
Ethiopia
India
Indonesia
Mexico
Philippines
Denmark
UK
South Africa
UAE
Vietnam
Grand Total
# Staff
72
28
1
0
1
1
4
3
3
2
0
3
7
0
4
0
101
# Staff
69
29
1
1
1
1
10
3
5
1
1
1
0
1
4
1
100
as of March, 2015
# Staff
71
29
2
1
1
1
10
3
5
1
1
1
0
1
4
1
103
19
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
III. GGGI’S Governance
The pie charts are prepared with Headcount data as of March 2015.
Staff vs Consultant
Ratio of Staffs by Working Location
40%
60%
31%
Staff
Consultant
69%
HQ
In Country
Consultant Part time vs Full time
Ratio of Consultants by Working Location
18%
Full time
Part time
82%
41%
59%
HQ
In Country
Consultant Contract Length
31%
Less than 6
Months
69%
More than 6
Months
20
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
III. GGGI’S Governance
Facilities
According to the Danish Appraisal Report issued in April 2014, GGGI had 3 satellite
offices during 2013-2014 in Abu Dhabi, London, and Copenhagen. In 2014, the GGGI
Council decided to close down two offices (London and Copenhagen) but to open a
European Focal Point with a focus on private sector engagement on green growth,
finance related issues, and donor relations. The pre-existing
GGGI Lo do Offi e s
research function was transferred to the Seoul HQ, and the European Focal Point will
concentrate on the private sector and donor relationships in order to make the
European presence cost effective.
With a
ta get ope i g date of Ma h
, the e Lo do offi e s fu tio
ill e
different from the function of the previous office. In order to reduce unnecessary costs,
GGGI s Eu opea P ese e ill
be located in a multi-used service office, and hire four
desks (3 staffs and one contractor) instead of using its former office with up to 18
people, which constitutes both staff and research consultants. The newly opened
European Focal Point resulted in
edu tio of GGGI s ea l ope atio al ost f o USD
550,000 to USD 120,000.
According to the GGGI Head of Corporate Services, GGGI initiated the Business Process
Management Program (BPM) with the approval from the DDG of GGGI on December
2013. The HR Management Process Map which was established in May 2014 will be
ready for use after ERP launch. Another business process map was put on hold due to
GGGI s p io it
with the ERP system; however it is expected to be completed by the
end of 2016. Once the BPM program is in place, it will be updated on annual basis to
check any omissions in the process steps and linkage among processes.
Business Process
Management
Program
21
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
IV.
Core Fund Project Management
1. Strategy and Planning
2. Mongolia Program
3. Rwanda Program
22
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
1. Strategy and Planning
Overview
First established in 2010 as a Korean non-profit organization, GGGI undertook an array
of institutional developmental processes and procedures in response to donor and
Council recommendations following the 2nd Joint Donor Review and other insight
documents.. Some of the improvements in the strategy and planning process made
du i g the e ie pe iod i ega d to GGGI s st ateg a d pla i g p o edu e a e as
follows:
-
2015-2020 Strategy:
GGGI's 2012-2014 Strategic Plan did not obtain approval
from the Council; GGGI explained that it was due to the fact that the plan was not
prepared in consultation with the member countries. However, GGGI has taken
various procedures such as obtaining internal and external consultations, meeting
with member countries, and attending country team meetings for its 2015-2020
Strategy Plan. In case of Mongolia, GGGI conducted an intensive consultation
session which included a 2-day multi-sector stakeholder workshop with 100
representatives from the public and private sectors and civil society.
-
Workstream integration:
The Appraisal report of GGGI issued by the Technical
Advisory Services of Ministry of Foreign Affairs of Denmark (Danish Appraisal
report) in April 2014 noted that there is weak integration among the three
workstreams (GGP&I, KDM, and PPC) in GGGI. One such example is the unclear
contribution to GGP&I by KDM and PPC. However, PPC had coordinated efforts in
Mongolia with the country team and the Ministry of Economic Development
(MEGD) since January 2014. For example, KDM supported the May study tour of
MEGD and National Statistics Office staff to Korea to explore green growth
indicator identification and definitions. Since 2013, KDM (then Research) has
suppo ted the Mo golia p og a s use of the Lo g-range
Alternative Energy
Planning (LEAP) software tool. In 2014, KDM and the country team also
coordinated
Mo golia s
partnership with the Green Technology Center of Korea
(GTC-K), which also had a strategic MoU with GGGI. This engagement resulted in
the design of a highly energy efficient kindergarten building and is an ongoing
component of GGGI work in Mongolia for both KS and GIS coordination. Also in
2014m GGGI issued a Planning Direction to develop the 2015-2016 work plans
and budgets which addressed such issues. Evidence of integration such as
cooperation or plans for cooperation among the workstreams is captured in the
QIR since 2014
-
Work Plan and Budget:
GGGI first implemented the Work Plan and Budget
template (WPB) in 2014, and moved from a one-year to a biennium work and
budget plan.
-
Result- ased
:
GGGI shifted to a ds esult- ased p og a
s in 2013, which
initially considers wanted outputs to plan the inputs necessary such as budget,
program, and ratio between in house staff and consultants.
-
Program Proposal:
In 2014, Preparation of Program Proposal was conducted by
each country team, and the budget and work plan was connected to a single
document. Previously, the plans were not connected in a single document, and
proposals and directions came from the upper management.
-
Program initiation:
Prior to 2014, GGGI did not have a systematic WPB review
process; it relied only on the division heads. The program manager submitted the
WPB template to the division heads, who submitted the templates to the Strategy,
23
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
Policy and Communication department (SPC). Ever since the Planning Direction
was issued in 2014, each program team fills out a WPB template; a challenge
session is also held to ensure that GGGI sets its strategy and budget appropriately.
Strategy and
Planning Process
In comparison to the previous strategy, which was outsourced to Dalberg Global
Development, the Strategic Plan 2015-2020 was developed in-house within GGGI in
2014.
The Strategic Plan 2015-2020 is the output of the strategic planning process that took
place over the course of 2014. This output is essentially the overarching strategy
do u e t that p o ides guida e to alig GGGI s ope atio s –
both programmatic and
non-programmatic
with the organizational vision and objectives over the next 6 years.
Prior to 2012, there was no organizational strategy. In 2012, the development of the
strategy was outsourced to an external firm. In 2014, GGGI developed the strategy in-
house in order to enhance relevance and buy-in. Strategic planning is a fundamental
process for any organization that is targeting effective delivery of organizational
objectives in the long run.
The effectiveness of the strategy and pla
i g p o ess is also e ide t i the Cou il s
approval of Strategic Plan, as well as the announcement of the Government of the
U ited Ki gdo s de isio to joi GGGI as a Co t i uti g e e at the No e e
2014 Council Session.
The Strategic Plan articulates the strategic priorities, delivery model, and the 2020
high-level targets, and forms the basis of the GGGI Results Framework 2015-2020 and
the Country Planning Framework (CPF) 2015-2019:
(i)
The Results Framework - indicating impact, outcomes and corporate outputs
aggregating program/project outputs - cascades down to program/project-level
logical frameworks and anchors the divisional targets and individual performance
o k ta gets th oughout the o ga izatio . GGGI s O ga izatio Deli e U it ill
monitor these targets and report against the Results Framework and project
Logical Frameworks. These targets are also linked to the work program of the
Human Resources Unit.
(ii) The Country Planning Framework is the guiding strategy for in-country delivery to
be d
i e
atio al p io ities alig ed ith GGGI s st ategi goals.
These two aspects are core to an integrated results-based management
framework/process to achieve an
o ga izatio s i te ded out o es i the lo g te .
The arrival of the current Director General in April 2014, and the submission of the
Work Program and Budget and the Strategic Plan at the GGGI Council meeting in
November 2014, necessitated efficiency in the strategic planning process to
24
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
ensure adequate consideration of diverse views in a relatively short period of time,
and the formulation of an overarching strategy that would be acknowledged by
Me e s fo GGGI s futu e.
The inputs of the planning process and the finalized strategy were as follows: the
process was initiated based on an approved concept note, a clear roadmap of the
i te ded o je ti es, a d a a al sis of GGGI s e isti g st u tu e, go e a e,
programs and service mix, staff, partnerships and resources. The resulting Strategic
Framework was further developed and shaped through numerous intensive internal
and external consultations: five country visits, surveys with GGGI donors, two informal
working group meetings, and two staff retreats. These consultative platforms ensured
representation from GGGI Member countries - both developed and developing
as
well as staff representation through the opportunity to submit opinions anonymously.
The strategic planning process also required a mechanism to operationalize the
objectives of the corporate strategy
the Work Program and Budget (WPB). The WPB
process in 2014 reflected efficiency by establishing a biennium timeframe as opposed
to the one-year timeframe of 2013. This reduces the administrative pressures on
project teams in conducting an annual budgeting exercise and widens the planning
horizon for development outcomes,
Considering
the eed to add ess do o de a ds a d GGGI s fi a ial situatio gi e
the time-specific circumstances, the strategic planning and budgeting process had to
be executed in an efficient manner and run in parallel, in view of the November
deadline: the Strategic Framework provided the basis of the Planning Directions which
was issued to the programmatic divisions for the preparation of the WPB. The WPB
process had to be results-focused: (i) budget ceilings and evaluation criteria aligned
with the Planning Directions were communicated to divisional heads; (ii) budgets
prepared by project teams and consolidated by each division; (iii) the submissions
were evaluated by both SPC and ODU and analysis provided to the Director General;
(iv) budget challenge sessions amongst divisional heads and the Director General; (v)
revision and or refinement of budgets; and (vi) analysis and preparation of the WPB
for the Council.
Conclusion
Overall, 2013 and 2014 was a transformative phase for GGGI and resulted in different
pla i g do u e t e ui e e ts du i g the t o ea pe iod. GGGI s St ategi Pla
2015-2020 and biennium WPB 2015-2016 reflect a shift in organizational thinking and
priorities, built on a common recognition amongst donors and in-country stakeholder
to demonstrate the case for green growth and deliver results on the ground.
A clear set of guiding principles, strategic priorities, and an integrated delivery model
emerged from an intensive strategic planning process through consultative platforms
and intensive discussions which included six country visits, two IWG meetings, an
informal Donor Consultative Group meeting, and the joint Audit and Finance Sub-
Committee and Project Sub-Committee, and staff surveys
in order to reflect lessons
learned and build upon bottom-up input.
25
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
The WPB is the operational tool for the Strategic Plan. The shift to a biennium
timeframe allows for the anchoring of project planning in a longer term horizon.
The launch of the Country Planning Framework, the derivative planning document
for in-country programming and any new project design, is aimed at delivering in-
ou t esults alig ed to atio al p io ities, GGGI s o po ate st ateg a d Results
Framework. Going forward, the draft GGGI Results Framework will require further
refinement of outcomes/outputs (based on the aggregation of biennium project-
level results), inclusion of baseline, indicators, and target. At the project level, all
project-level logical frameworks should be completed, finalized, and nested within
the corporate Results Framework. A methodology will have to be developed to
ensure nesting between project logical frameworks and corporate results framework
for meaningful aggregation of results
26
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
2. Mongolia Program
Overview of the
program
GGGI first engaged Mongolia at a time when the national economy seemed to be going
from strength to strength fueled by extractive industries and a booming southern
neighbor. At the same time, it was clear that business-as-usual approaches were
unsustainable and that climate change was affecting the landscape more rapidly in
Mongolia and Central Asia than nearly any other part of the world. Since the first
Consultative Workshop held in 2012, the Government of Mongolia (GoM) and GGGI
have worked collaboratively on specific priority sectors, including green growth policy
planning, energy, transport and construction. GGGI's programmatic engagement has
espo ded st ategi all
ith the GoM s e ol i g p io ities a d go e
e t
architecture.
Through effective and inclusive programming, GGGI has built the trust of a range of
government partners and stakeholders in the private sector, civil society, and
international development partners. Mongolia is a Member country of GGGI, and
GGGI has a growing presence in country, hosted by the Ministry of Environment, Green
Development and Tourism. Since deploying staff in Mongolia in September 2013,
GGGI s e gage e t a d olla o atio
ith
ministerial counterparts has expanded,
and now includes four ministries and two agencies as well as participation in important
coordinating bodies, such as the Business Council of Mongolia and the Green Building
Council of Mongolia.
During the government restructuring that began in October 2014, GGGI retained
important institutional and policy memory which enabled current government
counterparts to fast-track sustained green growth priorities, such as the National
Green Development Policy, and redefine new ones. In 2013-2014, through substantial
internal changes, GGGI and the GoM maintained a true-north focus that has created
and delivered green growth policies, methods, and projects -- key elements of the
evidence-based foundation of Mongolia's green growth transition.
Staffs:
Two GGGI staff members and one consultant are based in Mongolia as of March
2015 with plans to recruit additional staff and one consultant. Because GGGI does not
have legal status in Mongolia, issues such as absence of visa for employees and bank
accounts
a li it GGGI s a ti ities i Mo golia.
Since Mongolia became a member of
GGGI in June 20 2014, GGGI has been in discussion about a Host Country Agreement
(HCA) with the government. It is expected that the HCA will be finalized soon; however,
the reconstruction of the GoM from October 2014 extended into the 1
st
quarter of
2015 and may cause delay in the HCA process. Of the 22 countries in which GGGI
conducts programs, only two have granted HCA to GGGI. The challenge is a systemic
one that is being addressed by in-country teams, HQ units, and Council members alike.
The restructuring of the GoM in late 2014/early 2015 has served to delay the process
in Mongolia, although discussions are now back on track and under review at the
Ministry of Foreign Affairs.
Budget:
The total budget of the Mongolia program increased by USD 215,660 in 2014
from USD 681,091 in 2013 as the program extended to the general environmental
protection sector along with transportation and energy sector. In 2013, the Mongolia
p og a s
budget was composed mostly of salary expenses, with percentages as high
27
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
as 44%; however, outsourcing expenses increased from USD 28,440 in 2013 to USD
454,276 in 2014, which covered approximately 51% of the total annual budget.
Workstream integration:
The Appraisal Report by the Ministry of Foreign affairs of
Denmark drafted and submitted to the Danish Parliament in April 2014 pointed out
that the integration between the workstreams GGP&I, KDM, and PPC were limited.
However, according to GGGI, the Mongolia program has been well integrated with
other workstreams. For example, PPC has coordinated efforts in Mongolia with the
country team and the Ministry of Economic Development since Jan 2014. KDM
supported the May study tour of MEGD and National Statistics Office staff to Korea to
explore green growth indicator identification and definitions. Since 2013, KDM
supported the Mongolia prog
a s use of the Lo g-range
Alternative Energy Planning
(LEAP) software tool. In 2014, KDM and the country team also coordinated the
partnership with the Green Technology Center of Korea (GTC-K), with which GGGI has
a strategic MoU. This engagement resulted in the design of a highly energy efficient
kindergarten building and is an ongoing component in GGGI work in Mongolia for both
KS and GIS coordination. Since the 3rd quarter of 2013, the Mongolia country team
has been documenting the way in which the workstreams have cooperated or
integrated during the quarter; they have also recorded program opportunities or
requests for future support from the other work streams.
GGGI noted that the Mongolia country team is continuously well connected with the
workstreams. Currently, when the country team receives a request from the GoM for
development in the transportation sector, the work scope is sent to HQ to inquire
whether it is possible for GGGI to conduct the work with internal staff. Pending a
request from the country team, the former half-time country program manager and
now member of the KSD would consider provision of transportation sector-related
knowledge to the Mongolian program and government counterparts. In addition, KSD
has plans to support the country team in the facilitation of high-level knowledge
exchange with other government bodies in the upcoming GGGI-UNEP South-South
capacity building session. KSD also supports the country team in the screening of
program documents related to the water sector and in green indicator development
efforts. In case of integration with the Green Investment Services (GIS) department,
which took responsibility for PPC work, the country team has a person from GIS who
is dedicated to the Mongolia program for program design and launch. GIS has also
participated in liaising with the Ministry of Education and the Ministry of Industry and
Trade in Mongolia. Furthermore, GGGI prepared the preliminary design of GIS
programming for Mongolia in consultation with key stakeholders in 2014.
Team leader:
There have been changes in the Mongolia program team leadership
between 2013 and 2014. The former part time country program manager led the
Mongolian country program from Seoul on a fly-in, fly-out basis from 3
rd
quarter 2013
through the 1
st
quarter of 2014 at which point he transitioned to KDM. The current
country representative
– GGGI s fi st i Mo golia, took up his full ti e duties i the
th
quarter of 2014. During the 2
nd
and 3
rd
quarters of 2014, the Regional Director held
that role and was acting country program manager until the recruitment for the new
28
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
role of country representative was finalized. According to GGGI, the reason for the
delay of Country Representative Recruitment was due to the
GoM s
austerity budget,
which froze new hires. When asked whether the Mongolia program was affected by
the absence of a program leader, GGGI answered that the program was slow-moving
at the time due to austerity budget restrictions and was therefore not affected. Despite
the absence of a program leader, the Mongolia program conducted a green building
technology assessment with the GTC-K, initiate negotiationd for HCA, and conduct a
Consultative Workshop for Aimag (provincial) Government representatives.
Program
Management
I
, GGGI s isk assess e t as o du ted the p og a
a age ased o his
knowledge of the program and included in the COP document. GGGI first conducted
the country program risk identification in 2014 to capture the risk status in the logical
framework that contains information such as descriptions of the activities and
outcomes linked with the related risk identification and risk management strategy.
According to the country team, program risk is assessed through desktop study, field
data collection, and identification of possible risks via QIR document while the HQ
provides recommendations and comments related to risk mitigation. As an example of
risk assessment, GGGI noted that some risk, such as political change, can be predicted
from the voting cycle. However, sudden risks such as abrupt government restructuring
cannot always be predicted. Such political risk is a risk faced by some of the GGGI
country teams and cannot always be predicted beforehand. However, in this case the
Mongolia country team has mitigated the risk by maintaining good relations with the
new government bodies. As a proof of sustained good relations, GGGI received a
request from the new Ministry of Transportation for green transportation
development in January 2015. The Mongolia Country Team is considering the design
of a transport sector activity in 2015. In addition to this proof is an unqualified
endorsements from senior level government officials also bear witness to effective and
sustained good relations, such as those coming from former Vice Minister of the
Environment and Green Development and now current Vice Minister for Education,
Cultu e a d S ie e, M . B. Tulga, ho otes: With its esou es fo Mo golia
programming, GGGI has provided timely and cost-effective assistance in close
collaboration with the government. Our collaboration has helped strengthen the
go e
e ts o
it e t to g ee de elop e t.
The Appraisal Report by the Ministry of Foreign Affairs of Denmark drafted in April
2014 stated that the country team felt detached from the HQ and that there was a lack
of communication, strategic guidance, professional and administrative support. There
has been improvement in project management since the Regional Director joined
GGGI in the end of 2013, as a result of daily communications with the country team,
weekly country team meetings, and a portfolio meeting every month. Finally, GGGI
added that the Country Representative can always communicate with the HQ on at
least a weekly basis through email, phone, or Skype.
Overall, the Mongolia program management by HQ has been well established to
i ease effi ie
a d effe ti e ess of the ou t tea s a ti ities.
Over the course
of the two years that are subject to this VfM audit, the management of the Mongolian
29
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
country program has shifted from Seoul to Mongolia, with a sustained and growing
reputation of impact, relevance, and collaboration. However, there are still remaining
factors to be improved to enhance effective work between the country teams and the
HQ.
Urgent request for procurement approval at the end of the year: During the review of
procurement approval emails for the Mongolia program, it was noted that an urgent
approval request was sent to the procurement department on December 12, 2014,
requesting approval of 3 pending procurement request. The procurement request was
related to 52 Individual Consultant procurement contracts (34 consultants for the
Green Development Roadmap Project and 18 consultants for the Green Indicators
Development Project) with a total contract value of approximately USD 17,900 for the
green indicator development project and the green development roadmap project.
The u ge
of the e uest as ased o the GoM s eed to ha e i sights a d
feedback into conferences and decision-making related to the National
GreenDevelopment Policy by the end of December 2014.While the start date of all the
contracts are December 15, 2014, one of the required documents to finalize the
contracts, consultant CVs, were only fully submitted to the procurement department
on December 31 2014. Furthermore, the review of the procurement list for the
Mongolia program showed that GGGI obtained the receipt of the majority of signed
contracts from the consultants on December 30 2014 (Please refer to Procurement
of 52 Individual consultants procurement contracts [34 consultants for the Green
Development Roadmap Project and 18 consultants for the Green Indicators
Development Project]
i
the Procurement section). In this case, procurement was
related to numerous contract approvals, which the procurement unit had to approve
without sufficient time to thoroughly review the details of the procurement. Whether
this procurement was economical and or efficient or whether there were other options
that GGGI could have taken is not shown in this request. In order for GGGI to ensure
that 3Es are followed in the procurement process, procurement approval request
should not be sent as an urgent matter, in order to give the procurement unit time to
review the appropriateness of the procured service or product. The Country team at
all times should ensure that the procurement schedule is planned in advance and
consider whether it fits the 3E.
Budget
Management
The Mongolia program had a budget reduction during the 4
th
quarter from
USD
713,527 to USD 163,013.
The reason for changes in the total 4Q budget amount was not documented in the QIR.
However, according to GGGI, in Q4 of 2013, GGGI Council passed the 2014 budget, but
i sisted o a % edu tio a oss the oa d, hi h e a e k o as the Dela ed
budget. These figures were communicated to GGP&I staff by the then Deputy Director
General who was also the division head of GGP&I. In Q2 of 2014 when the new DG
arrived, the first round of austerity budgets were announced, along with hiring freezes
which suspended, among others, the first recruitment effort for the country
representative in Mongolia. Regional directors were instructed by the DDG and GGP&I
to manage budgets within their portfolios, rather than at a project level. ODU
continued to issue QIRs with the original budget allocations, and country teams were
30
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
instructed by the DDG and GGP&I to live within austerity budgets even as teams
reported to ODU with the original budget allocations. In September, GGP&I teams
learned that austerity budgets were extended for the remainder of 2014 even though
they had been told that austerity limits would be lifted for Q4 of 2014 and program
ould etu to thei o igi al dela ed udget allo atio s. Agai , ODU issued QIRs
with the delayed budget sums, even though the austerity budgets remained in place
until December 2014. With specific regards to the North and Central Asia region, the
regional director kept her teams informed of the changes throughout, during the
weekly regional meetings, and regular communications and interactions with each
team. During most of the austerity period, she was also acting country program
manager for Mongolia, and was, therefore, highly informed of budget limits and
program targets..
Due to the austerity budgets imposed in April 2014, the Mongolia country team
suspended the transportation sector activities and, at the request of the GoM focused
on energy sector efforts.
QIR:
In 2013, the DDG for GGP&I created the Project Monitoring Team to collect
information related to GGP&I work stream projects. QIRs were developed as a
management tool to allow the DDG to have an
o e all ie of p oje ts p og ess
toward the achievement of the planned results as well as a general understating of the
disbursement level over the year. Based on the information provided in the QIRs, the
DDG for GGP&I was able to report on project results to GGGI executives and to the
Program Sub-Committee.
According to GGGI, QIRs were never meant to serve as detailed financial reports for
external use, but merely to allow the GGP&I DDG to have a general understating of the
disbursement trend. At the end of 2013, the Organization and Delivery Unit was
created within the M&A
d
i isio to o ito all GGGI s p oje ts, ot o l GGP&I o es.
In Q1 2014, the role of QIRs was revised and the financial report section was
definitively discontinued. Since then information about budget execution was
provided only by the Finance Unit via monthly project dashboards. Since Q1 2014 QIRs
have been collected by ODU with the primary objective to inform GGGI executives and
the Cou il s su
-committees
a out GGGI p oje ts po
tfolio performance. We were
a le to e ie GGGI s a ti ities, udget, a d dis u se e t i ega ds to the QIR a d
QPR. From our review of the QIR it was noted that the QIR does not document detailed
information with regards to budget re-allocation and high variance between the
budget amount and the actual disbursement.
1.
Re-allocation of budget with no explanation in the QIR
In the 2
nd
quarter 2013, the QIR showed changes in the budget
i Se to al A tio Pla s
for Green de
elop e t of Mo golia a d
d Phase of T a spo t Se to P og a as
shown in the below table:
31
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
(Currency: USD)
Reporting Quarter
Category
Sectoral Action Plans
for Green
Development of
Mongolia
2nd Phase of
Transport Sector
Program
3Q
150,000
Q1
4Q
150,000
3Q
2Q
4Q
300,000
150,000
150,000
100,000
200,000
While the total amount of budget did not change, no explanations regarding the
reason for budget re-allocation were provided in the QIR.
According to GGGI, budget shift can occur during the year from one category to
another without changes in the total budget amount. Budget re-allocations were
considered under the full responsibility of project managers and the ADG following
their internal decisions. However, during the period of budget austerity, budgets were
allocated on a regional basis from the ADG with Regional Directors finalizing the
allocations across their regions. While Regional directors were requested to revise and
comment on the QIRs for quality assurance and to confirm information correctness
they were not requested to explain why there were changes in budget allocation.
Documentation of the details of the budget re-allocation such as purpose, cause, and
effect can help GGGI monitor and compare how the increase/decrease in input can
affect the efficiency and effectiveness of the program. Tailor-made reports will be
ge e ated th ough the GGGI s ERP P oje t Module s heduled to e fu tio al e d
June 2015) by taking information from different Modules including procurement,
finance, and grant module.
2. High variance between budget and actual disbursement during 2013 and 2014
GGGI implemented the Budget vs Actual Report only about a year ago. In the absence
of an ERP system, ODU had to manually collect information from the project teams
and Finance Unit on 40+ projects with the sole objective to facilitate internal
communication flow and track financial performance at the projects portfolio level
(QPR).
According to GGGI, since ODU was not the primary source of financial data, it was not
in a position to spot and correct errors unless there were clearly evident abnormalities.
32
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
The review of 2013 QIRs and Budget vs Actual Report shows high variance between
the planned budget amount and the actual disbursement amount as below:
2013 Budget VS Actual Disbursement on QIRs
2013 Budget - Actual, Disbursement Rate
$300,000
$250,000
$200,000
$150,000
$100,000
$50,000
$0
Q1
Budget
Q2
Actual
Q3
Variance
Q4
$96,575
$68,071
$68,594
$200,680
70%
$158,948
26%
$163,013
$154,191
126%
$262,555
95%
140%
120%
100%
80%
60%
40%
20%
0%
The above graph shows the Mongolia Program recorded high variance between budget
and actual in 2013 2Q and 3Q disbursement. Due to the absence of detailed
disbursement data for 2013, identification of which planned expenses were not
disbursed or over disbursed was limited.
2014 Budget VS Actual Disbursement on the variance report
2014 Budget - Actual, Disbursement Rate
400000
80.15%
38.11%
200000
$152,636
100000
$107,069
$85,817
$58,165
15.02%
$107,801
$40,245
20.00%
0.00%
2014 Q1
REVISED
2014 Q2
DISBURSED
2014 Q3
2014 Q4
29.20%
40.00%
$369,187
100.00%
80.00%
60.00%
300000
$267,859
0
DISBURSEMENT RATE
The above graph shows the Mongolia program recorded high variances between the
budget and actual disbursement in 2Q, 3Q, and 4Q of 2014. The issue in year 2014 was
that the actual disbursement was significantly lower than the planned budget. The
analysis of the variance report showed that the Mongolia program disbursed less than
50% of its planned budget in all categories as shown below; in some cases,
33
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
the team even disbursed 0% of the budget.
However according to GGGI, the actual disbursement was in compliance with the
austerity budget totals set by the Accounting and Finance Sub-Committee of the GGGI
Council, and the Mongolia country team disbursed austerity allocations in a way that
still met revised targets and government expectations.
2014 budget variance from variance report
Category
Salary and Wages
Supply expenses
Travel expenses
Conference
expenses
Outsourcing cost
Freight expenses
Communication
expenses
Overhead
Budget
(Annual)
221,775.48
3,500.00
62,500.00
97,000.00
454,276.00
2,000.04
18,200.00
37,500.00
Actual
(YTD)
109,126.74
1,290.45
20,402.43
28,768.37
104,009.92
91.73
164.86
0.00
Variance
amount
(YTD)
-112,648.74
-2,209.55
-42,097.57
-68,231.63
-350,266.08
-1,908.31
-18,035.14
-37,500.00
(Currency: USD)
Disbursement
rate
49%
37%
33%
30%
23%
5%
1%
0%
High variances between budget and actual may indicate that 1) The budget planning
was not conducted with full consideration of the program process, or that 2) The
program has not performed efficiently as initially planned, or that 3) There has been
an unexpected event. During the interview the Regional Director indicated that she
communicates with the country team when variances between the budget and actual
disbursement are present. However, explanations for variance were not documented
on the variance report or the QIR. Although GGGI stated that the DDG, Head of GGP&I
Division, instructed regional directors of austerity allotments, the country team and
GGGI should record and document the analyzed cause of the variance to help the
country programs plan appropriate budget amounts in the future.
Procurement
Request
In regard to the Mongolia program, we reviewed two procurements related to
procuring consultants and noted the followings:
1. Evaluation method for work performed by consultant
In October 2014, the current country team leader first joined GGGI as a consultant for
the country representative position; his status changed to staff member in March 2015.
According to GGGI regulation, consultants procurement by GGGI are required to
submit a progress report for hours worked (timesheet) and work performed in order
to receive payments from GGGI.
1. Information such as date, number of days, number of hours, start time, finish time,
duty station, and a short brief of activities performed can be submitted in the
timesheet. GGGI determines and approves the hours worked by consultants only
through the monthly timesheet submitted by the consultant at the end on the month.
Because the hours of work and activities are used for the basis of consultant payment,
GGGI elies o the o sulta t s o
epo t.
34
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
On the timesheet submitted by the then-consultant on December 2014, the time
submitted included time spent on lunch or dinner. For example, the timesheet
indicates that the consultant worked for 12 hours, from 9:00 AM to 21:00 PM on
December 11th, 2014. However, although it is reasonable to assume that time was
spent on lunch and dinner breaks, such meal time seem to be included along with the
hours worked. Similar cases (inclusion of lunch or dinner hours in the number of hours
worked) can be found throughout
the o sulta t s su itted ti esheets f o
November to January. Due to the absence of an evaluation method for the working
hours in GGGI, such hours were approved based on weekly discussions with the
Regional Director, and the deliverables and actions were also discussed and agreed to.
Invoices were approved if it abided the agreed upon requirements.
According to GGGI, HR instructed the then-consultant to complete his timesheet in a
manner consistent with staff, rather than as a procured consultant. However, because
the consultant was initially procured as a consultant, GGGI should follow the
procurement process instead of utilizing both the procurement and the HR (staff
recruitment) processes. It should be noted that if regulations can be bypassed with
e eptio s, effe ti e ess of GGGI s egulatio s a d i te al o t ol a de ease as
the number of exceptions increase.
2. Procurement request details
The rationale for forming 52 consultant procurement contracts (34 consultants for the
Green Development Roadmap Project and 18 consultants for the Green Indicators
Development Project) with individuals related to the Government of Mongolia is not
described on the procurement request document - 82.5% (Number confirmed by the
Mongolia Country Representative) of the 52 procurements relate to government
personnel.
According to GGGI, these individual consultants were procured based on relevant skills
and experience required for the task; the 52 consulting contracts are related to the
Green Development Roadmap Project which included the following:
- Written contributions to the review and/or development of green development
implementation plans (i.e. roadmap)
- Participation in working group sessions
GGGI added that the services provided will make up a critical component of the
Government of Mongolia
s a ilit to i ple e t its Natio al G ee De elop e t Poli .
These services will also assist in the formulation and multi-stakeholder commitment
to GGGI s
-2020 strategic country framework for Mongolia. Furthermore, GGGI
also emphasized
Vi e Mi iste Tulga s lette to GGGI
(5 May 2015) which confirms the
benefit and impact of this intervention by noting:
The o sultati e o kshops that
took place in 2013 and 2014, particularly those in December 2014 in Ulaanbaatar,
helped to e su e oad i put i to the go e
e t s g ee g o th pla i g a d egi
the p o ess of appl i g atio al st ateg to the eeds of lo al o
u ities.
Without the rationale, it is difficult to determine whether the procurement is
e o o i al, effi ie t, o effe ti e fo GGGI s a ti it pu poses. To dete i e
whether GGGI is utilizing its resources in accordance to the 3Es, GGGI should
35
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
document the rationale for procurement on the procurement request form in order
for any reviewers to monitor the appropriateness of the procurement. In addition,
procuring services from government-related individuals must document in detail
purpose, outputs of the service, and how GGGI benefited from the outputs for the
transparency purpose of the interaction.
Issues in the Progress report by the consultant
Although GGGI has flexible working hours, it is important to monitor the real working
hours put in by the consultant if the consultant is paid in a lump sum each month.
Furthermore, the consultant works in a different country and often works from a
remote location, making it difficult to supervise the working hours.
Findings from the sample of consultant’s
p og ess epo t
The consultant prepared a Monthly Timesheet and Activities Log from October 11,
2014 which was before the contract start date of October 13, 2014. Expense
reimbursement of USD 693.03 was also requested prior to the contract start date
based on the timesheet. Furthermore, the consultant treated Saturday and Sunday as
working days in December 2014 and January 2015, and billed based on these
timesheets.
(Currency: USD)
Month
GGGI Paid
KPMG's
assertion
Month
GGGI Paid
October
2,844.20 = 5day * 568.84
2,275.36 =
4day
* 568.84
The contract start date was Oct 13,
Not Oct 12
December
= 22day *
13,083.40
594.70
=
12day
*
7,136.40
594.70
3 Annual leaves has been provided
to the consultant in monetary
form (component 2 of the salary
according to Procurement No.PAI-
2014-358); as a consultant he
should ot e appli a le to GGGI s
benefits.
Also, overtime work should not be
included in the working hours.
Included 3 Saturday and 1 Sundays
as working days; weekends should
not be included in the calculation
February, 2015
November
13,083.40 = 20day * 654.17
13,083.40 = 20day * 654.17
Agreed
January, 2015
13,083.42 = 21day * 623.02
10,591.34 =
17day
* 623.02
Consultant
Management
KPMG's
assertion
Included 1 Saturday and 4 Sundays
as working days; weekends should
not be included in the calculation
Month
GGGI Paid
KPMG's
assertion
One of two pages is missing so
could not check the amount
36
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
Counter-party
Interview
Prior to the Mongolia trip, GGGI organized the meetings and interviewees to be met
in Ulaanbaatar for VfM evaluation; however, some of the counterparts who
cooperated with GGGI on green development program in 2013 and 2014 could not be
interviewed due to the restructuring of the Mongolia government.
Three of the seven public sector representatives (i.e. Enkhtaivan (Energy), Tumenjargal
(Energy), Batbold (Transportation), and Mr. Gerel-Od (Climate Change) had been
involved in the GGGI program during 2013-2014. In addition, one of the five
representatives of Clean Energy LLC (Sukhbaatar (Energy)) had been involved in GGGI
programming during 2013-2014. The new ministry personnel currently cooperating
with GGGI were interviewed instead for the public sector. The people on the list below
e e i te ie ed to e aluate the effe ti e ess of GGGI s g ee de elop e t
programs in Mongolia:
Mongolia program
Public Sector
Department/office
Ministry of Environment,
Green Development and
Tourism
Department of Strategic
Policy and Planning,
Ministry of Energy
Strategic Policy and Planning
Department, Ministry of
Roads and Transportation
Ministry of Roads and
Transportation
International Relations
Division, Ministry of
Environment, Green
Development and Tourism
Name
Ms. Saranchimeg Batsukh
Mr. Enkhtaivan G.
Mr. Tumenjargal M.
Mr.Batbold S.
Mr. Batbayar Ch.
Dr. Jae-Hong Kang
Title
Member of UB City Council
and Advisor to the Minister
of Environment
Deputy-Director General
Senior Officer
Senior Officer
Officer
Officer
NIPA Advisor
Officer, International
Cooperation Division
(Formerly Officer in Climate
Change Coordination
Office )
Mr. Gerelt-Od Ts.
Mongolia Program - Private Sector
Department/office
Clean energy
(One example of a private
sector entity with which
GGGI has had programming)
Name
Mr. Sukhbaatar Ts.
Mr. Jamiyandorj P.
Mr. Amar
Mr. Enkhsaikhan
Ms. Dashmaa D.
Title
CEO
Chief Technical Officer
HSE Officer
Senior Electrical Engineer
Admin and Document
Control Officer
According to the interviews, the majority of the counterparts first encountered GGGI
through consultative workshops or group activities held by GGGI, such as the first
aimag and multi stakeholder consultations on green development organized and by
GGGI and MEGDT. GGGI worked together with the public sector to identify the key
objectives of green development, and issued a report on green public transportation.
In addition, GGGI also supported the Government of Mongolia in the development of
the Mongolia National Green Development Policy. Clean Energy LLC, the private sector
counterpart, indicated that they were able to gain valuable information through the
GGGI workshops.
As e ide e of GGGI s suppo t to the go e
e t i de elopi g its
37
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
National Green Development Policy, the analysis of long-term energy scenarios are
di e tl efle ted i the NGDP s ta get of a hie i g % e e a le
energy generation
by 2030.
The counterparts in the public sector felt that GGGI had valuable information,
expertise, and knowledge on green growth development, but indicated the need for
specific information on green growth in Mongolia. Clean Energy commented that
GGGI s p og a is fo oth pu li a d p i ate se to
s and that one of the
accomplishments of GGGI is that GGGI was able to break barriers between ministries
and GGGI. Lastly, Clean Energy added GGGI enabled them to cooperate with
Mongolia
s
Ministry of Economic Development.
The o e all le el of satisfa tio fo GGGI s g ee de elop e t p og a p o ided to
both public and private sector is high. The Department of Strategic Policy and Planning
of Mi ist of E e g oted that GGGI s k o ledge a d o
it e t to Mo golia s
green development is acknowledged. Both the public and private sector interviewees
commented on future plans to cooperate with GGGI for green development of
Mongolia.
Below are suggestions provided to GGGI by the counterparts in Mongolia:
- Provide GGGI reports in Mongolian language in addition to the English version
- Organize capacity building sessions and cooperate in the implementation phase of
the green development
- One of the counterparts interviewed commented that although GGGI provided
strong study and research, they are hoping for tangible, real-life results which can
be used by the end user. The counterpart also commented that GGGI's long term
support is needed for Project Pipelining and technical support.
-
Provide specific design of the development programs and provide more hands-on
support in the implementation phase. In addition, Department of Strategic Policy
and Planning of Ministry of Energy suggested that a Mongolian personnel be hired
to o k ith GGGI to o tai GGGI s k o ledge a d e pe tise o the jo .
Recommendations
The followings are recommendations for improvements and changes that can be made
by GGGI to enhance its 3Es in its activities:
Program Management
Urgent request for procurement approval at the end of the year
All of the 52 transactions (34 for the Green Development Roadmap Project and 18 for
the Green Indicators Development Project) related to this urgent request violated the
proper procurement sequence; the final approval by the Head of Procurement was
given right before the ending date of the contract. Causal analysis showed that the
issue was due to the Mongolia
P og a Cou t Rep ese tati e s poo p epa atio of
the Procurement Request; the Head of Procurement attempted to ensure that all
required request documents were of proper quality.
Whether this procurement was economical and or efficient or whether there were
other options that GGGI could have taken were not shown in this request. In order for
38
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
GGGI to ensure that 3Es are followed in the procurement process, procurement
approval request should not be sent as an urgent matter, and time should be given to
the procurement unit to review the appropriateness of the procured service or
product. Country teams at all times should ensure that the procurement schedule is
planned in advance and consider whether it fits the 3E.
Budget Management
Re-allocation of budget with no explanation in the QIR and High variance between
budget and actual disbursement during 2013 and 2014
Documentation details of the budget re-allocation such as purpose, cause, and effect
can help GGGI monitor and compare how the increase/decrease in input can affect the
efficiency and effectiveness of the program.
GGGI s ERP P oje t Module that ill
be
functional by end of May 2015, is built to factor in efficiency and effectiveness in
project management. GGGI will no longer uses QIRs, as such processes would be
recorded through the ERP so that the program performance can be monitored and
evaluated along with the total input by the organization to determine whether 3Es are
being followed throughout the project.
Procurement Request
Absent an evaluation method for work performed by consultants based on the
timesheet and contract reviewed during the VfM evaluation, a need for GGGI to
implement a clear and objective consultant management system was identified. The
Mongolian program consultant contract should have included details such as whether
the contract is time-based or output-based or if there are any benefits to be provided
by GGGI. In addition, it is unclear as to whether the working hours submitted in
timesheets were actually used for GGGI related work. The direct supervisor should
have monitored and confirmed the
o sulta t s effi ie t a d effe ti e use of ti e a d
contribution throughout the project.
In addition, GGGI should follow the procurement process instead of utilizing both the
procurement and the HR (staff recruitment) processes. It should be noted that if
egulatio s a e passed ith e eptio s, effe ti e ess of GGGI s egulatio s a d
internal control can decrease as the number of exceptions increase.
Procurement request details
To determine whether GGGI is utilizing its resources in accordance to the 3Es, GGGI
should document the rationale for procurement on the procurement request form in
order for any reviewers to monitor the appropriateness of the procurement. In
39
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
addition, procuring services from government-related individuals must document in
detail the purpose and outputs of the service, and how GGGI benefited from the
outputs for the transparency purpose of the interaction.
In addition, GGGI should acknowledge the risk associated with hiring 43 out of 52
consultants (34 consultants for the Green Development Roadmap Project and 18
consultants for the Green Indicators Development Project) related to the government
during the time of government restructuring and that this lacks the rationale in the
procurement request. Engaging individual consultants who undertake some form of
government service should clearly demonstrate the absence of overlap in the
consulting service and the individual's other duties.
Consultant Management
Since the person who has the responsibility and authority to confirm a
o sulta t s
working hours is the Country Representative (CR), the CR should refrain from granting
preferential treatment to consultants without consulting with HR and Procurement
first. Furthermore, the CR or the Regional Director should openly express their opinion
on the timesheets to HR and Procurement if the format or the contents seem to be of
insufficient quality.
Conclusions
In general, the Mongolia Project achieved its main objectives. Despite the austerity
budget which brought significant internal limitations, the Mongolia program has
managed to support ratification of National Green Development Policy (NGDP) in
Mongolia. The instability of the Government of Mongolia in 2014, which resulted in
the replacement of the entire government, came to GGGI as both risk and opportunity.
Although the restructuring of the Government of Mongolia poses certain limitations
in the Mongolia country project, relationships are now re-established and productive,
as confirmed in statements by public sector counterparts. The country team also
extended partnerships into the private sector and civil society.
However, despite these achievements, definite room for improvements were
identified during the VfM procedure. As scope of the Mongolia program expands and
cooperation with the Government of Mongolia increases, it is crucial that GGGI
maintain an accurate and thorough internal documentation that depicts the activities
of the country team in detail in the ERP Project Module (to be launched by end of May
2015) including changes in the budget (whether the change is a mere re-allocation or
modification in the total budget amount) in order to achieve effective budget
management.
Furthermore, the most significant of the deficiencies noted is the recruitment of the
Country Representative which occurred during the second half of 2014. Review of the
consultant progress report suggested that consultant management was not being
performed appropriately, which damages both effectiveness and efficiency.
Furthermore, too much preferential treatment was provided to the consultant
without discussing with HR and Procurement in advance. Lastly, although payments
were provided to participants of GGGI workshops - of which 83% were government
related - there were no clear explanations as to why the payments were provided.
Therefore, it is hard to
40
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
conclude that the Mongolia project management was performed in an effective and
efficient manner.
41
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
3. Rwanda Program
Overview of
Program
The primary objective of the Rwanda program is to directly support the
implementation of the Second Economic Development and Poverty Reduction
Strategy (EDPRS2) 2013-2018 and the National Strategy for Green Growth and Climate
Resilience of Rwanda. The project started on September 2012, and consists of two
different phases: Resource Efficient and Affordable Housing and National Urban Policy
for Green Growth as Phase 1, and Develop Rwandan Secondary Cities as Model Green
Cities with Green Economic Opportunities as Phase 2. The project scoping (for phase
1) was conducted from January to August of 2012, and actual implementation of Phase
1 started on September 2012. The MOU was signed between GGGI, the Ministry of
Infrastructure, and the Rwanda Housing Authority on September 2012. Due to
completion of Phase 1, GGGI was able to provide strategic and technical advice to the
Government of Rwanda (GoR) through the National Territorial Vision, and also provide
the Strategy for Green Growth towards 2030. In addition, GGGI provided analysis on
the Local Construction Material for Resource Efficient & Affordable Housing in Rwanda,
and finally, provided the Policy and Legal Framework for Energy Efficient Housing in
Rwanda. GGGI initiated Phase 2 in January 2014 to develop six secondary cities as
model green cities with green economic opportunities, as inscribed in EDPRS2.
The work activities of the Program, discussed and confirmed by the GoR and GGGI are
as follows:
- Component I: Conduct preliminary analysis on the potential for green growth of
Kigali and secondary cities;
-
Co po e t II: De elop a G ee Cit f a e o k a d guideli e fitti g i to
the
Rwandan secondary city context;
- Component III: Develop a National Roadmap on secondary city development; and
-
Component IV: Enhance capacity of government employees and GGGI staffs by co-
developing appropriate tools
In April 2015,
R a da s Ca i et app o ed GGGI s Esta lish e t Ag
eement to show
its commitment to cooperating with GGGI to achieve the development of secondary
cities as green cities with green economic opportunities.
The GoR has decided to strengthen six secondary cities as centers of growth through
EDPRS 2. This is to transform the economic geography of Rwanda by facilitating and
managing urbanization and promoting secondary cities as poles of economic growth.
At the sa e ti e, EDPRS i o po ates a g ee e o o
app
oach to economic
transformation with two interventions related to the promotion of green urbanization
as well as green innovation in the industrial and private sectors.
In line with
GGGI s alue p opositio a d st ateg to o e lose to i ple e tatio ,
GGGI as part of its 2015 and 2016 work is currently in discussion with the GoR to
develop the institutional structures and capacity needed to develop a Green City
Investment Strategy and pipeline of bankable projects.
Program team:
The governance aspect of the project has been stable as the team
leader has not changed since the 1
st
quarter of 2013. The Regional Director became
involved in the program at the start of the 4
th
quarter of 2013. In January 2015, GGGI
appointed a Country Portfolio Director who manages 5 other countries in addition to
42
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
Rwanda. The Country Portfolio Director will relocate to HQ on June 2015. The Rwanda
Country Representative (CR) is based in Kigali.
Workstream integration:
The 2014 Danish Appraisal Report pointed out that GGGI
lacked integration amongst the three workstreams. GGGI noted that during the period
of the Appraisal, the role of KDM and PPC was to conduct research and studies
relevant to green growth at the HQ and did not integrate with country team in regard
to the country program.
Improvements in integration of the workstreams have been made now; country
team members are able to cooperate among workstreams based on their needs. For
example, KSD obtains data and information from the country teams to establish the
strategy and plans. The data is then sent to the country team, where the data is
utilized to work with the government.
Furthermore, PPC and KDM were merged in Q4 2014 to form the Knowledge
Solutions Division which has Knowledge Solutions (KS) and Green Investment
Services (GIS). GIS has replaced PPC.
As for integration with PPC, PPC plans to establish an investment strategy after the
completion of the roadmap according to the 2015 Rwanda Program strategy, which
documents how the investment plan should be made during each action phase.
Private sector integration:
Another issue noted in the Danish Report was the
insufficient level of integration with the Private Sector. According to GGGI, the
Danish report was issued when the Rwanda Program was in a phase where
government related personnel were frequently met to conduct research on the basic
status a d to o tai p oje t eeds fo uildi g the p oje t p og a . Although
private sector entities, such as the Rwanda Energy Group, were contacted, formal
relationship were still at the exploratory stage.
Since the issue of
e e ship as GGGI s top p io it , a ti ities e e fo used o
the GoR rather than the private sector; the private sector played minimal role at this
stage of engagement with the government.
GGGI noted that part of the plan for drafting the roadmap in 2015 is to include the
comments from the private sector as well as the public sector. On September 02-03,
2014, the Rwanda project conducted a large-scale joint consultation with PPC (now
KSD) in Kigali. The joint team organized 13 meetings with public and private sector
entities, international and national stakeholders, including Crystal Ventures, Private
Sector Federation of Rwanda, Rwanda Development Bank.
Program
Management
The 2014 Danish Appraisal Report drafted in April 2014 stated that the country team
felt detached from HQ and that there was a lack of communication, strategic
guidance, professional and administrative support. According to the Country
Portfolio Director, detailed guidelines form the HQ were lacking in 2013 and 2014.
Many improvements have been made to date and the Director General holds
conference calls on a regular basis and moving forward the plan is for the country
team leader to visit Rwanda each month to meet related personnel.
During the VfM evaluation, the following findings were noted with respect to the
program management of the Rwanda program:
43
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
1.
Delay in Project schedule and deliverables
The Rwanda program consists of two phases, and each phase consists of scope and
implementation steps. The scope step of Phase 1 was performed in 2012, and the
implementation step commenced in September 2012. During the QIR review, it was
noted that both the closing date of the phase 1 implementation step and the
launching date as well as Phase 2 scoping step had been delayed multiple times.
Specifically, the closing date of phase 1, recorded as March 2013 on the 2013 1
st
quarter QIR, had been changed to April 2013 on the 2
nd
quarter, and changed once
again to December 2013 on the 3
rd
quarter.
In the case of Phase 2, the original closing date of December 2014 was extended to
March 2015 on the 2013 4
th
quarter QIR. Furthermore, review of QIRs indicated
multiple delays in publication issuance and consultant reports. For instance,
although the National Territorial Vision and Strategy for Green Growth towards 2030
was originally planned to be delivered in August 2013, the actual delivery was made
in December 2013. The reason for the delay and extension of the deadline was not
stated in the QIR reports.
Please refer to the table below for the details of the delayed schedule.
Program phase
Phase 1
Phase 2
(Original closing date)
Actual closing date
(Mar 2013)
(Apr 2013)
Dec 2013
(Dec 2014)
Mar 2015
Original delivery
date
Aug 2013
Extended
9 months
3 months
Consulting
firm
KICT
Deliverable
Local Construction Material
for Energy Efficient &
Affordable Housing in Rwanda
National Territorial Vision and
Strategy for Green Growth
towards 2030
Institutional and Legal
Framework for Energy
Efficient and Affordable
Housing in Rwanda
Energy Status of Rwanda and
the Strategy for Green Growth
Preliminary analysis on the
potential for green growth of
Kigali and secondary cities
Green city framework and
guideline
Revised delivery
date
Dec 2013
KRIHS
Aug 2013
Dec 2013
AURI
AJOU
UNIVERSITY
GGGI
GGGI
Aug 2013
Dec 2013
-
Aug 2014
Dec 2013
Aug 2014
March 2014-
<Project phases and deliverables>
44
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
It was not evident in the QIRs whether the delays in the project phase and deliverables
ee o
u i ated to the elated ou te pa ts a d do u e ted i GGGI s e o ds.
However, after conducting an interview with the Rwanda CR, we found that the delay
in project schedule and deliverables was neither due to a lack of project management
skills nor due to incompetency of the consulting firm. It was due to a combination of
reasons including the considerable time that consultation takes and the lack of a
permanent Rwanda team. Furthermore, counterparties made many requests
as
GGGI tried to reflect each request in its output, the schedule was delayed and so was
the final output. Even though it was not explained in the QIR, the Rwanda team had
internal briefing session.
2. Project performance evaluation
The Rwanda country team did not have a performance evaluation method during
the review period of 2013 and 2014. According to GGGI, work performed during
2013 and 2014 consisted mostly of research and stakeholder engagement, which
was difficult to establish a specific timeline for. Currently, the project team uses a
result matrix and established a logical framework. The logical framework describes
all activities by stage, which is reviewed afterwards to check whether the activities
are performed and/or completed appropriately.
3. Quality Assurance for deliverables based consultant
The Rwanda CR stated that the deliverables of the Rwanda projects have all been in
English up to now, and also commented that if a client requires final deliverables in
the local language, an English version will be published along to ensure effective
quality review.
4. Quality Assurance for time based consultants
Three new time-based consultants were hired in 2015 for the Rwanda Project. When
the CR is in Rwanda, she ensures the working hours of the consultants in person.
When she is away, the responsibility of consultant management is delegated to
another personnel. However, the Rwanda Country Representative is hoping to
devise a more effective method of confirming consultant working hours even from a
remote location. Lastly, the Rwanda CR stated that standard working hours of
consultants are 8:00 AM to 5:00 PM, and that hours worked on weekends are not
recognized.
5. Compliance
The Rwanda CR also ensured that no payments are provided to Rwanda governors
or the private sector in return for participating in GGGI programs.
Budget
Management
According to the 2013 QIRs and 2014 variance reports, the
R a da P og a s
budget was USD 414,305 in 2013 and increased to USD 934,933 in 2014. In 2013,
over 50% of the budget was allocated to GGGI personnel expenses, including a
Senior Program Manager, Program Manager, and Program Assistant/Officer. Budget
for travel expenses of USD 74,128 was the second largest. As the phase in 2013 was
to scope the project and communicate with the government, budget for consulting
services occupied a relatively small amount, USD 23,529, for individual consultants.
The Rwanda team requested a budget revision in the 4
th
quarter of 2013. As a result,
45
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
the USD 135,000 originally budgeted for phase 2 of the Rwanda program was
reduced to zero, while the budgets for salaries, wages, and travel expenses were
doubled. Furthermore, according to 2013 4
th
quarter QIR, the team requested for
increase in the 2014 budget to purchase services from external outsourcing service
provider.
Comparing the budget for 2013 and 2014, salaries and wages have increased by 62%,
which is the largest increase excluding budget for outsourcing (consulting) services
which began in 2014. On the other hand, the number of employees and manpower
input did not change very much, averaging 3 persons during 2013 and 3.5 persons
during 2014. However, after conducting an interview with the Rwanda CR, we found
that this was due to a change in allocation rate resulting from cancellation of the
ENC project.
During the review of the QIR and variance report, high variance between the budget
and the actual disbursement was noted.
Although the average disbursement rate for the 2013 and 2014 budgets is
approximately 80%, the rate has fluctuated significantly in the 2
nd
quarter of 2013.
In 2
nd
quarter 2013, the Rwanda team disbursed more than 180%; however, a
quarter later the disbursement rate dropped to 31%. In the 2
nd
quarter 2014, the
disbursement rate marked its lowest of 18% due to the outsourcing payment of USD
163,000 not being made as scheduled. The reason for non-execution of payment
was not documented in the QIR. According to GGGI, in the absence of an ERP system,
ODU had to manually collect information from the project teams and Finance Unit
on 40+ projects with the sole objective to facilitate internal communication flow and
track financial performance at the projects portfolio level (QPR). According to GGGI,
since ODU was not the primary source of financial data, it was not in the position to
spot and correct errors unless they were clearly evident.
The review of 2013 QIRs and Budget vs Actual Report shows high variance between
the planned budget amount and the actual disbursement amount as below:
(Currency: USD)
Period
Budget
Revised
Actual
Rate
2013 Q1
43,989
43,989
43,161
98.12%
2013 Q2
77,407
77,407
143,525
185.42%
2013 Q3
162,842
162,842
51,421
31.58%
2013 Q4
255,762
130,067
84,375
32.99%
2013 Total
540,000
414,305
322,482
77.84%
2014 Q1
2014 Q2
2014 Q3
2014 Q4
2014 Total
50,235
50,235
31,838
230,458
230,458
43,487
450,254
450,254
185,154
203,986
203,986
159,445
934,933
934,933
419,924
<2013-14 Budget Revision and Disbursement>
63.38%
18.87%
41.12%
78.16%
44.91%
One of the reasons for such variance was due to the low disbursement rate of salaries
and wages as shown on the table below. According to the variance report of 2014, the
disbursement of salaries and wages for the first five months was 70% on average, and
46
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
the rate decreased to 31% in June and July; the rate fluctuated from 141.15% to 17.42%
in August and September.
In 2014, payment of salaries and wages of full time staff did not follow the initial
plan as the average disbursement rate approximated about 58%. Only about half of
the budget was processed, and the disbursement rates also fluctuated highly with
standard deviation of 32%.(Currency: USD)
<2014 Monthly Disbursement of Salaries and Wages>
Period
Budget
Actual
Disbursement Rate
Period
Budget
Actual
Disbursement Rate
Jan
11,195
8,050
71.91%
Jul
25,666
8,050
31.36%
Feb
11,195
8,050
71.91%
Aug
25,666
36,227
141.15%
Mar
11,195
8,050
71.91%
Sep
93,582
16,298
17.42%
Apr
11,831
8,050
68.04%
Oct
37,582
16,298
43.37%
May
11,831
8,050
68.04%
Nov
37,582
16,298
43.37%
Jun
25,666
8,050
31.36%
Dec
37,582
16,298
43.37%
High variances between budget and actual may indicate that 1) The budget planning
was not conducted with full consideration of the program process, or that 2) The
program did not perform as efficiently as initially planned, or that 3) There has been
an unexpected event. The explanation for variance was not documented on the
variance report or the QIR. However, after conducting an interview with the Rwanda
CR, we found that it was also related to the changes in allocation rates resulting from
the cancellation of the ENC project.
Outsourcing
Management
During the performance of the Rwanda program, GGGI contracted a consulting firm
during the 1
st
quarter of 2014 for the purpose of the Developing Rwanda Secondary
Cities as Model Green Growth Cities with Green Economic Opportunities project.
The total budget for this consulting contract was USD 380,000 in 2014. The total
actual expenses for outsourcing services in 2014 was USD 164,560 which is less than
50% of the total budgeted amount as shown in the table below.
(Currency: USD)
Period
Jan
Feb
Mar
Apr
May
Jun
Budgeted
0
0
0
0
0
160,000
Actual
0
0
0
0
0
0
Period
Jul
Aug
Sep
Oct
Nov
Dec
Budgeted
0
0
220,000
0
0
0
Actual
96,000
0
0
64,000
0
0
<2014 Outsourcing Budget and Actual>
The budget amount of USD 160,000 out of USD 380,000 was scheduled to be
executed in June, but zero dollars were paid that month; a month later, only USD
96,000 (60% of the original amount) was processed due to low quality output by the
consultancy firm. Furthermore, of the USD 220,000 scheduled to be executed in
September, only USD 64,000 (30% of the original amount) was processed, again one
month later. Therefore, it can be concluded that the execution of the contract was
postponed, and that the payment was not processed as originally planned.
47
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
According to GGGI, the delay in project payment was due to the following reasons:
-
Consultation itself takes up a lot of time, and the lack of the presence of
permanent Rwanda team was challenging. Further, counterparties made many
requests and as GGGI tried to reflect each request to its output, the schedule was
delayed and so was the final output.
-
The Project schedule was delayed from July 2014 to February 2015 with 3
amendments to the contract. The contract required the consulting firm to submit
two reports, with payment being made based on the submission of reports.
-
The report for Component 1 should have been delivered by March 2014; however
the contract was amended, and the report was submitted in July 2014. The
consulting firm did not deliver the report on time. Due to restraints in budget at
the time, GGGI decided to delay the project schedule and process the payment at
a later time than to force the consulting firm to meet the project schedule.
The submission date for report on Component 2 was shifted from December 2014 to
February 2015, due to the GoR
s dela ed e ie ; the
GoR reviewed and provided
feedback on the report submitted by the consulting firm. The consulting firm would
then edit the report based on the government feedback.
Counterpart
Interview
Prior to the Rwanda Trip, GGGI organized meetings for interviewees to be met in Kigali
for VfM evaluation. KPMG was able to interview the key person for the Rwanda project.
However, some of the counterparts previously interviewed for the Danish Appraisal
Report could not be interviewed due to scheduling conflicts. Therefore, interview was
conducted instead with their delegators who had an understanding of and participated
in GGGI
s R a da p og a .
The Rwanda Energy Group limited is one of the agencies under the Ministry of
Infrastructure, entrusted with expanding, operating and maintaining the energy
i f ast u tu e i the ou t . REG as a p odu t of the GoR s e e t efo that
led to
the dissolution of the former Energy Water and Sanitation Agency (EWSA). REG has
two subsidiaries, the Energy Utility Corporation Limited (EUCL) and the Energy
Development Corporation Limited (EDCL). The people on the list below were
intervie
ed to e aluate the effe ti e ess of GGGI s
support for the implementation of
the Second Economic Development and Poverty Reduction Strategy (EDPRS2) in
Rwanda:
Rwanda program
Public Sector
Department/office
Rwanda Energy Group(REG)
Mr. Patrick Mwesige
Rwanda
Authority(RHA)
Housing
Mr. Edward Kyazze
Name
Mr. Jean Bosco Mugiraneza
Title
CEO, Rwanda Energy Group
Technical Advisor, Energy &
Water Sector Reform
Head of Housing, Urban
Planning & Development
Division
Division Manager,
Urbanization, Human
Settlements, and Housing
Development Division
Director General
Coordinator - FONERWA
Ministry of Infrastructure
Rwanda Environment
Management
Authority(REMA)
Mr. Ir David Niyonsenga
Dr. Rose Mukankomeje,
Mr. Alex Mulisa
48
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
Rwanda Program - Private Sector
Department/office
Crystal Ventures
Name
Mr. Elias Baingana
Title
Chief Operating Officer
GGGI has worked very closely with them to support EDPRS2. In the case of REG, GGGI
is in discussion to hire a senior level consultant to provide direct support for working
in the REG office. Since there are fewer senior level staff who has experience and
knowledge of infrastructure economy in different countries, this consultant is expected
to transfer the knowledge/skill by training other staff in REG.
The counterparts in the public sector have considered the last two years as a
preliminary stage to cooperate with GGGI and are very eager to see the roadmap
which will be delivered by GGGI this June. They have a strong desire for rapid economic
development and a green growth approach but felt that they have a lack of knowledge,
skills, experiences and information. They have a very high expectation that GGGI can
support them in the manner of transferring skills/knowledge, helping to recruit the
relevant experts, perform pre-studies, facilitate introduction to the relevant parties
who are their role models and adopting new and feasible technologies. More
importantly they wish to develop a more stable and reliable partnership with GGGI;
therefore they are very satisfied that GGGI is working out of the Ministry of
Infrastructure building.
GGGI s
presence in-country has given the GoR the expectation
that the a e ei e GGGI s suppo t
more often through face to face meetings.
The counterparts in the private sector also have high expectations from cooperation
with GGGI, especially in regard to implementing bankable project after the roadmap is
delivered. Besides the feasibility test, they hope that GGGI can introduce and negotiate
with the funding company on behalf of the private sector.
Overall,
ou te pa ties satisfa tio
with working with GGGI is very high. The
interviewee from the Rwanda Housing Authority rated
GGGI s se i e
10 out of 10.
Below are suggestions provided to GGGI by the counterparts in Rwanda:
-
Need to have tangible results, at least some pilot testing results or a visual
demonstration so the stakeholders can easily
u de sta d GGGI s deli e a les
-
Boost program awareness by arranging workshops and introducing
stakeholde s e gage e t p og a
-
Provide progress status notifications including rescheduling/
challenge/obstacles so enhance ministry engagement with the project
Recommendations
The followings are recommendations for improvements and changes that can be made
by GGGI to enhance its 3Es in its activities:
Program Management
Delayed project schedule and deliverables
Project delay is understandable, but there is a need to analyze the cause and result
49
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
IV. Core Fund Project Management
in order to prepare remedial action plans. Also, the analysis should be recorded into
QIRs for recording purposes and Knowledge Management. Without it, preparing the
QIR has not accomplish its fundamental purpose.
Project performance evaluation
Project performance evaluation is necessary to evaluate the 3Es of GGGI activities.
In order to determine how the input has resulted in an efficient and effective output,
GGGI should establish an evaluation method that not only reviews whether actions
are performed, but other aspects as well.
GGGI also needs to establish an organization-wide or regional wide KPI to enable
comparison between programs. If government implementation of outputs is set as
the KPI, some countries with high country-level-risk may show as a failure no matter
how great the program management and outputs were.
Budget Management
It is understandable that high variances between budget and actual may incur but
the lack of detailed explanation or analysis brings unnecessary attention.
Outsourcing Management
It is understandable that an outsourcing service contract has delays but the lack of
detailed explanation or analysis brings unnecessary attention.
Conclusions
Overall, the performance of the Rwanda program is satisfactory.
There were some project and deliverable delays in the period of 2013 and 2014.
However, it as this happens in the course of general business there is no significant
exception or abnormality drawing our attention. The project is well managed and
operating efficiently and effectively.
However, this does not mean that there are no improvements needed. As the
Rwanda program progresses, it is crucial that GGGI maintain an accurate and
thorough internal documentation that depicts the activities of the country team in
detail.
50
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
V. GGGI’s Operations Management
V.
GGGI’s Ope atio s Ma age e t
1. Procurement
2. Human Resource
3. Finance
51
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
V. GGGI’s Operations Management
1. Procurement Management
Overview
The role and objective for Procurement is to achieve Value for Money, by means of
obtaining the best terms and conditions for fulfilling the GGGI needs, and by making
use of a competitive market. In 2013 GGGI decided that one of the most effective ways
to obtain Value for Money was to establish a Procurement Unit. This was effectuated
by hiring a Head of Procurement, who joined GGGI in September 2013.
We have performed tests on the samples selected to examine whether GGGI is
acquiring the appropriate type, quality and amount of resources (staff, equipment and
facilities) at an appropriate cost for the Mongolia and Rwanda programs. We have also
checked whether the resources acquired are being used optimally in delivering the
appropriate quantity and quality of services in a timely manner, and whether the
documented procedures are operating effectively in practice. Professional Standards
such as COSO
an internal control framework - and Sarbanes Oxley regulations were
used as references to determine whether GGGI is following the appropriate operating
and procurement procedures.
As part of the test procedure, relevant documents were reviewed and an interview
was conducted with the Head of Procurement. The details of the interview are as
follows:
- Total number of Interviews: 3
- Total interview time: 115 minutes
- Interview Purpose: To gain a thorough understanding of the procurement process
Lastly, a simplified process map of the procurement function was created after
reviewing the relevant documents and confirming the interview summary. The process
map focuses mainly on the activities that produce the output of each procedure; a
copy of the process map can be found in Appendix 3, and the findings are also listed
with the process map as a reference.
History of
Procurement
Management
The main function of the GGGI Procurement team is to acquire the goods, services,
and outsourcing at the best possible price in order to meet the needs of the acquirer
in terms of quality, quantity, time, and location.
Prior to September 2013, GGGI's procurement management function was
decentralized, and procurement affairs were managed by each division due to the lack
of the procurement team. These deficiencies, which were pointed out in the Danish
Report, were remedied starting in mid-2013. To obtain Value for Money, GGGI
introduced a new procurement rule in June 2013, and in order to strengthen the
procurement function appointed a Head of Procurement in September 2013.
Furthermore, a standardized procurement request template has been introduced as
of early 2014, and the Head of Procurement reviewed and approved all procurement
requests. As a result, an official, centralized Procurement Unit was created in the Seoul
headquarter.
Furthermore, the Head of Procurement emphasized that even though the heavy
workload and the lack of workforce (composed of one department head and one staff
member) has imposed a burden upon the procurement team, over 600 contracts
ep ese ti g so e of % of GGGI s udget e e p o essed ithout dela despite
the heavy workload.
52
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
V. GGGI’s Operations Management
The percentage of consultant related contracts out of all procurement contracts is as
follows:
2013
2014
By number of contract
By contract amount
Mongolia
No data available
85%
89%
Rwanda
100%
25%
1%
Findings
[Policies]
After reviewing the procurement rules, Delegation of Authority (DoA)
manuals, and the changes to DoA, we have noted that the procurement approval
procedure appropriately changed depending on the contract type and the amount.
However, although the policy is well established, some deficiencies were found in
practice. Secondly, although the DoA mentions vendor management, the procurement
ules do ot i lude o te ts elated to Due Dilige e o
e do Ma age e t .
A o di g to the Head of P o u e e t, GGGI s e do due dilige e p o edu e la ks
an objective criteria as it consists of only the Head of Procurement's independent
review. Furthermore, the professional liability insurance's contract guarantee
percentage level is decided based only on the Head of Procurement's opinion. Prior to
forming a contract with the vendor, the vendor should be evaluated upon clear and
objective criteria such as the vendor's financial status. The documents required from
the Vendor should also vary depending on the result of evaluation.
[Procedures & Process]
We noted that the internal controls of the procurement
process are well designed with respect to authorization, review, and segregation of
duties, as seen on the procurement process map. However, some user made
exceptions were identified in practice.
The Compliance Status of the Internal Procurement Procedure: Mongolia Program
- The Annual Procurement Plan for the Mongolia program was only submitted for
2014; a procurement plan was not submitted for the year 2013.
- Procurement requests (PR) were not processed in a systematic manner prior to
September 2013; instead, requests were handled by the teams (requesting
procurement) themselves. Hence, the current procurement team does not have
the custody of the relevant PR document; the documents are kept by the each
team.
- A certain percentage of the procurement contracts created after September 2013
were not processed appropriately, and only the disbursement requests were
submitted.
-
55 out of 66 contracts (83%) for the Mongolia program in 2014 did not comply
with the proper procurement procedures. The project had started before the final
approval was given, and the request for contract approval was submitted
immediately before the project
s
final date in most cases. Furthermore, 2 contracts
were approved by the Head of Procurement past the project end date.
53
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
V. GGGI’s Operations Management
Procurement of Individual Consultants for the Mongolia Country Representative
One procurement contract was made during the fourth quarter of 2014 for the
Mongolia Country Representative (CR). This procurement contract has adapted rules
from both the Human resources and the procurement department.
- Supporting documents necessary to prove that the procurement was either
budgeted in advance or had gone through budget reallocation could not be found.
- The consultant is subject to annual leaves & compensation.
- The consultant procurement contract was created to prepare for future possible
transfer to a permanent employment agreement. After the transfer, the salary
component corresponding to the benefits the consultant receives would be
deleted, as the consultant would be applicable for GGGI benefits after the transfer.
The Head of Procurement explained that GGGI is not able to execute employment
agreements due to lack of legal status in some countries; consultant contracts are
therefore the only options to perform duties in such countries.
- To recruit the Mongolia CR, the HR process was applied instead of the Procurement
process. According to Head of Procurement, interviews and selection of the best
candidate is done by the end users under supervision from HR. This was a special
case because the candidate was hired as a consultant only because employment
as a staff was not allowed.
(Please
refer to the Human Resource Management section to see whether GGGI
is acquiring the appropriate type, quality and amount of resources at an
appropriate cost.)
- The consultant contract did not comply with the Delegation of Authority
Manual. When the amount of a consultant contract is over USD 80,001, the
Director General, not the Deputy Director General, should select the
consultant.
GGGI has explained that it is due to the fact that the decision was in
accordance with the HR rules for staff hiring, whereas the decision on
selection was made by HR. To manage the fact that GGGI were not able to hire
the person as staff, a temporary consultant contract was executed. It was not
deemed feasible to undergo a new procurement process for this, i.e. start all
over. The HR procedures are in essence identical with the procurement
procedures.
- By reviewing the relevant procurement documents, we noted
that the o sulta t s
Monthly Timesheet and Activities Log (called Progress Report) had abnormal
contents. During November and December 2014, the consultant worked 56 hours
during 17 business days from a remote location (specific detail of the location is
not mentioned). On some days the consultant worked only one or two hours per
day.
(Please
refer to the Human Resource Management section for more explanation.)
Procurement of 52 Mongolian governors for the Green Development Roadmap
Project (34 for the Green Development Roadmap Project and 18 for the Green
Indicators Development Project)
- 79% of the contracts were made on December of 2014.
- 94% of the contracts were signed with Mongolian program counterparties. The
proper procurement sequence was not followed as the contract was signed after
the project start date. The contract date is the same as the project ending date.
- Although we could not find any supporting documents on the decision to hire
Mongolian governors for the Green Development Roadmap Project (the
consultant is an officer of the Ministry of Industry and therefore, participating in
54
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
V. GGGI’s Operations Management
the project should have been one of his tasks as the Mongolian officer), GGP&I
provided an explanation. Please refer to 2. Mongolia program in chapter IV. GGGI
s
Core Fund Project Management.
Compliance status of internal procurement procedure: Rwanda Program
- An Annual Procurement Plan was not created in 2013 and 2014.
-
Procurement requests (PR) were not processed systematically before September
2013. Such issues were handled individually by the teams requesting procurement.
-
Therefore, the procurement team does not have relevant PR documents regarding
the PR; the documents are kept by the teams.
3 out of 10 contracts (30%) did not comply with the proper procurement procedures:
For the Danish Appraisal Preparation Project, EAC Scoping Project, and Rwanda
Programs, the project commenced before the final approval was made.
55
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
V. GGGI’s Operations Management
2. Human Resource Management
Overview
The main objective of evaluating Human Resource (HR) Management is to assess the
economy, efficiency, and effectiveness by reviewing the Design of Process and the
quality of deliverables in each step. The scope of the HR process evaluation is limited
to supporting processes related to the Mongolia and Rwanda country programs which
happened in 2013 and 2014.
To examine the HR procedure, interviews were conducted with Head of HR and the
Compensation and Benefits Specialist, and documents were reviewed.
-
-
-
The total number of Interview: 2 times with Head of HR and 2 times with the
Compensation and Benefits Specialist
The total interview time: 120 minutes
Interview purpose : To gain a thorough understanding of the HR process
We have performed sampling tests to examine whether GGGI is acquiring the
appropriate type, quality and amount of resources (staff) at an appropriate cost for
the Mongolia and Rwanda programs, and whether GGGI has been using such resources
optimally in delivering the appropriate quantity and quality of services in a timely
manner. Additionally, whether the documented procedures are operating effectively
in practice was also reviewed.
The simplified process map of the Human Resource function drafted after the
interview summary was confirmed and the relevant documents that were reviewed
can be found in Appendix 3. This simplified process map focuses mainly on the activity
which produces the output of each procedure. The findings are also listed with the
process map.
Since most HR data includes sensitive personal information, HR performance was
evaluated by interview and its confirmation unless there was points to be clarified. For
this reason, HR function evaluation heavily relies on the interview summary, rather
than the sampling tests.
Progress of
Human Resources
Unit in 2013 and
2014
Although, centralized management and official documentation standards existed even
in 2013, the system was standardized and made more efficient in 2014. GGGI
implemented Staff Regulations and Rules, a Learning-Development-Policy, a Policy on
GGGIs Representation Expenses, and a Policy on Opportunities for Visiting Persons to
and from GGGI. GGGI recruited two HR professionals from January 2014 (the Senior
Compensation & Benefit Specialist, and the Head of Human Resources), responding to
the previous audit comments. The impact of bringing these skills in HR areas resulted
in significant cost savings for GGGI and its staff, hence Value for Money. The examples
of cost savings include, but are not limited to: elimination of Payroll administration fee,
restructuring benefit schemes in a legally proven tax effective manner, clarifying GGGI
obligations to participate in national social security programs for expatriates, and
negotiating lower premiums with service providers. More rigor and due process was
brought in to staff recruitment. The quality of performance management mechanism
56
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
V. GGGI’s Operations Management
improved significantly by bringing in the discipline to evaluate against annually agreed
individual targets. Further, the linkage of individual work targets to the Departmental
and Organizational goals in the Bi-annual Work Program Budget approved by the
Council, was established, to ensure organizational effectiveness.
Each division head managed personal leave and vacations in 2013; in 2014, a personal
leave coordinator in each division began to support division's vacations management.
The role of this coordinator is to help managers follow up on personal leave requests.
The personal leave system itself has been automated through use of ERP. Since ERP
provides automated checking functions, risks that a staff uses more personal leave
than she/he is allowed can be prevented. In 2013, allowance payment was processed
though the IS system, therefore requestors could ask for allowance payment at any
times. However, starting in 2014,the allowance system has been consolidated into
payroll and began to be paid on a monthly basis.
57
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
V. GGGI’s Operations Management
Interview
summary for
Human Resource
Unit
1. Human Resource Function
GGGI s Hu a Resou es Re uiti g fu tio is di ided a o g
the entire organization,
with HR sharing its role and responsibilities with the procurement function. HR
oversees staff recruitment and procurement oversees consultant recruitment; the
differences between staff and consultants are as follows:
1) GGGI staff is under a fixed-term contract (1-year minimum, 3-year maximum)
Furthermore, staff are entitled to compensation and benefits such as annual
leaves, health insurance, and retirement funds.*
2) Consultants employment terms are short and definite, often less than 1 year;
duties are project-oriented and ad hoc based. Staff are usually employed for longer
term, and their duties are not specifically project-oriented.
Consultant recruitment is controlled solely by the Procurement Unit, though HR
provides advisory services. Such division of roles and responsibility (R&R) is common
for international organizations, such as World Bank, Asian Development Bank and
United Nations. The reason consultant procurement is managed by Procurement and
not HR is that Consultants are normally individuals or organizations who are hired to
manage the short term or specific workforce needs of the organization and therefore
have a different set of internal processes of acquiring, contracting, invoicing and
managing them. In most countries the regulatory framework for contracting
consultant is also different from contracting employees/staff, which could have been
another reason to keep the two under separate departments. GGGI expects all its
workforce (consultants/staff/contractors/interns) to uphold the similar work ethics
and code of conduct.
1.1 Staffing Plan
In order to avoid overstaffing, idleness, duplication of effort, and work with little or no
purpose, GGGI performs a chain of controls in each country program and division
which are then reported to the Council. By the chain of controls, an approver or a
requestor should ensure that the above inefficiencies do not take place.
It is ea h di isio s espo si ilit to e su e the o siste
a d ele a
of staff
requests
ith o k p og a s o je ti es. E e tuall , all staff e uests ill e e ie ed
by the Council and those within the resources pledged by the donors will be approved.
A Staffing plan, driven by the biannual work program derived from the 2015-2020
strategy, is prepared by each division. The plan is then internally reviewed at different
levels and at the Council, which then is approved as the Work Program and Budget
2015-
. HR s ole i the pla i g phase is
to provide advisory services, data, and
technical comments.
HR provides a platform and ensures due process is followed for staff recruitment;
58
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
V. GGGI’s Operations Management
eventually, a qualified staff for each position should be recruited according to Staff
Regulations and Rules, and job descriptions.
Staffing is an activity that is interconnected between relevant divisions including
Human Resources.
A clear alignment among
GGGI s ea st ateg pla , ie ial o k p og a a d
the
budget of each division, and the staff plan of each division was created to ensure that
all staff requests share the common purpose of strategic objective achievement.
1.2 Follow up on the Danish Appraisal Report
The Danish Report pointed out that although GGGI recognized the ideal allocation of
manpower between HQ and country to be 50:50, the process of allocation adjustment
was slow partially due to financial distress. On this issue, the Head of Human Resources
confirmed that the current manpower allocation for GGGI is 69% HQ and 31% country,
and 58% business and 42% administration as of end of February 2015.
The delay to ratify Host Country Agreements is another reason for the slow
deployment of staff in-country. However, headcount limits imposed by Council and
hiring freezes linked to austerity budgets had the largest impact in how and when staff
were hired.
2. Payroll & Compensation Function
2.1 Payroll
GGGI's payroll process was partially outsourced in 2013 to Ernst & Young, specifically
in tax calculation. From 2014, GGGI started managing all of its own payroll to achieve
cost saving (economy) and efficiency. To ensure efficiency, GGGI operates the process
in compliance with DoA, and the full implementation of the ERP system is expected to
strengthen the efficiency by automating the controls. For instance, to validate a
monthly payroll GGGI reconciles the
u e t o ths pa oll ith pa oll f o
the
previous month. The result of reconciliation is approved by DoA. The reconciliation for
Employee Benefits, Pension, and Medical Insurance is performed via reliable external
resources
2.2 Compensation
GGGI has improved its leave and allowance benefits gradually and has been ensuring
efficiency by following proper DoA and control measures. In 2013, with manual leave
processes and forms, all leave or allowance request were submitted via email or
memorandum. GGGI designed and implemented standardized forms in August 2014.
Tha ks to ERP, a auto ated he k o
as i t odu ed a d i ple e ted. ERP s
personal leave module was implemented in Nov 2014 and all approvals and
calculations have been automated.
3. Performance Measurement for staff
Performance management is performed to determine
hethe GGGI s staff has
adequate skills required to conduct assigned tasks, link the individual annual goals to
the organizational business goals (2015-2016 Work Program and Budget), and ensure
the effe ti e ess of staff s pe fo
ance, output and outcome against the annual i
59
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
V. GGGI’s Operations Management
ndividual goals. GGGI's performance management system consists of a 5-tier
performance rating, from unsatisfactory to excellent. The performance level of a
staffmember shall be appraised once per year, in accordance with procedures and
guidelines established by the Director-General. The process starts with setting an
annual goal, and each division head evaluates staff's achievement in comparison with
the goal and gives a proper rating. If a staff gets a rating below satisfactory, he or she
would not be granted annual salary increment.
GGGI s a age e t de ided to diffe e tiate the pa i ease o l fo those ho do
ot eet the satisfa to
ati g. GGGI a ot e ead to diffe e tiate the
incentives further yet based on performance because GGGI is a relatively newly
esta lished o ga izatio , a d o l has
ea s e pe ie e of pe fo a e
management. Further, concern and feeling of unfairness may arise if a differentiated
incentive system is implemented before employee perception adjusts to accept
performance management. Therefore, the differentiated incentive system should be
implemented once the employee culture evolves to accept performance management.
Employees (both those being evaluated and those that evaluate) understand the key
principles of Performance management, and Performance culture matures at GGGI.
The HR manager also commented that some donors are not receptive to more than
inflationary salary increase.
GGGI started to set a more rigorous performance target for each staff at the beginning
this year. Furthermore, according to GGGI all three CPDs have aligned their KPIs and
that of their teams with organizational, DG, and divisional performance targets for
2015. By the end of 2015, one full circle of efficient performance management will
have occurred. GGGI recognizes that a link between performance and rewards is
needed. In the 2015 work plan GGGI decided to design both monetary and non-
monetary rewards for performance. The current system already utilizes a result-based
approach, as each staff sets a goal (linked to the Departmental goal) at the beginning
of the year, and their performance is evaluated against the goals at the end of the year.
An incentive mechanism for 2016 could either be monetary or non-monetary.
Findings
[Procedures & Process] HR related Findings from Procurement of the Country
Representative
Mongolia
The contract sample was examined to determine whether GGGI was acquiring the
appropriate type, quality and amount of resources (quasi staff) at an appropriate cost.
The reason this contract was selected as a test sample is that the contract was found
to have taken irregular procedures which GGGI had not taken in the past, even after
considering the fact that GGGI is a new organization. Secondly, the amount of the
o t a t is elati el high, a d the o t a t as eated a out
o ths afte GGGI s
60
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
V. GGGI’s Operations Management
passing of the Cash Flow Drainage in 2014. Lastly, it is a relatively new transaction and
made after issuance of the Danish Appraisal Report. For these reasons, relevant email
records among the relevant stakeholders such as the DDG, HR, GGP&I and
Procurement was reviewed.
Although budget was not allocated for this transaction, a document noted that budget
was checked by the Senior Strategy & Planning Specialist and Budget Officer in May
and October 2014.
The Human Resources Unit currently does not manage the manpower in the project
management process. HR neither provides guidance nor enforces strict directions on
the consultant progress report, and does not make enough effort to ensure that the
hours worked and the tasks performed by the consultant are accurate.
According to GGGI, enforcing the activity of consultant progress reports is not part of
HR espo si ilities. Mo ito i g p og ess a d ti e sheet is pa t of o sulta t s
a age s espo si ilit . Ho e e , as all
orkforce in GGGI are supposed to follow the
highest standards of work ethics and excellence in their office, HR uses all
opportunities to educate/support the managers to drive the performance orientation
in their teams.
Furthermore, we observed that the role of the Procurement Unit becomes very similar
to that of HR's for procurement of consultants with a total amount over 80,000 USD.
In addition, the number of staff on the procurement team was found to be very low
considering the number of procurement contracts processed.
The Job Description and Qualifications required for the Country Representative
position noted in HR Requisition Form was compared and analyzed. Candidate
A declined an interview offer. The awarded consultant had received higher
61
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
V. GGGI’s Operations Management
interview scores than Candidate B.
Testi g app op iate type, uality of Resou es a ui ed y o pa i
Qualifications
Awarded Consultant
Candidate A
Masters or PhD
MBA,
and
B.A. in
MPA and B.A. in
level or
Physics
and
Geography
equivalent,
Anthropology
preferably in
Engineering,
Economics, or
Business and
Finance
10 years of
Not all experiences
Very strong record of
relevant
are relevant, and
relevant Experience,
experience.
months of the career over 20 years
start and end date
are not shown.
Multi-cultural
literacy and easily Yes
Yes
adaptable
Strong oral and
written English
Yes
Yes
essential
Fluency in
Mongolian an
Conversational
None
advantage
g a didates’ CV
Candidate B
Masters of
Science,
Agricultural
Economics
B.A. in Business
Administration
Very strong
record of relevant
experience, over
20 years
Yes
Yes
Basic
Resources were acquired at an appropriate cost by comparing the salary for Previous
and current Country Representatives.
Both the previous Country Program manager and current Country Representative are
grade C3 level staff. However, only the current CR resides in Mongolia; the previous
Country Program Manager resided in Seoul. Furthermore, the previous Country
Program Manager had about 10 more years of experience, but the base annual salary
is slightly higher for the current CR.
62
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
V. GGGI’s Operations Management
Recommendation
[Recommendation 1]
HR needs to engage more actively when dealing with manpower in the project
management process. Currently, consultants constitute about 40% of GGGI
s o e all
workforce. If HR does not enforce strict directions and guidelines on how consultants
calculate and prove working hours and improve the progress report template, the risk
of fictitious contracts being made would increase. The media in Korea has already
accused K-GGGI of being used as a money laundering route by Korean Government by
making contracts with multiple individual consultants in the past.
1
0F
[Recommendation 2]
For performance evaluation of individuals, we recommend introducing the 360-degree
feedback (multi dimension evaluation) to produce fair results. The supervisor has
power to evaluate his or
he staff s pe fo a e; the efo e, the e e ists a isk that the
evaluation result is biased due to personal relationships between staff.
[Status in 2015 as Confirmed by GGGI]
GGGI is already introducing the 360. The DG
committed to this at the beginning of the year, and it is in the approved 2015 HR Work
Program to roll out.
[Recommendation 3]
More evaluators and appraisers need to be involved in the assessment procedure, such
as colleagues and clients. Furthermore, staff should also be evaluating their
supervisors.
[Status in 2015 as Confirmed by GGGI]
GGGI contemplated to introduce a multi-rater
feedback mechanism for the 2014 evaluations, but after rigorous discussion, the
Management Team decided it is premature to do so given the small size of GGGI and
the early stage of instigating performance culture.
[Recommendation 4]
Even though procurement of consultants is managed by the Procurement Unit,
a agi g a d p o idi g guida e a d o e sight to these o sulta ts should e HR s
responsibility. HR should at least provide consultation service to procurement or
cooperate with the Procurement Unit
.
1
http://www.wkh.kr/khnm.html?mode=view&artid=201402251610121&code=115
63
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
V. GGGI’s Operations Management
[Recommendation 5]
Considering the number of Procurement team staff members and the number of
procurement contracts, some roles performed by the Procurement team should be
transferred to the Human Resources unit. When the contract amount for an individual
consultant is above USD 80,000, the hiring process of a consultant becomes similar to
that of a staff member. We believe that combination of roles will reduce the workload
burden felt by the Procurement team. We have considered the fact that other
international organizations also differentiate between recruiting consultants and staff.
However, compared to the other organizations, GGGI is a relatively new organization
with a different organizational size, and is still establishing and developing its internal
procedures; therefore, direct benchmarking of other international organizations may
not be the most efficient method.
Conclusion
The payroll and compensation management sectors seem to have improved. However,
it is hard to conclude that the recruiting function is being operated in an efficient way
because the function is divided between Procurement and the Human Resources unit.
In particular, for Procurement Contract No.PAI-2014-358, the division of roles between
two departments involved is vague; the rules and policies of both the Procurement
and Human Resources unit were applied as a result, leading to ineffectiveness. Even
after considering the fact that GGGI is an international organization, HR should still be
more actively involved in relevant processes, such as providing feedback and opinions
and working towards improving management tools such as document formats.
Though we evaluated only ONE sample test, the result of the test is quite unsatisfactory.
GGGI is not acquiring the appropriate type, quality and amount of staff at an
appropriate cost based on the test result.
Also, the lack of guidance and monitoring of
the o sulta t s ti esheet a d p og ess
report raises our concerns about the quality of their deliverables in the Mongolia
program, and so the HR function in GGGI is not operating efficiently and effectively.
64
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
V. GGGI’s Operations Management
3. Finance Management
Overview
The main objectives of evaluating the finance procedure is to assess the economy,
efficiency and effectiveness by reviewing the Design of Process and the quality of
deliverables in each step. The scope of finance process evaluation is limited to the
supporting processes related to the Mongolia and Rwanda country programs in 2013
and 2014.
To assess the finance procedure, interviews were conducted with the Head of Finance,
and the Head of Corporate, and documents were reviewed.
- The total number of Interview: 3 times with the Head of Finance and 2 times with
Head of Corporate
- The total interview time: 125 minutes
- Interview purpose: To gain a thorough understanding of the process
We performed sampling tests for the Mongolia and Rwanda programs to determine
whether GGGI is using the appropriate operating and procurement procedures, and to
ascertain whether documented procedures are operating effectively in practice.
The simplified process map of the finance function drafted after the interview
summary was confirmed and the relevant documents reviewed can be found in
Appendix 3. This simplified process map focuses mainly on the activity which produces
the output of each procedure. The findings are also listed with the process map.
Professional Standards such as COSO
an internal control framework - and Sarbanes
Oxley regulations were used as references to determine whether GGGI is following the
appropriate operating and procurement procedures.
History of
Budget/Travel
[Budget Management]
GGGI s udget p o ess ha ged f o
to
.I
, GGGI did ot ope ate a
systematic review process; the review process relied on division heads. From 2014,
various divisions joined for a challenging session and the necessity and validity of
budgets were reviewed. GGGI also shifted from one a year work and budget plan to a
multi-year plan in 2014.
Implementation of an accounting software called EMAX in 2014 has improved the
budget monitoring function and enabled the creation of a monthly budget variance
report. Furthermore, the currency used in the previous budget system was KRW, so
the currency had to be converted into USD which caused inefficiency. Finally, Actual
budget execution of each program can only be monitored via a Quarterly
Implementation Report (QIR
prepared on a quarterly basis) in 2013.
[Travel & Expense Management]
The ole of Co po ate Se i e U it s T a el Tea is to se e as the fo al poi t fo T a el
by GGGI staff. They provide advisory and guidance to GGGI staff in understanding the
travel policy and guidelines which became effective on January 1 of 2014, and ensure
that the travel policy and guidelines are up-to-date (by managing and communicating
the approved changes) and are readily accessible to all GGGI staffs.
65
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
V. GGGI’s Operations Management
The unique
featu e of GGGI s t a el e pe se a age e t s ste is that a issio
travel report, which allows the project team to monitor the project status, must be
submitted within seven days of journey completion in order for expenses incurred
during the mission trip to be reimbursed.
Follow up on
Danish appraisal
report
[Budget Management]
According to the Danish appraisal report, it is important that GGGI, as part of the
strategy process, develop the concept, size, and plan for the accumulation of a working
capital (reserve) to ensure that priority activities can always be undertaken when cash
flow is challenged. Finance regulations adopted in January of 2014 also requires that
GGGI maintain a working capital fund. However, GGGI was not able to set-aside the
working capital fund for 2014, because the budget process for 2014 had already
started in 2013. GGGI practiced prudent cash planning, and therefore no longer has
problems in cash deficiency. Therefore, GGGI is able to retain working capital fund of
USD 5 million for each of 2015 and 2016. We have noted that the amounts stated in
the work program have been submitted to and approved by the council.
1.1 Findings from Evaluating Budget Management
[Policies]
We did not find any deficiencies or flaws in budgeting policy.
[Procedures & Process]
The overall internal control of the budget process was well
designed with respect to Authorization, Review and Segregation of Duties as seen the
budgeting process map. However, we observed that exceptions to the process were
made by users in practice.
The Procurement report noted that the budget for the Procurement of the Country
Representative
Mongolia has been checked with the Senior Strategy & Planning
Specialist and Budget officer on May and October 2014.
Findings
66
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
V. GGGI’s Operations Management
However, we could not find any mention of the Procurement of the Country
Representative
Mongolia on other budget documents.
Compliance status of internal budgeting procedure by the Mongolia Program
Budget reallocation had not occurred for the unplanned procurements.
Procurement of Individual Consultants for the Green Development Roadmap Project
and the Green Indicators Development Project.
- One procurement contract (hiring the Mongolia Country Representative) was
created in the fourth quarter of 2014. However, the procurement process included
rules adapted from both the Procurement and Human Resources units. As a result,
the contract had impact on the Budget Management.
- We were unable to find documental evidence that showed the procurement
contract was either planned / budgeted or had reallocated budgets for 2014.
According to the detailed project proposal, procurement plan, and variance report of
2014, the initial budget for outsourcing in 2014 was USD 340,000; the budget was
solely for procurement of a consulting firm, and not for an individual consultant.
According to this data, the procurement contracts for the Individual Consultants were
neither planned nor budgeted during the planning and budgeting step.
67
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
V. GGGI’s Operations Management
Even if the budget had not been allocated in advance, a request for reallocation of
budget should have been made in order to execute the contract. However, evidence
that such a request was made could not be found on any of the related documents.
Jan
Outsourcing
(consulting)
Outsourcing
(Honorarium)
Outsourcing
(Consultant)
Outsourcing
(Others)
Budgeted
Actual
Budgeted
Actual
Budgeted
Actual
Budgeted
Actual
Jul
Outsourcing
(consulting)
Outsourcing
(Honorarium)
Outsourcing
(Consultant)
Outsourcing
(Others)
Budgeted
Actual
Budgeted
Actual
Budgeted
Actual
Budgeted
Actual
0
0
1,000
0
0
0
0
0
47,276
0
0
0
0
0
0
0
Aug
102,000
0
1,000
0
0
0
0
0
Feb
0
0
0
0
0
0
0
0
Sep
33,000
0
2,000
0
0
0
0
0
Mar
0
47,276
0
0
0
0
0
0
Oct
0
0
2,000
0
0
2,844
0
0
Apr
102,000
0
0
1,000
0
0
0
0
Nov
0
0
2,000
0
0
13,083
0
0
May
0
0
0
0
0
0
0
0
Dec
161,000
0
1,000
0
0
33,583
0
3,950
Jun
0
0
0
0
0
2,274
0
0
*figures
in Red:
Payments executed without budget
1.2 Findings from Evaluating Travel Expense Management
[Procedures & Process]
Mission request forms, a written approval received prior to
business trips, has changed from 2013 to 2014. Mission request forms in year 2013
was mixed with the disbursement request (and the invoice attached) incurred prior to
travel; therefore, the Delegation of Authority (DoA) was up to a financial level. In 2014,
the mission request form was separated from the disbursement request, and therefore
the DoA was changed from a
fi a ial le el to o l the e uesto s supe iso fo faste
internal approval.
Overall, the internal control process for the travel expense management procedure
was designed well with respect to Authorization, Review and Segregation of Duties as
seen the Travel expense process map. However, we found that exceptions to the
process were made by users in practice.
Compliance status of internal travel expense procedure by the Mongolian Program
3 out of 5 sample mission travel reports did not follow the proper document
procedures. Mission travel reports from the periods of March 11 2013~March
16 2013, March 04 2013~March 08 2013, and June 16 2013~June 25 2013
were not submitted within 7 days of journey completion.
Compliance status of internal travel expense procedure by the Rwanda Program
According to testing of the samples selected, internal procedures on travel
expense operated well during the Rwanda program of 2013~2014.
68
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
V. GGGI’s Operations Management
Per Person
Expenses of
Mongolia and
Rwanda Programs
1. The reason behind the
40% decrease in salary and
wages and the 60% increase
in outsourcing cost (amount
in 2014 compared to the
amount in 2013) is not due
to changes in the number of
personnel in the Mongolia
team, but due to hiring the
Country Representative as a
Consultant.
2. Payment disbursed under
the category of Allowance
decreased by 94%; welfare
payment started to be
distributed in 2014.
3. Travel Expense decreased
by 60% from 2013 to 2014,
because the number of
business trips decreased
from 10 times in 2013 to 8
times in 2014.
4. Payment disbursed under
the category of Conference
Expenses increased by 80%.
Mongolia Program Expense Report 2013-2014
100%
90%
80%
70%
60%
50%
40%
30%
20%
10%
0%
2013
Salary and Wages
Outsourcing cost
Travel expenses
Conference expenses
Others
Employee benefits
Welfares
Allowances
182,032.91
65,639.18
50,723.37
15,999.30
3,143.72
861.15
-
36,504.00
2014
109,126.74
104,009.92
20,402.43
28,768.37
2,710.52
401.54
23,731.27
2,365.49
69
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
V. GGGI’s Operations Management
1. Salary & Wages increased
by 30%.
2.
Outsourcing
cost
increased by 200% in 2014
compared to 2013 due to
the first payment of USD
160,000 on the contract with
a consulting firm created on
January 2014.
3. Payment disbursed under
the category of Allowance
decreased by 25%; welfare
payment started to be
distributed in 2014.
4. Travel Expense decreased
by 50% compared to 2013.
5. Conference Expenses
decreased by 96% in 2014,
because most of the
conference expenses spent
in 2013 were a one-time
expense incurred from
EEBCEA Workshop.
Rwanda Program Expense Report 2013-2014
100%
90%
80%
70%
60%
50%
40%
30%
20%
10%
0%
Salary and Wages
Travel expenses
Outsourcing cost
Others
Conference expenses
Employee benefits
Welfares
Allowances
2013
121,138.49
104,067.66
51,600.66
1,577.28
27,067.89
382.03
-
18,924.61
2014
157,769.58
51,088.37
164,560.00
1,189.53
1,142.69
192.11
29,420.14
14,470.84
70
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
V. GGGI’s Operations Management
Recommendation
[Recommendation 1]
The budget check function in budget management should be strengthened to ensure
that transactions are conducted only if sufficient documental evidence of prior budget
allocation is available. The budget check process should also be documented in detail
to ensure completeness and effectiveness of the check process and to prevent
miscommunication between departments.
In conclusion, GGGI put in effort to improve the efficiency and effectiveness to deliver
o the o ga izatio s o je ti e.
As for the budgeting process, consistency has been checked through challenge
sessions to improve the quality of work plan and budget from 2014. Furthermore, for
the 2015 budget, GGGI started to practice prudent cash planning based on anticipated
cash flow scenarios. The cash planning enabled GGGI to set aside a working capital
fund of USD 5 million in 2015 and 2016.
The details of the travel expense management policies were improved during 2014.
Testing the travel expenses selected as samples confirmed that the documented
procedures were operating effectively.
Conclusions
71
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
VI. Enterprise Resource Planning
VI.
Enterprise Resource Planning
1. ERP Development
2. IT General
72
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
VI. Enterprise Resource Planning
1. ERP
Overall
The main objective of evaluating the ERP development project and general IT is to
assess whether the project execution and IT management were executed according to
the Es e o o , effi ie ,
and effectiveness) by reviewing the development
progress, project management and general IT management in 2013 and 2014.
Professional Standards such as COSO
an internal control framework - and COBIT-5
an IT management framework - were used as references to determine whether GGGI
is following the appropriate operating and procurement procedures
Development
Objectives
Enterprise resource planning (ERP) is a business tool that integrates business
applications to enable organizations to collect, store, process, and extract
information that can be used as a reference in management's decision making
process. Generally, the business applications are used to aid processes such as
planning, manufacturing or service delivery management, sales and marketing,
inventory management, human resource management, procurement and such. The
key objective of ERP implementation is providing high-level and integrated point of
view on core business processes on a real time basis.
According to GGGI's ERP Status Report, the primary reason behind GGGI's ERP
development and implementation was the need for innovation in business
processes to meet organizational strategic objectives. These needs increased
expectations of the IT department, and expanded the responsibilities of GGGI's IT
department to include roles as business enabler and cost optimizer in addition to
technological aspects. Therefore, the ERP system currently being developed is to be
one of the critical solutions to realize and deliver GGGI's strategic objectives on time.
GGGI is currently using a system called 'IS', which consists of different independent
parts that do not operate cross functionally; therefore, the system lacks uniformity
in control over business process and integrated management of data. ERP is
expected to consolidate all core business processes into one database, thus
providing an improved business process management as well as enhanced data
integrity; both critical to achieving organizational efficiency and effectiveness.
73
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
VI. Enterprise Resource Planning
Alignment with
Organizational
Strategy
According to GGGI's Strategic Plan of 2015 - 2020, GGGI is expected to ensure
organizational efficiencies, cost effectiveness, strategic staffing, and robust
management which drives improvements in organizations by cross-cutting
operations, and ERP is to take a part in the process.
GGGI will maximize efficiencies in information usage and communications
technology solutions in order to enhance business analytics, increase productivity,
reduce transaction costs, and enhance program and project support. The ERP system
will automate business modules in Finance, budget, procurement, grants and
projects, human resources, asset management, travel, and expense claims.
A o di g to GGGI s St ategi Pla of
-2020, GGGI selected organizational
efficiencies and cost effectiveness, strategic staffing and robust management which
creates conditions to drive change as the major processes of change. Seven tasks
were identified to accomplish the above major processes of change, including:
managing for results, ensuring sustainability, driving the global agenda, investing in
HR, strengthening the funding model, communicating for change, and measuring
success. ERP development is
pa t of the esult ased a age e t u de
a agi g fo esults
.
74
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
VI. Enterprise Resource Planning
Strategic Level - Theory of Change
GGGI Member countries move towards a model of
green growth that achieves poverty reduction, social
inclusion, environmental sustainability, and economic
growth simultaneously.
Efficiencies in organization, cost effectiveness,
strategic staffing, and robust management which
drives improvements in organizations
Cross-cutting priorities
1. Movement towards Implementation
2. Delivering More for Less
Impact
Process of
Change
Outcomes
Outputs
Professionalism of the organization ensured
Maximizing Institutional Effectiveness
Results Based Management (RBM)
Ensuring Sustainability
Driving the Global Agenda
Investing in our Human Resources
Strengthening our Funding Model
Communicating for Change
Measuring our Success
ERP Goals
Provide
a competitive advantage
for GGGI
Enable
timely access
to quality information
Enable GGGI to operate as an
integrated
entity
Improve job satisfaction
levels among the GGGI staff
A cost effective solution
to support GGGI operations
<Alignment ERP within Strategic Objectives>
75
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
VI. Enterprise Resource Planning
Managing for
Results
GGGI s
efforts to improve institutional capacity in Results Based Management (RBM),
which provides a framework for strategic planning and management based on
learning and accountability, will continue. RBM will be applied across the
organization via articulation of SMART performance indicators, defined standards,
minimum quality criteria for projects, and strengthened quality management
processes at all stages of the project cycle. The M&E system will also be equipped to
collect and assess data and report on performance in achieving wanted results.
Fu the o e, GGGI s o ga izatio al goals ill e at hed ith
the goals of
individual staff as part of the corporate accountability framework, and risk
management practices will be institutionalized to recognize and address potential
obstacles in achieving corporate objectives. Lastly, methods to reduce the impact
and probability or to prevent the risks entirely will be established, along with a
contingency plan in case the risk should occur.
Implementation and rollout of the ERP system will maximize efficiency in the use of
information and communications technology, which will enhance business analytics,
productivity, transaction cost savings, and support in program and project. The ERP
system will also automate modules such as Finance, Budget, procurement, Grants
and Projects, Human Resources, Asset Management, Travel, and Expense Claims.
What is notable from the above figure is that GGGI has been introducing and
implementing a results-based management structure, and applying lessons learned
from achievements and challenges to date, as following the 2015-2020 strategic plan.
Furthermore, the learned-from-lesson principle will also be implemented into the
ERP system.
A o di g to GGGI s ERP status epo t, the ke data elationships
indicate that the
ERP system will function bi-directionally through all core steps, from donor profiling,
grants, and funds-in to decision making in top management level; refer the figures
below that illustrate the key data relationships and the implementation of learned-
from-lesson principle to ERP system.
According to COBIT-5 Process Assessment Model, an
o ga izatio s IT st ateg shall
satisfy the business requirement of sustaining or extending the business strategy
and governance requirements while being transparent about benefits, costs and
risks. To achieve this objective, certain practices such as the following are needed:
-
-
-
Link business goals to IT goals
Identify critical dependencies and current performance
Build an IT strategic plan and tactical plan
Practices
Link business goals to IT goals
Identify critical dependencies and
current performance
Build an IT strategic plan and tactical plan
GGGI’s
Status
Confirmed (link with 2015-20 strategy)
Confirmed (by work plan of 2015)
Confirmed (by work plan of 2015)
76
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
VI. Enterprise Resource Planning
Donor and Grant
Donor Management and
Funds-in agreement
Donor and fund data
Aggregate to
the Management
Corporate DG
Division
Drill
down
Dept./Region
Project
Unit/Country
Project-to-project vertical relationship
between GGP&I, KDM, PPC
All project related data
Partner and agreement data
Partner
Partner
Management
Agreement(MOU)
Non-funding & Funds-out
agreement
<ERP Key data relationship>
1. Top
Management
Planning
2. Operations
Management
Planning
Business and Operations Planning
Sufficient Resources?
Feedback
Master Schedule
Resource Planning
3. Operations
Management
Execution
Adequate Planning?
Feedback
Procurement, Staffing, Expense
Schedule Management (Project Mgt)
Performance and Budget Management
<Learned-from-lesson chain in ERP>
77
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
VI. Enterprise Resource Planning
Project
Management
1. Project Schedule
According to the Danish Appraisal Report released in April 2014, the ERP
development project was to be completed by the end of 2014. Therefore, the
original scope of Value for Money evaluation was to evaluate the completed and
operational ERP system.
However, although several parts of the HR module, Staff Record, Absence/Leaves,
Position Administration, Right to Work and Competency have been operational since
soft-launch in November 2014, other major modules of the ERP system are still to
be launched due to the revision of the work schedule.
Regarding the project schedule, GGGI confirmed that ERP Deployment Strategy is a
continuous roll-out approach of ERP modules. As shown in the schedule, the
majority of sub-modules are planned to be released in June, followed by a couple of
sub-modules in July and a couple of sub-modules in the future (to be planned out).
Continuous Process Improvement (introducing improvements to the ERP system) is
one of the key drivers to realize the ERP Goal of competitive advantage and cost
effective solutions to support GGGI operations.
<2015 ERP Development Schedule>
78
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
VI. Enterprise Resource Planning
Modules
(work-
streams)
Scope of Work and Update
•S heduled to elease e ai i g 8 pa ts;
Pay &
Reward/Compensation, Benefit Administration and
Performance Appraisal, Recruitment/Applicant Tracking,
New Starters, Probation, Leavers, Grievances,
Disciplinary and Training Administration
•8 pa ts o e ed at the e ui e e ts
gathering and
solution designs discussions; Fund Accounting, Journal
Posting Processes, Currency & Exchange Rates, Period
End Processes, Financial Reporting, Cashbook
Maintenance and Bank Reconciliation Process
• pa ts o e ed at the e ui e e ts gathe i g a d
solution designs discussions; Grant Budgets, Project
Budgets, Project Forecasts and Budget Reporting.
• pa ts o e ed at the e ui e e ts gathe i g a d
solution designs discussions; Maintain Suppliers,
Product Maintenance, Funds Checking and Commitment
Tracking, Requisition Processing, Purchase
Order/Contract Processing, Invoice Registration and
Payment Processing
•4
parts covered at the requirements gathering and
solution designs discussions; Maintain Partner and
Donors, Grant Maintenance, Project Maintenance,
Request for Funds and Donor Reporting.
•5
parts covered at the requirements gathering and
solution designs discussions; Fixed Asset Master File,
Acquisitions, Depreciation, Disposals/Adjustments,
Transfers and Re-classes and Warranty Expiration.
•3
parts covered at the requirements gathering and
solution designs discussions; Travel Request &
Advances, Making Expense Claims, Unused Travel
Advance Notifications and Travel Expense Reporting.
•Co ti uous oll out app oa h of
modules as per Project
Schedule.
•Fi a e Data –Opening
Balance of 2015, keeping
previous data in EMAX system
•Budget Data
-Approved Budget for 2015
•G a t/P oje t Data –Currently
open Grants and Projects
•Mig atio of
previous Data (2013-2014, Closed Projects,
etc.) will be revisited in Q1 2015.
•P oje t Cha ge Co t ol p o ess i pla ed to o e a
scope changes or additional services.
•T ai i g fo T ai e sessio s ill e o du ted.
Through
this training, the workstream Leads (Process Owners) will
have a better understanding on how the ERP system
works then Test Plan, Data Migration Plan and
Deployment Plan will be refined.
Status in
2014
HR
Partially
launched
Finance
Budget
Procurement
Not
launched
(To-Be
launched in
2015)
Grants &
Projects
Asset MGT
T&E Claims
ERP
Deployment
Strategy
Data
Migration
Strategy
On-going
On-going
Change
Control &
Training
On-going
<Scope of Work and Updates>
79
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
VI. Enterprise Resource Planning
Originally, the project was to be completed by the end of 2014; however, the
completion date was extended to June 2015. This is partly because the process of
developing the ERP followed a continuous roll-out approach, and during the process
the project faced resource constraints (especially manpower) before launching the
HR module in November 2014. Currently, GGGI is reviewing the work scope and
updates in the work scope have been reported through the ERP status report.
Regarding the resource constraints, GGGI confirmed that remaining resources focused
on the November 2014 launch and the rest of the modules were put on hold
temporarily. A re-planning of schedule and resources was conducted. In December, a
revised schedule was finalized and approved by the ERP Project Steering Committee.
It cannot be overlooked that even after the go-live of the newly developed ERP
system, there still exist plans to progressively implement other modules as a part of
the continuous roll-out approach and continuous process improvement. The
progress schedule is expected to allow the ERP system to maximize its utilization,
and therefore allow the ERP system to operate at maximum effectiveness and
efficiency.
According to COBIT-5, project management aims to satisfy the business requirement
of ensuring the delivery of project results within agreed-upon time frames, budget
and quality. Therefore, the required practices related to the project schedule are as
follows:
-
-
-
-
Establish and maintain an IT project monitoring, measurement and
management system
Build project charters, schedules, quality plans, budgets, and communication
and risk management plans
Assure the effective control of projects and project changes
Define and implement project assurance and review methods
Practices
Establish and maintain an IT project
monitoring, measurement and
management system
Build project charters, schedules, quality
plans, budgets, and communication and
risk management plans
Define and implement project assurance
and review methods
GGGI’s
Status
Confirmed (by project status report,
2014)
Confirmed (by project status report and
budget variance report, 2014)
Confirmed (by ERP Project Steering
Co
ittee s e ie
2. Project Manager
GGGI Management changed the ERP Project Manager in response to his resignation.
Changing the project manager during such a project is uncommon and could be risky,
and GGGI confirmed that the Management Team made this decision to change
project manager change with enough consideration and mitigation of potential risk.
80
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
VI. Enterprise Resource Planning
(Currency: USD)
Mar
219,764
12,806
0
0
12,806
Jun
223,921
27,601
57,075
-11,724
72,952
Sep
123,921
-14,299
0
-26,489
-40,787
Dec
21,803
38,877
40,425
-4,016
75,285
1Q 2014
Budget
Total Expenses
Capitalized expenditure
Depreciation/Amortization
Total Expenditure
2Q 2014
Budget
a. Total Expenses
b. Capitalized expenditure
c. Depreciation/Amortization
Expenditure (a+b+c)
3Q 2014
Budget
a. Total Expenses
b. Capitalized expenditure
c. Depreciation/Amortization
Expenditure (a+b+c)
4Q 2014
Budget
a. Total Expenses
b. Capitalized expenditure
c. Depreciation/Amortization
Expenditure (a+b+c)
Total Budget
Total Expenditure
Disbursement Rate
Jan
19,764
13,886
0
0
13,886
Apr
123,921
22,965
365,000
-10,139
377,826
Jul
123,921
531,814
490,590
-11,724
1,010,680
Oct
123,921
35,256
156,400
-30,833
160,823
Feb
219,764
10,472
0
0
10,472
May
123,921
23,149
0
-10,139
13,010
Aug
223,921
-418,748
47,443
-40,116
-411,421
Nov
21,803
34,644
68,112
-33,087
69,668
1,570,345
1,365,200
86.9%
<2014 ERP Budget Variance>
81
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
VI. Enterprise Resource Planning
Budget
Management
4.39%
1.37%
0.11%
0.60%
3.22%
0.02%
6.03%
7.03%
0.56%
89.73%
Salary and Wages
Welfares
Travel expenses
Depreciation
Other expense
Allowances
Outsourcing cost
Commissions
Amotz. of intangible assets
Capitalized Expenditure
<Percentage of Project Expenditures>
According to the ERP budget variance report 2014, GGGI originally estimated a
budget of USD 1,570,345 for the ERP development project. With the disbursement,
major expenditures of the ERP were capitalized according to IFS. In 2014, ERP
disbursement was USD 1,365.200.23 and the disbursement rate was 87%
accordingly. This has been separately monitored by the Finance Team and discussed
with the ERP Project Manager.
1. Amortization and Depreciation
The amortization and depreciation cost of purchased software and office-equipment
were capitalized first in accordance with IFRS requirements, and were
depreciated/amortized in compliance to the Financial Policy.
2. Salaries and Wages
Irregular patterns in salary expense - salary payment of USD 10,000 was being made
each month during the first half of 2014; however, the payment stopped in August.
GGGI Management decided to reallocate the salary in response to the evolving role
and responsibilities of the ERP Specialist to start covering the outgoing IT & Facilities
Manager.
3. Travel Expenses
Regarding travel expense, GGGI has spent USD 44,000 on travel expense for non-
GGGI staff members, contractors from a consulting firm that started work after
signing a contract, and field trips to HQ to conduct ERP Requirements Gathering &
Solution Design sessions. This was expensed in August, October and December,
however, invoices are for the period of 2014. The Project Manager took some time
to validate the invoices, and those invoices are accepted and posted after clearance.
82
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
VI. Enterprise Resource Planning
4. Equipment and Software Purchasing
According to the budget variance report, GGGI spent USD 727,937 on purchasing
software and USD 497,108 on purchasing office equipment, including a server
machine. It is noted that all purchased equipment and software are capitalized in
a o da e ith GGGI s fi a e poli .
(Currency: USD)
Asset
Software
Office equip.etc
Total
Amount
727,937.00
497,108.40
1,225,045.40
<Capitalized Amount of Purchased Assets>
According to COBIT-5, project management aims to satisfy the business requirement
of ensuring the delivery of project results within agreed-upon time frames, budget
and quality. IT investment management aims to satisfy the business requirement of
continuously and demonstrably improving cost-efficiency and its contribution to
business profitability with integrated and standardized services that satisfy end-user
expectations. The required practices related to project budget management and
investment management are as follows:
-
-
-
-
Establish and maintain an IT project monitoring, measurement and
management system
Build project charters, schedules, quality plans, budgets, and communication
and risk management plans
Identify, communicate IT investment, cost and value to the business
Monitor IT investment, cost and value to the business
Practices
Establish and maintain an IT project
monitoring, measurement and
management system
Build project charters, schedules, quality
plans, budgets, and communication and
risk management plans
Identify, communicate IT investment,
cost and value to the business
Monitor IT investment, cost and value to
the business
GGGI’s
Status
Confirmed (by project status report and
budget variance report, 2014)
Confirmed (by budget variance report,
2014)
Confirmed (by reporting to ERP Project
Steering Committee and participation of
super-users, 2014)
Confirmed (by strategic goals and key
performance indicators related to the
project, 2015)
83
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
VI. Enterprise Resource Planning
Findings
The fi di gs o GGGI s ERP p oje t a e as
following: first, the extension of the project
schedule was due to a continuous roll-out approach; second, the project budget
variance of a disbursement rate averaging 87% and approximately 90% of total
expenditure consists of capitalized assets in accordance with IFS; and third, the risk
associated with the change of project manager due to resignation was mitigated
through consideration by
GGGI s a age e t.
Regarding overall project management, continuous review of project (ex. project
leader, estimated budget and available resources - including HR and Equipment,
purchasing plans for required resources, and overall development schedule) needs
to be assured during the planning phase in order to prevent risks of damaging the
economy, efficiency, and effectiveness of overall project.
When a change is made on the project plan, immediate follow up measures based
on analysis of potential risk should be implemented to increase the effectiveness.
Continuous assure that resources invested in the project are being managed in an
organized way. Resource management should include both HR management (such
as changing the project manager or team member) and asset management
(capitalization), and by doing so resource management will increase the overall
efficiency of the project.
Conclusion
According to the analysis of documents, interviews and evaluation based on the
international standard, COBIT-
, GGGI s ERP de elop e t p oje t has ee
meeting
the 3Es even if there has been minor issues such as a change to the roll-out approach
and project manager.
Specifically, GGGI has conducted a validation of system development and
outsourcing for economy, performed progress reporting and resource management,
include budget monitoring for efficiency, and conducted tests (user acceptance test,
cross-module test) and end-user training for effectiveness.
Regarding efficiency, although there has been issues such as project manager
change and system roll-out approach change, proper measures for managing
efficiency issues have been conducted. Therefore we conclude that overall efficiency
of ERP development has been improved.
As the system will go live in June 2015, it is expected that the ERP will contribute to
enhance the
Es of GGGI s ope atio s.
First, the system will provide a single source
for information and integrated information management in real time which will
e ha e effi ie
i GGGI s de isio
aki g. Se o d, the s ste is goi g to e
working as an integrated monitoring and reporting platform, thus enhancing the
management efficiency of each country program. Third, project achievements and
outputs will be updated in the ERP and the management can review and ensure the
effectiveness of project achievements and outputs in a more efficient way.
Recommendation
84
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
VI. Enterprise Resource Planning
2. IT General
IT General
1. IT Governance
GGGI s IT is u de the a age e t of
the Corporate Services Unit. The Corporate
Services Unit manages not only IT, but also other corporate affairs such as
organizational events and travels.
Director General
Management & Administration
DDG M&A
Corporate Services
Head of Corporate Services
ICT
Infra Management
Data Management
Incident Management
Change Management
Service Request Mgt.
<GGGI IT Governance>
The ERP project team is in charge of the development process, and the ERP Project
Steering Committee oversees and makes decisions based on issues that arise. On
ERP implementation, ERP Project Team and the Business Process Group (BPG: in
charge of defining
a d efi i g GGGI s usi ess p o esses ha e so e
interconnected activities. Due to this connection, GGGI is expected to operate by
standardized processes defined by BPG; all data generated from activities going
through processes will be handled by and stored by ERP. In other words, improved
standardized processing and centralized management are expected to enhance
organizational efficiency and effectiveness simultaneously.
The General IT Policy is currently being revised, and it is expected that the finalized
version of the
Ge e al IT Poli is goi g to defi e all GGGI s IT affai s a d p o esses
in an integrated way.
85
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
VI. Enterprise Resource Planning
Business Process Group
ERP Project Team
ERP Project Steering Committee
1. Manage the implementation of an
Enterprise Resource Planning (ERP) tool in
GGGI
2. Act as a Single Point of Contact for ERP
Vendor on GGGI Business Processes and
Requirements
3. Manage and track approved Changes
4. Coordinate End User Acceptance Testing and
Deployment
5. Coordinate Business Process & End User
Trainings
1. Defined or
refined
business
processes
2. Signed off
business
requirements
<Relationship between BPG and ERP Project Team>
2. Overall IT Management
GGGI's IT team is managed by a centralized and structured plan called the CSU Work
Plan 2015. The work plan covers areas from strategic goals and key performance
indicators to weekly objectives of staff and responsibility assignment matrix. The
Head of Corporate Services has been able to manage all of GGGI's IT related activities
and inputs / outputs in a centralized way by managing the work plan. The strategic
goals and key performance indicators allow the head of corporate services to
monitor and set up directions towards achieving the goals. The responsibility
assignment matrix allows for efficient allocation of IT tasks and prevents
duplications in task execution. Staff schedule management enables monitoring of all
planned tasks, and therefore management can see in advance whether all planned
tasks will be completed in a timely manner, or inquire about the reasons if not.
3. Infra Management
ICT does not directly manage GGGI's IT infrastructure as it is outsourced. Rather,
ICT's primary role is to ensure the efficiency and effectiveness of IT infrastructure by
monitoring the performance of outsourcing contractors.
4. Outsourcing Management
GGGI has implemented multiple monitoring measures to ensure efficiency and
effectiveness in outsourcing. First, a monthly inspection report that reviews the
infrastructure management conducted by contractors is issued. Second, a weekly
helpdesk report and dashboard report that demonstrates how many service
requests are made and processed is issued.
5. Cyber Security
GGGI has implemented a proper level of IT security measures. For instance, it is
mandatory of
e e staff s pass o ds
to be changed
egula l , a d GGGI s et o k
infrastructure has implemented multi-level firewalls in order to block external
atta ks. Fi all , all e e ts that a ise i GGGI s s ste a d et o k a e e o ded a d
reviewed periodically.
86
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
VI. Enterprise Resource Planning
According to COBIT-5, project management aims to satisfy the business requirement
of ensuring the delivery of project results within agreed-upon time frames, budget
and quality. IT investment management aims to satisfy the business requirement of
continuously and demonstrably improving cost-efficiency and its contribution to
business profitability with integrated and standardized services that satisfy end-user
expectations. The required practices related to project budget management and
investment management are as follows:,
-
-
-
-
-
-
-
-
-
-
Establish and implement IT roles and responsibilities, including supervision and
segregation of duties
Establish IT organizational structure, including committees
Design an IT process framework
Identify system and data owners
Establish and maintain an IT control environment and framework
Develop and maintain IT policies
Build and manage the quality plan for continuous improvement
Ensure system security
Maintain service desk for incident management
Acquire and maintain technology infrastructure
Practices
Establish and implement IT roles and
responsibilities, including supervision and
segregation of duties
Establish IT organizational structure,
including committees
Design an IT process framework
Identify system and data owners
Develop and maintain IT policies
Build and manage the quality plan for
continuous improvement
Ensure system security
Maintain service desk for incident
management
Acquire and maintain technology
infrastructure
GGGI’s
Status
Confirmed (by responsibility allocation
matrix)
Confirmed (No specific committee for
general IT affairs, but for ERP project and
Business Process Management)
Confirmed (By process management)
Confirmed (By defining owners of each
modules in the ERP system)
Confirmed (currently drafting the general
IT policies)
Confirmed (continuous roll-out approach
for ERP project and continuous process
improvement)
Confirmed (general IT policies and
internal procedures cover security
figures)
Confirmed (service desk and incident
management operational)
Confirmed (infrastructure outsourced)
87
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
VI. Enterprise Resource Planning
Findings
GGGI s ge e al IT a age e t is u e tl ei g e ha ed. GGGI s E aspe ts of IT
processes (composed of IT performance rate measurement, responsibility allocation
of IT manpower, monitoring expenditures on IT management, etc.) are reviewed by
the Head of Corporate services according to the COBIT-5 Process Assessment Model,
an international standard established for IT process assessment. The IT processes,
policies, procedures, and manuals are currently in a first draft phase of development;
an integrated IT package which includes all IT processes, policies, procedures, and
manuals will be provided through completion of the BPM project.
Regarding IT governance and overall IT management, currently drafting general IT
policy should cover all of GGGI
s IT p o esses a d a ti ities, a d the
Integrity of data
and efficiency of the ERP system should be ensured by integrated IT governance
framework and management. As new systems and modules are implemented, all
end users should be provided enough training in order to enhance overall IT
effectiveness.
As GGGI
s IT infrastructure is managed by contractors, GGGI needs to assure that
contractors are consistently performing as expected.
As the importance of cyber security continues to grow, GGGI should continuously
prepare and apply appropriate measures for cyber security.
Conclusion
According to the analysis and interviews, although it is still progressing, it is noted that
there have been attempts to enhance the
Es of GGGI s ge e
al IT management and
process. Specifically, GGGI has implemented and been operating necessity and cost
validation for infrastructure and outsourcing for economy, established work plan,
outsourcing management and automated controls through system for efficiency, and
monitoring performance indicators and setting up IT strategic goals for effectiveness.
Although some required processes such as a Business Continuity Plan and backup
policies have yet to be
i ple e ted, GGGI s
IT management and process match with
the required practices defined by the international standard, COBIT-5. In regard to the
atu it of IT p o ess, it is oted that GGGI s ge e al IT a age e t is u e tl at
the established level due to the fact that GGGI is a young organization; improvement
is still on-going. As the ERP and BPM are fully implemented, the maturity and capability
will be enhanced to a predictable and optimal level; in other words, the efficiency and
effectiveness of general IT management is going to be enhanced.
Recommendation
88
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
VI. Enterprise Resource Planning
Level
0
1
2
Maturity/
Capability
Incomplete
Performed
Managed
Description
Not implemented or little/no evidence of any systematic
achievement of the process purpose
Achieves its process purpose
Implemented in a managed fashion (planned, monitored
and adjusted) with appropriately established, controlled
and maintained work products
Implemented using a defined process that is capable of
achieving its process outcomes
Operates within defined limits to achieve its process
outcomes
Continuously improved to meet relevant current and
projected enterprise goals
GGGI’s
Status
Achieved
3
4
5
Established
Predictable
Optimizing
Expected to
achieve
(by ERP and
BPM)
<GGGI
s Ge e al IT Ma age e t Capa ilit Le el>
89
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
VII. Conclusion
VII.
Conclusion
90
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
VII. Conclusion
GGGI is a relatively new international organization, gaining its status as an international organization only in
October 2012. Therefore, it is natural that GGGI has room for improvements and that deficiencies may be
interpreted as risk. However, from a different perspective it is also an opportunity to build a strong and sound
organization and promote a sustainable green growth development model.
The overall evaluation result of the Value for Money in GGGI for the period of 2013 and 2014 is partially
satisfactory.
Although the internal management, institutional systems, policies, and procedures are well designed to
a hie e the o ga izatio s o je ti e, the s ste s a d sta da ds a e ot full i ple e ted i p a ti e. Fo
example, monitoring for program/project management and cross checking between processes need to be
strengthened to increase efficiency and effectiveness and enhance transparency of Business Management.
However, we also observed process owners contributing considerable effort to introduce and enhance the
appropriate business practice to GGGI by providing guidance and training to end users. Therefore, although it
is too early to conclude that the practice is fully implemented, it is possible that the Operations Management
will be operating efficiently and effectively in the near future.
In each chapter, we noted findings, exceptions, and recommendations for the exceptions. However, some of
the recommendations are already in the process of being implemented. This is because previously issued GGGI
appraisals and evaluation reports mention that GGGI lacks internal control structures such as relevant policies
and procedures. GGGI has implemented necessary revisions to follow up on the comments made in the past.
Our project evaluation scope covered the period from year 2013 to 2014; therefore, the improvements
currently being implemented or the improvements implemented by GGGI that became effective since 2015
are not well reflected in this report. However, we have observed the improvements and efforts made by GGGI.
GGGI is an evolving organization, learning from its past errors and actively developing its operations. GGGI has
e ol ed da
da to a hie e its isio of A esilie t o ld of st o g, i lusi e, a d sustai a le g o th .
91
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Appendix 1. List of Document Requested
Appendix
1. List of Document Requested
1. Entity level
Category
Task in
ToR
Document
Policy documents in the public domain
Approved Delegation of Authority (updated version)
(Final Report) Appraisal
2014 Danish Appraisal of GGGI (Mongolia
and Rwanda)
Entity level
A~I
GGGI appraisal master with GGGI Comments 23042014
Travel and Travel Expenses Policy
Risk & Mitigation Matrix in QIR
GGGI Business Process Management Update 20150213.pdf
Access to Process-Asset Library*
2. Strategic&Planning
Category
Task in
ToR
Document
Mongolia & Rwanda
1.
2.
3.
4.
1.
1.
Strategies
Planning
&
C, D, E, G,
I
8.a. MPSC.1.7.Annex1. Country planning framework
Annex 1_Planning Directions and Budgeting Framework 2015-2016
Annex 3-Work Program and Budget Forms
GGGI strategic plan 2015_final_web1
Document(s) that was used for council approval for the year 2013-2014
Budget re-evaluation document for the year 2013-2014
Mongolia
1.
Outcome of the project (if any) for the year 2013-2014
Rwanda
1.
2.
GGGI strategic plan for FY' 2013 - 2014
Final Draft PP1-B-F2 - Detailed project proposal_Rwanda_May
16_UPDATED VERSION
3. Outcome of the project (if any) for the year 2013-2014
Component 1 Report and Appendix
Component 2 Report and Appendix
92
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Appendix 1. List of Document Requested
3. Project
Category
Task in
ToR
Document
Mongolia & Rwanda
1.
2.
QPRs 2013-14
Internal evaluation performance sheet 30092014
Mongolia
1.
2.
3.
1.
2.
3.
4.
C, E, G, I
Rwanda
1.
2.
3.
1.
1.
1.
2.
3.
4.
5.
Rwanda 2015-16 Logframe
Rwanda QIRs 2013-14
MOU (Rwanda)- Hard copy
Documents that show all the projects that are conducted in Rwanda
Logical framework related to the year 2013-2014
Energy Status of Rwanda & Strategy for Green Growth
National Territorial Vision & Strategy for Green Growth in Rwanda
Resource Efficient Housing-Rwnda-RHA
Rwanda_Housing_Final-Construction Material
Rwanda_PPR_Aug_Master Document_final
Mongolia 2015-16 Logframe
Mongolia QIRs 2013-14
MOU (Mongolia) - Hard copy
Detailed project proposal_Mongolia 2014
Procurement plan_Mongolia 2014
GGGI MONGOLIA PORTFOLIO (updated Aug 2013)
COUNTRY STRATEGY 2014-2016 (Mongolia)
Project
Mgmt
93
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Appendix 1. List of Document Requested
4. Finance
Category
Task in ToR
Document
General ledger only related to Mongo & Rwanda Project code in the
period for 2013 and 2014
Monthly budget variance report for Mongolia project & Rwanda
project & IT(ERP related) for
2014
Travel reports 2013,2014(Mongolia, Rwanda)
Written approval(Official travel request) of travels in the attached file
Relevant supporting document for travel expenses(Receipt/Invoice)
Finance
Mgmt
A ~ E, G, H
5. Procurement
Category
Task in ToR
Document
Procurement list for 2013~14(Mongolia, Rwanda)
Annual procurement plans for 2013~14(HQ, Rwanda)
PAI-2014-358 / Country Representative
Mongolia
PO-2014-103 / Interpretation and facilitation services for workshop
Mongolia
A ~ E, G, H
DP-2014-557 / GDRP Mongolia
PH-2014-010 / Developing Rwandan Secondary Cities as Model Green
Growth Cities with Green Economic Opportunities
LE-2013-045 / EAC scoping project consultant
Rwanda
DP-2013-046 / Rwanda Program Consultant
Procurement
Mgmt
94
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Appendix 1. List of Document Requested
6. Human Resource
Category
Task in ToR
Document
Divisions/departments headcounts
Job Descriptions Template Performance Rating
Specific definitions of tasks and activities in GGGI's Job Profile or Job
Descriptions
Standardized time per each task and activity
Workforce demand driver per each department and function
Timesheets and analysis data of human resource and time Input for
output of each function
Human resource productivity index of each department
Panel Recommendation
Procedures and guidelines established by Director General for staff
performance evaluation
Plans for training sessions_2013, 2014
Documented Segregation of Duties_2013, 2014
Payroll Diagram(to be requested by Gazal)
HR Mgmt
D,E,F,G, H
7. IT
Category
Task in ToR
Document
Components of IT System & Architecture
General IT Policy Draft 20130915
ERP Status reporting
IT system(include both IS and ERP) performance indicators and
performance reports for 2013~14
Evaluation criteria for system performance or list of Key Performance
Indicators
IT Mgmt
A, C ~ E, G, H
Control checklist(user checklists)
IT Strategy map for 2013~14
IS and ERP system structure chart
ERP system education materials for Champions
Rules/procedures for managing outsourcing service provider(for internal
control purposes)
System module guidelines(procurement, finance, HR etc.)
CSU Work Plan 2015
95
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Appendix 2. Interviews
2. Interviews
96
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Appendix 3. Simplified Process Maps
3. Simplified Process Maps
Definitions
Symbol
Name
Terminator
Description
Indicates the beginning or end of a
process flow
Process
Indicates any processing function
Decision
Indicates a decision point between
two or more paths in a flowchart
Can represent any type of data in a
flowchart
Indicates data that can be read by
people, such as printed output
Data
Document
Connector
Indicates an inspection point
Indicates a list of information with a
standard structure that allows for
searching and sorting
Database
97
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Appendix 3. Simplified Process Maps
98
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Appendix 3. Simplified Process Maps
99
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Appendix 3. Simplified Process Maps
100
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Appendix 3. Simplified Process Maps
101
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Appendix 3. Simplified Process Maps
102
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Appendix 3. Simplified Process Maps
103
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Appendix 3. Simplified Process Maps
104
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Appendix 3. Simplified Process Maps
105
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Appendix 3. Simplified Process Maps
106
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Appendix 3. Simplified Process Maps
107
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Appendix 3. Simplified Process Maps
108
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Appendix 3. Simplified Process Maps
109
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Appendix 3. Simplified Process Maps
110
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
URU, Alm.del - 2014-15 (2. samling) - Bilag 5: Value-for-Money studie om Global Green Growth Institute (GGGI), fra udenrigsministeren
Appendix 3. Simplified Process Maps
Kim, You Kyoung(Kate), Partner, KPMG Risk Consulting Service
Tel 02-2112-0639
Mobile 010-9081-1079
111
© 2015 KPMG Samjong Accounting Corp., the Korea member firm of KPMG International Cooperative,
a Swiss cooperative. All rights reserved. Printed in Korea
