Transportudvalget 2014-15 (1. samling)
TRU Alm.del
Offentligt
Client
Femern A/S
Document type
Rambøll-Arup-TEC Report
Date
September 2014
CONCEPTUAL DESIGN
OPERATIONAL RISK ANALYSES 2014
REVISION 6C
Checked by
Approved by
Description
The operational risk analysis presents the risk level
for the Fehmarn Belt Tunnel in the years 2018 and
2038
Ref
RAT 64233-002
ATR 072-01-20
Disclaimer
The text and drawings presented in this report are developed in the course of
the planning process and should be considered as work in progress and not
representing a final position or determination unless otherwise explicitly
stated.
Work in Progress
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
CONCEPTUAL DESIGN
REVISION 6C
Revision
Date
Made by
Checked by
Approved by
Description
6C
2014/09/01
Kristina Hoffmann Larsen/Jesper Pedersen/Frederik
Sørensen
Jesper Pedersen/Kristina Hoffmann Larsen/Frederik
Sørensen
Dick Kevelam
Operational Risk Analysis
Ref
RAT 64233-002
ATR RAT73-JRS-141
Disclaimer
The text and drawings presented in this report are developed in the course of
the planning process and should be considered as work in progress and not
representing a final position or determination unless otherwise explicitly
stated.
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
TABLE OF CONTENT
1.
1.1
1.2
1.3
2.
2.1
2.2
2.3
2.4
2.5
2.6
2.7
2.8
3.
3.1
3.2
3.3
4.
4.1
4.2
4.3
4.4
4.5
4.6
5.
5.1
5.2
5.3
5.4
5.5
5.6
5.7
5.8
6.
6.1
6.2
6.3
6.4
6.5
6.6
7.
7.1
7.2
7.3
7.4
7.5
7.6
8.
9.
9.1
9.2
10.
11.
Introduction and procedure
Introduction
Procedure
Event overview and affected safety targets
Summary
Individual risk
Third party risk
Societal risk (section to be updated autumn 2014)
Risk of disruption
Environmental risk
Maintenance risk
Unauthorized persons on railway premises
“Others”
Safety Targets and risk acceptance criteria
FAT to FWSI conversion factors
Quantified acceptance criteria
Cost of safety targets
Consequence modelling
Population distributions
Fatalities on road and rail
Road
Rail
External events
Multiple simultaneous events
Risk
Ordinary road
Road accidents involving dangerous goods
All road accidents
Fire (road)
Results
landsides and enclosed tunnel
Ordinary rail
Fire (rail)
External events
Results
Acceptance criteria
Individual risk
Societal risk
Disruption risk
Total risk cost
Impact of the dangerous goods restrictions on railway
Revisions
Revision 6
Revision 5
Revision 4
Revision 3
Revision 2
Revision 1
Future work
Appendix A
Release of dangerous goods
general
assumptions
Assumptions
Assessment of impact from explosions
Appendix B
Train distribution in tunnel from time
schedule
Appendix C
Distributions of train capacity
Work in Progress
1
1
1
1
3
3
3
4
4
4
4
5
5
7
7
8
8
11
11
14
15
21
30
33
34
34
34
34
35
35
36
37
38
40
40
40
42
42
44
45
47
47
49
51
52
54
55
59
60
60
67
69
70
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
12.
12.1
12.2
12.3
12.4
12.5
12.6
12.7
12.8
12.9
12.10
12.11
12.12
13.
Appendix D
Consequence tables
Road accidents resulting in no fire
Road accident involving dangerous goods vehicle carrying
ammonia
Road accidents involving dangerous good vehicle carrying
chlorine
Road accidents involving dangerous good vehicle carrying lpg
Road accidents involving dangerous goods vehicle carrying
flammable liquids
Road accidents involving vehicles carrying explosives
Road accidents involving vehicles carrying acids and bases
Fire Road
Train Collision
Train collision involving dangerous goods
Train derailment
Fire rail
References
73
73
75
77
79
84
88
89
91
93
112
158
174
177
LIST OF FIGURES
Figure 4-1 Traffic distribution over a day based on Scandlines data
12

Figure 6-1 FN-curve for the disruption of the road part (one tube only) (2025)
42
Figure 6-2: FN-curve for the disruption of the rail part (only one rail tube)
43
Figure 6-3: FN-curve for the simultaneous disruption of road and rail
44
Figure 6-4 Total risk cost distribution
45
Figure 9-1: Location of jet fans used in the CFD-modelling of releases in road
part
60
Figure 9-2: Location of the source to the release of dangerous goods
61

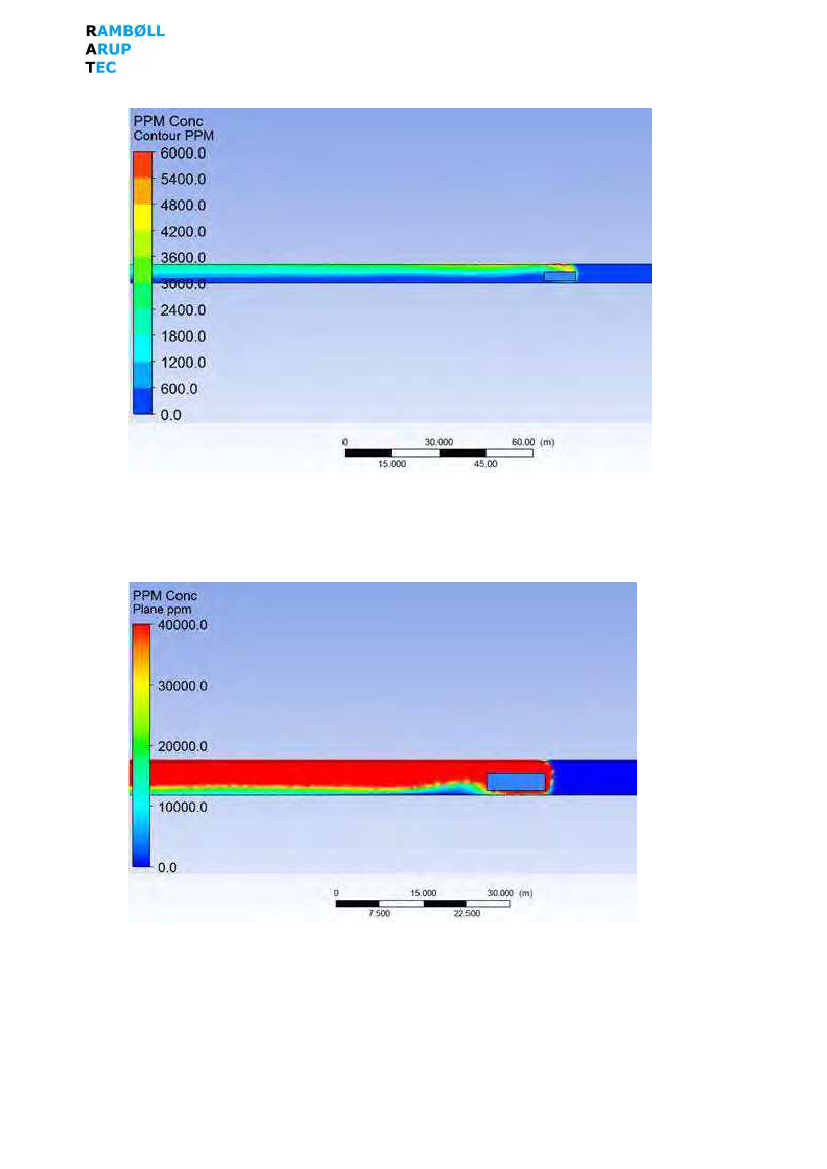

Figure 9-3 Result from CFD calculations for small release of ammonia
64
Figure 9-4 Result from CFD calculations for medium release of ammonia
64
Figure 11-1 Distribution of train capacities
70
Figure 11-2 Actual distribution of passengers
71
Figure 11-3 Assumed distribution
71
LIST OF TABLES
Table 1-1 Events distributed on safety targets with references to relevant
sections. *Disruption and repair costs are assessed under fire and
toxic release respectively.
2
Table 2-1 Individual risk (the number of fatalities and FWSI per billion person
passages) and acceptable risk on road and rail in 2025 and 2045 3
Table 2-2 Societal risk and acceptable risk in 2025 and 2045
4
Table 2-3 Tunnel disruption in days per year (* does not include simultaneous
disruption)
4
Table 3-1 Safety targets
7
Table 3-2 FAT to FWSI conversion factors for rail, ref. [29]
8
Table 3-3 FAT to FWSI conversion factors for road
8
Table 3-4 Overview of the risk acceptance criteria
8
Table 3-5 Cost of fatalities in million Euros in 2025 prices
8
Table 3-6 Initial cost of an event causing disruption of part of or the entire link
in million Euros in 2025 prices
9
Table 3-7 Societal cost of disruption of part of or the entire link in million Euros
in 2025 prices
9
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Table 3-8 Owner loss due to disruption of part of or the entire link in million
Euros in 2025 prices
9
Table 3-9 Environmental damage in Euros in 2025 prices
10
Table 4-1 Road tunnel traffic forecast and population
11
Table 4-2 Traffic distribution on road
12
Table 4-3 Average number of vehicles and occupants in a queue in 2 tubes in
case of an accident
13
Table 4-4 Rail tunnel forecast and number of passengers per train
13
Table 4-5 Fraction of time with different train scenarios
14
Table 4-6 Distribution of 95% of the expected number of passengers on
railway in both railway tubes
14
Table 4-7 Distribution of 95% of the expected number of employees on railway
in both railway tubes
14
Table 4-8 Example scale used for assessing number of fatalities and the
distribution
15
Table 4-9 Example scale used for assessing the distribution of disruption time
15
Table 4-10 Example scale used for assessing the repair cost distribution
15
Table 4-11 Distribution of fatalities in ordinary road accidents on Fehmarnbelt
Fixed Link Tunnel
16
Table 4-12 Average disruption time for a traffic accident
16
Table 4-13 Average fatalities as a consequence of dangerous goods accident
resulting in release of ammonia in road tunnel
18
Table 4-14 Average fatalities as a consequence of dangerous goods accident
resulting in release of chlorine in the road tunnel
18
Table 4-15 The nine fire scenarios in the road part leading to fatalities
20
Table 4-16 Assessed repair cost and disruption length for a range of fire sizes
in enclosed tunnel
21
Table 4-17 Assessed repair cost and disruption length for a range of fire sizes
on the land sides
21
Table 4-18 Fatality percentages for train accidents with fatalities.
22
Table 4-19 Accident scenarios for rail accidents and corresponding estimated
average number of FWSI for passengers and employees
23
Table 4-20 Road disruption consequences caused by ordinary rail accidents 24
Table 4-21 Consequences of repair costs for ordinary road and rail
24
Table 4-22 Estimated FWSI as a consequence of a freight train accident
resulting in release of ammonia in the railway tunnel
26
Table 4-23 Estimated FWSI as a consequence of a freight train accident
resulting in release of chlorine in the railway tunnel
27
Table 4-24 Assessed repair cost and disruption length for a range of fire sizes
in enclosed tunnel
29
Table 4-25 Assessed repair cost and disruption length for a range of fire sizes
on the land sides
30
Table 4-26 Scaled yearly fire frequency
33
Table 4-27 Vehicle length
33
Table 5-1 Risk of ordinary road accidents in terms of fatalities, FWSI,
disruption and repair costs
34
Table 5-2 Risk from accidents involving dangerous goods on road in terms of
fatalities, FWSI, disruption and repair costs
34
Table 5-3 Risk from all road accidents in terms of fatalities, FWSI, disruption
and repair costs
34
Table 5-4 Risk of fires in the enclosed tunnel road part in terms of fatalities,
FWSI, disruption and repair costs
35
Table 5-5 Risk of fires in the road part of the land sides in terms of fatalities,
FWSI, disruption and repair costs
35
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Table 5-6 Risk of fire in the road part of the total scope (landsides and
enclosed tunnel) in terms of fatalities, FWSI, disruption and repair
costs
35
Table 5-7 Risk of derailments in terms of fatalities, FWSI, disruption and repair
costs
36
Table 5-8 Risk of collisions between trains in terms of fatalities, FWSI,
disruption and repair costs
36
Table 5-9 Risk of train-object collisions in terms of fatalities, FWSI, disruption
and repair costs
36
Table 5-10 Risk from collisions and derailments involving dangerous goods on
rail in terms of fatalities, FWSI, disruption and repair costs
37
Table 5-11 Risk of fires in the enclosed tunnel rail part in terms of fatalities,
FWSI, disruption and repair costs
37
Table 5-12 Risk of fires in the landsides rail part in terms of fatalities, FWSI,
disruption and repair costs
37
Table 5-13 Risk of fire in the road part of the total scope (landsides and
enclosed tunnel) in terms of fatalities, FWSI, disruption and repair
costs
38
Table 5-14 Risk of flooding in terms of yearly average fatalities, FWSI,
disruption and repair costs
38
Table 5-15 Risk of sunken ship on tunnel in terms of yearly average fatalities,
FWSI, disruption and repair costs
38
Table 5-16 Yearly average risk due to dropped and dragged anchor in terms of
fatalities, FWSI, disruption and repair costs
38
Table 5-17 Risk due to ship groundings on tunnel roof in terms of fatalities,
FWSI, disruption and repair costs
39
Table 5-18 Risk of fire in transformer room in terms of fatalities, FWSI,
disruption and repair costs
39
Table 5-19 Risk of two fires in terms of fatalities, FWSI, disruption and repair
costs
39
Table 6-1 Risk acceptance criteria
40
Table 6-2 Individual risk
40
Table 6-3 Calculated risk in percentages of the acceptance criteria
40
Table 6-4
Calculated risk for “others” (fatalities per year) and percentages of
the acceptance criteria
40
Table 6-5 Contributors to fatalities per year on road in 2025
41
Table 6-6 Contributors to passenger fatalities per year on rail in 2025
41
Table 6-7 Contributors to employee fatalities per year on rail in 2025
41
Table 6-8 Contributors to fatalities per year on rail in 2025 for ordinary rail
accidents
41
Table 6-9 Total number of disruption days for road and the contributing factors
(2025)
42
Table 6-10 Total number of disruption days for the rail and the contributing
factors (2025)
43
Table 6-11 Simultaneous disruption times
44
Table 6-12 Total risk cost in million Euros
45
Table 6-13 Total costs in million Euros
45
Table 6-14 Impact of dangerous goods restriction on road users, rail
passengers and employees
46
Table 7-1 Individual risk in revision 6.
47
Table 7-2 Risk to individual life safety revision 5
48
Table 7-3 Comparison of total costs in million Euros for revision 6 and 5
48
Table 7-4 Comparison of the disruption risk measured in days for revision 6
and 5
48
Table 7-5 Traffic data for ORA revision 5 and revision 4
49
Table 7-6 Comparison of risk to individual life safety between results in
revision 5 and 4
50
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Table 7-7 Comparison of total costs in million Euros for revision 5 and 4
50
Table 7-8 Comparison of the disruption risk measured in days for revision 5
and 4
50
Table 7-9 Comparison of risk to individual life safety between results in
revision 4 and 3
51
Table 7-10 Comparison of total costs in million Euros for revision 4 and 3
52
Table 7-11 Comparison of the disruption risk measured in days for revision 4
and 3
52
Table 7-12 Comparison of risk to individual life safety between results in
revision 3 and 2
53
Table 7-13 Comparison of total costs in million Euros for Revision 3 and 2
53
Table 7-14 Comparison of the disruption risk measured in days for Revision 3
and 2
53
Table 7-15 Comparison of risk to individual life safety between results in
revision 2 and 1
54
Table 7-16 Comparison of total costs in million Euros between results in
Revision 2 and 1
54
Table 7-17 Comparison of disruption risk between results in Revision 1 and 255
Table 7-18 Comparison of risk to individual life safety between results in
Revision 1 and 0
55
Table 7-19 Comparison of total costs in million Euros between results in
Revision 1 and 0
56
Table 7-20 Comparison of disruption risk between results in Revision 1 and 056
Table 7-21 Accident frequency per year for ORA revision 1 and 0 for the
Fehmarnbelt Fixed link
57
Table 7-22 Fatalities per accident in revision 1 and 0
57
Table 7-23 Fire frequency per year and vehicle km for ORA revision 1 and 0 for
the Fehmarnbelt Fixed link
57
Table 7-24 Traffic data for ORA revision 0 and revision 1
58
Table 9-1 Representative release sizes of ammonia and chlorine and calculated
mass flow rates
61
Table 9-2 Representative release sizes of LPG and calculated mass flow rates61
Table 9-3 Mass flow rates of ammonia, chlorine and LPG used in the CFD-
modelling
61
Table 9-4 LC50 for ammonia - Lethal concentration as a function of probability
of fatality at different exposure times
65
Table 9-5 LC50 for chlorine - Lethal concentration as a function of probability
of fatality at different exposure times
66
Table 10-1: Expected number of trains per day used in scheduling for the year
2025
69
Table 10-2: Fraction of different train scenarios
69
Table 11-1 Persons on passenger trains
72
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
1.
1.1
INTRODUCTION AND PROCEDURE
Introduction
This report presents the operational risk analysis (ORA) for the Fehmarnbelt Fixed Link Tunnel.
The ORA combines the frequency estimation (ref. [1]) with the consequence estimation (this
report) to calculate the risk and then compares the risk with the acceptance criteria from ref.
[28].
1.2
Procedure
The operational risk analysis procedure is described in details in the ORA Accident Frequencies
Report ref. [1].
1.3
Event overview and affected safety targets
All background information needed in order to setup risk modelling in the ORA has been
presented in the ORA Accident Frequencies Report, ref. [1] .
In Table 1-1 all the identified events are shown together with the affected safety targets;
fatalities on road, fatalities on rail (both passengers and employees), disruption on road,
disruption on rail and repair cost. The numbers in the table are references to sections in this
report. If there are numbers opposite a given event, it means that the event has an effect on the
relevant safety targets. The consequences are described in more details in the referred sections.
A corresponding table containing references to sections containing descriptions of frequencies for
each of the risk are given in the ORA Accident Frequencies Report (ref. [1]).
Operational Risk Analysis
Work in Progress
1/178
1
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Initiating events
Fatalities
Road
Fatalities/inju
ries Rail
(both
passengers
and
employees)
Disruption
Road
Disruption
Rail
Repair cost
Ordinary road accidents
Ordinary road
4.3.1.1
traffic accident
Road accident involving DG
Ammonia
4.3.2.1.1
Chlorine
4.3.2.2.1
Corrosives
4.3.2.3.1
Explosives
4.3.2.4.1
Fire
road
Car
Bus
HGV (excl. DG)
DGV
Ordinary rail accidents
Train collisions
Train derailment
Train object
collision
Fire
rail
Passenger train
Freight train excl.
DG
Rail accidents involving DG
Ammonia
Chlorine
Corrosives
4.4.3.4
Explosives
External events
Flooding
Dropped and
4.5.4
dragged anchor
4.5.5
Grounding ship
Fire in transformer
room
4.5.2
Sunken ship
Multiple
simultaneous
events (fire/toxic
4.6
release and
accident causing
congestion)
4.3.3.1.2
4.3.3.1.2
4.3.3.1.2
4.3.3.1.2
4.3.1.2
4.3.2.1.2
4.3.2.2.2
4.3.2.3.2
4.3.2.4.2
4.3.3.2,
4.3.3.3
4.3.3.2,
4.3.3.3
4.3.3.2,
4.3.3.3
4.3.3.2,
4.3.3.3
4.4.2.1
4.4.2.1
4.4.2.1
4.4.2.2.3
4.4.2.2.3
4.4.2.2.3
4.3.1.2
4.3.2.1.2
4.3.2.2.2
4.3.2.3.2
4.3.2.4.2
4.3.3.2,
4.3.3.3
4.3.3.2,
4.3.3.3
4.3.3.2,
4.3.3.3
4.3.3.2,
4.3.3.3
4.4.2.3
4.4.2.3
4.4.2.3
4.4.5.1,
4.4.5.2
4.4.5.1,
4.4.5.2
4.4.3.1.2
4.4.3.2.2
4.4.3.3.2
4.4.3.4
4.5.1
4.5.4
4.5.5
4.5.3
4.5.2
4.3.2.4.1
4.3.2.4.2
4.3.3.2
4.3.3.2
4.3.3.2
4.3.3.2
4.4.2.2.2
4.4.2.2.1
4.4.2.2.2
4.4.5.1,
4.4.5.2
4.4.5.1,
4.4.5.2
4.4.3.1.2
4.4.3.2.2
4.4.3.3.2
4.4.3.4
4.5.1
4.5.4
4.5.5
4.5.3
4.5.2
4.4.5
4.4.5
4.4.3.1.1
4.4.3.2.1
4.4.3.3.1
4.4.3.4
4.4.5.1
4.4.5.1
4.4.3.4
4.5.1
4.5.4
4.5.5
4.5.4
4.5.5
4.5.3
4.5.2
4.5.2
*
*
Table 1-1 Events distributed on safety targets with references to relevant sections. *Disruption and
repair costs are assessed under fire and toxic release respectively.
The frequency report (ref. [1]) also contains a section with description of how each topic in TSI
SRT (ref. [32]) is handled in the ORA.
Operational Risk Analysis
Work in Progress
2/178
2
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
2.
SUMMARY
This report details the operational risk assessment for the design of the Fehmarnbelt Fixed Link
Tunnel. Within this report the following safety targets are considered:
Individual risk to road and rail users (both passengers and employees)
Third party risk
Societal risk
Risk of disruption (including repair cost)
Environmental risk
Risk to maintenance/inspection personnel
For all safety targets the risk is estimated. In all analysed cases the risk is considered acceptable.
2.1
Individual risk
In Table 2-1 the risk figures are presented for the year 2025 and 2045 as well as the
corresponding acceptable risk level. The risks are presented for the following safety targets:
Road users (fatalities)
Rail passengers (FWSI)
Rail employees (FWSI)
Others (FWSI)
2025
Fraction
of
acceptab
le risk
74.0%
84.2%
8.0%
0.3%
2045
Fractio
n of
accep-
table
risk
75.1%
90.0%
8.2%
0.5%
Road fatalities
Rail - FWSI
passengers
Rail - FWSI
employees
Individu
al Risk
0.17
2.60∙10
-3
8.81∙10
-4
1.15∙10
-5
Acceptab
le Risk
0.22
0.0031
0.0109
0.0035
Individu
al Risk
0.13
2.78∙10
-3
1.22∙10
-3
1.72∙10
-5
Acceptab
le Risk
0.17
0.00309
0.01486
0.00346
Rail - FWSI – Others
Table 2-1 Individual risk (the number of fatalities and FWSI per billion person passages) and acceptable
risk on road and rail in 2025 and 2045
It is noted that are risk figures are below the acceptance criteria, i.e., the risk is considered
acceptable.
In the estimation of the risk to employees it is seen that the risk only contributes a small part of
the acceptance criteria. In the modelling no risk model for harm to maintenance personal due to
rolling stock has been carried out. Clearly, there must be
“room” for the risk in the acceptance
criteria. With only 8% used, it is assessed that the risk for maintenance personal including FWSIs
due to rolling stock is considered acceptable.
Finally, it is seen that the risk for Others only constitute 0.3% of the acceptance criteria. This is
simply due to the low impact the railway has on the surroundings. Regarding Others it is
underlined that the risk to persons in cars, buses etc. that have been stopped outside the tunnel
due to an accident in a railway tube must to investigated further. They may be at risk if smoke
from a fire or a toxic release is ventilated to this area.
2.2
Third party risk
No third party risks have been identified.
Operational Risk Analysis
Work in Progress
3/178
3
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
In previous versions of the ORA the scope was chosen to be the enclosed tunnel part. In this case
no unauthorized persons are expected to enter the tunnel, as they will have to pass several
physical barriers, and the surveillance system will make sure that persons entering the area
would be seen and possibly stopped. Hence, persons entering the tunnel are persons who
deliberately choose to pass the physical barriers and they are considered similar to train-surfers
etc. who are omitted in a similar way as people committing suicide. However, considering the
free road and railway passages on the landsides there may be a risk that people will cross the
road and railway areas unauthorized, see ref. [33]. These stretches are, however, not different
from any other highway or railway in Denmark/Germany where crossing is not permitted, so
there is no argument for that the risk should be intolerable. Considering the location in the
country-side and that the area is partly closed, the risk is assessed not to be higher than similar
stretches in Denmark/Germany. Due to the above descriptions third party risk is not included in
the analysis.
2.3
Societal risk
(section to be updated autumn 2014)
The societal risk is the sum of the individual risk on road and rail and third party risk. The results
are presented in Table 2.2 in comparison to the acceptance criteria. The societal risk is
considered acceptable in both 2025 and 2045.
Societal Risk
2025
0.18
Acceptable
Risk 2025
1.64
Societal Risk
2045
0.15
Acceptable
Risk 2045
2.70
Fatalities per year
Table 2-2 Societal risk and acceptable risk in 2025 and 2045
2.4
Risk of disruption
The calculated disruption risk for road and rail individually and simultaneously is presented in
Table 2-3 and is considered acceptable. It is conservatively assumed, that the disruption covers
both tubes for road and rail respectively.
2025
Road tunnel disruption (days per year)(road alone*)
Rail tunnel disruption (days per year) (rail alone*)
Simultaneous road and rail disruption (days per year)
0.60
0.13
0.41
2045
0.96
0.15
0.46
Acceptable
Disruption
6.50
0.60
Table 2-3 Tunnel disruption in days per year (* does not include simultaneous disruption)
From Table 2-3 it is seen that it is acceptable to disrupt the railway 0.6 days a year. This
disruption may come from an event disrupting the rail alone or an event giving a simultaneous
disruption.
2.5
Environmental risk
No environmental risks have been identified.
In general all spillage (from e.g. trains/vehicles with dangerous goods) will be collected in the
drainage system from where it will be pumped to vehicles and handled in a proper way.
A scenario where the environment could be affected by e.g. dangerous goods is if the tunnel
collapses (e.g. caused by explosion). In this case some, considering the case, relative small
amount of substances will be able to flow into the sea. However, considering all other
consequences of a tunnel collapse, which will happen extremely rare, this consequence will be
relative low. The tunnel is high safety class and can withstand a very high overpressure.
2.6
Maintenance risk
Railway maintenance personal is included in the acceptance criteria for rail employees, which is a
group of persons defined in relation to the railway system in the CST and NRV’s.
Operational Risk Analysis
Work in Progress
4/178
4
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Persons carrying out maintenance work according to strict procedures. The following hazards that
may occur have been identified:
1) Person(s) injured/killed by electrocution by the overhead catenary system
2) Person(s) injured/killed by falling e.g. on stairs
3) Person(s) injured/killed due to train in motion
(1) Is not different than any other railway section/line in Denmark/Germany with an overhead
catenary system, and the work is carried out under legislation such as the High Voltage
Directive (The National Electrical Code Standard Handbook).
(2) Workers doing maintenance work will walk and use stairs. The risk of falling is of course
present. Stairs will, however, be designed following standard health and safety legislation,
e.g. Consolidation act on the Working Environment
(In Danish: Arbejdsmiljøloven).
(3) Is not covered by the quantitative risk model.
Because no quantitative risk model is carried out for 3),
it is important that there is some “room”
for risk in relation to maintenance personal in the acceptance criteria for employees.
For a detailed list of hazards, see ref. [33].
2.7
Unauthorized persons on railway premises
Unauthorized persons are a group of persons defined in relation to the railway system in the CST
and NRV’s.
Unauthorized persons are persons that deliberately gain access to the railway part of the system
without being authorized. One can imagine the following situations:
1)
On or more persons “surf” on the outside of the train. The person can e.g. get access to this
on a station near the tunnel.
2) Graffiti painters.
3) One or more persons choose to enter the railway area and follow the track in order to walk to
the other side of the tunnel using the railway track.
4) Persons that cross the railway track on the landsides.
The area around the tunnel will have a fence and signs, etc. so no persons will enter the area
without knowing that it is not allowed.
Train surfers (1) and graffiti-painters (2) that deliberately choose to go into the system knowing
very well the danger of the actions they do. Other persons along the track (3) will be similar to
(1) and (2).
A detailed list of hazards can be found in ref. [33].
Considering the location of the tunnel far away from larger cities, it is assessed that the likelihood
of occurrence of the identified hazards are less than in other/similar railway sections/lines in
Denmark/Germany. Hence, the risk for these types of events is considered not worse than the
average safety level in Denmark/Germany.
2.8
“Others”
“Others” is a group of persons defined in relation to the railway system in the CST and NRV’s.
For this railway system the users of
the road part will be considered as “others”.
An explosion in
the railway part is an example of an event, where people in the road part may be affected.
Neighbors are considered to be so far away from the tunnel portals that they will not be affected
by accidents with dangerous goods (toxic gasses or smoke) in the tunnel.
Operational Risk Analysis
Work in Progress
5/178
5
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Cars which are stopped outside the tunnel in case of an accident in the tunnel will be stopped by
barriers approximately 400 m outside the tunnel on the German side and approximately 250 m
outside the tunnel on the Danish side. It is assumed, that procedures will ensure that no people
in the cars will be affected by accidents with dangerous goods (toxic gasses or smoke) in the
tunnel even though a large toxic release inside the tunnel probably can affect people 250 m
outside the tunnel.
This means that only people on the road part of the system will be included in the risk
assessment
of “others”.
Operational Risk Analysis
Work in Progress
6/178
6
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.
SAFETY TARGETS AND RISK ACCEPTANCE CRITERIA
The consequences of each of the selected hazards and accidents are assessed against a number
of key criteria. These are presented and described in detail in ref. [3] and shown in Table 3-1.
Safety target
1. Individual risk to road users
2. Individual risk to rail passengers (NRV1.1)
3. Individual risk to rail employees (NRV 2)
4. Risk to level crossing users (NRV 3)
5. Risk to others (NRV 4)
6. Risk to unauthorised persons on premises (NRV 5)
7. Third party risk
8. Societal risk (composed of 1 to 7)
9. Risk of disruption
10. Environmental risk
Table 3-1 Safety targets
Measure
FAT/Year
FWSI/Year
FWSI/Year
FWSI/Year
FWSI/Year
FWSI/Year
FWSI/Year
FAT/Year,
F-N representation
Days/Year
F-N representation
Euro/Year
Related to
Road
Rail
Rail
Rail
Rail
Rail
Road and rail
Road and Rail
Road and Rail
Road and Rail
Furthermore, for all hazards the repair cost has been estimated. However, no risk acceptance
criteria have been setup with respect to cost.
3.1
FAT to FWSI conversion factors
In previous versions of the ORA, the risk has been estimated as a number of fatalities. However,
railway safety targets are measured in terms of Fatalities and Weighted Serious Injuries (FWSI)
per year. The connection between fatalities (FAT), FWSI and serious injuries (SI) can be
estimated on basis of data for accidents, showing a number of fatalities and serious injuries.
The following relation illustrates the connection:
where:
Based on the above relations between FWSI and FAT, a conversion factor can be estimated for
each of the safety targets relating to rail, so that conversion can be summarized in a single
factor:
W
1
is defined in ref. [30] and ref. [31] to 0.1, i.e. 10 seriously injured weights as 1 fatality. W
2
differs for each of the safety targets relating to rail and have been estimated in ref. [29]. The
resulting conversion factors are shown in Table 3-2.
Operational Risk Analysis
Work in Progress
7/178
7
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Safety target
Passengers
Employees
Level crossing users
Unauthorized persons
Other persons
Abbreviation
C
passenger
C
employee
C
level crossing
C
unauthorized
C
others
Conversion factor
1.4
1.4
1.05
1.04
1.1
Table 3-2 FAT to FWSI conversion factors for rail, ref. [29]
The conversion factors will be used to estimate the number of FWSI based on FAT.
For road users the corresponding W
2
is found from ref. [5], and the resulting conversion factor is
shown in Table 3-3.
Safety target
Raod users
Table 3-3 FAT to FWSI conversion factors for road
Abbreviation
C
road
Conversion factor
1.6
3.2
Quantified acceptance criteria
Detailed calculations for establishing quantified acceptance criteria have been presented in ref.
[3]. The results are summarized in Table 3-4.
Risk Acceptance Criteria
Risk to road users (FAT/passage)
Risk to rail passengers (FWSI/year)
Risk to employees (FWSI/year)
Risk to level crossing users (FWSI/year)
Risk to others (FWSI/year)
Risk to unauthorized persons on premises (FWSI/year)
Third party risk (FWSI/year)
Societal risk (FAT/year)
Risk of disruption to road (days/year)
Risk of disruption to road (days/year)
Risk of simultaneous disruption (days/year)
Environmental risk (Euro/year)
Table 3-4 Overview of the risk acceptance criteria
2025
0.223
3.09·10
-3
1.09·10
-2
-
3.67·10
-3
0.136
-
1.64
6.5
0.6
0.6
-
2045
0.174
3.09·10
-3
1.49·10
-2
-
4.98·10
-3
0.185
-
2.70
6.5
0.6
0.6
-
3.3
Cost of safety targets
According to the latest recommendations from the Danish Ministry of Finance (“Høringsversion af
vejledning til samfundsøkonomisk analyse fra Finansministeriet”) the value of a statistical life
(VSL) is 16 million DKK or approximately 2.1 million Euros in 2007 prices. This corresponds to
2.3 million Euros in 2009 prices.
The value from “Høringsversion af vejledning til samfundsøkonomisk analyse fra
Finansministeriet” is recommended as the preference value to be used for fatalities.
This
corresponds to 2025 and 2045 values in 2025 prices as given in Table 3-5.
2025
3.1
2045
4.3
Cost of one fatality, Million Euro
Table 3-5 Cost of fatalities in million Euros in 2025 prices
The cost of disruption relates to the extra cost for the society and the owners loss due to the
Operational Risk Analysis
Work in Progress
8/178
8
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
disruption. The societal cost is described by the extra time and distance that the users of the Link
are subject to in case of shorter or larger disruptions.
The basic assumption is that the traffic (both road and rail) will be lead over the route of the
Great Belt Bridge in case of closure of the Fehmarnbelt Fixed Link. The traffic is for simplicity
assumed to go through Copenhagen and Hamburg. Possible remedial transport in case of very
long disruptions is disregarded when assessing the cost values.
The calculated disruption costs are calculated based on unit prices for traffic economy issued by
the Danish Ministry of Transport, see ref. [11]. In general there is an initial cost for an event
causing disruption. This “start-up” cost is indicated in
Table 3-6.
Initial start-up
cost Per event (€m)
Road
2025
2045
0.08
0.14
Rail
2025
0.06
2045
0.12
Entire link
2025
2045
0.14
0.26
Table 3-6 Initial cost of an event causing disruption of part of or the entire link in million Euros in 2025
prices
Having an initial cost per disruption implies that longer disruptions are less expensive per day,
than shorter disruptions. In Table 3-7 are indicated the disruption costs for a day, a week, a
month, six months and a year.
Societal disruption
cost Million Euros
Per day
Per week
Per month
Six Months
A year
Road
2025
1.66
11.14
47.45
288.43
576.43
2045
3.13
21.07
89.74
545.815
1,090.23
2025
0.71
4.54
14.31
116.86
171.46
Rail
2045
1.27
8.24
28.47
211.82
342.7
Entire link
2025
2045
2.37
4.4
16.96
30.87
66.79
124.51
439.48
799.43
810.98
1,511.97
Table 3-7 Societal cost of disruption of part of or the entire link in million Euros in 2025 prices
It is seen that closing the entire link is relatively more costly than closing either the road or the
rail individually. This is because some transport originally planned for the closed part, can use the
non-closed part instead e.g. road tunnel users can go by train or freight can be transported by
road instead of rail.
The owners' loss due to disruption is calculated on basis of the expected income for 2025 (1871
million DKK) from ref. [12], and it is extrapolated to 2045 based on ref. [11].
Expected owners loss
2025
in €m (ex VAT)
Per day
Road part
2025
2045
0.560
0.836
Railway part
2025
2045
0.129
0.192
Entire link
2025
2045
0.662
1.060
Table 3-8 Owner loss due to disruption of part of or the entire link in million Euros in 2025 prices
Owners’ loss is assumed to be linearly dependent on time; hence the owners’ loss per week
equals 7 times the loss for one day. In case of disrupting the entire link the owners' loss in 2025
and 2045 has been scaled similarly to the societal costs.
In addition to the owner’s loss the cost of repairing after an accident must be assessed. The costs
are completely dependent on the type of accident, and hence these repair cost considerations are
described in the sections covering the consequences of the different accidents.
Environmental damage is assumed related to clearing and cleanup of an oil spill. The SAFEDOR
values ref. [10] which is also used in the Fehmarnbelt Fixed Link Navigational Studies ref. [8] is
recommended used. This will also provide consistency in the assessments. Thus, a cost of 13,100
USD in 2006 prices equal to 9,200 € per spilled tonne of oil will be used. Other spills will
- if
relevant - be related to oil spill prices.
Operational Risk Analysis
Work in Progress
9/178
9
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
A rough extrapolation of this cost of environmental damage is presented in Table 3-9. Please
note that the number in principle only covers the cleanup cost.
2025
13,200
2045
17,900
Clean up cost per tonne , Euros
Table 3-9 Environmental damage in Euros in 2025 prices
Operational Risk Analysis
Work in Progress
10/178
10
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
4.
CONSEQUENCE MODELLING
The following chapter describes the calculations and assessments carried out in order to assess
the consequences of different events.
In order to assess the consequences of a given event, some issues are important to address,
namely:
Which safety target is affected by the accident?
o
Road users (fatalities)
o
Rail users (fatalities)
o
Disruption
Road part (alone)
Rail part (alone)
Simultaneous disruption of rail and road
o
Repair costs
Population at the accident site
o
What is the traffic intensity at the time of the accident (e.g. difference between day
and night)
o
Rush hour traffic (peak our traffic)
o
For train accidents, the number of passengers on the train(s) are important
Location - where has the accident occurred?
o
On the landsides
o
In the enclosed tunnel
o
For railway accidents, evacuation procedures will be slightly different in the two
railway tubes
o
Distance to emergency exits
4.1
Population distributions
In the event of an incident it is important to identify the population at the time of the accident
and this is especially important when there is an ongoing risk to life safety such as a fire or toxic
release. In the following sections the figures for road and railway are presented.
4.1.1
Road
The road tunnel population as defined by ref. [27] is shown in Table 4-1.
Road Traffic
Annual average daily traffic (AADT)
[vehicles/day]
Cars
Cars (professional activities) 30%
Cars (private use) 70%
Lorries
Buses
Average person per vehicle
Cars (professional activities)
Cars (private use)
Lorries
Buses
Average load per lorry in tons
Table 4-1 Road tunnel traffic forecast and population
2025
11723
9819
2946
6873
1751
153
2.4
1.2
2.9
1.0
35.0
15.5
2045
19288
15221
4566
10655
3851
215
Operational Risk Analysis
Work in Progress
11/178
11
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
These figures for daily traffic flow and number of occupants per vehicle are average values. In
the event of an incident the average occupancy is taken and sensitivity studies assessing higher
or lower occupancy loading has not been considered at this time.
4.1.1.1
Average number of people in the road tubes in case of an road accidents
The traffic data forms the basis of the estimated number of passengers within the road tunnel in
case of an accident. At first a representative average number of vehicles are estimated from the
day, night and peak hour traffic on Scandlines ferries between Rødby and Puttgarden. The
statistics from Scandlines (see Figure 4-1) show that there is peak hour traffic intensity for 5
hours a day, daytime traffic intensity for 12 hours and night time traffic intensity for 7 hours. The
distributions are presented in Table 4-2.
Traffic distribution over day
8.0%
7.0%
6.0%
5.0%
4.0%
3.0%
2.0%
1.0%
0.0%
0
5
10
15
20
Hour
Figure 4-1 Traffic distribution over a day based on Scandlines data
2025
Traffic
Day time traffic
(excl. Peak hour)
6-9, 13-22
Peak hour traffic
10-15
Night time traffic
0-5, 23
Total
Percentage
Vehicles
Average
value per
hour
504
826
221
Vehicles
2045
Average
value per
hour
829
1359
364
52%
35%
13%
100%
5723
4129
1871
11723
9416
6793
3079
19288
Table 4-2 Traffic distribution on road
Choosing the middle of the tunnel as a representative location for accidents the number of cars
upstream of accident in the tunnel can be estimated. The estimate is based on the assumption of
an average speed of 90 km/h.
Operational Risk Analysis
Work in Progress
12/178
12
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Furthermore it is assumed that the traffic into the tunnel will be stopped after 2 minutes. The
estimated time to have the traffic stopped is short, but is based on the presence of the traffic
management system and VAID system to be provided in the tunnels.
Assuming that accidents occur at the middle of the tunnel on average the number of vehicles in a
queue is calculated by the following formula:
N
v
�½
A
0
t
0
t
s
3600
N
V
: vehicles in a queue
t
s
: time to stop traffic in case of an accident (120 s)
t
o
: time to drive to the middle of the tunnel at average speed, (364 s)
A
0
: vehicles per hour per tube
If the stopping time is taken as 2 minutes and the traffic volume is taken as average daytime
traffic, the number of vehicles and persons in the queue is presented in Table 4-3.
Vehicles in
queue
Cars
Buses
Lorries
Passengers
per vehicle
2.4
35.0
1.0
Number of
vehicles
72.7
1.1
13.0
Total
People in the tunnel
Average of 2025 and 2045
173.9
39.7
13.0
226.5
Table 4-3 Average number of vehicles and occupants in a queue in 2 tubes in case of an accident
4.1.2
Rail
The rail tunnel population as defined by ref. [27] is shown in Table 4-4.
Rail Traffic
Average number of freight trains per day
Average number of passenger trains per day
Passengers per passenger train
Operators/workers on passenger train
Operators/workers on freight train
Average load per freight wagon (ton)
Number of wagons per freight train
2025
87
40
95
2
1
17.7
30
2045
132
40
Table 4-4 Rail tunnel forecast and number of passengers per train
These figures for daily traffic flow and number of occupants per train are average values. In the
event of an incident the average occupancy is taken and sensitivity studies assessing higher or
lower occupancy loading has not been considered at this time, as the acceptance criterion is
defined with the average number of trains and persons.
4.1.2.1
Circumstances given a large accident
Considering a large accident in the modelling, e.g., explosion, grounding ship and other events
that may lead to tunnel collapse, it is important to know the circumstances for the accident. In
order to estimate the number of fatalities it is important to know how many cars and trains (and
the corresponding number of passengers) are expected to be present in the tunnel at the time of
the accident.
Analysing the train schedule for 2025, which is described in ref. [21], it is possible to estimate
how many persons are present in a single railway tube at a given time, when the number of
persons per train from Table 4-4 is used. The result is shown in Table 4-5.
Operational Risk Analysis
Work in Progress
13/178
13
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Trains present in a single tube
3 trains in tube
2 trains (Freight-Freight)
2 trains (Freight-Pass. or Pass.-Freight)
2 trains (Pass.-Pass.)
1 train (Freight)
1 train (Pass.)
Total time with trains in tube
Time without trains in tube
Number of
employees
0
2
3
4
1
2
-
0
Average number
of passengers
0
0
95
190
0
95
-
0
Fraction of time
0
1,78%
0,60%
0,05%
34,70%
11,44%
48,56%
51,44%
Table 4-5 Fraction of time with different train scenarios
If the accident is caused by an external factor (e.g. a grounding ship leading to tunnel
leakage/flooding) the number of persons (both passengers and employees) in the railway part
can be estimated using the table.
Assuming (conservatively) that in these “catastrophic” scenarios that 95% of the persons in the
tunnel will be fatalities, a distribution for the expected number of fatalities for passengers are
given in Table 4-6 and Table 4-7.
Passengers
Mean
21,83
0
87,92%
1
0%
3
0%
10
0%
30
0,96%
100
5,91%
300
5,21%
Total
100,00%
Table 4-6 Distribution of 95% of the expected number of passengers on railway in both railway tubes
Mean
1,20
Employees
0
1
53,17%
20,14%
3
23,88%
10
2,81%
30
0%
100
0%
300
0%
Total
100,00%
Table 4-7 Distribution of 95% of the expected number of employees on railway in both railway tubes
It is seen that on average over time 21.8 railway passengers are present at the same time in the
tunnel, while the corresponding number on average for employees is 1.2.
Whenever a specific train is involved in the accident, i.e., if an explosion is caused by a freight
train carrying dangerous goods then, this information is taken into account. Knowing that one
freight train is already present in the tunnel the conditional probabilities that one or more train is
present can be estimated on basis of Table 4-5. Furthermore, it is taken into account if the
accident is a derailment or a collision. Finally, the possible dangerous goods restriction is also
taken into account and the impact it has on the presence of passengers when there is a large
accident.
4.2
Fatalities on road and rail
The number of fatalities (and hence FWSIs using the relations in section 3.1) for a given event is
modelled based on a scale from zero through to the maximum number of occupants. The
majority of ordinary road accidents will lead to no fatalities. Conversely for a large toxic release
the probability of there being fatalities is higher. For all distributions for all the modelled events
see Appendix D.
As an example, ordinary accidents are assessed by means of the numbers presented in Table
4-8.
Operational Risk Analysis
Work in Progress
14/178
14
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Individual risk
[fatalities]
Probability
0
95.68%
1
4.22%
3
0.10%
10
0%
30
0%
100
0%
300
0%
Table 4-8 Example scale used for assessing number of fatalities and the distribution
In general these assessments are carried out on the basis of statistics, whenever available, and
when no information has been available, best engineering judgements have been made. In the
example given in Table 4-8 there is
given an accident - 95.7% chance that there are no
fatalities, 4.2% of 1 fatality, 0.1% of 3 fatalities etc. This gives an average of 0.019 fatalities per
accident.
For each accident scenario the probabilities in Table 4-8 are assessed for both road and rail,
respectively. The reason for assessing the distribution, and not only using the average value, is
to be able to represent the results by means of FN-curves, see e.g. ref. [4].
4.2.1
Disruption road and rail
Disruption times on road and rail in the event of an incident are assessed in a similar way to
fatalities with an example shown in Table 4-9.
Disruption time
[days per year]
Probability
0
75%
1
20%
7
4%
14
1%
30
0
180
0
365
0
Table 4-9 Example scale used for assessing the distribution of disruption time
In the example given in Table 4-9 the average disruption time is about 0.6 days per year
corresponding to about 15 hours. The tables are assessed for both road and rail.
4.2.2
Repair costs
Besides assessing the disruption time, the costs of repairing the tunnel after an accident must be
assessed. This is measured on similar scales as fatalities and disruption; presented in Table 4-10.
Repair cost [Euro]
Probability
10
3
0%
10
4
20%
10
5
70%
10
6
10%
10
7
0%
10
8
0%
10
9
0%
Table 4-10 Example scale used for assessing the repair cost distribution
The distribution in Table 4-10 leads to an average cost of
1.72∙10
5
Euro.
4.3
Road
In the following sections the consequences of all events occurring in the road part of the tunnel
are presented, these are:
Ordinary traffic accidents
Ordinary accidents involving dangerous goods
Fire
For each of the accidents the following parameters are assessed (if applicable):
The distribution of fatalities
The distribution of disruption time
o
Road part alone
o
Simultaneously disruption of road and rail
Repair costs
It is underlined that these distributions are assessed based on statistics available and best
engineering judgements. All assumptions made, are presented in the suitable sections.
Operational Risk Analysis
Work in Progress
15/178
15
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
4.3.1
Ordinary road accidents
Ordinary road accidents are for example colliding cars and normal traffic accidents. In the
modelling these accidents have been divided into accidents involving cars, buses and trucks
respectively. The latter leads to different consequences depending on if dangerous goods are
involved; this is dealt with in section 4.3.2.
In general it is assumed that ordinary accidents (not leading to fires, explosions or release of
dangerous goods) are relevant for the individual risk on road, disruption risk on road and on
repair costs. Hence, the accidents do neither lead to fatalities nor disruption of the railway part.
4.3.1.1
Individual risk road
Data for fatalities on motorways has been collected from 1998 to 2009 by the Danish Road
Directorate. However, the statistics include accidents that are not representative for the
Fehmarnbelt Fixed Link tunnel. By using the VIS-database a range of accidents have been
excluded, namely those including the following objects:
Accidents as an example include pedestrians, horses and mopeds
Turning accidents
Accidents in crossings
Accidents that occurs with opposite traffic
Accidents that occurs because of slippery roads caused by snow or ice
When these accidents were excluded from normal motorway accidents it resulted in a 12.6
percentage lower fatality rate per accident. The resulting fatality rates are shown in Table 4-11.
2025
0.029
2045
0.019
Average number of fatalities per accident
Table 4-11 Distribution of fatalities in ordinary road accidents on Fehmarnbelt Fixed Link Tunnel
The values have been distributed according to different types of accidents with assumptions
made for larger accidents which are typically not seen in the statistics.
It is underlined that statistics for accidents involving different vehicles types, such as cars, buses
and trucks were investigated in order to see if there was any difference in the average number of
fatalities in an accident. However, there was a small tendency that when a larger vehicle (bus or
truck) was involved the average number of fatalities was slightly and not significantly larger.
Hence, for simplicity the same fatality distribution has been used in the consequence modelling
for cars, buses and trucks.
4.3.1.2
Disruption risk and repair costs
In general there is not data available about for how long a time an ordinary accident will disrupt
the link and therefore engineering judgement has been made. Similarly values for the repair
costs are not readily available and have been assumed.
In general it is assumed that ordinary traffic accidents (not leading to fires, explosions or release
of dangerous goods) may lead to some downtime but do not lead to significant repair costs as
shown in Table 4-12.
Vehicle type
Car
Truck
Bus
Mean disruption
time [min]
60
90
120
Mean repair
costs [Euro]
2500
5000
5000
Table 4-12 Average disruption time for a traffic accident
Operational Risk Analysis
Work in Progress
16/178
16
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
It is noted that the values are average values for all accidents; some accidents will only disrupt
the traffic for a few minutes taking the vehicle(s) to the emergency lanes while other accidents
will lead to longer disruption times.
4.3.2
Road accidents involving dangerous goods
A fraction of the traffic accidents involve vehicles transporting dangerous goods. This implies that
some of the accidents will lead to release of toxic, flammable or explosive materials. In order to
assess the consequences of a release of such materials, CFD-modelling has been carried out for
representative substances. This includes dispersion analyses of LPG, chlorine and ammonia. The
consequences of selected release sizes are computed by means of the air-concentrations at given
locations of the given substances in the tubes. The results of the modelling are presented in ref.
[3].
Comparing the release characteristics with the population at the accident time and location in the
tunnel estimation of the number of fatalities can be carried out.
The persons at risk when there is a release can be divided into three groups:
The truck driver
People downstream the release
People upstream the release
In general people downstream are supposed to drive out of the tunnel (with a significantly higher
speed than the release propagates).
People upstream of the release are in general safe as long as the ventilation system works
properly. For the ventilation system an uptime (availability) of 99% has been assumed. There will
be some back-layering of the gases, the extent of which depends on the initial velocity of the
wind speed in the tunnel (which again depends on the traffic amount) and the length of time it
will take for the ventilation system to reach the critical velocity.
The truck driver is in general very exposed, due to that he will be located downstream the
release. Conservatively it is assumed that the truck driver will be fatally injured in these
scenarios.
4.3.2.1
Release of ammonia
4.3.2.1.1
Human impact
The human impact has been assessed by using the probit function to establish the LC50 and ppm
value for ammonia as described in section 9.1.6.2. In the consequence assessment for road, it is
assumed that by the time the air in the car has an ammonia concentration on 5 ppm (odour
threshold), the air outside the car has reached the final concentration calculated by the CFD
modelling, see section 9.1.5.2.The final concentration is of 4.200 ppm given a small release and
a concentration of 40.000 ppm given a medium release.
The number of fatalities depends on the number of people in the tunnel. As presented in section
9.1.5.3, a medium release of ammonia gives a concentration of 40.000 ppm. Without ventilation
this gives the people in the road tunnel between a half and one minute to evacuate into the
central gallery. Similar to the evacuation study related to fire, see section 4.3.3.1.2, a pre-
movement time of 60 seconds has been assumed and a walking speed of 1.2 m/s. The time it
takes to evacuate the persons from the road tube depends on the number of passengers. There
are on average 61 passengers in the tube.
Based on the evacuation assessment for fire in the road part, see section 4.3.3.1.2, it will take 2
minute and 24 seconds to evacuate a total of 113 passengers (the passengers in a region of 200
m behind the accident). This is a larger number of passengers then what are expected to be in
the tunnel following a toxic release. However, the toxic gas may induce the passengers to move
less rapidly, it is assumed that it will on average take 2 minute and 24 seconds to evacuate the
61 passengers as well.
Operational Risk Analysis
Work in Progress
17/178
17
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
The LC 50 calculations show that 50% of the passengers will die because of the ammonia gas if
they are exposed during more than 1 minute given the concentration of 40,000 ppm. It is
assessed that 50% of the passengers will be able to evacuate in one minute and that 50% of the
remaining 50% will be killed by the gas. This gives an additional 25% fatality probability from a
medium release of ammonia. It is assumed that a large release will give a higher concentration
and hence that it will give a 50% higher additional fatality probability; of total 38%. Taking
ventilation into account the fatalities are reduced by 99%. This is due to the ventilation system
blowing the gas release away from the queued traffic. In Table 4-13 the results distributed on
accident types are presented.
Consequence type
Ventilation failure
(1% probability)
Ammonia release
Ventilation ok
(99% probability)
Small
Medium
Large
Small
Medium
Large
Average number of fatalities
0.03
56.66
84.97
0.0003
0.57
0.85
Table 4-13 Average fatalities as a consequence of dangerous goods accident resulting in release of
ammonia in road tunnel
4.3.2.1.2
As
by
be
Disruption and repair cost
described in section 9.1.5.3.1 the road tunnel will also need to be cleaned after a toxic release
washing the interior with water. The concrete, asphalt and different installations may need to
replaced. It is assessed that the repair costs is estimated to on average €5000.
The tunnel will be closed on between 2.5 to 4.5 hours given a release of ammonia, which is the
downtime during cleaning of the tunnel.
4.3.2.2
Chlorine release
4.3.2.2.1
Human impact
The human impact has been assessed by using the probit function to establish the LC50 and ppm
value for chlorine as described in section 9.1.6.2. In the consequence assessment for road it is
assumed that by the time the air in the car has a chlorine concentration of 0.2 ppm (odour
threshold), the air outside the car has reached the final concentration calculated by the CFD
modelling, see section 9.1.5.2. The modelling results in a concentration of 4,200 ppm given a
small release and a concentration of 40,000 ppm given a medium release.
The number of fatalities depends on the number of people in the tunnel. A concentration of
1,000 ppm can be fatal after a few deep breaths of the gas, it is assessed that very few
passengers will be able to evacuate into the adjacent road tube (or central gallery) before they
are affected by the gas. In section 4.4.3.1.1 it has been assumed that it will take a minimum of 1
minute to evacuate a car after the gas has been detected. It is assessed that this is also the case
after a release of chlorine, it is therefore assessed that there will be an additional fatality
probability of 50% caused by a medium chlorine release. It is assumed that a large release will
give a higher concentration and it is assumed that it will give a 50% higher additional fatality
probability of in total 75%. Taking ventilation into account the average number of fatalities are
reduced by 99%. In Table 4-14 the result distributed on accident types is presented.
Consequence type
Chlorine release
Ventilation
failure (1%)
Ventilation ok
(99%)
Small
Medium
Large
Small
Medium
Large
Average number of fatalities
0.03
113.29
169.92
0.0003
1.13
1.70
Table 4-14 Average fatalities as a consequence of dangerous goods accident resulting in release of
chlorine in the road tunnel
Operational Risk Analysis
Work in Progress
18/178
18
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
4.3.2.2.2
Disruption and repair cost
The disruption time and repair costs are assumed to be the same as for ammonia, see section
4.3.2.1.
Hence, repair costs are estimated to cost on average €5000
and a disruption of 2.5 to
4.5 hours, which is the estimated down time for cleaning.
4.3.2.3
Corrosive release
In this section the assessment of consequences following a dangerous goods accident which could
lead to a release of corrosives in the road tube is presented.
4.3.2.3.1
Human impact
As described in section 9.1.4.1 it is assessed that there will not be any additional fatalities due to
a corrosive release, and the consequences are therefore estimated to be the same as for an
ordinary truck accidents.
4.3.2.3.2
Disruption and repair cost
The disruption time and repair costs are assumed to be the same as for ammonia and chlorine
see section 4.3.2.1.
Hence, repair costs are estimated to cost on average €5000
and a disruption
of 2.5 to 4.5 hours, which is the estimated down time for cleaning.
4.3.2.4
Explosions
4.3.2.4.1
Human impact
As described in section 9.2 explosions caused by solid explosions, vapour cloud explosions and
BLEVEs are assumed all to give the same consequences; namely collapse of a single tunnel
element. This is an assumption since an explosion may cause collapse of more than one element.
A collapse of one tunnel element due to an explosion in a road tube will affect vehicles and trains
in the adjacent tube as well as the other tubes. It is assumed that the accident occurs in the
middle of the road tunnel. Vehicles in both road tubes, which have just passed the collapsing
element, are assumed to be able to drive out of the tunnel, while all trains in the tunnel will be
affected. Conservatively assumed the accident leads to a 95% fatality rate inside in both road
tubes for vehicles approaching the element and 95% fatalities for all trains in the tunnel. See
section 4.1.2.1 for information on the presence of passengers during an accident.
The injuries and fatalities in the road part due to an explosion in the railway part is considered as
“others”. See section
2.8 for details.
4.3.2.4.2
Disruption and repair cost
Estimated repair time is assumed about one year, where the entire tunnel has to be closed for
traffic during the repairing period.
The repair cost
is estimated to €500 million.
4.3.3
Fire - road
Four event trees with a range of scenarios have been setup for the enclosed tunnel part and four
event trees covering the landsides; covering fire in cars, buses, HGVs and DGVs. For each of the
fire scenarios it has been estimated how often a fire is detected, if the suppression system works
and if ventilation works. For all four vehicle types this leads to a total of 44 fire scenarios in the
enclosed tunnel part, and in total 8 scenarios on the landsides. The reason for having fewer
scenarios on the landsides in the enclosed tunnel is simply due to the lack of mechanical
ventilation and automatic suppression on the landsides.
4.3.3.1
Safety to users
For each of the scenarios the population in the area of the fire is considered taken into account
the tenability criteria, described in the next section.
4.3.3.1.1
Tenability criteria
The tenability criteria describe the various parameters and at which levels people are expected to
die, regarding:
Operational Risk Analysis
Work in Progress
19/178
19
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Visibility
Thermal radiation
Convective temperature
CO concentration
The criteria have been chosen to be the following conservative values, ref. [16]:
Visibility = 5 m
Convective temperature = 100°C
Thermal radiation = 2.5 kW/m
2
CO Concentration = 1150 ppm
These criteria are used in the modelling in order to identify fatalities such that if a person is
located in a region where the visibility is less than 5 m or in a region with convective temperature
of 100
O
C, then that person will be considered a fatality.
4.3.3.1.2
Evacuation modelling
Detailed evacuation modelling has been carried out using the Legion software, ref. [7], which
takes into account:
geometry of the tunnel,
location of emergency exits,
walking speeds
how vehicles queue up upstream the fire
congestion and queuing of occupants
pre-movement characteristics (time before people starts to evacuate)
In general it is assumed that users are in safe areas in the non-incident tubes and in the central
gallery. In order to be conservative, it is assumed that vehicles queue up quickly after the fire
has started. In reality even with low volumes of traffic it will take a few minutes to fill up a
distance of, say, 200 m behind the incident. This implies that the results are independent of the
traffic volume, which again implies that the consequences following from a fire are the same in
2025 and 2045 (regardless that the traffic figures differ).
Important parameters used in the modelling are:
Distance between emergency exits: 100 m
Average walking speed of occupants: 1.2 m/s
The results of the evacuation modelling are that only 9 of the scenarios lead to fatalities see ref.
[16]. The scenarios are presented in Table 4-15 .
Description
Car
Bus
Bus
DGV
DGV
HGV
HGV
HGV
HGV
Fire Size (MW)
8
15
30
20
350
20
50
20
200
Detection
N
N
N
N
N
N
N
N
N
Suppression
N
Y
N
Y
N
Y
N
Y
N
Ventilation
N
N
N
N
N
N
N
N
N
Fatalities
3
3
3
3
3
3
3
3
3
Table 4-15 The nine fire scenarios in the road part leading to fatalities
It is seen that fatalities will occur if both the detection system as well as the ventilation system
must fail. In all scenarios a fire growth rate has been assumed which is identical regardless of the
maximum fire size. In this respect, during an evacuation, occupants are exposed to identical
conditions. It is only after the evacuation has been completed that the fire continues to grow to a
much large fire size. Hence where fatalities are expected the number of fatalities is taken to be
the same regardless of the maximum fire size.
Operational Risk Analysis
Work in Progress
20/178
20
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
4.3.3.2
Disruption and repair costs due to fires, enclosed tunnel
All fire scenarios are assumed to have a maximum heat release rate, measured in MW
(Megawatts), and it is assumed that the consequences, in terms of disruption as well as repair
costs, are related to peak fire size.
In ref. [6] the length of disruption and the repair costs are assessed for a 50MW fire and a
200MW fire if the fire incident is in the enclosed tunnel. These figures for disruption lengths and
repair costs are primarily based on statistical data for fire incidents in tunnels where suppression
systems have not been installed. Hence these figures are conservative upper limits. The selected
figures for different fire sizes relevant for the fire modelling can be seen in Table 4-16.
Peak Fire size
[MW]
1
2.5
8
15
20
30
50
200
350
Mean repair cost
[Euro]
1,500
9,375
96,000
337,500
600,000
1,350,000
15,000,000
60,000,000
105,000,000
Mean disruption,
incident tube
[days]
0.2
0.4
0.6
1
4
5
30
90
90
Mean disruption,
non-incident tubes
[hours]
1
2
3
6
8
12 (0.5 day)
84 (3.5 day)
168 (7 days)
168 (7 days)
Table 4-16 Assessed repair cost and disruption length for a range of fire sizes in enclosed tunnel
4.3.3.3
Disruption and repair costs due to fires, land sides
For the landsides, fires are not expected to lead to fatalities, due to the possibility of escaping
from the fire. Fires on landsides will, however, lead to disruption and to repair costs.
In general the repair costs and the disruption time will be much smaller if the fire is located on
the landsides comparing with consequences of fire in the enclosed tunnel part. This is primarily
due to that the amount of equipment is much larger in the enclosed tunnel part and that the
tunnel structure is not damaged by a fire outside the tunnel areas.
Disruption lengths and repair costs are assessed for a range of selected fire sizes relevant for the
fire modelling on the land side; the result can be seen in Table 4-17. In general it is assumed
that the repair costs for fires on landsides are 1/10 of the repair costs for a similar fire in the
enclosed tunnel part. For the same reasons the disruption time is much lower for fires on the land
sides. A fire on e.g. the road part of a land side is assumed not to have any impact on disruption
of the rail part, and vice versa. This is conservative
Fire size
[MW]
1
2.5
15
30
200
350
Mean repair cost
[Euro]
150.00
937.50
33,750.00
135,000.00
6,000,000.00
10,500,000.00
Mean disruption,
incident "tube"
[days]
0.2
0.4
0.5
1
2
2
Table 4-17 Assessed repair cost and disruption length for a range of fire sizes on the land sides
4.4
Rail
The consequence estimation for rail accidents has been divided into:
Ordinary rail accidents (derailments, train collisions and train-object collisions)
Operational Risk Analysis
Work in Progress
21/178
21
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
4.4.1
Accidents involving dangerous goods
Fire (on rolling stock)
Consequence reducing measures
Derailment containment provisions are meant to mitigate the consequences of an initial
derailment. They guide the derailed vehicle, preventing it from deviating further from the track,
hitting other objects and turning over.
Derailment provisions will be installed in the tunnel by means of the elevated walkways, which
will be designed to have adequate geometry (height and lateral position) and strength.
4.4.2
Ordinary rail accidents
The consequence estimation for rail accidents has been divided into derailments and collisions.
Derailments have been divided into severe derailments, resulting in fatalities, and not severe
derailments. Collisions have been divided into severe collisions and not severe collisions and into
front-front collisions and front-end collisions.
4.4.2.1
Fatalities and injuries (FWSI)
The accident frequencies for collisions and train derailments are presented in ref. [1].
The maximum number of fatalities caused by ordinary railway accidents on the Fehmarnbelt
Fixed Link is estimated on the basis of the number of people present on the trains. From Section
4.1.2 it can be seen that
Only one person is assumed to be inside a freight train, namely the driver.
On average 95 passengers and two employees (the driver and one other personnel) is
assumed to be on passenger train.
Based on accident information from accidents in Europe, the distribution of fatalities in accidents
with fatalities has been assessed. The number of fatalities has been divided into collision between
trains, train collision with objects and derailments.
On basis of the statistics in ref. [34] the expected fatality fraction of the passengers, drivers and
employees in Table 4-18 is established.
Fatality percentage
Passengers
Driver
Employees
Derailment
Trains collision (front
end)
Trains collision (front
front)
Collision with object
8.70%
2.70%
5.40%
2.90%
54.90%
29.60%
59.20%
44.40%
8.70%
2.70%
5.40%
2.90%
Table 4-18 Fatality percentages for train accidents with fatalities.
The figures are to be understood in the following way. The derailment scenario either leads to a
severe accident causing fatalities or to a non-severe accident/incident causing no fatalities. In
those cases where the derailment is severe, a fraction of 8.7% the passengers will be fatalities
and similarly will the train driver die with a probability of 54.9%. It is underlined that these
probabilities hold for accidents with severe consequences, on average including all accidents a
much lower fraction of the passengers will die in a derailment.
Based on these data the average number of fatalities and FWSI for derailments, collisions
between trains and train collision with objects has been estimated and presented in Table 4-19.
Operational Risk Analysis
Work in Progress
22/178
22
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Accident
type
Train(s) involved
Severity of
accident
Estimated
average number
of employee
FWSI
Estimated
average number
of passenger
FWSI
Derailment without
fatalities
Freight train
Derailment with
fatalities
Derailment
Derailment without
fatalities
Passenger train
Derailment with
fatalities
Front
end
Freight trains
Front
front
Front
end
Front
front
Front
end
Passenger trains
Front
front
Collision with no
fatalities
0
-
0.55
-
0
0
0.64
0.59
1.00
0.62
1.24
0.65
1.29
8.27
-
-
5.13
10.26
5.13
10.26
Passenger train/
freight train
Collision
All combinations
Passenger train
Train object
collision
Freight train
0
0.62
0.66
0
-
3.86
Front-object
Front-object
Collision with no
fatalities
All combinations
0
0
Table 4-19 Accident scenarios for rail accidents and corresponding estimated average number of FWSI for
passengers and employees
For comparison the data used in the risk assessment for the Øresund link ref. [13] shows that a
derailment on average leads to between 0 and 5 fatalities, while an average fatality of 6 for
front-front collisions involving a passenger train and an average fatality of 3 for front–end
collision involving a passenger train.
4.4.2.2
Disruption
The disruption time given a collision and a derailment has been assessed based on available
accident information. In the estimation it has been assumed that an accident leading to several
fatalities will have a longer disruption time than an accident without any fatalities. However, it is
assumed that an accident resulting in a fire or a toxic release will have a long disruption
regardless of the number of fatalities.
4.4.2.2.1
Derailments
Clearing up after a non-severe derailment of a single wagon is estimated to take 4 to 6 hours,
namely (ref. [14]):
Operational Risk Analysis
Work in Progress
23/178
23
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
1 hour for discovering the character of the problem,
2 hours for getting organized,
1 to 3 hours for doing the job.
4.4.2.2.2
Collisions
Clearing up after a train collision with no fatalities is estimated to take 6 hours on average, see
ref. [14]. It is assumed to cover both collisions between trains and train collision with objects.
Rescuing and clearing up after railway accidents with fatalities are estimated to take 24 hours on
average, ref. [14].
4.4.2.2.3
Disruption on road
For ordinary rail accidents that lead to fatalities on the rail, it is assessed that there will be a
disruption on the road as well. This is due to the fact that the road tube will be used for
evacuating passengers. The duration of the disruption on road depends on the severity of the
accident; the assumed disruption lengths are presented in Table 4-20.
The disruptions are assessed in terms of six severity classes 1 to 6, where 1 corresponds to the
shortest disruption time and 6 to the longest.
Disruption
Class
1
2
3
4
5
6
Example
Derailment of freight train with no fatalities
Derailment of passenger train with no fatalities
Front- end collision - freight trains
Front- end collision - passenger trains
Derailment/ Front-front collision passenger train with
fatalities
Front-front collision freight trains
Disruption
hours
1
2
4
6
8
10
Table 4-20 Road disruption consequences caused by ordinary rail accidents
4.4.2.3
Repair costs due to ordinary rail accidents
Based on estimated repair cost for fires on road, costs for ordinary rail accidents have been
estimated. It is assumed that a front- front collision with two passenger trains will damage the
rail tunnel to the same extent as a fire on road with fire size between 20MW and 30MW. The
other consequences have been assessed based on a comparison with the severity of front-front
collision with two passenger trains. The repair costs are presented in Table 4-21 again
represented with six consequence classes. It is underlined that the repair costs are only
considering damage to the tunnel, and not the rolling stock etc.
Tunnel damage class
1
2
3
4
5
6
7
Example
Derailment passenger train with no fatalities
Derailment freight trains with no fatalities
Front- end collision - no freight trains
Front- end collision - inv freight trains
Front-front collision passenger trains
Derailment/ Front-front collision with fatalities
involving freight train
Explosion
million €
0.01
0.05
0.1
0.5
1
5
500
Table 4-21 Consequences of repair costs for ordinary road and rail
4.4.3
Rail accidents involving dangerous goods
Similar to the modelling for the road a range of scenarios involving dangerous goods have been
modelled on the railway part. These include:
Operational Risk Analysis
Work in Progress
24/178
24
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Ammonia release
Chlorine release
Flammable liquids
LPG
Release of chlorine or ammonia in the rail tubes could be the result of an accident with a freight
train.
When estimating the consequences of an accident leading to e.g. a toxic release, fatalities due to
the “mechanical” accident (e.g. a collision) will not count as a fatality caused by dangerous
goods. Only the additional fatalities, due to the actual presence of dangerous goods will be
accounted as such.
4.4.3.1
Ammonia release
4.4.3.1.1
Human impact
The human impact due to an ammonia release on railway is similar to release on road, see
section 4.3.2.
The number of fatalities depends on the number of people in the tunnel. As presented in section
9.1.3 medium release of ammonia gives a concentration of 40.000 ppm and the average odour
threshold for ammonia is 5 ppm. This gives the train passengers between a half and one minute
to evacuate to the adjacent rail tube or the road tube.
Based on the evacuation assessment made for fire where a pre-movement distribution of
between 15 and 30 seconds (90% of occupants have 30 seconds pre-movement) and walking
speed is 1.2m/s. The time it takes to evacuate the rail tube depends on the number of
passengers. There are on average 95 passengers on a passenger train and based on the
evacuation assessment for fire on rail it will take 1 minute and 50 seconds for 95 passengers to
evacuate into the adjacent rail tube. It is assumed that after a collision or a derailment there
might be additional difficulties because of already injured passengers and doors that do not open.
It is therefore assessed that it will take 2 minutes to evacuate after a collision or a derailment.
The LC 50 (see appendix A in section 9) calculations show that 50% of the passengers will die
because of the ammonia gas if they are exposed during more than 1 minute given the
concentration of 40.000 ppm. It is assessed that 50% of the passengers will be able to evacuate
in one minute and that 50% of the remaining 50% will be killed by the gas. This gives an
additional 25% fatality probability from a medium release of ammonia. It is assumed that the
additional fatality probability is 50% higher for a large release then for a medium release which
gives a total 38% additional probability for fatalities after a large ammonia release. In Table 4-22
the result distributed on accident types is presented.
Operational Risk Analysis
Work in Progress
25/178
25
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Accident type -
Train(s) involved
Severity of
accident
Estimated average
number of
employee FWSI
0
0.35
0.53
0
0.70
1.05
0
0.70
1.05
0
1.05
1.58
0
1.05
1.58
0
0.35
0.91
Estimated average
number of
passenger FWSI
-
-
-
-
-
-
-
-
-
0
33.25
49.88
0
33.25
49.88
-
-
-
Severe derailment -
freight train carrying
ammonia
Small
Medium
Large
Small
Medium
Large
Small
Front -
Medium
front
Large
Small
Front -
Medium
end
Large
Small
Front -
Medium
front
Large
Small release
Medium release
Large release
Front -
end
Collision - Two freight
trains one carrying
ammonia
Collision - Passenger
train/ freight trains one
carrying ammonia
Train-object collision with
freight train
Table 4-22 Estimated FWSI as a consequence of a freight train accident resulting in release of ammonia
in the railway tunnel
As presented in section 9.1.5.3 a small release gives no additional (to the fatalities due to the
“mechanical” accident)
fatalities, the number of fatalities in case of a small release is the same as
an ordinary rail accident.
4.4.3.1.2
Disruption and Repair Cost
The disruption time and repair costs are assumed to be the same as for ordinary collisions. It is
assumed that the cost for cleaning up after a toxic release is negligible compared to the repair
cost after a collision, see Table 4-21. Disruption on rail is also estimated to be the same as for
ordinary rail accidents, see Table 4-20.
4.4.3.2
Chlorine release
4.4.3.2.1
Human impact
The human impact due to an ammonia release on railway is similar to release on road, see
section 4.3.2.
The number of fatalities depends on the number of people in the tunnel. As presented in section
9.1.3 medium release of chlorine gives a concentration of 40.000 ppm and the average odour
threshold for chlorine is 0.2 ppm. This gives the train passengers between a half and one minute
to evacuate to the adjacent rail tube or to the central gallery.
Since a concentration of 1.000 ppm can be fatal after a few deep breaths (se section 9.1.6.2) of
the gas it is assessed that very few passengers will be able to evacuate into the adjacent rail
tube before they are affected by the gas. In section 4.4.3.1.1 it was assumed that it will take a
minimum of 1 minute to evacuate the train after the gas is detected. It is assessed that this is
also the case after a release of chlorine it is therefore assessed that there will be an additional
fatality rate of 50% which caused by medium chlorine release. In Table 4-23 the result
distributed on accident types is presented. It is assumed that the additional fatality probability is
50% higher for a large release then for a medium release which gives a total 75% additional
probability for fatalities after a large chlorine release.
Operational Risk Analysis
Work in Progress
26/178
26
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Accident type -
Train(s) involved
Severity of
accident
Small
Medium
Large
Small
Medium
Large
Small
Front -
Medium
front
Large
Small
Front -
Medium
end
Large
Small
Front -
Medium
front
Large
Small release
Medium release
Large release
Front -
end
Estimated average
number of
employee FWSI
0.00
0.70
1.05
0.00
1.40
2.31
0.00
1.40
2.10
0.00
2.10
3.15
0.00
2.10
3.15
0.00
0.70
1.21
Estimated average
number of
passenger FWSI
-
-
-
-
-
-
-
-
-
0.00
66.50
99.75
0.00
66.50
99.75
-
-
-
Severe derailmant -
freight train carrying
chlorine
Collision - Two freight
trains one carrying
chlorine
Collision - Passenger
train/ freight trains one
carrying chlorine
Train-object collision with
freight train
Table 4-23 Estimated FWSI as a consequence of a freight train accident resulting in release of chlorine in
the railway tunnel
As presented in section 9.1.5.3, a small release gives no additional fatalities; the number of
fatalities in case of a small release is the same as an ordinary rail accident.
4.4.3.2.2
Disruption and repair cost
The disruption time and repair costs are assumed to be the same as for ordinary collisions. It is
assumed that the cost for cleaning up after a toxic release is negligible compared to the repair
cost after a collision, see Table 4-21. Disruption on rail is also estimated to be the same as for
ordinary rail accidents, see Table 4-20.
4.4.3.3
Corrosive release
4.4.3.3.1
Human impact
As described in section 9.1.4.1 it is assessed that there will not be any additional fatalities due to
an accident with corrosive release is therefore estimated to be the same as for ordinary rail
accidents involving freight trains.
4.4.3.3.2
Disruption and repair cost
The disruption time and repair costs are assumed to be the same as for ordinary collisions. It is
assumed that the cost for cleaning up after a toxic release is negligible compared to the repair
cost after a collision, see Table 4-21. Disruption on rail is also estimated to be the same as for
ordinary rail accidents, see Table 4-20.
4.4.3.4
Explosions
As described in section 9.2 explosions caused by solid explosions, vapour cloud explosions and
BLEVE are assumed to all give the same consequences; namely collapse of a single tunnel
element. This is an assumption since an explosion may cause collapse of more than one element.
A collapse of one tunnel element due to an explosion in one tube will affect trains and vehicles in
the accident tube as well as the other tubes. It is assumed that the accident occurs in the middle
of the tunnel. All trains in the tube with the explosion and the adjacent rail tube are assumed to
be affected as it is assumed, that the electrical systems will break down which means that the
Operational Risk Analysis
Work in Progress
27/178
27
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
trains cannot drive out of the tunnel. It is conservatively assumed that the accident leads to a
95% fatality rate for both tunnel tubes.
In Section 4.1.2.1 is described the estimated distribution of number of persons in the railway
tunnel.
Estimated repair time is assumed about one year. The entire tunnel has to be closed for traffic for
the repair time. The repair cost
is estimated to €500 million.
4.4.4
Modelling of dangerous goods restrictions
As described in ref. [1], the following restrictions will apply for dangerous goods transported on
railway:
Freight trains with RID-classified goods are only allowed in the tunnel, if there are no
passenger trains at the same track.
Freight trains with dangerous goods classified as RID class 1 or RID class 1.5 or 1.6 are
only allowed in the tunnel, when no other trains are in the tunnel, irrespective of tunnel
tube.
Freight wagons with dangerous goods classified as RID class 1 are only allowed to
transport 1000 kg explosive goods per train wagon.
The following general events will be affected by at least one of the restrictions:
Freight trains with RID-classified goods are only allowed in the tunnel, if there are no
passenger trains at the same track.
o
Collisions between passenger trains and freight trains carryings dangerous goods
will have their frequency set to 0.
o
No passengers will be present in the same tube
Freight trains with dangerous goods classified as RID class 1 or RID class 1.5 or 1.6 are
only allowed in the tunnel, when no other trains are in the tunnel, irrespective of tunnel
tube.
o
All train-train collision scenarios involving freight trains carrying explosives will
have their frequency set to 0.
o
The consequences of derailment and train-object collision scenarios involving
freight trains carrying explosives will be modified such that only fatalities among
employees on the freight train and road users are possible.
Freight wagons with dangerous goods classified as RID class 1 are only allowed to
transport 1000 kg explosive goods per train wagon.
o
This will not significantly affect the model in its current form, because it is
assessed that even 1000 kg of explosives will have a very large impact on the
tunnel structure and the persons inside the tunnel.
4.4.5
Fire
Rail
Detailed fire modelling has been carried out in order to establish the fire strategy, see ref. [16].
The fire modelling provides consequence inputs to the event trees for fire on:
Passenger trains
Freight trains
Fire in trains carrying dangerous goods
For the
passenger train and freight trains four different locations of the fire have been assumed:
Interior of train wagon
Under wagon
In engine
In roof
A probability for each of the fire locations has been assessed, namely interior (5%), engine
(40%), roof (40%) and under train wagon (15%).
Operational Risk Analysis
Work in Progress
28/178
28
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Evacuation analyses have been carried out for all the fire scenarios, see ref. [16]. The tenability
criteria chosen are similar as those for the road analyses, as described in section 4.3.3.1.1.
In general these analyses show that when there is average number of passengers on the train
(95 persons) the evacuation is efficient with little queuing. The same holds if there are 200
passengers on the train. If the maximum capacity is used (here assumed to be 588 passengers)
passengers will queue up at the exits and this will lead to a number of FWSI. A distribution for
the number of passenger has been proposed in appendix in C in section11; however, using the
distribution (a lognormal) the probability of having more than e.g. 350 passengers or more on a
train is less than 10
-7
. In order to ensure conservative estimates, the following assumptions are
made:
The number of fatalities on a train with 350 passengers is assumed to be the same as the
number of fatalities calculated on basis on a full train with 320 passengers.
The probability of having 350 passengers or more is assumed to be 0.1%
4.4.5.1
Disruption and repair costs due to fires, enclosed tunnel
All fire scenarios lead to a fire of a certain peak fire size, measured in MW (Megawatt). In the
consequence modelling, it assessed that for each peak fire size there are certain consequences in
terms of disruption as well as repair costs. Two factors are important when comparing
consequences of fires in the road and rail part:
Due to the fact that the train tube is smaller than the road tube, fires are expected to be
more intense and damage a longer section of tunnel.
Compared to road, restoring the rail tunnel after a fire will probably be more costly and
time consuming, due to strict validation and verification procedures in railway projects,
and because it is a more difficult and restricted working environment.
Due to these facts it is assumed that disruption time as well as repair costs are 50% higher than
for a similar fire in the road tube part. The results, i.e., assumed disruption time and repair costs
in the railway tube, are shown in Table 4-24.
Mean
disruption,
incident tube
[days]
0.3
0.6
0.9
1.5
6
10.5
45
135
135
Mean disruption,
other tubes
(non-incident tubes)
[hours]
1
3
6
9
12
18 (0.75 day)
126 (5.25 day)
252 (10.5 days)
252 (10.5 days)
Fire size
[MW]
1
2.5
8
15
20
30
50
200
350
Mean repair cost
[Euro]
2.250,00
14.062,50
144.000,00
506.250,00
900.000,00
2.025.000,00
22.500.000,00
90.000.000,00
157.500.000,00
Table 4-24 Assessed repair cost and disruption length for a range of fire sizes in enclosed tunnel
4.4.5.2
Disruption and repair costs due to fires, land sides
On landsides, fires are assessed not to lead to fatalities due to the possibility for escaping from
the fire. Fires on landsides will, however, lead to disruption and to repair costs.
In general the repair costs and the disruption time will be much smaller if the fire is located on
the landsides comparing with consequences of fire in the enclosed tunnel part. This is primarily
due to that the amount of equipment is much larger in the enclosed tunnel part and that the
tunnel structure is not damaged by a fire on the land sides.
Operational Risk Analysis
Work in Progress
29/178
29
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Based on Table 4-24 disruption lengths and repair costs are assessed for a range of selected fire
sizes relevant for the fire modelling on the land side; the result can be seen in Table 4-25. In
general it is assumed that the repair costs for fires on landsides are 1/10 of the repair costs for a
similar fire in the enclosed tunnel part. For the same reasons the disruption time is much lower
for fires on the land sides. A fire on e.g. the rail part of a land side is assumed not to have any
impact on disruption of the road part, and vice versa.
Fire size
[MW]
1
2.5
15
30
200
350
Mean repair cost
[Euro]
225
1406
50625
202500
9000000
15750000
Mean disruption,
incident "tube"
[days]
0.3
0.6
0.75
2.25
3
3
Table 4-25 Assessed repair cost and disruption length for a range of fire sizes on the land sides
4.5
External events
The consequences of the external events are presented in the following sections.
4.5.1
Flooding
Due to predictions and forecasts flooding is very unlikely to cause any fatalities. The tunnel will
simply in these cases be shut down, causing a disruption.
4.5.1.1
Heavy rainfall
The tunnel has been designed for heavy rainfall, but not for extreme rain events, which are
expected to occur on average every 50 years. In these cases it is assumed that:
It will take a long time to fill the drainage system; the pumps will continuously try to
empty the drain during the rainfall.
Only in cases where the pumping capacity is too small or is not properly functioning, the
drainage system can be filled.
Also an alarm shall appear in the tunnel SCADA if the drainage system is in a position
which implies a risk for water on the rail tracks.
In those cases water can start to fill the tunnel.
However, the water level should be very high before it has consequences in terms of
repair costs
such a rainfall is assessed not to occur in reality.
Hence, it is assessed that every 50 years the complete tunnel will be disrupted during such a
rainfall event
conservatively, this disruption is estimated at 6 hours.
4.5.1.2
High water level
The tunnel has been designed to resist a very high water level - see ref. [15]. Taking into
account that flood protection will be installed whenever the water level is too high, water is
prevented from entering the tunnel. In the very rare event of a mean water level higher than
4.6m above normal water level together with a worst case rainstorm event and global warming,
water will begin to flow into the tunnel. In this very unlikely event Lolland will be completely
flooded, and it will not be possible to get to the link from the Lolland side.
Again, as with heavy rainfall, the consequences are a disruption of the complete link. The event
is estimated to occur with a frequency of 3.0∙10
-5
in 2025 (and similarly with a frequency in 2045
of about 5.0∙10
-5
). In ref. [22] the consequence of flooding the substation is estimated to be a
disruption up to 12 month.
Operational Risk Analysis
Work in Progress
30/178
30
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
4.5.2
Sunken ship on tunnel
A sinking ship hitting the tunnel roof will cause a dynamic load during impact and subsequently a
static load originating from the weight of the ship. The Fehmarnbelt Fixed Link design load is 150
KN/m
2
. The impact force
F
on the tunnel roof from a sinking ship is determined as
F=m
g,
where
m
is the ship displacement and
g
is the gravitation.
It is assumed that the sinking ships will affect the tunnel in the same way regardless of how the
ship hits the tunnel roof, and that any ship with a load higher than the design load will cause the
tunnel to collapse.
The data that has been used to establish the frequency for sinking ships includes ship
displacement, length and ship width ref. [9].
It has been assumed that the ships loads are distributed on 10% of the ships’ area when it hits
the tunnel. This is likely a conservative assumption.
Calculations based on evaluation of impact forces and tunnel capacity results in that 0.4% of all
impact on the tunnel from sinking ships lead to a collapse of the tunnel, i.e. the collapse
frequency is 1.610
-7
in 2025 and 2.710
-7
in 2045.
It is assumed that a collapse of the tunnel due to a sunken ship affects the people in the tunnel
in the same way as an explosion, which implies that the following assumptions are made:
A sunken ship beyond design load cause collapse of one element
A collapse of one tunnel element will affect vehicles in all tubes
The ship hits the middle of the tunnel
Vehicles which just have passed the collapsing element are assumed to be able to drive
out of the tunnel
All train in the tunnel will be affected by the collapse
Calculations for explosion show that a collapse of the tunnel will lead to 215 fatalities on average
on road and 17.4 fatalities or 19.4 FWSI on rail.
Estimated repair time is assumed to be about one year, where the entire tunnel has to be closed
for traffic during the repairing period. The repair cost given such an accident is estimated to 500
million Euros.
4.5.3
Fire in transformer room
There are 10 transformer rooms in connection to the road tunnel and 10 transformer rooms in
connection to the rail tunnel. In each transformer room there are 2 transformers.
Substations will be placed in the tunnel at the location of each special element containing
transformers, switchgear and distribution boards. Each of the substations will be equipped with
redundant switchgear and transformers. There is a gaseous suppression fire fighting system in
each of the substations. Each room will be separated by firewalls and escape doors.
Since the transformer rooms will be separated by fire walls it is assumed that fire in a
transformer room will not cause any fatalities.
The following assumptions have been used:
The fire suppression system does not affect the transformers in a way that could lead to
a longer disruption time.
One functioning transformer per transformer room is assumed sufficient to stay in
operation.
Since there are redundant transformers and switchgear, there will be no disruption
caused be power failure due to fire in a transformer room.
Operational Risk Analysis
Work in Progress
31/178
31
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
The gaseous suppression will suppress the fire before the other transformer in the room
is affected.
In case of a fire in a transformer room there will be an average disruption of 1 hour in
the tube where the transformer room is located in order to inspect the consequences of
the fire.
The estimated cost for fire in transformer room is assumed to be €1.500 if suppression works
(90%) and €150.000 if the suppression system does not work
(10%).
It is assumed that there will be one metre between every vehicle. The calculations show that
there will be on average 26 people trapped between the two fires and it is conservatively
assumed that they will be fatally injured.
4.5.4
Dragged and dropped anchor
In this section the consequences in terms of fatalities and disruption of the tunnel due to dragged
and dropped anchors are presented.
In the frequency assessment the initial event frequency is to be calculated in the nearest future,
and the results of the calculations are expected to be included in the Operational Risk Analysis
within the autumn 2014 revision.
The frequencies cover all types of accidents related to dragged and dropped anchors. The
following two types of cases are considered:
No damage or minor anchor damage to the tunnel and the protection layer
Critical damage to the protection layer and the tunnel roof
The people that have just passed the accident location will drive out of the tunnel and the people
approaching the accident location will be fatally injured. Based on calculations made for
explosions it is assessed that there will be 215 fatalities on road and 17.4 fatalities or 19.4 FWSI
on rail.
These calculations have also been used for sunken ship on tunnel. There will be 365 disruption
days on both road and rail and it will cost €500 million to repair the tunnel.
4.5.5
Grounding ships
The ship grounding frequencies covers all types of groundings. In the following two types of
groundings are considered:
Groundings leading to no damage or minor damage to the tunnel and the protection layer
Serious grounding leading to critical damage to the protection layer and the tunnel roof
For groundings giving minor damages the grounding ship will simply slide on the seabed and will
not penetrate the seabed and the protection layer. Hence, there will be no fatalities amongst the
tunnel users. However, the grounding in itself will lead to a stop in the tunnel operation during a
period while it is investigated whether or not the grounding ship has damaged the tunnel roof
after all. It is assumed that the disruption period will be approximately one day.
Ship size 1 to 5 is not assumed to cause any greater damage to the tunnel in case of grounding.
Only ship size 6 - 9 is assumed to provide serious damage by grounding.
For critical damage, the draught of the grounding ship must significantly exceed the water depth
leading to a penetration of the protection layer and leading to serious tunnel roof damages and
water ingress into the tunnel. It is assumed that the structural damage solely affects one tunnel
tube.
It is assumed that the grounding will take place in coastal areas and that the water inflow into
the tunnel tube will affect all persons in the tunnel tube. Further, it is conservatively assumed
that the disruption is a total disruption covering all tunnel tubes.
Operational Risk Analysis
Work in Progress
32/178
32
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
It is conservatively assessed that a grounding leading to a tunnel collapse will affect the people in
the tunnel in the same way as an explosion in the end or beginning of the tunnel, see section
4.3.2.4.
In the explosions calculations it is assumed that vehicles in the road tubes that have just passed
the accident location will drive out of the tunnel and the vehicles approaching the accident
location will be affected by the accident. All trains in the tunnel will be affected by the accident.
In Section 4.1.2.1 is described the estimated distribution of number of persons in the railway
tunnel.
It is assessed that there will be 365 days of
disruption on both road and rail and it will cost €500
million to repair the tunnel.
4.6
Multiple simultaneous events
As no simultaneous events for rail are subject to detailed frequency calculation, no consequences
are found for multiple simultaneous events for rail.
It is assessed that disruption and repair costs is included in the assessment of fire and toxic
release on road and this section only include a consequence assessment in regard to fatalities.
The consequence that is assessed in this section is the consequences of multiple simultaneous
events that could lead to persons being trapped in an area with smoke or toxic gas. In this
context a toxic release has the same properties as smoke from a fire, but will not be covered in
this analysis since a combination of these events is highly unlikely. It is assessed that it will
contribute very little to the total number of fatalities per year on The Fehmarnbelt Fixed Link.
In the assessment it is assumed that the only scenario that is not included in the fire assessment
is the scenario where two fires occur within 100 meters from each other where the emergency
exits will be blocked. The fire frequencies for the entire fixed link have been scaled to the 100
meters in this assessment and are presented in Table 4-26.
Yearly frequency
2025
2045
Table 4-26 Scaled yearly fire frequency
8.18∙10
-8
1.90∙10
-7
In order to estimate the number of persons exposed, the number of vehicles within 100 m must
be assessed. The estimated vehicle lengths are presented in Table 4-27.
Vehicles in a queue
Cars
Buses
Lorries
Table 4-27 Vehicle length
Vehicle length [m]
4.75
16.5
13.7
Operational Risk Analysis
Work in Progress
33/178
33
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
5.
RISK
In this section the risk is presented for all scenarios. The risk is calculated by multiplying the
frequencies and the consequences:
Risk = frequency
∙ consequence
The risk is calculated and presented in terms of annual expected fatalities on road and rail,
annual expected disruption days on road and rail and annual expected repair costs.
5.1
Ordinary road
The risk of ordinary road accidents in terms of fatalities, disruption and repair costs are presented
in Table 5-1.
Rail - FWSI
Road -
fat
2025
2045
1.6∙10
-1
1.3∙10
-1
Pass
0
0
Employee
s
0
0
Road
[alone]
2.5∙10
-1
2.9∙10
-1
Disruption [days]
Rail
[alone]
0
0
Simultaneou
s
0
0
Repair
cost
[euro]
1.6∙10
4
1.9∙10
4
Table 5-1 Risk of ordinary road accidents in terms of fatalities, FWSI, disruption and repair costs
From Table 5-1 it is seen that there will be no fatalities or disruption on rail caused by ordinary
road accidents. Note that dangerous goods accidents are not included here.
5.2
Road accidents involving dangerous goods
In Table 5-2 the results for accidents involving dangerous goods are presented (ordinary road
accidents not including dangerous goods are excluded).
Rail - FWSI
Road -
fat
Pass
1.1∙10
-4
1.1∙10
-4
Employees
5.8∙10
-6
5.8∙10
-6
Disruption [days]
Road [alone]
1.0∙10
-3
1.2∙10
-3
Rail [alone]
0
0
Simultaneous
1.7∙10
-3
2.0∙10
-3
Repair cost
[euro]
1.8∙10
3
2.1∙10
3
2025
2045
2.3∙10
-3
3.5∙10
-3
Table 5-2 Risk from accidents involving dangerous goods on road in terms of fatalities, FWSI, disruption
and repair costs
5.3
All road accidents
In Table 5-3 the results for road accidents - ordinary road accidents and road accident involving
dangerous goods are presented.
Rail - FWSI
Road -
fat
Pass
0
0
Employees
0
0
Road
[alone]
2.5∙10
-1
2.9∙10
-1
Disruption [days]
Rail
[alone]
0
0
Simultaneous
1.7∙10
-3
2.0∙10
-3
Repair
cost
[euro]
1.8∙10
-4
2.1∙10
-4
2025
2045
1.7∙10
-1
1.3∙10
-1
Table 5-3 Risk from all road accidents in terms of fatalities, FWSI, disruption and repair costs
Operational Risk Analysis
Work in Progress
34/178
34
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
5.4
5.4.1
Fire (road)
Results for fire in road part, enclosed tunnel
The risk of fires in the tunnel road part in terms of fatalities, disruption and repair costs are
presented in Table 5-4.
Rail - FWSI
Road -
fat
Pas
s
0
0
Employee
s
0
0
Road
[alone]
2.7∙10
-1
5.1∙10
-1
Disruption [days]
Rail
[alone]
0
0
Simultaneou
s
5.0∙10
-2
9.1∙10
-2
Repair
cost
[euro]
5.0∙10
4
1.1∙10
5
2025
2045
9.6∙10
-5
2.1∙10
-4
Table 5-4 Risk of fires in the enclosed tunnel road part in terms of fatalities, FWSI, disruption and repair
costs
From Table 5-4 it is seen that the disruption on the rail is caused by the fire on road and
therefore determines a simultaneous disruption of road and rail of 0.04 days in 2025 and 0.07
days in 2045.
5.4.2
Results for fire in road part, landsides
The results of fires on landsides are presented in Table 5-5.
Rail - FWSI
Road -
fat
2025
2045
0
0
Pass
0
0
Employee
s
0
0
Road
[alone]
8.6∙10
-2
1.5∙10
-1
Disruption [days]
Rail
[alone]
0
0
Simultaneou
s
0
0
Repair
cost
[euro]
5.1∙10
4
1.1∙10
5
Table 5-5 Risk of fires in the road part of the land sides in terms of fatalities, FWSI, disruption and repair
costs
It is seen that fires on the road part of the landsides are neither expected to lead to fatalities, nor
disruption of the railway part.
5.5
Results
landsides and enclosed tunnel
The summarized results for the landsides and the enclosed tunnel are presented in Table 5-6.
Rail - FWSI
Road -
fat
Pass
0
0
Employee
s
0
0
Road
[alone]
3.5∙10
-1
6.6∙10
-1
Disruption [days]
Rail
[alone]
0
0
Simultaneou
s
5.0∙10
-2
9.1∙10
-2
Repair
cost
[euro]
1.0∙10
5
2.2∙10
5
2025
2045
9.6∙10
-5
2.1∙10
-4
Table 5-6 Risk of fire in the road part of the total scope (landsides and enclosed tunnel) in terms of
fatalities, FWSI, disruption and repair costs
It is seen that fires in the road part leads to about 0.3 days disruption of the road part (in 2025).
Here it is conservatively not taken into account that it probably will be possible to use the other
road for traffic in both directions, not by means of bi-directional traffic, but by shifting the traffic
direction e.g. every hour.
Looking at the disruption time for the different fire sizes, by joining the results in Table 4-16 and
Table 5-4 for the enclosed tunnel part, and Table 4-17 and Table 5-5 for the landsides part, the
results per fire size can be obtained. From this it is seen that about 20% of the disruption time
originates from fires with a size of 50 MW or more, i.e., very large fires that results in a long
Operational Risk Analysis
Work in Progress
35/178
35
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
disruption time. Subtracting the disruption time originating from very large fires, the average
disruption time for road in 2025 is considerably less than 0.4 days per year.
5.6
Ordinary rail
The results from ordinary rail accidents, i.e. derailments and collision are presented in the next
section.
5.6.1
Results ordinary rail
The consequences of ordinary rail in terms of fatalities, disruption and repair costs are presented
in this section, not including accidents involving dangerous goods (these are presented in the
following sections). In Table 5-7 the risk of derailments are presented.
Rail - FWSI
Road
- fat
Pass
1.8∙10
-4
1.8∙10
-4
Employee
s
1.6∙10
-4
2.4∙10
-4
Road
[alone]
0
0
Disruption [days]
Rail
[alone]
6.6∙10
-4
1.0∙10
-3
Simultaneou
s
8.6∙10
-4
1.3∙10
-3
Repair
cost
[euro]
2.0∙10
2
2.9∙10
2
2025
2045
0
0
Table 5-7 Risk of derailments in terms of fatalities, FWSI, disruption and repair costs
In Table 5-8 the risk of collisions between trains are presented.
Rail - FWSI
Road -
fat
2025
2045
0
0
Pass
1.3∙10
-3
1.3∙10
-3
Employee
s
2.9∙10
-4
3.9∙10
-4
Road
[alone]
0
0
Disruption [days]
Rail
[alone]
4.2∙10
-4
5.1∙10
-4
Simultaneou
s
2.5∙10
-4
3.4∙10
-4
Repair
cost
[euro]
3.7∙10
2
5.2∙10
2
Table 5-8 Risk of collisions between trains in terms of fatalities, FWSI, disruption and repair costs
In Table 5-9 the risk of train-object collisions are presented.
Rail - FWSI
Road -
fat
2025
2045
1.7∙10
-6
2.7∙10
-6
Pass
5.1∙10
-4
5.1∙10
-4
Employe
es
2.6∙10
-4
3.6∙10
-4
Road
[alone]
0
0
Disruption [days]
Rail
[alone]
3.4∙10
-4
4.7∙10
-4
Simultaneou
s
3.3∙10
-4
4.4∙10
-4
Repair
cost
[euro]
1.9∙10
2
2.8∙10
2
Table 5-9 Risk of train-object collisions in terms of fatalities, FWSI, disruption and repair costs
From Table 5-7, Table 5-8 and Table 5-9 it is seen that there will be no fatalities or disruption of
the road part alone caused by ordinary rail accidents.
5.6.2
Rail accidents involving dangerous goods
In Table 5-10 the results from the consequence assessment for rail are presented.
Operational Risk Analysis
Work in Progress
36/178
36
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Rail - FWSI
Road -
fat
2025
2045
7.4∙10
-6
1.1∙10
-5
Pass
1.4∙10
-6
1.7∙10
-6
Employe
es
1.4∙10
-7
2.0∙10
-7
Road
[alone]
0
0
Disruption [days]
Rail
[alone]
2.2∙10
-4
3.1∙10
-4
Simultaneou
s
7.0∙10
-5
1.0∙10
-4
Repair
cost
[euro]
4.6∙10
2
6.8∙10
2
Table 5-10 Risk from collisions and derailments involving dangerous goods on rail in terms of fatalities,
FWSI, disruption and repair costs
The injuries and fatalities in the road part caused by dangerous goods events in the railway part
are considered as “others”.
5.7
5.7.1
Fire (rail)
Results for fire in railway part, enclosed tunnel
The risk of fires in the enclosed tunnel rail part in terms of fatalities, disruption and repair costs
are presented in Table 5-11.
Rail - FWSI
Road -
fat
Pass
5.2∙10
-5
5.2∙10
-5
Employe
es
1.1∙10
-6
1.1∙10
-6
Road
[alone]
8.6∙10
-4
9.8∙10
-4
Disruption [days]
Rail
[alone]
8.4∙10
-3
9.8∙10
-3
Simultaneou
s
8.6∙10
-4
9.8∙10
-4
Repair
cost
[euro]
1.6∙10
3
1.8∙10
3
2025
2045
0
0
Table 5-11 Risk of fires in the enclosed tunnel rail part in terms of fatalities, FWSI, disruption and repair
costs
From Table 5-11 it is seen that disruption on the road part can be caused by a fire on rail and
therefore determines a simultaneous disruption of road and rail of 0.015 days in 2025 and 0.028
days in 2045.
5.7.2
Results for fire in railway part, landsides
The risks of fires on landsides are presented in Table 5-12.
Rail - FWSI
Road -
fat
2025
2045
0
0
Pass
0
0
Employee
s
0
0
Road
[alone]
0
0
Disruption [days]
Rail
[alone]
9.2∙10
-2
9.6∙10
-2
Simultaneou
s
0
0
Repair
cost
[euro]
3.0∙10
4
8.4∙10
3
Table 5-12 Risk of fires in the landsides rail part in terms of fatalities, FWSI, disruption and repair costs
It is seen that fires on the rail part of the landsides are neither expected to lead to fatalities, nor
disruption of the road part. It is seen to lead to a yearly average disruption of the railway of
about 3.8 days per year in 2045.
5.7.3
Results for fire in railway part, landsides and enclosed tunnel
The summarized results for the landsides and the enclosed tunnel are presented in Table 5-13.
Operational Risk Analysis
Work in Progress
37/178
37
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Rail - FWSI
Road -
fat
2025
2045
0
0
Pass
5.2∙10
-5
5.2∙10
-5
Employe
es
1.1∙10
-6
1.1∙10
-6
Road
[alone]
8.6∙10
-4
9.8∙10
-4
Disruption [days]
Rail
[alone]
1.0∙10
-1
1.1∙10
-1
Simultaneou
s
8.6∙10
-4
9.8∙10
-4
Repair
cost
[euro]
3.2∙10
4
1.0∙10
4
Table 5-13 Risk of fire in the road part of the total scope (landsides and enclosed tunnel) in terms of
fatalities, FWSI, disruption and repair costs
5.8
External events
In the following sections the risk for the external events are presented.
5.8.1
Flooding
The risk of flooding in terms of fatalities, disruption and repair costs are presented in Table 5-14.
Rail - FWSI
Road -
fat
Pass
0
0
Employee
s
0
0
Road
[alone]
0
0
Disruption [days]
Rail
[alone]
0
0
Simultaneou
s
3.4∙10
-1
3.4∙10
-1
Repair
cost
[euro]
0
0
2025
2045
0
0
Table 5-14 Risk of flooding in terms of yearly average fatalities, FWSI, disruption and repair costs
5.8.2
Sunken ship on tunnel
The risk of sunken ship on tunnel in terms of fatalities, disruption and repair costs are presented
in Table 5-15.
Rail - FWSI
Road -
fat
Pass
0
0
Employee
s
0
0
Road
[alone]
0
0
Disruption [days]
Rail
[alone]
0
0
Simultaneou
s
5.9∙10
-5
1.0∙10
-4
Repair
cost
[euro]
8.1∙10
1
1.4∙10
2
2025
2045
3.5∙10
-5
5.9∙10
-5
Table 5-15 Risk of sunken ship on tunnel in terms of yearly average fatalities, FWSI, disruption and
repair costs
5.8.3
Dragged and dropped anchor
The risk of dragged and dropped anchor in terms of fatalities, disruption and repair costs are
presented in Table 5-16.
Rail - FWSI
Road -
fat
Pass
5.0∙10
-8
8.3∙10
-8
Employe
es
2.7∙10
-9
4.6∙10
-9
Road
[alone]
0
0
Disruption [days]
Rail
[alone]
0
0
Simultaneou
s
4.3∙10
-7
7.1∙10
-7
Repair
cost
[euro]
1.5∙10
0
2.5∙10
0
2025
2045
3.5∙10
-7
5.9∙10
-7
Table 5-16 Yearly average risk due to dropped and dragged anchor in terms of fatalities, FWSI,
disruption and repair costs
5.8.4
Grounding ship
The risk of grounding ships in terms of fatalities, disruption and repair costs are presented in
Table 5-17.
Operational Risk Analysis
Work in Progress
38/178
38
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Rail - FWSI
Road -
fat
2025
2045
4.4∙10
-6
7.3∙10
-6
Pass
6.2∙10
-7
1.0∙10
-6
Employe
es
3.4∙10
-8
5.7∙10
-8
Road
[alone]
0
0
Disruption [days]
Rail
[alone]
0
0
Simultaneou
s
7.4∙10
-6
1.2∙10
-5
Repair
cost
[euro]
1.0∙10
1
1.7∙10
1
Table 5-17 Risk due to ship groundings on tunnel roof in terms of fatalities, FWSI, disruption and repair
costs
5.8.5
Fire in transformer room
The risk of fire in transformer room in terms of fatalities, disruption and repair costs are
presented in Table 5-18. From Table 5-18 it is seen that there will be no fatalities on rail or road
caused by fire in transformer room.
Rail - FWSI
Road -
fat
2025
2045
0
0
Pass
0
0
Employee
s
0
0
Road
[alone]
0
0
Disruption [days]
Rail
[alone]
0
0
Simultaneou
s
1.7∙10
-3
1.7∙10
-3
Repair
cost
[euro]
2.1∙10
1
2.1∙10
1
Table 5-18 Risk of fire in transformer room in terms of fatalities, FWSI, disruption and repair costs
5.8.6
Multiple simultaneous events
In the multiple event scenarios it has been assessed that only the scenario with two fires very
close to each other could lead to fatalities.
Rail - FWSI
Road -
fat
Pass
0
0
Employee
s
0
0
Road
[alone]
*
*
Disruption [days]
Rail
[alone]
*
*
Simultaneou
s
*
*
Repair
cost
[euro]
*
*
2025
2045
2.0∙10
-6
4.6∙10
-6
Table 5-19 Risk of two fires in terms of fatalities, FWSI, disruption and repair costs
*Disruption and repair costs are assessed under fire, toxic releases and traffic accident
respectively.
5.8.7
Qualitative assessments of maintenance operations
In general there has been focus on developing a tunnel design that ensures optimal conditions for
workers and maintenance personnel.
The whole maintenance strategy and philosophy has been described in detail in ref. [20]. Some
main points regarding safety are:
A significantly part of the maintenance work is located in the special elements
Maintenance workers may park the car in separate lay-by in the special elements - hence
no parking is done in e.g. emergency lane.
The worker can go directly to the service rooms from the lay-by
In order to get controlled access to the other side of the tubes, the worker can use a
channel located under the road
hence the worker does not have to pass the road with
traffic.
All installation rooms have two separate doors to ensure the possibility for safe escape
Hence, no maintenance workers are expected to be harmed due to maintenance work in the
tunnel and landsides.
Operational Risk Analysis
Work in Progress
39/178
39
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
6.
6.1
RESULTS
Acceptance criteria
The calculated risk acceptance criteria are presented in Table 6-1.
Risk Acceptance Criteria
Risk to road users (FAT/year)
Risk to rail passengers (FWSI/year)
Risk to rail employees (FWSI/year)
Risk to level crossing users (FWSI/year)
Risk to others (FWSI/year)
Risk to unauthorized persons on premises (FWSI/year)
Third party risk (FWSI/year)
Societal risk (FAT/year)
Risk of disruption to road (days/year)
Risk of disruption to rail (days/year)
Risk of simultaneous disruption (days/year)
Environmental risk (Euro/year)
Table 6-1 Risk acceptance criteria
2025
2045
0.223
0.174
-3
3.09·10
3.09·10
-3
1.09·10
-2
1.49·10
-2
-
-
-3
3.67·10
4.98·10
-3
0.136
0.185
To be updated autumn 2014
To be updated autumn 2014
6.5
6.5
0.6
0.6
0.6
0.6
-
-
The simultaneous disruption for road and rail is bounded by the acceptance criterion on the
disruption of the railway, which is estimated to 0.6 days.
6.2
Individual risk
The overall risk for the individual risk on road and rail is presented in Table 6-2.
Fatalities/FWSI
Fatalities road
FWSI rail passengers
FWSI rail employees
Table 6-2 Individual risk
2025
Per year
0.165
2.60·10
-3
8.81·10
-4
2045
Per year
0.131
2.78·10
-3
1.22·10
-3
Comparing the acceptance criteria presented in Table 6-1 with the estimated risk Table 6-2, it is
seen that the individual risk is acceptable for both road and rail.
Percentage of acceptance criteria
2025
2045
74.0%
84.2%
8.0%
75.1%
90.0%
8.2%
Year
Fatalities road
FWSI rail passengers
FWSI rail employees
Table 6-3 Calculated risk in percentages of the acceptance criteria
In Table 6-4
the calculated risk for “others” and the percentages of the acceptance criteria is
shown. It is seen that the risk
for “others” is acceptable.
“Other” FWSI
2025
2045
1.15∙10
1.72∙10
-5
-5
Percentage of acceptance criteria
0.31%
0.35%
Table 6-4 Calculated risk
for “others”
(fatalities per year) and percentages of the acceptance criteria
Operational Risk Analysis
Work in Progress
40/178
40
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
The contributors to fatalities on road for 2025 are shown in Table 6-5.
Fatalities on road
Ordinary road
Fire
Dangerous goods - road
Dangerous goods - rail
External events
Total
Fatalities per year in 2025
1.63∙10
-1
9.58∙10
-5
2.25∙10
-3
7.42∙10
-6
4.15∙10
-5
1.65∙10
-1
Percentage
98.55%
0.06%
1.36%
0.004%
0.03%
100%
Table 6-5 Contributors to fatalities per year on road in 2025
It is seen that ordinary road accidents constitute the most significant risk of fatalities on the road
with a minor contribution from dangerous goods. Fire and external events contribute very little to
the total number of fatalities.
The contributors to passenger fatalities on rail for 2025 are shown in Table 6-6.
Fatalities on rail
Ordinary rail
Fire
Dangerous goods - rail
Dangerous goods - road
External events
Total
Fatalities per year in 2025
1.74E∙10
-3
Percentage
93.70%
1.99%
0.05%
4.04%
0.22%
100%
3.69∙10
-5
9.82∙10
-7
7.51∙10
-5
4.01∙10
-6
1.86∙10
-3
Table 6-6 Contributors to passenger fatalities per year on rail in 2025
The contributors to employee fatalities on rail for 2025 are shown in Table 6-7.
Fatalities on rail
Ordinary rail
Fire
Dangerous goods - rail
Dangerous goods - road
External events
Total
Fatalities per year in 2025
6.24∙10
-4
-7
Percentage
99.09%
0.12%
0.02%
0.65%
0.12%
100%
7.76∙10
9.51∙10
-8
4.12∙10
-6
7.63∙10
-7
6.30∙10
-4
Table 6-7 Contributors to employee fatalities per year on rail in 2025
It is seen that ordinary rail accidents constitutes the most significant risk of fatalities on the rail,
with a smaller contribution from dangerous goods. Fire contributes about 1.99% of the fatalities.
Dangerous goods contribute about 4% in total, with the large part originating from dangerous
goods accidents in the road part.
In Table 6-8 it is shown how collisions, derailments and train-object collisions contribute to the
total risk on rail for ordinary rail accidents.
Fatalities on rail
Derailments
Trains collisions
Collision with objects
Ordinary rail
Fatalities per year in 2025
1.28∙10
-4
1.25∙10
-3
3.62∙10
-4
1.74∙10
-3
Percentage
7.34%
71.84%
20.82%
100%
Table 6-8 Contributors to fatalities per year on rail in 2025 for ordinary rail accidents
It is seen that 71.8% of the fatalities on rail are due to train collisions.
Operational Risk Analysis
Work in Progress
41/178
41
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
6.3
Societal risk
Section to be updated during autumn 2014.
6.4
Disruption risk
In the following section the disruption risk for road, rail and simultaneous disruption is presented.
6.4.1
Disruption road
The total number of disruption days per year for road and the contributing factors for 2025 are
seen in Table 6-9. It is seen that fire (road and rail) contributes most (40.4%), while external
events and ordinary road accidents also give significant contributions with 34% and 25.2%
respectively.
Disruption road
Ordinary road
Ordinary rail
Fire, road
Fire, rail
Dangerous goods
road
Dangerous goods
rail
External events
Total
Contribution
2.51∙10
-1
1.43∙10
-3
4.01∙10
-1
5.33∙10
-4
2.72∙10
-3
7.30∙10
-5
3.39∙10
-1
9.96∙10
-1
Percentage
25.20%
0.14%
40.30%
0.05%
0.27%
0.007%
34.03%
100%
Table 6-9 Total number of disruption days for road and the contributing factors (2025)
An FN-curve for the disruption of the road part for 2025 is shown in Figure 6-1.
Figure 6-1 FN-curve for the disruption of the road part (one tube only) (2025)
It is seen that there is no violation of the upper-limit, and hence the calculated risk of disruption
of the road part is considered acceptable.
It is highlighted that for most of the time where the road is disrupted, only one of the two road
tubes are disrupted. The time where both road tubes are disrupted constitutes about 20% of the
total disruption time.
Operational Risk Analysis
Work in Progress
42/178
42
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
6.4.2
Disruption rail
The total number of disruption days for rail in 2025 and the contributing factors are seen in Table
6-10. It is seen that the railway part is expected to be closed for about 0.495 days a year and
that fire contribute with 52.7% and that external events (due to flooding of substations)
contribute with 40.7%.
Disruption rail
Ordinary road
Ordinary rail
Fire, road
Fire, rail
Dangerous goods
road
Dangerous goods
rail
External events
Total
Contribution
0
2.78∙10
-3
5.04∙10
-2
1.01∙10
-1
1.71∙10
-3
3.03∙10
-4
3.39∙10
-1
4.95∙10
-1
Percentage
0%
0.56%
10.18%
20.40%
0.35%
0.06%
68.45%
100%
Table 6-10 Total number of disruption days for the rail and the contributing factors (2025)
An FN-curve for the disruption of the rail part in 2025 is shown in Figure 6-2.
Figure 6-2: FN-curve for the disruption of the rail part (only one rail tube)
It is seen that there is violations of the upper-limit. This clearly follows that the mean value (for
disrupting the railway) is larger than the acceptance criterion.
6.4.3
Simultaneous disruption of road and rail
Sections 6.4.1 and 6.4.2 presented the disruption of the road and rail respectively. Some of
these disruptions will happen simultaneously, such that both the road and rail part are closed at
the same time.
Operational Risk Analysis
Work in Progress
43/178
43
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Disruption
Disruption, road alone [days
per year]
Disruption, rail alone [days per
year]
Disruption, simultaneous [days
per year]
Table 6-11 Simultaneous disruption times
2025
0.60
0.10
0.39
2045
0.96
0.11
Acceptance Criteria
6.5
0.6
0.44
In Table 6-9 and Table 6-10 it is seen that the individual road and rail parts are disrupted about
0.996 and 0.495 days respectively days in 2025, and about 0.40 of a day simultaneously, in
2025.
An FN-curve for the simultaneous disruption is shown in Figure 6-3.
Figure 6-3: FN-curve for the simultaneous disruption of road and rail
It is seen that there is violations of the upper-limit. This clearly follows that the mean value (for
disrupting the railway) is larger than the acceptance criterion.
6.5
Total risk cost
In this section the total cost of all risk contributions are summarized.
Million Euros
Fatalities
Societal loss
Disruption, road alone
Disruption, rail alone
Disruption, simultaneous
Owner loss
Disruption, road alone
Disruption, rail alone
Disruption, simultaneous
Repair cost
Total
2025
0.521
0.991
0.061
0.922
0.338
0.013
0.260
0.152
3.258
2045
0.575
2.963
0.128
1.891
0.096
0.022
0.462
0.286
6.422
2025
16.0%
30.4%
1.9%
28.3%
10.4%
0.4%
8.0%
4.7%
100.0%
2045
9.0%
46.1%
2.0%
29.4%
1.5%
0.3%
7.2%
4.5%
100.0%
44/178
44
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Table 6-12 Total risk cost in million Euros
From Table 6-12 it is seen that the total risk cost is about
€3.26
million Euros in 2025
and €6.42
millions in 2045.
In Table 6-13
the societal cost and owners’ loss are amalgamated, and are graphically
represented in Figure 6-4.
Euro
Fatalities
Disruption, road alone
Disruption, rail alone
Disruption, simultaneous
Repair cost
Total
Table 6-13 Total costs in million Euros
2025
0.521
1.329
0.074
1.182
0.152
3.258
2045
0.575
3.058
0.150
2.352
0.286
6.422
2025
16.0%
40.8%
2.3%
36.3%
4.7%
100.0%
2045
9.0%
47.6%
2.3%
36.6%
4.5%
100.0%
Figure 6-4 Total risk cost distribution
From Figure 6-4 it is seen that most of the risk costs
about 80% - originate from disruption,
while repair costs and cost of fatalities costs are about 5% and 16% respectively.
Again it is underlined that the cost for disruption for road has been based on disruption of a
single road tube only. This is very conservative because a single road tube is still available in
most of the cases.
6.6
Impact of the dangerous goods restrictions on railway
The results presented in the previous sections do not take the restrictions in relation to
dangerous goods into account (see section 4.4.4.).
In order to clarify the impact of the DG restrictions the results with and without DG restrictions
are presented in Table 6-14.
Operational Risk Analysis
Work in Progress
45/178
45
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Fatalities on road
Ordinary road
Fire
Dangerous goods - road
Dangerous goods - rail
External events
Total
Fatalities on rail passengers
Ordinary rail
Collisions
Derailment
Collision with object
Fire
Dangerous goods - rail
Dangerous goods - road
External events
Total
Fatalities on rail employees
Ordinary rail
Collisions
Derailment
Collision with object
Fire
Dangerous goods - rail
Dangerous goods - road
External events
Total
Contribution
1.63∙10
-1
9.58∙10
-5
2.25∙10
-3
7.42∙10
-6
4.15∙10
-5
1.65∙10
-1
Contribution
1.74∙10
-3
1.25∙10
-3
1.28∙10
-4
3.62∙10
-4
3.69∙10
-5
7.05∙10
-7
7.51∙10
-5
4.01∙10
-6
1.86∙10
-3
Contribution
6.24∙10
-4
2.76∙10
-4
1.60∙10
-4
1.89∙10
-4
7.76∙10
-7
8.09∙10
-8
4.12∙10
-6
2.20∙10
-7
6.29∙10
-4
Contribution
1.63∙10
-1
9.58∙10
-5
2.25∙10
-3
5.13∙10
-6
4.15∙10
-5
1.65∙10
-1
Contribution
1.45∙10
-3
9.57∙10
-4
1.28∙10
-4
3.62∙10
-4
3.69∙10
-5
0
7.51∙10
-5
4.01∙10
-6
1.56∙10
-3
Contribution
5.53∙10
-4
2.05∙10
-4
1.60∙10
-4
1.89∙10
-4
7.76∙10
-7
3.83∙10
-8
4.12∙10
-6
2.20∙10
-7
5.58∙10
-4
Difference
0
0
0
2.29∙10
-6
0
2.29∙10
-6
Difference
2.93∙10
-4
2.93∙10
-4
0
0
0
7.05∙10
-7
0
0
2.94∙10
-4
Difference
7.10∙10
-5
7.10∙10
-5
0
0
0
4.25∙10
-8
0
0
7.10∙10
-5
Reduction
30.9%
0.001%
Reduction
16.8%
23.4%
100.0%
15.8%
Reduction
11.4%
25.8%
52.6%
11.3%
Table 6-14 Impact of dangerous goods restriction on road users, rail passengers and employees
The following can be concluded:
Impact from DG on rail on the road passengers is reduced with about 31%, however the
-6
reduction corresponds to only
2.29∙10
fatality per year
With the restriction no impact on railway passengers can be detected, which is a reduction of
7.05∙10
-7
. However, it is interesting that DG on road contribute with two orders of
magnitude more.
Due to the restrictions some collisions are avoided between DG trains and other trains. This
-4
reduces the FWSI-figure on railway passengers with
2.93∙10
and the FWSI-figure for
-5
railway employees with
7.10∙10
.
The absolute reduction directly related to the dangerous goods on rail for railway passengers
-7
is
7.05∙10
, corresponding to 0.04% of the total risk for this safety target
The absolute reduction directly related to the dangerous goods on rail for railway employees
-8
is
4.25∙10
, corresponding to 0.007% of the total risk for this safety target
The relative low impact on the railway passengers and railway employees indicates that
restriction to dangerous goods transportation in the railway tunnel do not have a significant
impact on the safety.
Operational Risk Analysis
Work in Progress
46/178
46
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
7.
REVISIONS
This issue (revision 6) of the Operational Risk Analysis (ORA) delivered in June 2014 is an update
of the earlier ORA report delivered in August 2013 (revision 5).
The previous versions are:
Revision
Revision
Revision
Revision
4,
3,
2,
1,
October 2012
January 2011
October 2010
June 2010
The revisions are described in detail in the following sections.
7.1
Revision 6
This update of the ORA contains the following larger changes:
The lengths for the enclosed tunnel and landsides for both road and rail are updated.
The traffic forecast is updated.
The dangerous goods forecast is updated.
The risk and acceptance criteria for the railway part are described for each common safety
target in accordance with CSM including dividing the individual risk for rail into passenger risk
and risk for employees, and all topics from TSI are covered in the ORA.
The risk model is updated with a model for how often a dangerous goods wagon on a freight
train will be involved in an accident.
Instead of having one number for fatalities on rail for the catastrophic scenarios a distribution
is made including the probability of having different combinations of train in the same tube as
the accident and different combinations of train in the other tube.
The risk model is setup with the restrictions for dangerous goods on the railway. The
restrictions can be turned on/off separately to see the effect of each of the restrictions.
Collisions with objects are included in the risk model.
Fire detection is no longer part of the risk model in the railway part.
The mechanical effects of the accidents on rail are included in the dangerous goods accidents.
Individual risk
The above changes (and more minor changes) lead to changes in the individual risk on road and
rail as shown in Table 7-2 and Table 7-2.
2025
Fraction
of
acceptab
le risk
74.0%
84.2%
8.0%
0.3%
2045
Fraction
of
accep-
table
risk
75.1%
90.0%
8.2%
0.5%
Road fatalities
Rail - FWSI
passengers
Rail - FWSI
employees
Individual
Risk
0.17
2.60∙10
-3
8.81∙10
-4
1.15∙10
-5
Acceptable
Risk
0.22
0.0031
0.0109
0.0035
Individu
al Risk
0.13
2.78∙10
-3
1.22∙10
-3
1.72∙10
-5
Accepta
ble Risk
0.17
0.00309
0.01486
0.00346
Rail - FWSI –
Others
Table 7-1 Individual risk in revision 6.
Operational Risk Analysis
Work in Progress
47/178
47
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
2025
Result
fatalities
per billion
person
passages
5.0
3.5
2045
Result
fatalities per
billion
person
passages
2.6
3.5
Acceptance criteria
Acceptance criteria
Revision 5
Road
Rail
20.92
7.54
10.46
8.35
Table 7-2 Risk to individual life safety revision 5
The numbers in Table 7-1 and Table 7-2 are not directly comparable due to several things. First
of all it is decided to communicate the risk in FWSI per year (instead of per passage) and the risk
is furthermore split into different safety targets (passengers, employees and others).
Total cost
The changes lead to changes in the total costs for road and rail as shown in Table 7-3.
2025
Fatalities
Disruption, road alone
Revision 6
Disruption, rail alone
Disruption, simultaneous
Repair cost
Total
Fatalities
Disruption, road alone
Revision 5
Disruption, rail alone
Disruption, simultaneous
Repair cost
Total
0.521
1.329
0.074
1.182
0.152
3.258
0.162
0.881
0.319
1.191
0.187
2.740
2045
0.575
3.058
0.150
2.352
0.286
6.422
0.189
2.801
0.684
2.358
0.324
6.356
Table 7-3 Comparison of total costs in million Euros for revision 6 and 5
Disruption
Table 7-4 presents a comparison of the disruption risk for the years 2018/2025 and 2038/2045
for revision 5 and 4.
2025
Accepta
nce
criteria
Disruption
days per
year
Accepta
nce
criteria
2045
Disruption
days per
year
0.96
0.11
0.44
1.00
0.52
0.44
Disruption, road alone
6.50
0.60
6.50
[days per year]
Disruption, rail alone
Revision 6
0.10
[days per year]
0.6
0.6
Disruption, simultaneous
0.39
[days per year]
Disruption, road alone
6.50
0.63
6.50
[days per year]
Disruption, rail alone
Revision 5
0.44
[days per year]
0.6
0.6
Disruption, simultaneous
0.40
[days per year]
Table 7-4 Comparison of the disruption risk measured in days for revision 6 and 5
Operational Risk Analysis
Work in Progress
48/178
48
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
7.2
Revision 5
This update of the ORA contains the following changes:
The reference years are changed to 2025 and 2045 on request from Femern A/S to ensure
better alignment with design reports.
The risk acceptance criterion for rail is based on the common safety targets (CST) which
contains national reference values (NRV). The NRV for passengers is added a contribution
from freight train drivers to include these in the analysis.
The suppression system is no longer a part of the railway design, and this is now reflected
the calculations.
In all tables with fatalities in the railway part, an extra column has been inserted with the
corresponding FWSI results.
New data material from the European Railway Accident Information Links is used as basis for
the derailment and collision frequencies.
The forecast for dangerous goods on railway is updated to contain a small amount of
explosives.
Changes due to the CSM-RA assessment Phase I of RINA S.P.A./SINTEF Added general
sections for improving the readability in relation to the railway part.
An appendix is added to the accident frequencies report ref. [28] containing description of
safety related functions and probability of failure on demand.
The data for the traffic forecast used in ORA revision 5 and revision 4 is presented in Table 7-5.
Revision 4
2018
2038
9856
8325
2497
5828
1395
136
2.39
1.2
2.9
1
35
15.5
Revision 4
2018
2038
49.0
40.0
95
3
17.7
30
113
40
16113
12865
3859
9006
3057
191
Revision 5
2025
2045
11723
9819
2946
6873
1751
153
2.4
1.2
2.9
1.0
35.0
15.5
Revision 5
2025
2045
78
40
95
3
17.7
30
96
40
19288
15221
4566
10655
3851
215
Road Traffic
Annual average daily traffic
(AADT) [veh/day]
Cars
Cars (prof. activities) 30%
Cars (private use) 70%
Lorries
Coaches
Average person per vehicle
Cars (prof. activities)
Cars (private use)
Lorries
Coaches
Average load per lorry in tons
Rail Traffic
Average number of freight
trains per day
Average number of passenger
trains per day
Passengers per passenger train
Operators/workers per trains
Average load per freight wagon
(ton)
Number of wagons per freight
train
Table 7-5 Traffic data for ORA revision 5 and revision 4
The change in traffic volume affects all results since the number of accidents per year is
calculated based on number of vehicle or rolling stock kilometres in the tunnel per year.
Individual risk
The above changes lead to changes in the individual risk on road and rail as shown in Table 7-6.
Operational Risk Analysis
Work in Progress
49/178
49
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
2018/2025
Result
Acceptance
fatalities per
criteria
billion person
passages
Revision 5
(2025 and
2045)
Revision 4
(2018 and
2038)
Road
Rail
Road
Rail
20.92
7.54
26.67
1.95
5.0
3.5
18.8
2.4
2038/2045
Result
Acceptance
fatalities per
criteria
billion person
passages
10.46
8.35
13.34
1.95
2.6
3.5
5.0
2.8
Table 7-6 Comparison of risk to individual life safety between results in revision 5 and 4
Total cost
The changes lead to changes in the total costs for road and rail as shown in Table 7-7.
2018/2025
Fatalities
Disruption, road alone
Revision 5
(2025 and 2045)
Disruption, rail alone
Disruption, simultaneous
Repair cost
Total
Fatalities
Disruption, road alone
Revision 4
(2018 and 2038)
Disruption, rail alone
Disruption, simultaneous
Repair cost
Total
0.162
0.881
0.319
1.191
0.187
2.740
0.564
1.196
0.223
1.163
0.143
3.290
2038/2045
0.189
2.801
0.684
2.358
0.324
6.356
0.332
2.648
0.795
2.267
0.292
6.333
Table 7-7 Comparison of total costs in million Euros for revision 5 and 4
Disruption
Table 7-8 presents a comparison of the disruption risk for the years 2018/2025 and 2038/2045
for revision 5 and 4.
2018/2025
Accepta
nce
criteria
Revision 5
(2025 and
2045)
Disruption, road alone
[days per year]
Disruption, rail alone
[days per year]
Disruption, simultaneous
[days per year]
Disruption, road alone
[days per year]
Disruption, rail alone
[days per year]
Disruption, simultaneous
[days per year]
6.50
Disruption
days per
year
0.63
0.44
0.6
0.40
6.50
0.54
0.31
0.6
0.39
0.6
0.42
6.50
0.6
0.44
0.70
0.6
2038/2045
Accepta
nce
criteria
6.50
Disruption
days per
year
1.00
0.52
Revision 4
(2018 and
2038)
Table 7-8 Comparison of the disruption risk measured in days for revision 5 and 4
Operational Risk Analysis
Work in Progress
50/178
50
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
7.3
Revision 4
This update of the ORA is based on a request from Femern A/S to ensure that the Operational
Risk Analysis incorporates the changes made in the design since revision 3 of the ORA was made
in February 2011. These changes include changes in the length of the tunnel. The changes have
affected basically all the results; on road in relation to individual risk (and subsequently societal
risk), on individual risk on railway and also the risk of disruption.
The railway update concerns a new acceptance criteria based on National Reference Values see
ref. [22], and update of a range of datasets. The latter include newer accidents data for ordinary
rail accidents, time schedules for the train traffic and actual distribution of passengers on
passenger trains. Furthermore, statistics on fires for different types of trains have been carried
out. Finally, the traffic work of trains has been updated.
In the two previous revisions of the ORA, there was a high focus on aligning the risk analyses for
the bridge and the tunnel solutions, and as a result of this, the landsides where excluded from
the scope. The cross-overs on the landsides are taken into account in the present revision.
New acceptance criteria for disruption on the railway have been adopted from RAM work, ref.
[24].
The location of substations and control-center have changed from on top of the tunnel portal to
besides the tunnel, this has implied that the risk of flooding of substations and control-center has
increased. This is analysed in the present revision.
A new hazard has been taken into account, namely damage to persons due to train in motion.
Furthermore, updates have been carried out regarding sunken ships on runnel roof, grounding
ships on tunnel roof and dropped and dragged anchor.
The change in frequency and consequences for road accidents leads to changes in the individual
risk on road as shown in Table 7-9.
2018
Acceptance
criteria
Revision 4
Revision 3
Road
Rail
Road
Rail
26.67
1.95
18.14
3.06
Result
fatalities per
billion person
passages
18.8
2.4
13.30
2.26
Acceptance
criteria
13.34
1.95
9.07
3.06
2038
Result
fatalities per
billion person
passages
5.0
2.8
7.01
2.84
Table 7-9 Comparison of risk to individual life safety between results in revision 4 and 3
The change in frequency for road accidents leads to changes in the total costs for road as shown
in Table 7-10.
Operational Risk Analysis
Work in Progress
51/178
51
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
2018
Fatalities
Disruption, road alone
Revision 4
Disruption, rail alone
Disruption, simultaneous
Repair cost
Total
Fatalities
Disruption, road alone
Revision 3
Disruption, rail alone
Disruption, simultaneous
Repair cost
Total
0.564
1.196
0.223
1.163
0.143
3.290
0.324
0.74
0.067
0.198
0.082
1.411
2038
0.332
2.648
0.795
2.267
0.292
6.333
0.374
1.847
0.24
0.606
0.161
3.228
Table 7-10 Comparison of total costs in million Euros for revision 4 and 3
Table 7-11 presents a comparison of the disruption risk for the years 2018 and 2038 for revision
4 and 3.
2018
Acceptance
criteria
Disruption, road alone
[days per year]
Disruption, rail alone
[days per year]
Disruption, simultaneous
[days per year]
Disruption, road alone
[days per year]
Disruption, rail alone
[days per year]
Disruption, simultaneous
[days per year]
6.50
Disruption
days per
year
0.54
0.31
0.6
0.39
6.5
6.5
1.3
0.33
0.09
0.06
6.5
6.5
1.3
0.6
0.42
0.54
0.18
0.11
2038
Acceptance
criteria
6.50
Disruption
days per
year
0.70
0.6
Revision
4
Revision
3
Table 7-11 Comparison of the disruption risk measured in days for revision 4 and 3
7.4
Revision 3
This update of the ORA is based on a request from Femern A/S to ensure as much as possible a
consistent approach between the bridge and tunnel solutions. The changes have affected the
results on road in relation to individual risk (and subsequently societal risk) and also the risk of
disruption.
The update concerns the calculations based on statistical data from the Danish Road Directorate
(VIS-database). The VIS-database has been used to calculate the percentage of the accidents on
Danish motorways is relevant for the Fehmarnbelt Fixed Link. The same method has previously
been used in revision 2, however in revision 3 a more conservative approach has been used, and
the accidents in the database has been studied more in detail.
The change in frequency and consequences for road accidents leads to changes in the individual
risk on road as shown in Table 7-12.
Operational Risk Analysis
Work in Progress
52/178
52
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
2018
Acceptance
criteria
Revision 3
Revision 2
Road
Rail
Road
Rail
18.14
3.06
18.14
3.06
Result
fatalities per
billion person
passages
13.30
2.26
10.7
2.26
Acceptance
criteria
9.07
3.06
9.07
3.06
2038
Result
fatalities per
billion person
passages
7.01
2.84
5.6
2.84
Table 7-12 Comparison of risk to individual life safety between results in revision 3 and 2
The change in frequency for road accidents leads to changes in the total costs for road as shown
in Table 7-13.
2018
2038
Fatalities
Disruption, road alone
Revision 3
Disruption, rail alone
Disruption, simultaneous
Repair cost
Total
Fatalities
Disruption, road alone
Revision 2
Disruption, rail alone
Disruption, simultaneous
Repair cost
Total
0.402
0.731
0.067
0.198
0.082
1.479
0.324
0.74
0.067
0.198
0.082
1.411
0.463
1.832
0.240
0.605
0.161
3.301
0.374
1.847
0.24
0.606
0.161
3.228
Table 7-13 Comparison of total costs in million Euros for Revision 3 and 2
Table 7-14 presents a comparison of the disruption risk for the years 2018 and 2038 for revision
3 and 2.
2018
Disrupt
ion
days
per
year
0.33
0.09
0.06
0.34
0.09
0.06
2038
Disrupt
ion
days
per
year
0.54
0.18
0.11
0.55
0.18
0.11
Acceptance
criteria
Disruption, road alone [days
per year]
Disruption, rail alone [days
per year]
Disruption, simultaneous
[days per year]
Disruption, road alone [days
per year]
Disruption, rail alone [days
per year]
Disruption, simultaneous
[days per year]
6.5
6.5
1.3
6.5
6.5
1.3
Acceptance
criteria
6.5
6.5
1.3
6.5
6.5
1.3
Revisio
n3
Revisio
n2
Table 7-14 Comparison of the disruption risk measured in days for Revision 3 and 2
Operational Risk Analysis
Work in Progress
53/178
53
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
7.5
Revision 2
This update of the ORA is based on a request from Femern A/S to ensure as much as possible a
consistent approach between the bridge and tunnel solutions. The changes have affected the
results both for road and rail in relation to individual risk (and subsequently societal risk) and
also the risk of disruption. The update consists of two parts:
Update of the fatalities per accident for road accidents
Update of the tunnel length
The fatality per accident has been updated based on a benchmark suggested by Femern A/S,
which have affected the results for fatalities on road, see Table 7-15. In revision 1 the number of
fatalities per kilometre in 2018 and 2038 was calculated, based on a decreasing statistical trend.
In revision 1 the half-life period was estimated to be 9.5 years. Femern A/S has requested that a
more conservative approach is used and that the half-life period should be 20 years. Because of
the more conservative approach the acceptance criteria between rev 1 and 2 have been
increased, as shown in Table 7-15.
The tunnel length has changed between revisions 1 and 2 of the ORA from 25.4 km to 18.14 km.
The scope is now identical in both the bridge and tunnel risk analyses enabling a more direct
comparison to be made. The new scope includes the tunnel structure only. However, it should be
noted that the risk figures should now only be used comparatively as they no longer represent
the absolute risk. The absolute risk would incorporate the entire tunnel structure in addition to
the landside road and railway to the hinterland connections. The change in length leads to
changes in the acceptance criteria for individual risk on road and rail as shown in Table 7-15.
2018
Acceptance
criteria
Revision 2
Revision 1
Road
Rail
Road
Rail
18.14
3.82
9.70
4.40
Result
fatalities per
billion person
passages
10.7
2.26
7.90
3.70
Acceptance
criteria
9.07
3.89
2.30
4.40
2038
Result
fatalities per
billion person
passages
5.6
2.84
1.90
4.00
Table 7-15 Comparison of risk to individual life safety between results in revision 2 and 1
Table 7-16 present a comparison of the results for the total costs for years 2018 and 2038 for
both revisions 1 and revision 2.
2018
Fatalities
Disruption, road alone
Revision 2
Disruption, rail alone
Disruption, simultaneous
Repair cost
Total
Fatalities
Disruption, road alone
Revision 1
Disruption, rail alone
Disruption, simultaneous
Repair cost
Total
0.324
0.740
0.067
0.198
0.082
1.411
0.248
1.051
1.459
0.199
0.396
3.354
2038
0.374
1.847
0.240
0.606
0.161
3.227
0.146
5.373
5.202
0.601
0.828
12.151
Table 7-16 Comparison of total costs in million Euros between results in Revision 2 and 1
Operational Risk Analysis
Work in Progress
54/178
54
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Table 7-17 present a comparison of the disruption risk for years 2018 and 2038 for both revision
1 and revision 2.
2018
Disrupt
ion
days
per
year
0.34
0.09
0.06
0.48
2.00
0.06
2038
Disrupt
ion
days
per
year
0.55
0.18
0.11
0.67
3.96
0.11
Acceptance
criteria
Disruption, road alone [days
per year]
Disruption, rail alone [days
per year]
Disruption, simultaneous
[days per year]
Disruption, road alone [days
per year]
Disruption, rail alone [days
per year]
Disruption, simultaneous
[days per year]
6.5
6.5
1.3
6.5
6.5
1.3
Acceptance
criteria
6.5
6.5
1.3
6.5
6.5
1.3
Revisio
n2
Revisio
n1
Table 7-17 Comparison of disruption risk between results in Revision 1 and 2
The numbers from revision 1 is used if not updated in revision 2.
7.6
Revision 1
The first update of the ORA was necessary as a result of changes in design parameters and to
ensure as much as possible a consistent approach between the bridge and tunnel solutions.
The following inputs to the calculations have been changed between revisions 0 and 1 of this
report:
Road accident frequency
Road accident fatalities
Road fire frequency
Road fire fatalities
Tunnel length
Traffic data
The changes have affected the results both for road and rail in relation to individual risk (and
subsequently societal risk) and also the risk of disruption. Table 7-18 present a comparison of the
results for years 2018 and 2038 for both revision 0 and revision 1.
2018
Fatalities per
Acceptance
billion
criteria
passages
9.7
7.9
4.4
3.7
26.5
19.9
3.8
2.76
2038
Fatalities per
Acceptance
billion
criteria
passages
2.3
1.9
4.4
4.0
26.5
20.7
3.8
3.2
Revision 1
Revision 0
Road
Rail
Road
Rail
Table 7-18 Comparison of risk to individual life safety between results in Revision 1 and 0
Note that in regard to individual risk to life safety, in the year 2038 it is shown to be safer to
travel by car than by train. Typically this is not the case however the reason is that in revision 1
new statistical data from the Danish Road Directorate is used for accident frequency and number
of fatalities on the road (see section 7.6.1 and section 7.6.2). The frequency of accidents and
fatalities is considered to decrease over time while the accident frequency on rail is assumed to
Operational Risk Analysis
Work in Progress
55/178
55
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
be constant. It is likely that train safety will also improve over time, however, no statistical
trends have been found in the available data for rail and cannot therefore be included in this
report.
Table 7-19 presents a comparison of the results for the total costs for years 2018 and 2038 for
both revision 0 and revision 1.
2018
0.248
1.051
1.459
0.199
0.396
3.354
0.588
3.011
1.226
0.562
0.648
6.035
2038
0.146
5.373
5.202
0.601
0.828
12.15
1.168
9.478
3.810
1.651
1.177
17.284
Revision 1
Revision 0
Fatalities
Disruption, road alone
Disruption, rail alone
Disruption, simultaneous
Repair cost
Total
Fatalities
Disruption, road alone
Disruption, rail alone
Disruption, simultaneous
Repair cost
Total
Table 7-19 Comparison of total costs in million Euros between results in Revision 1 and 0
Table 7-20 present a comparison of the disruption risk for years 2018 and 2038 for both revision
0 and revision 1.
2018
Acceptance
Disruption
criteria
days
Disruption, road
alone [days]
Disruption, rail alone
[days]
Disruption,
simultaneous [days]
Disruption, road
alone [days]
Disruption, rail alone
[days]
Disruption,
simultaneous [days]
6.5
6.5
1.3
6.5
6.5
1.3
0.48
2.00
0.06
1.38
1.681
0.183
2038
Acceptance
Disruption
criteria
days
6.5
6.5
1.3
6.5
6.5
1.3
0.67
3.96
0.11
2.30
2.899
0.300
Revision 1
Revision 0
Table 7-20 Comparison of disruption risk between results in Revision 1 and 0
7.6.1
Road accident frequency
In the revision 0 of the Conceptual Design Operational Risk Analysis (ORA) the traffic accident
frequency and the traffic accident fatalities were assessed based on statistical data from 2001 to
2007. It was assumed that there would be the same frequency of traffic accidents per driven km
in 2018 and 2038 as there was on average between 2001 and 2007. It was also assumed that
the number of fatalities per accident would be the same in 2018 and 2038 as on average
between 2001 and 2007.
These assumptions are however considered to be conservative given that there are strong
indicators in the statistics that point to a decrease both in accident frequencies and in fatalities
on road. In revision 1 of the ORA the development of traffic accident frequencies and
consequences for the year 2018 and 2038 are estimated based on statistical trends.
The statistics indicate, contrary to the assumption of the accident frequency and fatalities per
accident remaining constant, that there will be a decrease in accident frequencies and
consequences between 2018 and 2038. In Table 7-21 the values from ORA revision 0 are
Operational Risk Analysis
Work in Progress
56/178
56
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
presented together with extrapolated values for motorways based on the statistical data from the
Danish Road Directorate as used in revision 1.
Total number of accidents per year
Revision 1
Revision 0
2018
3.116
4.270
2038
2.199
6.140
Table 7-21 Accident frequency per year for ORA revision 1 and 0 for the Fehmarnbelt Fixed link
This change in input affects a number of the results including individual risk to life safety,
disruption and societal risk.
7.6.2
Road accident fatalities
In a similar manner to which the accident frequency is extrapolated the average number of
fatalities per year is also expected to decrease again based on the statistical data from the
Danish Road Directorate. Table 7-22 presents the average number of fatalities used in revision 0
and the revised number of fatalities per accident, based on statistical trends, which have been
used in revision 1.
Average number of fatalities per accident
Revision 1
Revision 0
Table 7-22 Fatalities per accident in revision 1 and 0
2018
0.025
0.0451
2038
0.013
This change in input affects individual risk to life safety for road users.
7.6.3
Road fire frequency
The fire frequencies used for the road in the ORA have been updated in light of more recent
statistics. The fire frequencies used in revision 0 were based on data from PIARC. PIARC data for
the frequency of fires in road tunnels is based on statistics from years 1968 to 1992 and is
therefore considered to be conservative. In revision 1, Danish statistics for road fires have been
used and are considered to be more appropriate in this situation. Firstly, as a result of
representing the vehicles typically expected to use the tunnel and secondly since they are
considered to be more up to date.
Revision 1
Car fire frequency
HGV fire frequency
Bus fire frequency
DGV fire frequency
6.75∙10
-9
1.39∙10
-8
1.39∙10
-8
1.03∙10
-8
Revision 0
1.50∙10
-8
3.08∙10
-8
3.08∙10
-8
2.30∙10
-8
Table 7-23 Fire frequency per year and vehicle km for ORA revision 1 and 0 for the Fehmarnbelt Fixed
link
This change in input affects the individual risk to life safety in addition to the disruption for both
the road and rail tunnels.
7.6.4
Road fire fatalities
In line with revised modelling of the fire scenarios in the road tunnel the fatalities expected given
specific scenarios have been made more conservative. The number of fire scenarios in which
fatalities are expected has increased from four to nine. These scenarios are all considered high
challenge fires and extreme events in that they have very long return period. Thus, although the
increase to life safety increases, the overall number of fatalities per year does not increase
significantly due to the low likelihood of these scenarios occurring.
7.6.5
Tunnel length
The tunnel length has been changed during the conceptual design phase. The lengths of road and
rail ramps on the landside areas have also changed.
Operational Risk Analysis
Work in Progress
57/178
57
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
In revision 0 of the ORA the road link was taken as 18,690m while the rail link was taken as
19,529m
In revision 1 of the ORA the road link is 25,430m and the rail link is 26,055m.
As the accident frequency is per km this increased length leads to increased accidents on both
road and rail and therefore impacts on all aspects of the ORA.
7.6.6
Traffic data
The traffic data has been changed on request from Femern A/S. The data used in ORA revision 0
and revision 1 is presented in Table 7-24.
Revision 0
2018
2038
9,639
8,152
2,446
5,707
1,352
134
13,856
11,190
3,357
7,833
2,492
173
Revision 1
2018
2038
9,856
8,325
2,497
5,828
1,395
136
16,113
1,2865
3,859
9,006
3,057
191
Road Traffic
Annual average daily traffic
(AADT) [veh/day]
Cars
Cars (prof. activities) 30%
Cars (private use) 70%
Lorries
Coaches
Average person per vehicle
Cars (prof. activities)
Cars (private use)
Lorries
Coaches
Average load per lorry in tons
Rail Traffic
Average number of freight
trains per day
Average number of passenger
trains per day
Passengers per passenger train
Average number of
operators/workers on trains
Average load per freight wagon
Number of wagons per freight
train
2.4
1.2
2.9
1.0
35
15.9
Revision 0
2018
2038
47
40
95
3
17.0
30
93
42
2.4
1.2
2.9
1.0
35.0
15.9
Revision 1
2018
2038
49.0
40.0
95
3
17.7
30
113
40
Table 7-24 Traffic data for ORA revision 0 and revision 1
The change in traffic volume affects all results since the number of accidents per year is
calculated based on number of vehicle or rolling stock kilometres in the tunnel per year.
Operational Risk Analysis
Work in Progress
58/178
58
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
8.
FUTURE WORK
In the next revision ORA 2014 (Autumn) updates will at least be made on the following topics:
Dragged and dropped anchor; at the time detailed studies are made for dragged and dropped
anchor. These studies will be included in the ORA.
Grounding ships; at the time detailed studies are made for grounding ships. These studies will
be included in the ORA.
A more detailed study of the disruption of the road and rail, focus on updates in design
regarding location of control centre and substation.
The evacuation model on road and rail relative to the fire consequence calculations will be
looked over and updated if it is found necessarily.
A more detailed study at the consequences at the landsides (especially at Lolland as the safety
zone is shorter than the Femern side). This study will include a more thorough description of
the landsides with focus on safety.
The costs of fatalities etc. will be updated to 2014 prices (instead of the present 2009 prices)
Include new data from DHI for wave heights and sea level.
Include results from the risk study of laybys.
Update of the Operational Risk Management Plan
Possible cost benefit analysis of FFFS (fixed fire fighting system)
Operational Risk Analysis
Work in Progress
59/178
59
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
9.
APPENDIX A
RELEASE OF DANGEROUS GOODS
GENERAL ASSUMPTIONS
In order to access the consequences in accidents where dangerous goods are involved, some
assumptions have been made, e.g., regarding size of releases, and toxicity limits for the selected
substances.
The assumptions are all related to the chosen scenarios involving dangerous goods, which are the
following:
Ammonia release
Chlorine release
Flammable liquids
LPG
Explosives
Acids and bases (corrosives)
9.1
Assumptions
General assumptions made:
The upper limit for the longitudinal tunnel ventilation is an air velocity of 10 m/s.
The critical velocity in terms of smoke ventilation is set to 3.2 m/s
for a 200 MW fire scenario, ref. [16].
The CFD-model includes: 2 groups of jet fans with each 4 parallel jet fans
Internal diameter 1250 mm
Jet velocity: 35 m/s (max)
Thrust pressure: 1600 N
Length of jet fan: 6 meter
Start up time: 60 sec.
Figure 9-1: Location of jet fans used in the CFD-modelling of releases in road part
9.1.1
Release sizes
In the consequence modelling different sizes of release have been modelled; namely small,
medium and large. In this section is described how “small”, “medium” and “large” have been
interpreted. The flow rates are calculated using QRA Pro, ref. [17].
The flow rates for ammonia/chlorine are presented in Table 9-1, and for LPG in Table 9-2.
Operational Risk Analysis
Work in Progress
60/178
60
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Release size
Small
Medium
Large
Storage pressure
80 bar
100 bar
80 bar
100 bar
80 bar
100 bar
Hole size
(diameter)
0.1”
0.1”
1”
1”
10”
10”
Calculated mass flow rate
0.308 kg/s
0.345 kg/s
30.8 kg/s
34.5 kg/s
3080 kg/s
3450 kg/s
Table 9-1 Representative release sizes of ammonia and chlorine and calculated mass flow rates
Release size
Small
Medium
Large
Storage pressure
80 bar
100 bar
80 bar
100 bar
80 bar
100 bar
Hole size
(diameter)
0.1”
0.1”
1”
1”
10”
10”
Calculated mass flow rate
0.288 kg/s
0.322 kg/s
28.8 kg/s
32.2 kg/s
2880 kg/s
3220 kg/s
Table 9-2 Representative release sizes of LPG and calculated mass flow rates
From Table 9-1 and Table 9-2 it is seen that the difference in mass flow rates between ammonia,
chlorine and LPG do not differ significantly, hence for all three substances the values presented in
Table 9-3 have been used in modelling.
Release size
Small
Medium
Large
Storage pressure
80 bar
80 bar
80 bar
Hole size
(diameter)
0.1”
1”
10”
Calculated mass flow rate
0.288 kg/s
28.8 kg/s
2880 kg/s
Table 9-3 Mass flow rates of ammonia, chlorine and LPG used in the CFD-modelling
9.1.2
Location of source of release
Some assumptions regarding the source to the release, namely:
Release source is the back-end of truck and cover the whole area of the back face of the
truck, see Figure 9-2.
Only diffusive leaks have been analysed
Jet release is assumed to be converted into diffusive leak due to blockage
Figure 9-2: Location of the source to the release of dangerous goods
Operational Risk Analysis
Work in Progress
61/178
61
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
9.1.3
Assessment of impact from toxic release
A number of toxic materials will be transported on the Fehmarnbelt Fixed Link. Following an
accident with a truck or a freight train transporting dangerous goods, there is a possibility for a
release of toxic materials. In this assessment ammonia and chlorine have been selected as
representative materials, why these two materials have been investigated. The release of toxic
materials will have no influence on the structure, but could have serious consequences for the
users. A typical accident in the road tube would be a truck accident where the truck will block the
traffic and traffic will queue up behind the truck. The vehicles in front of the accident are in these
circumstances assumed to drive out of the tunnel.
9.1.3.1
Individual risk
The consequence assessment for toxic releases used in this assessment is based on dispersion
calculations in combination with computational-fluid-dynamics (CFD)-modelling and probit
functions. The probit function predicts human impact in terms of the probability of fatalities
given a certain concentration and a certain time of exposure.
9.1.3.2
Dispersion calculations and CFD modelling
CFD-modelling has been carried out for representative substances. This includes dispersion
analyses of chlorine and ammonia. The consequences of selected release sizes (see section
9.1.1) are based on the results from dispersion calculations. The dispersion calculations are
computed by means of the air-concentrations at given locations of the given substances in the
tubes.
The results of the modelling are presented in ref. [3].
9.1.3.3
Probit and LC50
The individual risk in terms of a probability of fatalities is modelled with a probit function,
reflecting the toxic dose, i.e. exposed concentration and time. The dispersion modelling is linked
to the probit function by determining the size of a cloud giving a 50% probability of fatality at the
exposure time given by the size of the cloud or the release duration, or both. The probits used
are those recommended by DNV Technica, ref. [18]. A probit function is material/substance
dependent and it is expressed as:
Pr
�½
a
b
ln(
C
n
t
)
Where
Pr
is the probit value for death
C
is the concentration of toxic material ppm
a, b
and
n
are material constants
t
is the time of exposure, minutes
The probit value is transferred to a probability of fatalities through a normal distribution. If the
concentration varies during the time of exposure, the concentration should be expressed as an
integral of time. In this assessment it is assumed that the concentration of exposure is
approximately time independent. The human impact is described in terms of a 50% fatality,
which is a common means to determine the number of people affected by a given incident within
a uniform population, e.g. a car queue in the tunnel. The 50% limit is used as it is a measure of
the average fatal dose. Weaker individuals being beyond the envelope may be among the
casualties while stronger individuals within will survive, i.e. the 50% fatality criterion is used to
predict a 100% fatality level.
The deadly concentrations can be calculated by means of the formula below:
Operational Risk Analysis
Work in Progress
62/178
62
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
LC50 after t min. exposure =
p
a

exp

b

t
1
b
9.1.4
t: time in minutes
p = Pr(50%) =5
Corrosive release
A corrosive substance is one that will destroy or irreversibly damage another substance with
which it comes into contact. The main hazards to people include damage to the eyes, the skin,
and the tissue under the skin; inhalation or ingestion of a corrosive substance can damage the
respiratory and gastrointestinal tracts. Exposure results in chemical burn. The most common
strong acids are sulfuric acid, nitric acid and hydrochloric acid (H
2
SO
4
, HNO
3
and HCl,
respectively).
9.1.4.1
Individual risk
The human impact of a corrosive release inside the tunnel will be dependent of the released
material and the time for exposure although people may be seriously injured by the liquid itself
or fumes due to reactions. The likelihood of fatalities is low. The percentage of fatalities due to an
accident with corrosive release is therefore assumed to be the same as for ordinary rail accidents
involving freight trains, described in section 4.1.2.1.
9.1.4.2
Disruption
Corrosive releases may be releases of typically acids or bases. Corrosive materials are normally
transported in thin walled tanks on trucks or on railway. The capacity of the drainage system will
affect the impact of a release. Two sub sumps in the road tubes will have sufficient volume to
collect the contents of a tank truck (30 m
3
). Two sub sumps in the rail tubes will have sufficient
volume to collect the contents of one tank wagon (80 m
3
). The sumps will be emptied with a
tanker. Assuming that an available tanker is one hour away and it will take 15 minutes to empty
the sumps and another 15 minutes to make the dissention to open the tunnel again.
9.1.5
Ammonia release
Ammonia is a colourless gas with a characteristic pungent smell. It is lighter than air, its density
being 0.589 times that of air. It is easily liquefied due to the strong hydrogen bonding between
molecules. Ammonia does not burn readily or sustain combustion, except under narrow fuel-to-
air mixtures of 15-25% air. Anhydrous ammonia is classified as toxic and inhalation of
concentrated gas can be lethal.
9.1.5.1.1
Individual risk
The consequence for individuals is assessed for release of ammonia based on CFD-modelling and
probit functions. The result is presented in the following section.
9.1.5.2
CFD calculations
CFD-modelling has been carried out for two scenarios for ammonia:
Small release
Medium release
The release sizes used in the modelling are defined in Table 9-3. The small release gives a
concentration below 4.200 ppm. The small release scenario does not lead to a critical situation,
not even for the driver. Hence, no fatalities are expected in this scenario.
Operational Risk Analysis
Work in Progress
63/178
63
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Figure 9-3 Result from CFD calculations for small release of ammonia
The medium release scenario leads to a concentration of 40.000 ppm which is a critical situation
for the people in the tunnel. The number of fatalities depends on the number of people in the
tunnel following a release.
Figure 9-4 Result from CFD calculations for medium release of ammonia
Since the medium release gives a concentration high enough to create a critical situation, CFD
modelling has not been performed for large releases. Assumptions of the concentrations for a
large release have been made based on the medium release.
Operational Risk Analysis
Work in Progress
64/178
64
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
9.1.5.3
Probit and LC50
The most severe consequences from an ammonia release will origin from ammonias toxicity; the
deadly concentrations are given below:
a: -15.8
b: 1
n: 2.0
An example is LC50 with an exposure time of 10 minutes given Pr(50%) = 5 and an ammonia
gas intensity of 0.69 kg/m
3
.
LC50 after 30 min. exposure:
5
15.8
 
exp

1

6000
mg
/
m
3
8700
ppm
30
1
2
In Table 9-4 LC50 for different exposure time is presented. Exposure times below 5 minutes
contain large uncertainties.
LC50
Exposure time (minutes)
�½
1
5
15
30
60
mg/m
46471
32860
14695
8484
5999
4242
3
Ppm
64542
45638
20410
11784
8332
5892
Table 9-4 LC50 for ammonia - Lethal concentration as a function of probability of fatality at different
exposure times
In the risk assessment it is assumed that a concentration above 8695 ppm in more than 5
minutes will be lethal. And for exposure time less than 5 minutes a concentration above 21.295
ppm is assumed to be lethal.
Ammonia vapour has a sharp, irritating, pungent odour that acts as a warning of potentially
dangerous exposure. The average odour threshold is 5 ppm, well below any danger or damage.
Exposure to very high concentrations of gaseous ammonia can result in lung damage and death.
9.1.5.3.1
Consequences to the structure and the installations
The consequences to the structure and the tunnel installations due to a toxic release of ammonia
may be similar to those of a corrosive release; e.g. released gases may react with water in the
drainage system and with concrete moisture. The tunnel will need to be cleaned from the toxic
release by washing the interior with water. The concrete, asphalt and different installations may
need to be replaced, but the restoration of the tunnel must not necessary include closure of both
of the road or railway tubes.
9.1.5.3.2
Disruption
The capacity of the drainage system will affect the impact of a release in the same way as for
corrosive release see section 9.1.4.2.
9.1.6
Chlorine release
Chlorine is a toxic gas that irritates the respiratory system. Because it is heavier than air, it tends
to accumulate at the bottom of poorly ventilated spaces. Chlorine gas is a strong oxidizer, which
may react with flammable materials. Chlorine is detectable in concentrations of as low as 0.2
ppm. Coughing and vomiting may occur at 30 ppm and lung damage at 60 ppm. About 1000 ppm
can be fatal after a few deep breaths of the gas.
Operational Risk Analysis
Work in Progress
65/178
65
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
9.1.6.1.1
Individual risk
The consequence for individuals is assessed for release of chlorine based on CFD-modelling and
probit functions. The result is presented in the following section.
9.1.6.1.2
CFD calculations
The same CFD–modelling as for ammonia is used to determine the concentration of chlorine in
the tunnel after an accident which leads to a release. A small release gives a concentration of
4200 ppm and a medium release gives a concentration of 40 000 ppm. It is assumed that a large
release gives the same consequence as a medium release.
9.1.6.2
Probit and LC50
The most severe consequences from a chlorine release will origin from chlorines toxicity; the
deadly concentrations are given below:
a: -14.8
b: 1
n: 2.3
An example is LC50 with an exposure time of 10 minutes given Pr(50%) = 5 and a chlorine gas
intensity of 0.10 kg/m
3
.
LC50 after 30 min. exposure:
5
14.3
 
exp

1

1005
mg
/
m
3
335
ppm
30
1
2
In Table 9-4 LC50 for different exposure time is presented. Exposure times below 5 minutes
contain large insecurities.
LC50
Exposure time (minutes)
�½
1
5
15
30
60
mg/m
5959
4409
2190
1358
1005
743
3
ppm
1986
1470
730
453
335
248
Table 9-5 LC50 for chlorine - Lethal concentration as a function of probability of fatality at different
exposure times
9.1.6.3
Consequences to the structure and the installations
The consequences to the structure and the tunnel installations due to a toxic release of chlorine
are assumed to be the same as for ammonia, see section 9.1.5.3.1 .
9.1.6.3.1
Disruption
The capacity of the drainage system will affect the impact of a release in the same way as for
corrosive release see section 9.1.4.2.
Operational Risk Analysis
Work in Progress
66/178
66
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
9.1.7
Detection of release
There are installed a few (five) gas detectors in the tunnel in order to measure the NO
x
-
concentration. No detectors are installed with the specific purpose of identifying releases of
dangerous goods.
The tunnel is designed with a VAID (Vehicle Accident and Incident Detection)-system that
automatically detects if a vehicle is stopped in the tunnel. In the analysis it has been assumed
that all significant releases of dangerous goods are related to traffic accidents, hence the vehicle
releasing the dangerous goods will be stopped. The VAID system is designed such that it
automatically starts up ventilation in order to avoid back-layering of smoke (in possible fire
scenarios) and gasses (from dangerous goods releases).
It the analyses it has been assumed that it will take 1 minute to detect the release/accident (by
means of a stopped vehicle) and start the ventilation up.
9.2
Assessment of impact from explosions
Explosions in terms of deflagration or detonation may be a result of ignition of solid explosives or
releases of LPG or similar materials. The following section presents the estimate of fatalities in
detonation of solid explosives, and the results of ignition of gas clouds leading to deflagration.
The effects of a detonation of solid explosives are only presented as an estimate of the number of
fatalities.
9.2.1
Solid explosives
Solid explosives are likely to be transported to some extent through the tunnel. If such goods
should detonate the consequences will probably be severe. Explosives are normally transported
in bulk packages and the amounts up to 1000 kg on road. In risk assessment for the Øresund
link ref. [13] calculations regarding explosions were made.
The assessment for Øresund showed that the consequences of an accident involving explosion of
solid explosives will be severe, and considering the overpressures possible in case of a
detonation, a collapse of several tunnel elements is possible. A collapse of one tunnel element
due to an explosion in one tube will affect vehicles in the accident tube as well as in the other
tubes. An explosion might cause collapse of more than one element. Vehicles which just have
passed the collapsing element are assumed to be able to drive out of the tunnel.
9.2.2
Vapour cloud explosion
A vapour cloud explosion is a deflagration creating an overpressure pulse as the flame front
burns from the point of ignition. The velocity of the flame front, which determines the
overpressure, is dependent on the size of the gas cloud in the tunnel. The length of the gas cloud
from typical release scenarios (se section 9.1.1) are determined by dispersion calculations
previously described.
The consequences of an explosion of a continuous release of LPG in terms of fatalities due to an
explosion in the tunnel are estimated by assuming that people inside the exploding gas cloud will
be fatally injured. People outside the cloud are assumed not to be harmed. The CFD modelling for
the road tube showed that a medium release of LPG will give a gas cloud larger than 200 m
within 150 seconds. It also indicates that a small release will not be sufficient to get an explosion.
For the medium release the whole tunnel might be affected by a gas cloud and gas clouds longer
than 200 m will most likely detonate causing fatalities in the whole tunnel..
9.2.3
BLEVE (boiling liquid expanding vapour explosion)
For outdoor BLEVE accidents, the consequences to people are normally assessed as the extent
and duration of the fireball, hence overpressure effects are normally not considered. The fireball
is normally modelled as a spherical fireball, assumed to be resting on the ground. The parameter
affecting the size of the fireball is the mass of the flammable liquid exploding in a BLEVE. A
Operational Risk Analysis
Work in Progress
67/178
67
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
BLEVE occurring inside a tunnel will be formed by the tunnel instead of forming a spherical
fireball.
In the risk assessment for the Øresund Link ref. [13] the radius of a BLEVE fireball and the
consequences of a BLEVE inside the tunnel have been calculated. The model used for the
Øresund link is conservative and gives indications of that an accident leading to a BLEVE inside
the tunnel, will affect the whole tunnel. It is assumed that a BLEVE in the Fehmarnbelt Fixed Link
also will affect the whole tunnel. Based the fact that the Øresund Tunnel is 3.5 km and the
Fehmarnbelt Fixed Link Tunnel is 18.4 km this assumption is conservative.
The consequences from a BLEVE are assumed to be the same as for explosion with solid
explosives.
Operational Risk Analysis
Work in Progress
68/178
68
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
10. APPENDIX B
TRAIN DISTRIBUTION IN TUNNEL FROM
TIME SCHEDULE
Based on the time schedule for 2025, which is described in ref. [21], an analysis about the train
distribution in the tunnel has been carried out.
The timetable data is diverging from the data used in Table 4-4, because of an increased number
of trains, see Table 10-1.
Rail Traffic
Average number of freight trains per day
Average number of passenger trains per day
2025
97
54
Table 10-1: Expected number of trains per day used in scheduling for the year 2025
Based on the time scheduled it is assessed how often different train scenarios are expected to
occur. From the analysis it is seen that there are two trains as a maximum - the combinations
are:
Two freight trains, (freight train followed by a passenger train and passenger train
followed by a freight train),
A single passenger train,
A single freight train.
The fraction of time spent in each scenario is estimated for each travel direction, and the result is
presented in Table 10-2.
Scenario
Freight / Freight
Freight / Passenger
Passenger / Freight
Freight
Passenger
Total
Fehmarn direction
1.6%
0.0%
0.1%
36.5%
11.9%
50.1%
Lolland direction
1.9%
1.1%
0.0%
32.9%
10.9%
46.9%
Table 10-2: Fraction of different train scenarios
From Table 10-2 it is seen that there are trains in a tunnel in direction of Fehmarn about 50% of
the time and about 47% in the direction of Lolland.
Operational Risk Analysis
Work in Progress
69/178
69
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
11. APPENDIX C
DISTRIBUTIONS OF TRAIN CAPACITY
11.1.1.1
Passenger trains
The average number of passengers on passenger trains is estimated to 95 persons, and the
number of workers on each train is conservatively set to 3 (Train driver, Train manager and one
other), ref.[3]. This gives a total of 98 persons on passengers on trains on average. Based on
traffic data from the present travel connection, i.e., passengers on trains driving on board of the
ferry between Rødby and Puttgarten, an analysis has been carried out. Data covers a one year
period from October 2011 to September 2012.
In Figure 11-1 the distribution of the present train capacities can be seen. Due to the fact that it
is expected that the same type and number of trains will be needed in the future, this distribution
is assumed to estimate the future distribution very well. It is e.g. seen that 82% of the trains can
have 195 passengers on board and a minor fraction (about 0.3%) can have up to 390
passengers.
90%
82%
80%
70%
60%
50%
40%
30%
20%
13%
10%
0%
4%
0
147
195
294
390
Figure 11-1 Distribution of train capacities
In Figure 11-2 the actual distribution of passengers can be seen. It is seen that it is most likely
that there are between 40 and 200 passengers on a train
Operational Risk Analysis
Work in Progress
70/178
70
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
12%
10%
8%
6%
4%
2%
0%
Figure 11-2 Actual distribution of passengers
It is seen that there is only a few number of registrations with trains with more than 260-270
passengers. The maximum number of passengers seen in data is 320. The distribution has been
shown in Figure 11-3 together with a fitted distribution.
12.0%
10.0%
8.0%
6.0%
4.0%
2.0%
0.0%
0
50
100
150
200
250
300
350
400
450
500
Number of passengers (including workers/operators)
Figure 11-3 Assumed distribution
From the data and the distribution it is seen that it is very unlikely that the number of passengers
in a train is larger than 320.
The numbers are presented in Table 11-1.
Operational Risk Analysis
0
10
20
30
40
50
60
70
80
90
100
110
120
130
140
150
160
170
180
190
200
210
220
230
240
250
260
270
280
290
300
310
320
330
340
Distribution of persons on passenger trains
Work in Progress
71/178
71
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Intervals (number of passengers)
0
40
80
100
150
275
40
80
100
150
275
350
Cumulative
4.8%
42.3%
61%
87%
99.2%
99.9%
Distribution
4.8%
37.5%
18.6%
26.2%
12.0%
0.76%
Table 11-1 Persons on passenger trains
11.1.1.2
Freight trains
It is assumed; see ref. [3], that the locomotive driver is the only person on the freight train.
Operational Risk Analysis
Work in Progress
72/178
72
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
12. APPENDIX D
CONSEQUENCE TABLES
12.1
Road accidents resulting in no fire
1.1 - Car accident resulting in no fire
Fatalities road
Distribution-type
Average
Poisson
0,0287
0
97,17%
0
0
95,92%
0
1,00E+03
0
0
0
1,00E+00
0
0
1,00E+00
0
0
1,00E+00
0
1
2,79%
2,79E-02
1
4,00%
4,00E-02
1,00E+04
100,00%
1,00E+04
1
0
0
1
0
0
1
0
0
3
0,04%
1,21E-03
7
0,08%
5,91E-03
10
0,00%
2,76E-07
14
0
0
30
0
0
30
0
0
100
0
0
180
0
0
300
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,0417
Repair costs
Distribution-type
Average
Poisson
2,50E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
0
0
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,000
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
1.3 - Buss accident resulting in no fire
Fatalities road
Distribution-type
Average
Poisson
0,0287
0
97,17%
0
0
92,00%
0
1,00E+03
0
0
0
1,00E+00
0
0
1,00E+00
0
0
1,00E+00
0
1
2,79%
2,79E-02
1
7,67%
7,67E-02
1,00E+04
100,00%
1,00E+04
1
0
0
1
0
0
1
0
0
3
0,04%
1,21E-03
7
0,33%
2,30E-02
10
0,00%
2,76E-07
14
0
0
30
0
0
30
0
0
100
0
0
180
0
0
300
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,0833
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
0
0
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,000
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
Operational Risk Analysis
Work in Progress
73/178
73
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
1.5 - Truck accident resulting in no fire
Fatalities road
Distribution-type
Average
Poisson
0,0287
0
97,17%
0
0
93,94%
0
1,00E+03
0
0
0
1,00E+00
0
0
1,00E+00
0
0
1,00E+00
0
1
2,79%
2,79E-02
1
5,87%
5,87E-02
1,00E+04
100,00%
1,00E+04
1
0
0
1
0
0
1
0
0
3
0,04%
1,21E-03
7
0,19%
1,31E-02
10
0,00%
2,76E-07
14
0
0
30
0
0
30
0
0
100
0
0
180
0
0
300
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,0625
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
0
0
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,000
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
Operational Risk Analysis
Work in Progress
74/178
74
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
12.2
Road accident involving dangerous goods vehicle carrying ammonia
1.1.1 - traffic accident involving dangerous goods vehicle carrying ammonia resulting in no release
Fatalities road
Distribution-type
Average
Poisson
0,0287
0
97,17%
0
0
93,94%
0
1,00E+03
0
0
0
1,00E+00
0
0
1,00E+00
0
0
1,00E+00
0
1
2,79%
2,79E-02
1
5,87%
5,87E-02
1,00E+04
100,00%
1,00E+04
1
0
0
1
0
0
1
0
0
3
0,04%
1,21E-03
7
0,19%
1,31E-02
10
0,00%
2,76E-07
14
0
0
30
0
0
30
0
0
100
0
0
180
0
0
300
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,0625
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
0
0
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,000
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
1.1.2 - traffic accident involving dangerous goods vehicle carrying ammonia resulting in small release
Fatalities road
Distribution-type
Average
Poisson
0,0287
0
97,17%
0
0
90,11%
0
1,00E+03
0
0
0
9,49E-01
0
0
1,00E+00
0
0
1,00E+00
0
1
2,79%
2,79E-02
1
9,39%
9,39E-02
1,00E+04
100,00%
1,00E+04
1
4,94E-02
4,94E-02
1
0
0
1
0
0
3
0,04%
1,21E-03
7
0,51%
3,54E-02
10
0,00%
2,76E-07
14
0
0
30
0
0
30
0
0
100
0
0
180
0
0
300
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,1042
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
1,31E-03
9,17E-03
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,052
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
Operational Risk Analysis
Work in Progress
75/178
75
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
1.1.3 - traffic accident involving dangerous goods vehicle carrying ammonia resulting in medium release
Fatalities road
Distribution-type
Average
Poisson
56,6912
0
0
0
0
88,25%
0
1,00E+03
0
0
0
9,39E-01
0
0
1,00E+00
0
0
1,00E+00
0
1
0
0
1
11,03%
1,10E-01
1,00E+04
100,00%
1,00E+04
1
5,87E-02
5,87E-02
1
0
0
1
0
0
3
0
0
7
0,72%
5,03E-02
10
0
0
14
0
0
30
0,01%
100
99,99%
300
0,00%
2,24E-03 1,00E+02 2,16E-05
30
0
0
180
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,1250
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
1,87E-03
1,31E-02
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,063
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
1.1.4 - Traffic accident involving Dangerous goods vehicle carrying Ammonia resulting in Large release
Fatalities road
Distribution-type
Average
Poisson
85,0225
0
0
0
0
82,90%
0
1,00E+03
0
0
0
9,11E-01
0
0
1,00E+00
0
0
1,00E+00
0
1
0
0
1
15,54%
1,55E-01
1,00E+04
100,00%
1,00E+04
1
8,54E-02
8,54E-02
1
0
0
1
0
0
3
0
0
7
1,55%
1,09E-01
10
0
0
14
0
0
30
0
0
30
0
0
100
95,04%
300
4,96%
9,50E+01 1,49E+01
180
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,1875
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
4,13E-03
2,89E-02
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,094
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
Operational Risk Analysis
Work in Progress
76/178
76
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
12.3
Road accidents involving dangerous good vehicle carrying chlorine
1.2.1 - traffic accident involving dangerous goods vehicle carrying chlorine resulting in no release
Fatalities road
Distribution-type
Average
Poisson
0,0287
0
97,17%
0
0
93,94%
0
1,00E+03
0
0
0
1,00E+00
0
0
1,00E+00
0
0
1,00E+00
0
1
2,79%
2,79E-02
1
5,87%
5,87E-02
1,00E+04
100,00%
1,00E+04
1
0
0
1
0
0
1
0
0
3
0,04%
1,21E-03
7
0,19%
1,31E-02
10
0,00%
2,76E-07
14
0
0
30
0
0
30
0
0
100
0
0
180
0
0
300
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,0625
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
0
0
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,000
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
1.2.2 - traffic accident involving dangerous goods vehicle carrying chlorine resulting in small release
Fatalities road
Distribution-type
Average
Poisson
0,0287
0
97,17%
0
0
90,11%
0
1,00E+03
0
0
0
9,49E-01
0
0
1,00E+00
0
0
1,00E+00
0
1
2,79%
2,79E-02
1
9,39%
9,39E-02
1,00E+04
100,00%
1,00E+04
1
4,94E-02
4,94E-02
1
0
0
1
0
0
3
0,04%
1,21E-03
7
0,51%
3,54E-02
10
0,00%
2,76E-07
14
0
0
30
0
0
30
0
0
100
0
0
180
0
0
300
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,1042
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
1,31E-03
9,17E-03
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,052
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
Operational Risk Analysis
Work in Progress
77/178
77
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
1.2.3 - traffic accident involving dangerous goods vehicle carrying chlorine resulting in medium release
Fatalities road
Distribution-type
Average
Poisson
113,3538
0
0
0
0
88,25%
0
1,00E+03
0
0
0
9,39E-01
0
0
1,00E+00
0
0
1,00E+00
0
1
0
0
1
11,03%
1,10E-01
1,00E+04
100,00%
1,00E+04
1
5,87E-02
5,87E-02
1
0
0
1
0
0
3
0
0
7
0,72%
5,03E-02
10
0
0
14
0
0
30
0
0
30
0
0
100
11,21%
300
88,79%
1,12E+01 2,66E+02
180
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,1250
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
1,87E-03
1,31E-02
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,063
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
1.2.4 - Traffic accident involving Dangerous goods vehicle carrying Chlorine resulting in Large release
Fatalities road
Distribution-type
Average
Poisson
170,0164
0
0
0
0
82,90%
0
1,00E+03
0
0
0
9,11E-01
0
0
1,00E+00
0
0
1,00E+00
0
1
0
0
1
15,54%
1,55E-01
1,00E+04
100,00%
1,00E+04
1
8,54E-02
8,54E-02
1
0
0
1
0
0
3
0
0
7
1,55%
1,09E-01
10
0
0
14
0
0
30
0
0
30
0
0
100
0,00%
300
100,00%
4,16E-07 3,00E+02
180
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,1875
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
4,13E-03
2,89E-02
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,094
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
Operational Risk Analysis
Work in Progress
78/178
78
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
12.4
Road accidents involving dangerous good vehicle carrying lpg
1.3.1 - traffic accident involving dangerous goods vehicle carrying lpg resulting in no release
Fatalities road
Distribution-type
Average
Poisson
0,0287
0
97,17%
0
0
93,94%
0
1,00E+03
0
0
0
1,00E+00
0
0
1,00E+00
0
0
1,00E+00
0
1
2,79%
2,79E-02
1
5,87%
5,87E-02
1,00E+04
100,00%
1,00E+04
1
0
0
1
0
0
1
0
0
3
0,04%
1,21E-03
7
0,19%
1,31E-02
10
0,00%
2,76E-07
14
0
0
30
0
0
30
0
0
100
0
0
180
0
0
300
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,0625
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
0
0
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,000
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
1.3.2 - traffic accident involving dangerous goods vehicle carrying lpg resulting in small release no ignition
Fatalities road
Distribution-type
Average
Poisson
0,0287
0
97,17%
0
0
90,11%
0
1,00E+03
0
0
0
9,49E-01
0
0
1,00E+00
0
0
1,00E+00
0
1
2,79%
2,79E-02
1
9,39%
9,39E-02
1,00E+04
100,00%
1,00E+04
1
4,94E-02
4,94E-02
1
0
0
1
0
0
3
0,04%
1,21E-03
7
0,51%
3,54E-02
10
0,00%
2,76E-07
14
0
0
30
0
0
30
0
0
100
0
0
180
0
0
300
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,1042
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
1,31E-03
9,17E-03
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,052
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
Operational Risk Analysis
Work in Progress
79/178
79
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
1.3.3 - traffic accident involving dangerous goods vehicle carrying lpg resulting in small release, delayed
ignition leading to a explosion
Fatalities road
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
215,3177
0
0
0
0
0
1,00E+03
0
0
0
0
0
0
2,13E-01
0
0
2,13E-01
0
0
0
1
0
0
1,00E+04
0
0
1
0
0
1
3,29E-01
3,29E-01
1
3,29E-01
3,29E-01
0
0
7
0
0
0
0
14
0
0
0
0
30
0
0
0
0
180
0
0
100,00%
3,00E+02
365
51,39%
1,88E+02
Disruption road
Distribution-type
Average
Poisson
365,0000
Repair costs
Distribution-type
Average
Poisson
5,00E+08
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
0
0
3
3,86E-01
1,16E+00
3
3,86E-01
1,16E+00
0
0
14
0
0
10
0
0
30
0
0
30
0
0
180
0
0
100
0
0
100
0
0
100,00%
1,00E+09
365
5,14E-01
1,88E+02
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
365,000
Fatalities rail passengers
Distribution-type
Average
Poisson
1,547
7,17E-02 7,43E-07
7,17E-01 2,23E-05
10
30
Fatalities rail employees
Distribution-type
Average
Poisson
1,547
7,17E-02 7,43E-07
7,17E-01 2,23E-05
1.3.5 - traffic accident involving dangerous goods vehicle carrying lpg resulting in small release, immediate
ignition leading to a bleve
Fatalities road
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
215,3177
0
0
0
0
0
1,00E+03
0
0
0
0
0
0
2,13E-01
0
0
2,13E-01
0
0
0
1
0
0
1,00E+04
0
0
1
0
0
1
3,29E-01
3,29E-01
1
3,29E-01
3,29E-01
0
0
7
0
0
0
0
14
0
0
0
0
30
0
0
0
0
180
0
0
100,00%
3,00E+02
365
51,39%
1,88E+02
Disruption road
Distribution-type
Average
Poisson
365,0000
Repair costs
Distribution-type
Average
Poisson
5,00E+08
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
0
0
3
3,86E-01
1,16E+00
3
3,86E-01
1,16E+00
0
0
14
0
0
10
0
0
30
0
0
30
0
0
180
0
0
100
0
0
100
0
0
100,00%
1,00E+09
365
5,14E-01
1,88E+02
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
365,000
Fatalities rail passengers
Distribution-type
Average
Poisson
1,547
7,17E-02 7,43E-07
7,17E-01 2,23E-05
10
30
Fatalities rail employees
Distribution-type
Average
Poisson
1,547
7,17E-02 7,43E-07
7,17E-01 2,23E-05
Operational Risk Analysis
Work in Progress
80/178
80
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
1.3.7 - traffic accident involving dangerous goods vehicle carrying lpg resulting in medium release, no
immediate ignition leading to a no ignition
Fatalities road
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
0,0287
97,17%
0
0
88,25%
0
1,00E+03
0
0
0
9,39E-01
0
0
1,00E+00
0
0
1,00E+00
0
2,79%
2,79E-02
1
11,03%
1,10E-01
1,00E+04
100,00%
1,00E+04
1
5,87E-02
5,87E-02
1
0
0
1
0
0
0,04%
1,21E-03
7
0,72%
5,03E-02
0,00%
2,76E-07
14
0
0
0
0
30
0
0
0
0
180
0
0
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,1250
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
1,87E-03
1,31E-02
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,063
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
1.3.8 - traffic accident involving dangerous goods vehicle carrying lpg resulting in medium release, delayed
ignition leading to a explosion
Fatalities road
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
215,3177
0
0
0
0
0
1,00E+03
0
0
0
0
0
0
2,13E-01
0
0
2,13E-01
0
0
0
1
0
0
1,00E+04
0
0
1
0
0
1
3,29E-01
3,29E-01
1
3,29E-01
3,29E-01
0
0
7
0
0
0
0
14
0
0
0
0
30
0
0
0
0
180
0
0
100,00%
3,00E+02
365
51,39%
1,88E+02
Disruption road
Distribution-type
Average
Poisson
365,0000
Repair costs
Distribution-type
Average
Poisson
5,00E+08
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
0
0
3
3,86E-01
1,16E+00
3
3,86E-01
1,16E+00
0
0
14
0
0
10
0
0
30
0
0
30
0
0
180
0
0
100
0
0
100
0
0
100,00%
1,00E+09
365
5,14E-01
1,88E+02
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
365,000
Fatalities rail passengers
Distribution-type
Average
Poisson
1,547
7,17E-02 7,43E-07
7,17E-01 2,23E-05
10
30
Fatalities rail employees
Distribution-type
Average
Poisson
1,547
7,17E-02 7,43E-07
7,17E-01 2,23E-05
Operational Risk Analysis
Work in Progress
81/178
81
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
1.3.10 - traffic accident involving dangerous goods vehicle carrying lpg resulting in medium release,
immediate ignition leading to a bleve
Fatalities road
0
1
3
10
30
100
Distribution-type
Average
Poisson
215,3177
0
0
0
0
0
1,00E+03
0
0
0
0
0
0
2,13E-01
0
0
2,13E-01
0
0
0
1
0
0
1,00E+04
0
0
1
0
0
1
3,29E-01
3,29E-01
1
3,29E-01
3,29E-01
0
0
7
0
0
0
0
14
0
0
0
0
30
0
0
0
0
180
0
0
300
100,00%
3,00E+02
365
51,39%
1,88E+02
Disruption road
Distribution-type
Average
Poisson
365,0000
Repair costs
Distribution-type
Average
Poisson
5,00E+08
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
0
0
3
3,86E-01
1,16E+00
3
3,86E-01
1,16E+00
0
0
14
0
0
10
0
0
30
0
0
30
0
0
180
0
0
100
0
0
100
0
0
100,00%
1,00E+09
365
5,14E-01
1,88E+02
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
365,000
Fatalities rail passengers
Distribution-type
Average
Poisson
1,547
7,17E-02 7,43E-07
7,17E-01 2,23E-05
10
30
Fatalities rail employees
Distribution-type
Average
Poisson
1,547
7,17E-02 7,43E-07
7,17E-01 2,23E-05
1.3.12 - traffic accident involving dangerous goods vehicle carrying lpg resulting in large release, no
immediate ignition leading to a no ignition
Fatalities road
0
1
3
10
30
100
Distribution-type
Average
Poisson
0,0287
97,17%
0
0
82,90%
0
1,00E+03
0
0
0
9,11E-01
0
0
1,00E+00
0
0
1,00E+00
0
2,79%
2,79E-02
1
15,54%
1,55E-01
1,00E+04
100,00%
1,00E+04
1
8,54E-02
8,54E-02
1
0
0
1
0
0
0,04%
1,21E-03
7
1,55%
1,09E-01
0,00%
2,76E-07
14
0
0
0
0
30
0
0
0
0
180
0
0
300
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,1875
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
4,13E-03
2,89E-02
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,094
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
Operational Risk Analysis
Work in Progress
82/178
82
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
1.3.15 - traffic accident involving dangerous goods vehicle carrying lpg resulting in large release, leading to
a immediate ignition - explosion
Fatalities road
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
215,3177
0
0
0
0
0
1,00E+03
0
0
0
0
0
0
2,13E-01
0
0
2,13E-01
0
0
0
1
0
0
1,00E+04
0
0
1
0
0
1
3,29E-01
3,29E-01
1
3,29E-01
3,29E-01
0
0
7
0
0
0
0
14
0
0
0
0
30
0
0
0
0
180
0
0
100,00%
3,00E+02
365
51,39%
1,88E+02
Disruption road
Distribution-type
Average
Poisson
365,0000
Repair costs
Distribution-type
Average
Poisson
5,00E+08
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
0
0
3
3,86E-01
1,16E+00
3
3,86E-01
1,16E+00
0
0
14
0
0
10
0
0
30
0
0
30
0
0
180
0
0
100
0
0
100
0
0
100,00%
1,00E+09
365
5,14E-01
1,88E+02
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
365,000
Fatalities rail passengers
Distribution-type
Average
Poisson
1,547
7,17E-02 7,43E-07
7,17E-01 2,23E-05
10
30
Fatalities rail employees
Distribution-type
Average
Poisson
1,547
7,17E-02 7,43E-07
7,17E-01 2,23E-05
Operational Risk Analysis
Work in Progress
83/178
83
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
12.5
Road accidents involving dangerous goods vehicle carrying flammable liquids
1.4.1 - traffic accident involving dangerous goods vehicle carrying flammable liquidsresulting in no release
of heptane
Fatalities road
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
0,0287
97,17%
0
0
93,94%
0
1,00E+03
0
0
0
1,00E+00
0
0
1,00E+00
0
0
1,00E+00
0
2,79%
2,79E-02
1
5,87%
5,87E-02
1,00E+04
100,00%
1,00E+04
1
0
0
1
0
0
1
0
0
0,04%
1,21E-03
7
0,19%
1,31E-02
0,00%
2,76E-07
14
0
0
0
0
30
0
0
0
0
180
0
0
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,0625
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
0
0
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,000
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
1.4.2 - traffic accident involving dangerous goods vehicle carrying flammable liquids resulting in small
heptane release no ignition
0
1
3
10
30
100
300
Fatalities road
Distribution-type
Average
Poisson
0,0287
97,17%
0
0
90,11%
0
1,00E+03
0
0
0
9,49E-01
0
0
1,00E+00
0
0
1,00E+00
0
2,79%
2,79E-02
1
9,39%
9,39E-02
1,00E+04
100,00%
1,00E+04
1
4,94E-02
4,94E-02
1
0
0
1
0
0
0,04%
1,21E-03
7
0,51%
3,54E-02
0,00%
2,76E-07
14
0
0
0
0
30
0
0
0
0
180
0
0
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,1042
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
1,31E-03
9,17E-03
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,052
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
Operational Risk Analysis
Work in Progress
84/178
84
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
1.4.3 - traffic accident involving dangerous goods vehicle carrying flammable liquids resulting in heptane
release, ignition leading to a bleve
Fatalities road
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
215,3177
0
0
0
0
0
1,00E+03
0
0
0
0
0
0
0
0
0
0
0
0
0
1
0
0
1,00E+04
0
0
1
0
0
1
0
0
1
0
0
0
0
7
0
0
0
0
14
0
0
0
0
30
0
0
0
0
180
0
0
100,00%
3,00E+02
365
51,39%
1,88E+02
Disruption road
Distribution-type
Average
Poisson
365,0000
Repair costs
Distribution-type
Average
Poisson
5,00E+08
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
0
0
3
0
0
3
0
0
0
0
14
0
0
10
0
0
30
0
0
30
0
0
180
0
0
100
100,00%
1,00E+09
365
5,14E-01
1,88E+02
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
365,000
Fatalities rail passengers
Distribution-type
Average
Poisson
43,473
1,13E-09 2,00E-02 9,80E-01
1,13E-08 6,01E-01 9,80E+01
10
30
100
Fatalities rail employees
Distribution-type
Average
Poisson
43,473
1,13E-09 2,00E-02 9,80E-01
1,13E-08 6,01E-01 9,80E+01
1.4.5 - traffic accident involving dangerous goods vehicle carrying flammable liquids resulting in heptane
release, medium release leading to a no ignition
Fatalities road
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
0,0287
97,17%
0
0
88,25%
0
1,00E+03
0
0
0
9,39E-01
0
0
1,00E+00
0
0
1,00E+00
0
2,79%
2,79E-02
1
11,03%
1,10E-01
1,00E+04
100,00%
1,00E+04
1
5,87E-02
5,87E-02
1
0
0
1
0
0
0,04%
1,21E-03
7
0,72%
5,03E-02
0,00%
2,76E-07
14
0
0
0
0
30
0
0
0
0
180
0
0
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,1250
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
1,87E-03
1,31E-02
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,063
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
Operational Risk Analysis
Work in Progress
85/178
85
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
1.4.6 - traffic accident involving dangerous goods vehicle carrying flammable liquids resulting in heptane
release, medium release leading to a bleve
Fatalities road
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
215,3177
0
0
0
0
0
1,00E+03
0
0
0
0
0
0
2,13E-01
0
0
2,13E-01
0
0
0
1
0
0
1,00E+04
0
0
1
0
0
1
3,29E-01
3,29E-01
1
3,29E-01
3,29E-01
0
0
7
0
0
0
0
14
0
0
0
0
30
0
0
0
0
180
0
0
100,00%
3,00E+02
365
51,39%
1,88E+02
Disruption road
Distribution-type
Average
Poisson
365,0000
Repair costs
Distribution-type
Average
Poisson
5,00E+08
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
0
0
3
3,86E-01
1,16E+00
3
3,86E-01
1,16E+00
0
0
14
0
0
10
0
0
30
0
0
30
0
0
180
0
0
100
0
0
100
0
0
100,00%
1,00E+09
365
5,14E-01
1,88E+02
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
365,000
Fatalities rail passengers
Distribution-type
Average
Poisson
1,547
7,17E-02 7,43E-07
7,17E-01 2,23E-05
10
30
Fatalities rail employees
Distribution-type
Average
Poisson
1,547
7,17E-02 7,43E-07
7,17E-01 2,23E-05
1.4.8 - traffic accident involving dangerous goods vehicle carrying flammable liquids resulting in heptane
release, large release leading to no ignition
Fatalities road
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
0,0287
97,17%
0
0
82,90%
0
1,00E+03
0
0
0
9,11E-01
0
0
1,00E+00
0
0
1,00E+00
0
2,79%
2,79E-02
1
15,54%
1,55E-01
1,00E+04
100,00%
1,00E+04
1
8,54E-02
8,54E-02
1
0
0
1
0
0
0,04%
1,21E-03
7
1,55%
1,09E-01
0,00%
2,76E-07
14
0
0
0
0
30
0
0
0
0
180
0
0
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,1875
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
4,13E-03
2,89E-02
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,094
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
Operational Risk Analysis
Work in Progress
86/178
86
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
1.4.9 - traffic accident involving dangerous goods vehicle carrying flammable liquids resulting in heptane
release, large release, leading to a ignition
Fatalities road
0
0
0
0
0
0
0
Distribution-type
Average
Co
0
Poisson ered in DGV-fire event tree
0,0000
0
0
100,00%
0
1,00E+03
100,00%
1,00E+03
0
1,00E+00
0
0
1,00E+00
0
0
1,00E+00
0
0
1
0
0
1,00E+04
0
0
1
0
0
1
0
0
1
0
0
0
0
7
0
0
0
0
14
0
0
0
0
30
0
0
0
0
180
0
0
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,0000
Repair costs
Distribution-type
Average
Poisson
0,00E+00
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
0
0
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,000
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
Operational Risk Analysis
Work in Progress
87/178
87
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
12.6
Road accidents involving vehicles carrying explosives
1.5.1 - traffic accident involving dangerous goods vehicle carrying exposives resulting in detonation
Fatalities road
Distribution-type
Average
Poisson
215,3177
0
0
0
0
0
0
1,00E+03
0
0
0
0
0
0
2,13E-01
0
0
2,13E-01
0
1
0
0
1
0
0
1,00E+04
0
0
1
0
0
1
3,29E-01
3,29E-01
1
3,29E-01
3,29E-01
3
0
0
7
0
0
10
0
0
14
0
0
30
0
0
30
0
0
100
0
0
180
0
0
300
100,00%
3,00E+02
365
51,39%
1,88E+02
Disruption road
Distribution-type
Average
Poisson
365,0000
Repair costs
Distribution-type
Average
Poisson
5,00E+08
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
0
0
3
3,86E-01
1,16E+00
3
3,86E-01
1,16E+00
0
0
14
0
0
10
0
0
30
0
0
30
0
0
180
0
0
100
0
0
100
0
0
100,00%
1,00E+09
365
5,14E-01
1,88E+02
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
365,000
Fatalities rail passengers
Distribution-type
Average
Poisson
1,547
7,17E-02 7,43E-07
7,17E-01 2,23E-05
10
30
Fatalities rail employees
Distribution-type
Average
Poisson
1,547
7,17E-02 7,43E-07
7,17E-01 2,23E-05
1.5.2 - traffic accident involving dangerous goods vehicle carrying exposives resulting in no detonation
Fatalities road
Distribution-type
Average
Poisson
0,0287
0
97,17%
0
0
93,94%
0
1,00E+03
0
0
0
1,00E+00
0
0
1,00E+00
0
0
1,00E+00
0
1
2,79%
2,79E-02
1
5,87%
5,87E-02
1,00E+04
100,00%
1,00E+04
1
0
0
1
0
0
1
0
0
3
0,04%
1,21E-03
7
0,19%
1,31E-02
10
0,00%
2,76E-07
14
0
0
30
0
0
30
0
0
100
0
0
180
0
0
300
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,0625
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
0
0
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,000
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
Operational Risk Analysis
Work in Progress
88/178
88
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
12.7
Road accidents involving vehicles carrying acids and bases
1.6.1 - traffic accident involving dangerous goods vehicle carrying acids and bases resulting in large release
Fatalities road
Distribution-type
Average
Poisson
0,0287
0
97,17%
0
0
82,90%
0
1,00E+03
0
0
0
9,11E-01
0
0
1,00E+00
0
0
1,00E+00
0
1
2,79%
2,79E-02
1
15,54%
1,55E-01
1,00E+04
100,00%
1,00E+04
1
8,54E-02
8,54E-02
1
0
0
1
0
0
3
0,04%
1,21E-03
7
1,55%
1,09E-01
10
0,00%
2,76E-07
14
0
0
30
0
0
30
0
0
100
0
0
180
0
0
300
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,1875
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
4,13E-03
2,89E-02
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,094
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
1.6.2 - traffic accident involving dangerous goods vehicle carrying acids and bases resulting in medium
release
Fatalities road
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
0,0287
97,17%
0
0
88,25%
0
1,00E+03
0
0
0
9,39E-01
0
0
1,00E+00
0
0
1,00E+00
0
2,79%
2,79E-02
1
11,03%
1,10E-01
1,00E+04
100,00%
1,00E+04
1
5,87E-02
5,87E-02
1
0
0
1
0
0
0,04%
1,21E-03
7
0,72%
5,03E-02
0,00%
2,76E-07
14
0
0
0
0
30
0
0
0
0
180
0
0
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,1250
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
1,87E-03
1,31E-02
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,063
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
Operational Risk Analysis
Work in Progress
89/178
89
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
1.6.3 - traffic accident involving dangerous goods vehicle carrying acids and bases resulting in small release
Fatalities road
Distribution-type
Average
Poisson
0,0287
0
97,17%
0
0
90,11%
0
1,00E+03
0
0
0
9,49E-01
0
0
1,00E+00
0
0
1,00E+00
0
1
2,79%
2,79E-02
1
9,39%
9,39E-02
1,00E+04
100,00%
1,00E+04
1
4,94E-02
4,94E-02
1
0
0
1
0
0
3
0,04%
1,21E-03
7
0,51%
3,54E-02
10
0,00%
2,76E-07
14
0
0
30
0
0
30
0
0
100
0
0
180
0
0
300
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,1042
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
1,31E-03
9,17E-03
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,052
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
1.6.4 - traffic accident involving dangerous goods vehicle carrying acids and bases resulting in no release
Fatalities road
Distribution-type
Average
Poisson
0,0287
0
97,17%
0
0
93,94%
0
1,00E+03
0
0
0
1,00E+00
0
0
1,00E+00
0
0
1,00E+00
0
1
2,79%
2,79E-02
1
5,87%
5,87E-02
1,00E+04
100,00%
1,00E+04
1
0
0
1
0
0
1
0
0
3
0,04%
1,21E-03
7
0,19%
1,31E-02
10
0,00%
2,76E-07
14
0
0
30
0
0
30
0
0
100
0
0
180
0
0
300
0
0
365
0
0
Disruption road
Distribution-type
Average
Poisson
0,0625
Repair costs
Distribution-type
Average
Poisson
5,00E+03
1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
7
0
0
3
0
0
3
0
0
0
0
14
0
0
10
0
0
10
0
0
0
0
30
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
100
0
0
0
0
365
0
0
300
0
0
300
0
0
Disruption rail
Distribution-type
Average
Poisson
0,000
Fatalities rail passengers
Distribution-type
Average
Poisson
0,000
Fatalities rail employees
Distribution-type
Average
Poisson
0,000
Operational Risk Analysis
Work in Progress
90/178
90
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
12.8
Fire Road
Scenario
2.1.2
2.1.3
2.1.4
2.1.5
2.1.6
2.1.7
2.1.8
2.1.9
2.2.2
2.2.3
2.2.4
2.2.5
2.2.6
2.2.7
2.2.8
2.2.9
2.3.2
2.3.3
2.3.4
2.3.5
2.3.6
2.3.7
2.3.8
2.3.9
2.3.10
2.3.11
2.3.12
2.3.13
2.3.14
2.3.15
2.3.16
2.3.17
2.4.2
2.4.3
2.4.4
2.4.5
2.4.6
2.4.7
2.4.8
2.4.9
2.1.1
2.2.1
2.3.1
2.4.1
2.5.1
2.6.1
2.7.1
2.8.1
0
1,00
1,00
1,00
1,00
1,00
1,00
1,00
0,43
1,00
1,00
1,00
1,00
1,00
1,00
1,00
0,43
1,00
1,00
1,00
1,00
1,00
1,00
0,40
0,43
1,00
1,00
1,00
1,00
1,00
1,00
1,00
0,43
1,00
1,00
1,00
1,00
1,00
1,00
1,00
0,43
1,00
1,00
1,00
1,00
1,00
1,00
1,00
1,00
1
0
0
0
0
0
0
0
0,09
0
0
0
0
0
0
0
0,09
0
0
0
0
0
0
0,02
0,09
0
0
0
0
0
0
0
0,09
0
0
0
0
0
0
0
0,09
0
0
0
0
0
0
0
0
3
0
0
0
0
0
0
0
0,27
0
0
0
0
0
0
0
0,27
0
0
0
0
0
0
0,13
0,27
0
0
0
0
0
0
0
0,27
0
0
0
0
0
0
0
0,27
0
0
0
0
0
0
0
0
10
0
0
0
0
0
0
0
0,21
0
0
0
0
0
0
0
0,21
0
0
0
0
0
0
0,43
0,21
0
0
0
0
0
0
0
0,21
0
0
0
0
0
0
0
0,21
0
0
0
0
0
0
0
0
30
0
0
0
0
0
0
0
0,00
0
0
0
0
0
0
0
0,00
0
0
0
0
0
0
0,01
0,00
0
0
0
0
0
0
0
0,00
0
0
0
0
0
0
0
0,00
0
0
0
0
0
0
0
0
100
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
300
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
Mean
0
0
0
0
0
0
0
3,00
0
0
0
0
0
0
0
3,00
0
0
0
0
0
0
5,00
3,00
0
0
0
0
0
0
0
3,00
0
0
0
0
0
0
0
3,00
0
0
0
0
0
0
0
0
Operational Risk Analysis
Work in Progress
91/178
91
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Repair costs
Fire size
1
2,5
8
15
20
30
50
200
350
Repair costs [Euro] - fire inside enclosed tunnel
1,00E+03 1,00E+04 1,00E+05 1,00E+06
1,00E+07
1,00E+08
9,44E-01 5,56E-02
0
0
0
0
7,26E-02 9,27E-01 3,16E-04
0
0
0
0
5,05E-02 9,49E-01 6,09E-04
0
0
0
1,10E-05 7,36E-01 2,64E-01
1,84E-08
0
0
2,66E-07 4,44E-01 5,56E-01
1,10E-06
0
0
0
9,30E-04 9,60E-01
3,90E-02
0
0
0
0
5,16E-04
9,44E-01
5,56E-02
0
0
0
2,66E-07
4,44E-01
5,56E-01
0
0
0
0
8,53E-03
9,85E-01
1,00E+09
0
0
0
0
0
0
0
1,10E-06
6,41E-03
Mean
1.500
9.375
96.000
337.500
600.000
1.350.000
15.000.000
60.000.000
105.000.000
Repair costs [Euro] - fire on landsides
Fire size 1,00E+03 1,00E+04 1,00E+05 1,00E+06
1,00E+07
1,00E+08
1
1,00E+00
0
0
0
0
0
2,5
1,00E+00
0
0
0
0
0
15
1,10E-05 7,36E-01 2,64E-01 1,84E-08
0
0
30
0
9,30E-04 9,60E-01 3,90E-02
0
0
200
0
0
2,66E-07 4,44E-01
5,56E-01
1,10E-06
350
0
0
0
8,53E-03
9,85E-01
6,41E-03
Disruption
Fire size
1
2,5
8
15
20
30
50
200
350
Fire size
1
2,5
8
15
20
30
50
200
350
0
8,73E-01
8,11E-01
7,71E-01
7,15E-01
4,22E-01
2,90E-01
6,93E-01
5,00E-01
5,00E-01
Disruption [days] - fire inside enclosed tunnel
1
7
14
30
1,14E-01 1,22E-02
0
0
1,53E-01 3,52E-02 6,52E-09
0
1,67E-01 6,18E-02 1,24E-07
0
1,66E-01 1,19E-01 4,62E-06
0
4,32E-02 5,05E-01 3,01E-02
1,17E-05
4,53E-03 4,20E-01 2,81E-01
4,06E-03
0
1,61E-07 2,82E-04
1,68E-01
0
0
0
0
0
0
0
0
Disruption [days] - fire
1
7
3,63E-02 7,67E-04
6,41E-02 2,75E-03
8,58E-02 5,60E-03
1,28E-01 1,74E-02
1,44E-01 2,70E-02
1,62E-01 4,83E-02
5,83E-02 4,62E-01
4,53E-03 4,20E-01
4,53E-03 4,20E-01
- Incident tube
180
0
0
0
0
0
0
1,39E-01
5,00E-01
5,00E-01
1,00E+09
0
0
0
0
0
0
Mean
1.000
1.000
33.750
135.000
6.000.000
10.500.000
365
0
0
0
0
0
0
0
0
0
Mean
0,20
0,40
0,60
1,00
4,00
7,00
30,00
90,00
90,00
0
9,63E-01
9,33E-01
9,09E-01
8,55E-01
8,29E-01
7,90E-01
4,65E-01
2,90E-01
2,90E-01
inside enclosed tunnel - Non
14
30
0
0
0
0
0
0
0
0
1,70E-09
0
3,33E-08
0
1,48E-02
2,35E-06
2,81E-01
4,06E-03
2,81E-01
4,06E-03
incident tube
180
365
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
Mean
0,04
0,08
0,13
0,25
0,33
0,50
3,50
7,00
7,00
Fire size
1
2,5
15
30
200
350
0
8,73E-01
8,11E-01
7,90E-01
6,60E-01
6,10E-01
6,10E-01
1
1,14E-01
1,53E-01
1,62E-01
1,46E-01
1,22E-01
1,22E-01
Disruption [days] - fire on landsides
7
14
30
180
1,22E-02
0
0
0
3,52E-02 6,52E-09
0
0
4,83E-02 3,33E-08
0
0
1,93E-01 7,41E-05
0
0
2,67E-01 4,94E-04
1,75E-09
0
2,67E-01 4,94E-04
1,75E-09
0
365
0
0
0
0
0
0
Mean
0,20
0,40
0,50
1,50
2,00
2,00
Operational Risk Analysis
Work in Progress
92/178
92
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
12.9
Train Collision
Operational Risk Analysis
Work in Progress
93/178
93
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.0 - No severe collision
Fatalities passengers
0
1
0
0
1
0
0
1
7,67%
3
0
0
3
0
0
7
0,33%
10
0
0
10
0
0
14
0
0
30
0
0
30
0
0
30
0
0
100
0
0
100
0
0
180
0
0
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
92,00%
0
Distribution-type Poisson
Average
8,33E-02
Repair costs
7,67E-02 2,30E-02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
92,00%
0
0
0
0
1
7,67%
100,00%
1,00E+05
7
0,33%
0
0
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+04
Disruption road
Distribution-type Poisson
Average
8,33E-02
Fatalities road
7,67E-02 2,30E-02
1
0
0
3
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.1 - Front- Front - Train collision with one passenger train and one freight train not carrying
dangerous goods
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
10,26
Fatalities employees
0,00%
0
0
29,00%
0
0
0,04%
0,81%
54,20%
44,95%
0,00%
0
0
300
0
0
365
0
0
3,59E-04 2,44E-02 5,42E+00 1,35E+01 1,38E-05
1
35,90%
3
31,39%
10
3,72%
30
0,00%
100
0
0
180
0
0
Distribution-type Poisson
Average
1,238
Disruption
3,59E-01 9,42E-01 3,72E-01 2,54E-06
1
27,07%
7
59,29%
14
0,11%
30
0,00%
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
94/178
94
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.3 - Front- Front - Train collision with two freight trains not carrying dangerous goods
Fatalities passengers
0
1
0
0
1
36,79%
3
0
0
3
24,53%
10
0
0
10
1,90%
30
0
0
30
0,00%
100
0
0
100
0
0
180
0
0
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
36,79%
0
0
Distribution-type Poisson
1
Average
Disruption
3,68E-01 7,36E-01 1,90E-01 3,01E-07
1
27,07%
7
59,29%
14
0,11%
30
0,00%
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.5 - Front- Front - Train collision with two passenger trains
Fatalities passengers
0
0,00%
0
0
27,47%
0
0
4,98%
0
1
0,04%
3
0,81%
10
54,20%
30
44,95%
100
0,00%
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
Average
10,26
Fatalities employees
3,59E-04 2,44E-02 5,42E+00 1,35E+01 1,38E-05
1
35,49%
3
32,80%
10
4,23%
30
0,00%
100
0
0
180
0
0
Distribution-type Poisson
Average
1,292
Disruption
3,55E-01 9,84E-01 4,23E-01 3,87E-06
1
14,94%
7
78,89%
14
1,19%
30
0,00%
Distribution-type Poisson
Average
3,00E+00
Repair costs
1,49E-01 5,52E+00 1,67E-01 2,01E-05
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
7
4,46%
50,03%
49,97%
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
95/178
95
Distribution-type Poisson
Average
1,00E+06
Disruption road
5,00E+05 5,00E+06
14
0,00%
30
0
0
30
0
0
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.6 - Front- End - Train collision with one passenger train and one freight train not carrying
dangerous goods
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
5,13
Average
Fatalities employees
0,59%
0
0
53,85%
0
0
3,04%
21,10%
73,65%
1,62%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
3,04E-02 6,33E-01 7,37E+00 4,86E-01
1
33,33%
3
12,44%
10
0,37%
30
0
Distribution-type Poisson
Average
0,619
Disruption
3,33E-01 3,73E-01 3,75E-02 2,18E-09
1
27,07%
7
59,29%
14
0,11%
30
0,00%
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.7 - Front- End- Train collision with two freight trains not carrying dangerous goods
Fatalities passengers
0
1
0
0
1
32,75%
3
0
0
3
11,61%
10
0
0
10
0,32%
30
0
0
30
0
100
0
0
100
0
0
180
0
0
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
55,32%
0
0
Distribution-type Poisson
Average
0,592
Disruption
3,28E-01 3,48E-01 3,20E-02 1,37E-09
1
36,79%
7
26,42%
14
0,00%
30
0
0
Distribution-type Poisson
36,79%
0
Average
1,00E+00
Repair costs
3,68E-01 1,85E+00 1,43E-04
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
96/178
96
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
0
3
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.9 - Front- End - Train collision with two passenger trains
Fatalities passengers
0
0,59%
0
0
52,41%
0
0
1
3,04%
3
21,10%
10
73,65%
30
1,62%
100
0
0
100
0
0
180
0
0
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
5,13
Average
Fatalities employees
3,04E-02 6,33E-01 7,37E+00 4,86E-01
1
33,86%
3
13,29%
10
0,44%
30
0
Distribution-type Poisson
Average
0,646
Disruption
3,39E-01 3,99E-01 4,35E-02 3,40E-09
1
27,07%
7
59,29%
14
0,11%
30
0,00%
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
50,08%
49,92%
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
5,01E+04 4,99E+05
7
2,65%
14
0
Distribution-type Poisson
Average
1,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
97/178
97
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.1.1 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving ammonia resulting in no release
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.1.2 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving ammonia resulting in small release
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
98/178
98
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.1.3 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving ammonia resulting in medium release
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
300
0
0
Distribution-type Poisson
Average
23,75
Fatalities employees
0
0
0
47,24%
0
0
4,98%
0
0,00%
0,00%
0,13%
91,17%
8,71%
1,15E-09 3,66E-07 1,26E-02 2,74E+01 8,71E+00
1
35,43%
3
16,61%
10
0,73%
30
0
100
0
0
100
0
0
Distribution-type Poisson
0,75
Average
Disruption
3,54E-01 4,98E-01 7,29E-02 1,60E-08
1
14,94%
3
44,81%
10
35,25%
30
0,03%
Distribution-type Poisson
Average
3,00E+00
Repair costs
1,49E-01 1,34E+00 3,52E+00 8,77E-03
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
3
4,42%
0
0
10
0,04%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
100
0
0
100
0
0
0
0
300
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 1,33E-01 3,95E-03
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.1.4 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving ammonia resulting in large release
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
Average
35,625
Fatalities employees
0
0
0
32,47%
0
0
4,98%
0
0
0
1
36,52%
0
0
3
28,25%
0,00%
19,72%
80,28%
4,20E-06 5,91E+00 8,03E+01
10
2,76%
30
0,00%
100
0
0
180
0
0
Distribution-type Poisson
Average
1,125
Disruption
3,65E-01 8,47E-01 2,76E-01 9,83E-07
1
14,94%
7
78,89%
14
1,19%
30
0,00%
Distribution-type Poisson
Average
3,00E+00
Repair costs
1,49E-01 5,52E+00 1,67E-01 2,01E-05
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
99/178
99
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.1.5 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving chlorine resulting in no release
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
300
0
0
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
3
45,11%
0
0
10
0
0
10
14,29%
0
0
30
0
0
30
0,00%
0
0
100
0
0
100
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 1,35E+00 1,43E+00 2,49E-04
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
3
4,42%
0
0
10
0,04%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
100
0
0
100
0
0
0
0
300
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 1,33E-01 3,95E-03
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.1.6 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving chlorine resulting in small release
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
100/178
100
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.1.7 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving chlorine resulting in medium release
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
Average
23,75
Fatalities employees
0
0
0
47,24%
0
0
4,98%
0
0,00%
0,00%
0,13%
91,17%
8,71%
1,15E-09 3,66E-07 1,26E-02 2,74E+01 8,71E+00
1
35,43%
3
16,61%
10
0,73%
30
0
100
0
0
180
0
0
Distribution-type Poisson
0,75
Average
Disruption
3,54E-01 4,98E-01 7,29E-02 1,60E-08
1
14,94%
7
78,89%
14
1,19%
30
0,00%
Distribution-type Poisson
Average
3,00E+00
Repair costs
1,49E-01 5,52E+00 1,67E-01 2,01E-05
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.1.8 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving chlorine resulting in large release
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
Average
35,625
Fatalities employees
0
0
0
32,47%
0
0
4,98%
0
0
0
1
36,52%
0
0
3
28,25%
0,00%
19,72%
80,28%
4,20E-06 5,91E+00 8,03E+01
10
2,76%
30
0,00%
100
0
0
180
0
0
Distribution-type Poisson
Average
1,125
Disruption
3,65E-01 8,47E-01 2,76E-01 9,83E-07
1
14,94%
7
78,89%
14
1,19%
30
0,00%
Distribution-type Poisson
Average
3,00E+00
Repair costs
1,49E-01 5,52E+00 1,67E-01 2,01E-05
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
101/178
101
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.1.9 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving flammable resulting in no release of heptane
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.1.10 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving flammable resulting in small release and no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0
0
0
0
10
0
0
14
0
0
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
100,00%
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
7,20E+01
Repair costs
5,39E-07 1,80E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
102/178
102
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.1.11 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving flammable resulting in small release, ignition and bleve
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
90,25
Fatalities employees
0
0
0
5,78%
0
0
0
0
0
0
1
16,49%
0
0
3
45,81%
0
0
10
31,90%
0
0
30
0,02%
85,92%
14,08%
8,59E+01 4,22E+01
100
0
0
180
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
2,85
Average
Disruption
1,65E-01 1,37E+00 3,19E+00 5,71E-03
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
0
0
300
100,00%
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
3
0
10
0
0
0
0
0
0
0
3,00E+02
3.1.13 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving flammable resulting in medium release and no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
2,15E+02
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0
0
0
0
10
0
0
14
0
0
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
100,00%
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
7,20E+01
Repair costs
5,39E-07 1,80E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
103/178
103
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.1.14 - front- end - train collision with one passenger train and one freight train carrying
dangerous good resulting in train accident involving flammable liquids and medium release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
90,25
Fatalities employees
0
0
0
5,78%
0
0
0
0
0
0
1
16,49%
0
0
3
45,81%
0
0
10
31,90%
0
0
30
0,02%
85,92%
14,08%
8,59E+01 4,22E+01
100
0
0
180
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
2,85
Average
Disruption
1,65E-01 1,37E+00 3,19E+00 5,71E-03
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
0
0
300
100,00%
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
3
0
10
0
0
0
0
0
0
0
3,00E+02
3.1.16 - front- front - train collision with one passenger train and one freight train carrying
dangerous goods involving flammable liquids resulting in large release leading to no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
2,15E+02
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0
0
0
0
10
0
0
14
0
0
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
100,00%
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
7,20E+01
Repair costs
5,39E-07 1,80E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
104/178
104
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.1.18 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving lpg resulting in no release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.1.19 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving lpg resulting in small release and no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0
0
0
0
10
0
0
14
0
0
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
100,00%
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
7,20E+01
Repair costs
5,39E-07 1,80E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
105/178
105
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.1.20 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving lpg,small release resulting in delayed ignition and explosion
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
90,25
Fatalities employees
0
0
0
5,78%
0
0
0
0
0
0
1
16,49%
0
0
3
45,81%
0
0
10
31,90%
0
0
30
0,02%
85,92%
14,08%
8,59E+01 4,22E+01
100
0
0
180
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
2,85
Average
Disruption
1,65E-01 1,37E+00 3,19E+00 5,71E-03
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
0
0
300
100,00%
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
3
0
10
0
0
0
0
0
0
0
3,00E+02
3.1.22 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving lpg,small release resulting in immediate ignition and bleve
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
2,15E+02
Distribution-type Poisson
Average
90,25
Fatalities employees
0
0
0
5,78%
0
0
0
0
0
0
1
16,49%
0
0
3
45,81%
0
0
10
31,90%
0
0
30
0,02%
85,92%
14,08%
8,59E+01 4,22E+01
100
0
0
180
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
2,85
Average
Disruption
1,65E-01 1,37E+00 3,19E+00 5,71E-03
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
100,00%
3,00E+02
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
Average
2,15E+02
Operational Risk Analysis
Work in Progress
106/178
106
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.1.24 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving lpg,medium release resulting in no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0
0
0
0
10
0
0
14
0
0
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
100,00%
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
7,20E+01
Repair costs
5,39E-07 1,80E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.1.25 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving lpg,medium release resulting in delayed ignition and explosion
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
90,25
Fatalities employees
0
0
0
5,78%
0
0
0
0
0
0
1
16,49%
0
0
3
45,81%
0
0
10
31,90%
0
0
30
0,02%
85,92%
14,08%
8,59E+01 4,22E+01
100
0
0
180
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
2,85
Average
Disruption
1,65E-01 1,37E+00 3,19E+00 5,71E-03
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
100,00%
3,00E+02
107/178
107
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
Average
2,15E+02
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.1.27 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving lpg,medium release resulting in immediate ignition and bleve
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
90,25
Fatalities employees
0
0
0
5,78%
0
0
0
0
0
0
1
16,49%
0
0
3
45,81%
0
0
10
31,90%
0
0
30
0,02%
85,92%
14,08%
8,59E+01 4,22E+01
100
0
0
180
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
2,85
Average
Disruption
1,65E-01 1,37E+00 3,19E+00 5,71E-03
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
0
0
300
100,00%
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
3
0
10
0
0
0
0
0
0
0
3,00E+02
3.1.29 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving lpg, large release resulting in no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
2,15E+02
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0
0
0
0
10
0
0
14
0
0
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
100,00%
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
7,20E+01
Repair costs
5,39E-07 1,80E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
108/178
108
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.1.30 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving lpg,large release resulting in delayed ignition and explosion
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
90,25
Fatalities employees
0
0
0
5,78%
0
0
0
0
0
0
1
16,49%
0
0
3
45,81%
0
0
10
31,90%
0
0
30
0,02%
85,92%
14,08%
8,59E+01 4,22E+01
100
0
0
180
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
2,85
Average
Disruption
1,65E-01 1,37E+00 3,19E+00 5,71E-03
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
0
0
300
100,00%
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
3
0
10
0
0
0
0
0
0
0
3,00E+02
3.1.33 - front- front - train collision with one passenger train and one freight train carrying
dangerous g involving acid and resulting in no release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
2,15E+02
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
109/178
109
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.1.34 - front- front - train collision with one passenger train and one freight train carrying
dangerous goods involving acid and resulting in small release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.1.35 - front- front - train collision with one passenger train and one freight train carrying
dangerous goods involving acid and resulting in medium release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
14,94%
0
0
3
0
0
7
78,89%
0
0
10
0
0
14
1,19%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
4,98%
0
Distribution-type Poisson
Average
3,00E+00
Repair costs
1,49E-01 5,52E+00 1,67E-01 2,01E-05
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
110/178
110
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.1.36 - front- front - train collision with one passenger train and one freight train carrying
dangerous goods involving acid and resulting in large release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
14,94%
0
0
3
0
0
7
78,89%
0
0
10
0
0
14
1,19%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
4,98%
0
Distribution-type Poisson
Average
3,00E+00
Repair costs
1,49E-01 5,52E+00 1,67E-01 2,01E-05
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
3,33E-01
Fatalities road
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
111/178
111
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
12.10 Train collision involving dangerous goods
Operational Risk Analysis
Work in Progress
112/178
112
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.2.1 - front- front - train collision with two freight trains carrying dangerous goods involving
ammonia resulting in no release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.2.2 - front- front - train collision with two freight trains carrying dangerous goods involving
ammonia resulting in small release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0
0
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0,36%
0
0
100
0
0
180
99,64%
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
4,80E+01
Repair costs
1,10E-07 1,09E-01 1,79E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
113/178
113
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.2.3 - front- front - train collision with two freight trains carrying dangerous goods involving
ammonia resulting in medium release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
60,65%
0
0
0
0
0
0
1
30,33%
0
0
3
8,85%
0
0
10
0,18%
0
0
30
0
0
30
0,36%
0
0
100
0
0
180
99,64%
0
0
300
0
0
365
0
0
Distribution-type Poisson
0,5
Average
Disruption
3,03E-01 2,65E-01 1,75E-02
1
0
0
7
0
0
14
0,00%
Distribution-type Poisson
Average
4,80E+01
Repair costs
1,10E-07 1,09E-01 1,79E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.2.4 - front- front - train collision with two freight trains carrying dangerous goods involving
ammonia resulting in large release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
47,24%
0
0
0
0
0
0
1
35,43%
0
0
3
16,61%
0
0
10
0,73%
0
0
30
0
0
0
100
0
0
180
99,64%
0
0
300
0
0
365
0
0
Distribution-type Poisson
0,75
Average
Disruption
3,54E-01 4,98E-01 7,29E-02 1,60E-08
1
0
0
7
0
0
14
0,00%
30
0,36%
Distribution-type Poisson
Average
4,80E+01
Repair costs
1,10E-07 1,09E-01 1,79E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
114/178
114
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.2.5 - front- front - train collision with two freight trains carrying dangerous goods involving
chlorine resulting in no release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.2.6 - front- front - train collision with two freight trains carrying dangerous goods involving
chlorine resulting in small release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0
0
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0,36%
0
0
100
0
0
180
99,64%
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
4,80E+01
Repair costs
1,10E-07 1,09E-01 1,79E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
115/178
115
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.2.7 - front- front - train collision with two freight trains carrying dangerous goods involving
chlorine resulting in medium release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
60,65%
0
0
0
0
0
0
1
30,33%
0
0
3
8,85%
0
0
10
0,18%
0
0
30
0
0
30
0,36%
0
0
100
0
0
180
99,64%
0
0
300
0
0
365
0
0
Distribution-type Poisson
0,5
Average
Disruption
3,03E-01 2,65E-01 1,75E-02
1
0
0
7
0
0
14
0,00%
Distribution-type Poisson
Average
4,80E+01
Repair costs
1,10E-07 1,09E-01 1,79E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.2.8 - front- front - train collision with two freight trains carrying dangerous goods involving
chlorine resulting in large release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
47,24%
0
0
0
0
0
0
1
35,43%
0
0
3
16,61%
0
0
10
0,73%
0
0
30
0
0
0
100
0
0
180
99,64%
0
0
300
0
0
365
0
0
Distribution-type Poisson
0,75
Average
Disruption
3,54E-01 4,98E-01 7,29E-02 1,60E-08
1
0
0
7
0
0
14
0,00%
30
0,36%
Distribution-type Poisson
Average
4,80E+01
Repair costs
1,10E-07 1,09E-01 1,79E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
116/178
116
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.2.9 - front- front - train collision with two freight trains carrying dangerous goods involving
flammable resulting in no release of heptane
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.2.10 - front- front - train collision with two freight trains carrying dangerous goods involving
flammable resulting in small release and no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0
0
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0,36%
0
0
100
0
0
180
99,64%
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
4,80E+01
Repair costs
1,10E-07 1,09E-01 1,79E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
117/178
117
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.2.11 - front- front - train collision with two freight trains carrying dangerous goods involving
flammable resulting in small release, ignition and bleve
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
14,96%
0
0
0
0
0
0
1
28,42%
0
0
3
44,10%
0
0
10
12,53%
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
1,9
Average
Disruption
2,84E-01 1,32E+00 1,25E+00 1,55E-04
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
0
0
300
100,00%
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
3
0
10
0
0
0
0
0
0
0
3,00E+02
3.2.13 - front- front - train collision with two freight trains carrying dangerous goods involving
flammable resulting in medium release and no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
2,15E+02
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
118/178
118
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.2.14 - front- front - train collision with two freight trains carrying dangerous goodsheptane
release resulting in medium release ignition leading tobleve
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
14,96%
0
0
0
0
0
0
1
28,42%
0
0
3
44,10%
0
0
10
12,53%
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
1,9
Average
Disruption
2,84E-01 1,32E+00 1,25E+00 1,55E-04
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
0
0
300
100,00%
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
3
0
10
0
0
0
0
0
0
0
3,00E+02
3.2.16 - front- front - train collision with two freight trains carrying dangerous goods involving
flammable resulting in large release and no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
2,15E+02
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0
0
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0,36%
0
0
100
0
0
180
99,64%
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
4,80E+01
Repair costs
1,10E-07 1,09E-01 1,79E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
119/178
119
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.2.18 - front- front - train collision with two freight trains carrying dangerous goods involving lpg
resulting in no release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.2.19 - front- front - train collision with two freight trains carrying dangerous goods involving lpg
resulting in small release and no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0
0
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0,36%
0
0
100
0
0
180
99,64%
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
4,80E+01
Repair costs
1,10E-07 1,09E-01 1,79E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
120/178
120
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.2.20 - front- front - train collision with two freight trains carrying dangerous goods involving
lpg,small release resulting in delayed ignition and explosion
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
14,96%
0
0
0
0
0
0
1
28,42%
0
0
3
44,10%
0
0
10
12,53%
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
1,9
Average
Disruption
2,84E-01 1,32E+00 1,25E+00 1,55E-04
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
0
0
300
100,00%
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
3
0
10
0
0
0
0
0
0
0
3,00E+02
3.2.22 - front- front - train collision with two freight trains carrying dangerous goods involving
lpg,small release resulting in immediate ignition and bleve
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
2,15E+02
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
14,96%
0
0
0
0
0
0
1
28,42%
0
0
3
44,10%
0
0
10
12,53%
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
1,9
Average
Disruption
2,84E-01 1,32E+00 1,25E+00 1,55E-04
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
100,00%
3,00E+02
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
Average
2,15E+02
Operational Risk Analysis
Work in Progress
121/178
121
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.2.24 - front- front - train collision with two freight trains carrying dangerous goods involving
lpg,medium release resulting in no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0
0
0
0
10
0
0
14
0
0
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
100,00%
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
7,20E+01
Repair costs
5,39E-07 1,80E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.2.25 - front- front - train collision with two freight trains carrying dangerous goods involving
lpg,medium release resulting in delayed ignition and explosion
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
14,96%
0
0
0
0
0
0
1
28,42%
0
0
3
44,10%
0
0
10
12,53%
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
1,9
Average
Disruption
2,84E-01 1,32E+00 1,25E+00 1,55E-04
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
100,00%
3,00E+02
122/178
122
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
Average
2,15E+02
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.2.27 - front- front - train collision with two freight trains carrying dangerous goods involving
lpg,medium release resulting in immediate ignition and bleve
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
14,96%
0
0
0
0
0
0
1
28,42%
0
0
3
44,10%
0
0
10
12,53%
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
1,9
Average
Disruption
2,84E-01 1,32E+00 1,25E+00 1,55E-04
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
0
0
300
100,00%
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
3
0
10
0
0
0
0
0
0
0
3,00E+02
3.2.29 - front- front - train collision with two freight trains carrying dangerous goods involving
lpg, large release resulting in no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
2,15E+02
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0
0
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0,36%
0
0
100
0
0
180
99,64%
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
4,80E+01
Repair costs
1,10E-07 1,09E-01 1,79E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
123/178
123
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.2.30 - front- front - train collision with two freight trains carrying dangerous goods involving
lpg,large release resulting in delayed ignition and explosion
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
14,96%
0
0
0
0
0
0
1
28,42%
0
0
3
44,10%
0
0
10
12,53%
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
1,9
Average
Disruption
2,84E-01 1,32E+00 1,25E+00 1,55E-04
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
0
0
300
100,00%
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
3
0
10
0
0
0
0
0
0
0
3,00E+02
3.2.33 - front- front - train collision with two freight trains carrying dangerous goods involving
acid and resulting in no release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
2,15E+02
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
124/178
124
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.2.34 - front- front - train collision with two freight trains carrying dangerous goods involving
acid and resulting in small release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.2.35 - front- front - train collision with two freight trains carrying dangerous goods involving
acid and resulting in medium release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
125/178
125
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.2.36 - front- front - train collision with two freight trains carrying dangerous goods involving
acid and resulting in large release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+06
Disruption road
Distribution-type Poisson
Average
4,17E-01
Fatalities road
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
126/178
126
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Operational Risk Analysis
Work in Progress
127/178
127
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.3.1 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving ammonia resulting in no release
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
36,79%
0
0
3
0
0
7
26,42%
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
36,79%
0
Average
1,00E+00
Repair costs
3,68E-01 1,85E+00 1,43E-04
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.3.2 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving ammonia resulting in small release
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
128/178
128
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.3.3 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving ammonia resulting in medium release
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
Average
23,75
Fatalities employees
0
0
0
47,24%
0
0
0,00%
0,00%
0,13%
91,17%
8,71%
1,15E-09 3,66E-07 1,26E-02 2,74E+01 8,71E+00
1
35,43%
3
16,61%
10
0,73%
30
0
100
0
0
180
0
0
Distribution-type Poisson
0,75
Average
Disruption
3,54E-01 4,98E-01 7,29E-02 1,60E-08
1
27,07%
7
59,29%
14
0,11%
30
0,00%
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.3.4 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving ammonia resulting in large release
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
Average
35,625
Fatalities employees
0
0
0
32,47%
0
0
0
0
1
36,52%
0
0
3
28,25%
0,00%
19,72%
80,28%
4,20E-06 5,91E+00 8,03E+01
10
2,76%
30
0,00%
100
0
0
180
0
0
Distribution-type Poisson
Average
1,125
Disruption
3,65E-01 8,47E-01 2,76E-01 9,83E-07
1
27,07%
7
59,29%
14
0,11%
30
0,00%
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
129/178
129
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.3.5 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving chlorine resulting in no release
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
36,79%
0
0
3
0
0
7
26,42%
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
36,79%
0
Average
1,00E+00
Repair costs
3,68E-01 1,85E+00 1,43E-04
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.3.6 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving chlorine resulting in small release
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
130/178
130
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.3.7 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving chlorine resulting in medium release
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
Average
23,75
Fatalities employees
0
0
0
47,24%
0
0
0,00%
0,00%
0,13%
91,17%
8,71%
1,15E-09 3,66E-07 1,26E-02 2,74E+01 8,71E+00
1
35,43%
3
16,61%
10
0,73%
30
0
100
0
0
180
0
0
Distribution-type Poisson
0,75
Average
Disruption
3,54E-01 4,98E-01 7,29E-02 1,60E-08
1
27,07%
7
59,29%
14
0,11%
30
0,00%
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.3.8 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving chlorine resulting in large release
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
Average
35,625
Fatalities employees
0
0
0
32,47%
0
0
0
0
1
36,52%
0
0
3
28,25%
0,00%
19,72%
80,28%
4,20E-06 5,91E+00 8,03E+01
10
2,76%
30
0,00%
100
0
0
180
0
0
Distribution-type Poisson
Average
1,125
Disruption
3,65E-01 8,47E-01 2,76E-01 9,83E-07
1
27,07%
7
59,29%
14
0,11%
30
0,00%
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
131/178
131
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.3.9 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving flammable resulting in no release of heptane
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.3.10 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving flammable resulting in small release and no ignition
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0
0
0
0
10
0
0
14
0
0
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
100,00%
0
0
Average
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
132/178
132
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.3.11 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving flammable resulting in small release, ignition and bleve
Fatalities passengers
0
1
3
10
30
100
300
14,08%
Distribution-type Poisson
Average
90,25
Fatalities employees
0
0
0
5,78%
0
0
0
0
0
0
1
16,49%
0
0
3
45,81%
0
0
10
31,90%
0
0
30
0,02%
85,92%
8,59E+01 4,22E+01
100
0
0
180
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
2,85
Average
Disruption
1,65E-01 1,37E+00 3,19E+00 5,71E-03
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
0
0
300
100,00%
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
3
0
10
0
0
0
0
0
0
0
3,00E+02
3.3.13 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving flammable resulting in medium release and no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
2,15E+02
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
133/178
133
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.3.14 - front- end - train collision with one passenger train and one freight train carrying
dangerous good resulting in train accident involving flammable liquids and medium release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
90,25
Fatalities employees
0
0
0
5,78%
0
0
0
0
0
0
1
16,49%
0
0
3
45,81%
0
0
10
31,90%
0
0
30
0,02%
85,92%
14,08%
8,59E+01 4,22E+01
100
0
0
180
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
2,85
Average
Disruption
1,65E-01 1,37E+00 3,19E+00 5,71E-03
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
0
0
300
100,00%
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
3
0
10
0
0
0
0
0
0
0
3,00E+02
3.3.16 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving flammable resulting in large release and no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
2,15E+02
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
134/178
134
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.3.18 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving lpg resulting in no release
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
36,79%
0
0
3
0
0
7
26,42%
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
36,79%
0
Average
1,00E+00
Repair costs
3,68E-01 1,85E+00 1,43E-04
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.3.19 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving lpg resulting in small release and no ignition
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0
0
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0,36%
0
0
100
0
0
180
99,64%
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
4,80E+01
Repair costs
1,10E-07 1,09E-01 1,79E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
135/178
135
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.3.20 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving lpg,small release resulting in delayed ignition and explosion
Fatalities passengers
0
1
3
10
30
100
300
14,08%
Distribution-type Poisson
Average
90,25
Fatalities employees
0
0
0
5,78%
0
0
0
0
0
0
1
16,49%
0
0
3
45,81%
0
0
10
31,90%
0
0
30
0,02%
85,92%
8,59E+01 4,22E+01
100
0
0
180
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
2,85
Average
Disruption
1,65E-01 1,37E+00 3,19E+00 5,71E-03
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
0
0
300
100,00%
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
3
0
10
0
0
0
0
0
0
0
3,00E+02
3.3.22 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving lpg,small release resulting in immediate ignition and bleve
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
2,15E+02
Distribution-type Poisson
Average
90,25
Fatalities employees
0
0
0
5,78%
0
0
0
0
0
0
1
16,49%
0
0
3
45,81%
0
0
10
31,90%
0
0
30
0,02%
85,92%
14,08%
8,59E+01 4,22E+01
100
0
0
180
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
2,85
Average
Disruption
1,65E-01 1,37E+00 3,19E+00 5,71E-03
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
100,00%
3,00E+02
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
Average
2,15E+02
Operational Risk Analysis
Work in Progress
136/178
136
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.3.24 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving lpg,medium release resulting in no ignition
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0
0
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0,36%
0
0
100
0
0
180
99,64%
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
4,80E+01
Repair costs
1,10E-07 1,09E-01 1,79E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.3.25 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving lpg,medium release resulting in delayed ignition and explosion
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
90,25
Fatalities employees
0
0
0
5,78%
0
0
0
0
0
0
1
16,49%
0
0
3
45,81%
0
0
10
31,90%
0
0
30
0,02%
85,92%
14,08%
8,59E+01 4,22E+01
100
0
0
180
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
2,85
Average
Disruption
1,65E-01 1,37E+00 3,19E+00 5,71E-03
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
100,00%
3,00E+02
137/178
137
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
Average
2,15E+02
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.3.27 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving lpg,medium release resulting in immediate ignition and bleve
Fatalities passengers
0
1
3
10
30
100
300
14,08%
Distribution-type Poisson
Average
90,25
Fatalities employees
0
0
0
5,78%
0
0
0
0
0
0
1
16,49%
0
0
3
45,81%
0
0
10
31,90%
0
0
30
0,02%
85,92%
8,59E+01 4,22E+01
100
0
0
180
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
2,85
Average
Disruption
1,65E-01 1,37E+00 3,19E+00 5,71E-03
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
0
0
300
100,00%
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
3
0
10
0
0
0
0
0
0
0
3,00E+02
3.3.29 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving lpg, large release resulting in no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
2,15E+02
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0
0
0
0
10
0
0
14
0
0
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
100,00%
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
7,20E+01
Repair costs
5,39E-07 1,80E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
138/178
138
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.3.30 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving lpg,large release resulting in delayed ignition and explosion
Fatalities passengers
0
1
3
10
30
100
300
14,08%
Distribution-type Poisson
Average
90,25
Fatalities employees
0
0
0
5,78%
0
0
0
0
0
0
1
16,49%
0
0
3
45,81%
0
0
10
31,90%
0
0
30
0,02%
85,92%
8,59E+01 4,22E+01
100
0
0
180
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
2,85
Average
Disruption
1,65E-01 1,37E+00 3,19E+00 5,71E-03
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
100,00%
3,00E+02
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
Average
2,15E+02
3.3.33 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving acid and resulting in no release
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
36,79%
0
0
3
0
0
7
26,42%
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
36,79%
0
Average
1,00E+00
Repair costs
3,68E-01 1,85E+00 1,43E-04
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
139/178
139
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.3.34 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving acid and resulting in small release
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.3.35 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving acid and resulting in 0.32967
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
27,07%
0
0
3
0
0
7
59,29%
0
0
10
0
0
14
0,11%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
13,53%
0
Average
2,00E+00
Repair costs
2,71E-01 4,15E+00 1,54E-02 1,16E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
140/178
140
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.3.36 - front- end - train collision with one passenger train and one freight train carrying
dangerous good involving acid and resulting in large release
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
36,79%
0
0
3
0
0
7
26,42%
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
36,79%
0
Average
1,00E+00
Repair costs
3,68E-01 1,85E+00 1,43E-04
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
77,88%
0
0
0
0
1
19,47%
0
0
7
2,65%
100,00%
1,00E+06
14
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
2,50E-01
Fatalities road
1,95E-01 1,85E-01 4,24E-09
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
141/178
141
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.4.1 - front- end - train collision with two freight trains carrying dangerous goods involving
ammonia resulting in no release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
36,79%
0
0
3
0
0
7
26,42%
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
36,79%
0
Average
1,00E+00
Repair costs
3,68E-01 1,85E+00 1,43E-04
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
0
3
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.4.2 - front- end - train collision with two freight trains carrying dangerous goods involving
ammonia resulting in small release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
36,79%
0
0
3
0
0
7
26,42%
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
36,79%
0
Average
1,00E+00
Repair costs
3,68E-01 1,85E+00 1,43E-04
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
142/178
142
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
0
3
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.4.3 - front- end - train collision with two freight trains carrying dangerous goods involving
ammonia resulting in medium release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
60,65%
0
0
0
0
1
30,33%
0
0
3
8,85%
0
0
10
0,18%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
0,5
Average
Disruption
3,03E-01 2,65E-01 1,75E-02
1
36,79%
7
26,42%
14
0,00%
Distribution-type Poisson
36,79%
0
Average
1,00E+00
Repair costs
3,68E-01 1,85E+00 1,43E-04
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
0
3
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.4.4 - front- end - train collision with two freight trains carrying dangerous goods involving
ammonia resulting in large release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
47,24%
0
0
0
0
1
35,43%
0
0
3
16,61%
0
0
10
0,73%
0
0
30
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
0,75
Average
Disruption
3,54E-01 4,98E-01 7,29E-02 1,60E-08
1
36,79%
7
26,42%
14
0,00%
30
0
0
Distribution-type Poisson
36,79%
0
Average
1,00E+00
Repair costs
3,68E-01 1,85E+00 1,43E-04
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
143/178
143
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
0
3
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Operational Risk Analysis
Work in Progress
144/178
144
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.4.5 - front- end - train collision with two freight trains carrying dangerous goods involving
chlorine resulting in no release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
36,79%
0
0
3
0
0
7
26,42%
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
36,79%
0
Average
1,00E+00
Repair costs
3,68E-01 1,85E+00 1,43E-04
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
0
3
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.4.6 - front- end - train collision with two freight trains carrying dangerous goods involving
chlorine resulting in small release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
36,79%
0
0
3
0
0
7
26,42%
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
36,79%
0
Average
1,00E+00
Repair costs
3,68E-01 1,85E+00 1,43E-04
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
145/178
145
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
0
3
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.4.7 - front- end - train collision with two freight trains carrying dangerous goods involving
chlorine resulting in medium release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
60,65%
0
0
0
0
1
30,33%
0
0
3
8,85%
0
0
10
0,18%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
0,5
Average
Disruption
3,03E-01 2,65E-01 1,75E-02
1
36,79%
7
26,42%
14
0,00%
Distribution-type Poisson
36,79%
0
Average
1,00E+00
Repair costs
3,68E-01 1,85E+00 1,43E-04
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
0
3
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.4.8 - front- end - train collision with two freight trains carrying dangerous goods involving
chlorine resulting in large release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
47,24%
0
0
0
0
1
35,43%
0
0
3
16,61%
0
0
10
0,73%
0
0
30
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
0,75
Average
Disruption
3,54E-01 4,98E-01 7,29E-02 1,60E-08
1
36,79%
7
26,42%
14
0,00%
30
0
0
Distribution-type Poisson
36,79%
0
Average
1,00E+00
Repair costs
3,68E-01 1,85E+00 1,43E-04
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
146/178
146
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
0
3
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.4.9 - front- end - train collision with two freight trains carrying dangerous goods involving
flammable resulting in no release of heptane
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
36,79%
0
0
3
0
0
7
26,42%
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
36,79%
0
Average
1,00E+00
Repair costs
3,68E-01 1,85E+00 1,43E-04
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
0
3
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.4.10 - front- end - train collision with two freight trains carrying dangerous goods involving
flammable resulting in small release and no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0,00%
0
0
10
0
0
14
1,98%
0
0
30
0
0
30
88,43%
0
0
100
0
0
180
9,58%
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
2,40E+01
Repair costs
3,32E-04 2,77E-01 2,65E+01 1,73E+01
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
147/178
147
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
0
3
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.4.11 - front- end - train collision with two freight trains carrying dangerous goods involving
flammable resulting in small release, ignition and bleve
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
14,96%
0
0
0
0
0
0
1
28,42%
0
0
3
44,10%
0
0
10
12,53%
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
1,9
Average
Disruption
2,84E-01 1,32E+00 1,25E+00 1,55E-04
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
0
0
300
100,00%
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
3
0
0
0
0
0
0
0
3,00E+02
3.4.13 - front- end - train collision with two freight trains carrying dangerous goods involving
flammable resulting in medium release and no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
2,15E+02
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0,00%
0
0
10
0
0
14
1,98%
0
0
30
0
0
30
88,43%
0
0
100
0
0
180
9,58%
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
2,40E+01
Repair costs
3,32E-04 2,77E-01 2,65E+01 1,73E+01
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
0
3
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
148/178
148
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.4.14 - front- end - train collision with two freight trains carrying dangerous goods resulting in
train accident involving flammable liquids and medium release ignition leading tobleve
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
14,96%
0
0
0
0
0
0
1
28,42%
0
0
3
44,10%
0
0
10
12,53%
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
1,9
Average
Disruption
2,84E-01 1,32E+00 1,25E+00 1,55E-04
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
0
0
300
100,00%
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
3
0
0
0
0
0
0
0
3,00E+02
3.4.16 - front- end - train collision with two freight trains carrying dangerous goods involving
flammable resulting in large release and no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
2,15E+02
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0,00%
0
0
10
0
0
14
1,98%
0
0
30
0
0
30
88,43%
0
0
100
0
0
180
9,58%
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
2,40E+01
Repair costs
3,32E-04 2,77E-01 2,65E+01 1,73E+01
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
0
3
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
149/178
149
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Operational Risk Analysis
Work in Progress
150/178
150
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.4.18 - front- end - train collision with two freight trains carrying dangerous goods involving lpg
resulting in no release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
36,79%
0
0
3
0
0
3
24,53%
0
0
10
0
0
10
1,90%
0
0
30
0
0
30
0,00%
0
0
100
0
0
100
0
0
0
0
300
0
0
300
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
36,79%
0
Average
1,00E+00
Repair costs
3,68E-01 7,36E-01 1,90E-01 3,01E-07
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
1
14,11%
0
0
3
1,24%
100,00%
1,00E+06
10
0,00%
0
0
30
0
0
30
0
0
0
0
100
0
0
100
0
0
0
0
300
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 3,72E-02 2,81E-04
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.4.19 - front- end - train collision with two freight trains carrying dangerous goods involving lpg
resulting in small release and no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0,00%
0
0
10
0
0
14
1,98%
0
0
30
0
0
30
88,43%
0
0
100
0
0
180
9,58%
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
2,40E+01
Repair costs
3,32E-04 2,77E-01 2,65E+01 1,73E+01
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
151/178
151
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
0
3
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.4.20 - front- end - train collision with two freight trains carrying dangerous goods involving
lpg,small release resulting in delayed ignition and explosion
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
14,96%
0
0
0
0
0
0
1
28,42%
0
0
3
44,10%
0
0
10
12,53%
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
1,9
Average
Disruption
2,84E-01 1,32E+00 1,25E+00 1,55E-04
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
0
0
300
100,00%
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
3
0
0
0
0
0
0
0
3,00E+02
3.4.22 - front- end - train collision with two freight trains carrying dangerous goods involving
lpg,small release resulting in immediate ignition and bleve
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
2,15E+02
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
14,96%
0
0
0
0
0
0
1
28,42%
0
0
3
44,10%
0
0
10
12,53%
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
1,9
Average
Disruption
2,84E-01 1,32E+00 1,25E+00 1,55E-04
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
100,00%
3,00E+02
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
0
3
0
0
Distribution-type Poisson
Average
2,15E+02
Operational Risk Analysis
Work in Progress
152/178
152
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.4.24 - front- end - train collision with two freight trains carrying dangerous goods involving
lpg,medium release resulting in no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0
0
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0,36%
0
0
100
0
0
180
99,64%
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
4,80E+01
Repair costs
1,10E-07 1,09E-01 1,79E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
0
3
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.4.25 - front- end - train collision with two freight trains carrying dangerous goods involving
lpg,medium release resulting in delayed ignition and explosion
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
14,96%
0
0
0
0
0
0
1
28,42%
0
0
3
44,10%
0
0
10
12,53%
0
0
30
0,00%
0
0
100
0
0
100
0
0
0
0
300
0
0
300
0,03%
7,67E-02
Distribution-type Poisson
1,9
Average
Disruption
2,84E-01 1,32E+00 1,25E+00 1,55E-04
1
0
0
3
0
0
10
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
0
0
1
14,11%
0
0
3
1,24%
100,00%
1,00E+06
10
0,00%
0
0
30
0
0
30
0
0
0
0
100
0
0
100
0
0
0
0
300
0
0
300
100,00%
3,00E+02
153/178
153
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 3,72E-02 2,81E-04
1
0
0
3
0
0
10
0
0
Distribution-type Poisson
Average
2,15E+02
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.4.27 - front- end - train collision with two freight trains carrying dangerous goods involving
lpg,medium release resulting in immediate ignition and bleve
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
14,96%
0
0
0
0
0
0
1
28,42%
0
0
3
44,10%
0
0
10
12,53%
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
1,9
Average
Disruption
2,84E-01 1,32E+00 1,25E+00 1,55E-04
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
0
0
300
100,00%
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
3
0
0
0
0
0
0
0
3,00E+02
3.4.29 - front- end - train collision with two freight trains carrying dangerous goods involving lpg,
large release resulting in no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
2,15E+02
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0
0
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0,36%
0
0
100
0
0
180
99,64%
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
0
0
Distribution-type Poisson
Average
4,80E+01
Repair costs
1,10E-07 1,09E-01 1,79E+02
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
0
3
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
154/178
154
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.4.30 - front- end - train collision with two freight trains carrying dangerous goods involving
lpg,large release resulting in delayed ignition and explosion
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
14,96%
0
0
0
0
0
0
1
28,42%
0
0
3
44,10%
0
0
10
12,53%
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
51,39%
1,88E+02
Distribution-type Poisson
1,9
Average
Disruption
2,84E-01 1,32E+00 1,25E+00 1,55E-04
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type Poisson
Average
3,65E+02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
0
0
300
100,00%
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
3
0
0
0
0
0
0
0
3,00E+02
3.4.33 - front- end - train collision with two freight trains carrying dangerous goods involving
acid and resulting in no release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
Average
2,15E+02
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
36,79%
0
0
3
0
0
7
26,42%
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
36,79%
0
Average
1,00E+00
Repair costs
3,68E-01 1,85E+00 1,43E-04
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
0
3
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
155/178
155
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.4.34 - front- end - train collision with two freight trains carrying dangerous goods involving
acid and resulting in small release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
36,79%
0
0
3
0
0
7
26,42%
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
36,79%
0
Average
1,00E+00
Repair costs
3,68E-01 1,85E+00 1,43E-04
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
0
3
0
0
Distribution-type Poisson
100,00%
Average
0
0
3.4.35 - front- end - train collision with two freight trains carrying dangerous goods involving
acid and resulting in medium release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
36,79%
0
0
3
0
0
7
26,42%
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
36,79%
0
Average
1,00E+00
Repair costs
3,68E-01 1,85E+00 1,43E-04
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
156/178
156
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
0
3
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
3.4.36 - front- end - train collision with two freight trains carrying dangerous goods involving
acid and resulting in large release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type Poisson
100,00%
0
0
Average
Fatalities employees
0
0
0
1
0
0
1
36,79%
0
0
3
0
0
7
26,42%
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Distribution-type Poisson
100,00%
0
0
Average
Disruption
0
Distribution-type Poisson
36,79%
0
Average
1,00E+00
Repair costs
3,68E-01 1,85E+00 1,43E-04
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
84,65%
0
0
0
0
1
14,11%
0
0
7
1,24%
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type Poisson
Average
5,00E+05
Disruption road
Distribution-type Poisson
Average
1,67E-01
Fatalities road
1,41E-01 8,71E-02
1
0
0
3
0
0
Distribution-type Poisson
100,00%
Average
0
0
Operational Risk Analysis
Work in Progress
157/178
157
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
12.11 Train derailment
4.1 - train derailment involving passenger train resulting in no severe derailment
Fatalities passengers
0
100,00%
0
0
100,00%
0
0
1
0
0
1
0
0
1
7,67%
3
0
0
3
0
0
7
0,33%
10
0
0
10
0
0
14
0
0
30
0
0
30
0
0
30
0
0
100
0
0
100
0
0
180
0
0
300
0
0
300
0
0
365
0
0
Distribution-type
Average
Poisson
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
92,00%
0
0
100,00%
0
0
50,27%
49,73%
0
0
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
5,03E+03 4,97E+04
1
7,67%
7
0,33%
Distribution-type
Average
Poisson
1,00E+04
Disruption road
Distribution-type
Average
Poisson
8,33E-02
7,67E-02 2,30E-02
1
0
0
3
0
0
Fatalities road
Distribution-type
Average
Poisson
4.2 - train derailment involving passenger train resulting in severe derailment and no fire
Fatalities passengers
0
0,03%
0
0
52,94%
0
0
1
0,21%
3
3,30%
10
75,33%
30
21,13%
100
0,00%
300
0
0
300
0
0
365
0
0
Distribution-type
Average
Poisson
8,265
2,13E-03 9,90E-02 7,53E+00 6,34E+00 1,14E-07
1
33,67%
3
12,98%
10
0,41%
30
0
100
0
0
180
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0,636
3,37E-01 3,89E-01 4,12E-02 2,89E-09
1
7,67%
7
0,33%
14
0
0
30
0
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
100,00%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
158/178
158
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
3,33E-01
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Operational Risk Analysis
Poisson
Work in Progress
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
4.4 - train derailment involving freight train resulting in not severe derailment
Fatalities passengers
0
100,00%
0
0
100,00%
0
0
1
0
0
1
0
0
1
7,67%
3
0
0
3
0
0
7
0,33%
10
0
0
10
0
0
14
0
0
30
0
0
30
0
0
30
0
0
100
0
0
100
0
0
180
0
0
300
0
0
300
0
0
365
0
0
Distribution-type
Average
Poisson
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
95,92%
0
0
100,00%
0
0
50,27%
49,73%
0
0
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
5,03E+03 4,97E+04
1
4,00%
7
0,08%
Distribution-type
Average
Poisson
1,00E+04
Disruption road
Distribution-type
Average
Poisson
4,17E-02
4,00E-02 5,91E-03
1
0
0
3
0
0
Fatalities road
Distribution-type
Average
Poisson
4.5 - train derailment involving freight train resulting in severe derailment, no dangerous goods
invloved and no fire
0
1
3
10
30
100
300
Fatalities passengers
Distribution-type
Average
Poisson
0
100,00%
0
0
57,75%
0
0
0
0
1
31,71%
0
0
3
10,30%
0
0
10
0,24%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0,549
3,17E-01 3,09E-01 2,45E-02
1
7,67%
7
0,33%
14
0
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
100,00%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
3,33E-01
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Poisson
Operational Risk Analysis
Work in Progress
159/178
159
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
4.1.1 - train derailment involving dangerous goods vehicle carrying lpg resulting in no release
Fatalities passengers
0
100,00%
0
0
100,00%
0
0
1
0
0
1
0
0
1
7,67%
3
0
0
3
0
0
7
0,33%
10
0
0
10
0
0
14
0
0
30
0
0
30
0
0
30
0
0
100
0
0
100
0
0
180
0
0
300
0
0
300
0
0
365
0
0
Distribution-type
Average
Poisson
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
100,00%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
3,33E-01
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Poisson
4.1.2 - train derailment involving dangerous goods vehicle carrying lpg resulting in small release no
ignition
0
1
3
10
30
100
300
Fatalities passengers
Distribution-type
Average
Poisson
0
100,00%
0
0
100,00%
0
0
0
0
1
0
0
1
7,67%
0
0
3
0
0
7
0,33%
0
0
10
0
0
14
0
0
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
100,00%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
4,17E-01
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Poisson
Operational Risk Analysis
Work in Progress
160/178
160
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
4.1.3 - train derailment involving dangerous goods vehicle carrying lpg resulting in small
releasedelayed ignition leading to a explosion
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type
Average
Poisson
0
100,00%
0
0
38,67%
0
0
0
0
1
36,74%
0
0
3
22,98%
0
0
10
1,61%
0
0
30
0,00%
0
0
100
0
0
180
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0,95
3,67E-01 6,89E-01 1,61E-01 1,79E-07
1
7,67%
7
0,33%
14
0
0
30
0
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
0
0
0
0
0
0
1
0
0
1
0
0
0
7
0
0
3
0
0
0
14
0
0
10
0
0
0
30
0
0
30
0
0
0
180
0
0
100
0
100,00%
1,00E+09
365
51,39%
1,88E+02
300
100,00%
Distribution-type
Average
Poisson
5,00E+08
Disruption road
Distribution-type
Average
Poisson
3,65E+02
Fatalities road
2,15E+02
0
0
0
0
0
0
3,00E+02
4.1.5 - train derailment involving dangerous goods vehicle carrying lpg small release resulting in
immediate ignition leading to bleve
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
Distribution-type
Average
Poisson
0
100,00%
0
0
38,67%
0
0
0
0
1
36,74%
0
0
3
22,98%
0
0
10
1,61%
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0,95
3,67E-01 6,89E-01 1,61E-01 1,79E-07
1
7,67%
7
0,33%
14
0
0
30
0
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
0
0
0
0
0
0
0
1
0
0
1
0
0
0
0
7
0
0
3
0
0
100,00%
1,00E+06
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
51,39%
1,88E+02
300
100,00%
3,00E+02
Distribution-type
Average
Poisson
5,00E+05
Disruption road
Distribution-type
Average
Poisson
3,65E+02
Fatalities road
Distribution-type
Average
Poisson
2,15E+02
Operational Risk Analysis
Work in Progress
161/178
161
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
4.1.7 - train derailment involving dangerous goods vehicle carrying lpg resulting in medium release,
no immediate ignition leading to no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
0
100,00%
0
0
100,00%
0
0
0
0
1
0
0
1
7,67%
0
0
3
0
0
7
0,33%
0
0
10
0
0
14
0
0
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
100,00%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
4,17E-01
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Poisson
4.1.8 - train derailment involving dangerous goods vehicle carrying lpg resulting in medium release
no immediate ignition leading to delayed ignition and explosion
0
1
3
10
30
100
300
Fatalities passengers
Distribution-type
Average
Poisson
0
100,00%
0
0
38,67%
0
0
0
0
1
36,74%
0
0
3
22,98%
0
0
10
1,61%
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0,95
3,67E-01 6,89E-01 1,61E-01 1,79E-07
1
7,67%
7
0,33%
14
0
0
30
0
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
100,00%
1,00E+03
0
0
0
0
0
0
0
0
1
0
0
1
0
0
0
0
7
0
0
3
0
0
0
0
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
51,39%
1,88E+02
300
100,00%
3,00E+02
Distribution-type
Average
Poisson
1,00E-02
Disruption road
Distribution-type
Average
Poisson
3,65E+02
Fatalities road
Distribution-type
Average
Poisson
2,15E+02
Operational Risk Analysis
Work in Progress
162/178
162
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
4.1.10 - train derailment involving dangerous goods vehicle carrying lpg resulting in medium
release, immediate ignition and bleve
Fatalities passengers
0
1
3
10
30
100
300
0
0
300
0
0
365
0
0
Distribution-type
Average
Poisson
0
100,00%
0
0
38,67%
0
0
0
0
1
36,74%
0
0
3
22,98%
0
0
10
1,61%
0
0
30
0,00%
0
0
100
0
0
180
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0,95
3,67E-01 6,89E-01 1,61E-01 1,79E-07
1
7,67%
7
0,33%
14
0
0
30
0
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
100,00%
1,00E+03
0
0
0
0
0
0
0
1
0
0
1
0
0
0
7
0
0
3
0
0
0
14
0
0
10
0
0
0
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
51,39%
1,88E+02
300
100,00%
Distribution-type
Average
Poisson
1,00E-01
Disruption road
Distribution-type
Average
Poisson
3,65E+02
Fatalities road
2,15E+02
0
0
0
0
0
0
3,00E+02
4.1.12 - train derailment involving dangerous goods vehicle carrying lpg resulting in large release
leading to no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
Distribution-type
Average
Poisson
0
100,00%
0
0
100,00%
0
0
0
0
1
0
0
1
7,67%
0
0
3
0
0
7
0,33%
0
0
10
0
0
14
0
0
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
100,00%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
4,17E-01
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Poisson
Operational Risk Analysis
Work in Progress
163/178
163
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
4.1.13 - train derailment involving dangerous goods vehicle carrying lpg resulting inlarge release,
no immediate ignition leading to delayed ignition and explosion
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
0
100,00%
0
0
38,67%
0
0
0
0
1
36,74%
0
0
3
22,98%
0
0
10
1,61%
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0,95
3,67E-01 6,89E-01 1,61E-01 1,79E-07
1
7,67%
7
0,33%
14
0
0
30
0
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
100,00%
1,00E+03
0
0
0
0
0
0
0
0
1
0
0
1
0
0
0
0
7
0
0
3
0
0
0
0
14
0
0
10
0
0
0
0
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
51,39%
1,88E+02
300
100,00%
3,00E+02
Distribution-type
Average
Poisson
5,00E+00
Disruption road
Distribution-type
Average
Poisson
3,65E+02
Fatalities road
Distribution-type
Average
Poisson
2,15E+02
Operational Risk Analysis
Work in Progress
164/178
164
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
4.2.1 - train derailment involving dangerous goods vehicle carrying ammonia resulting in no release
Fatalities passengers
0
100,00%
0
0
100,00%
0
0
1
0
0
1
0
0
1
7,67%
3
0
0
3
0
0
7
0,33%
10
0
0
10
0
0
14
0
0
30
0
0
30
0
0
30
0
0
100
0
0
100
0
0
180
0
0
300
0
0
300
0
0
365
0
0
Distribution-type
Average
Poisson
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
100,00%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
3,33E-01
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Poisson
4.2.2 - train derailment involving dangerous goods vehicle carrying ammonia resulting in small
release
0
1
3
10
30
100
300
Fatalities passengers
Distribution-type
Average
Poisson
0
100,00%
0
0
100,00%
0
0
0
0
1
0
0
1
7,67%
0
0
3
0
0
7
0,33%
0
0
10
0
0
14
0
0
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
100,00%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
4,17E-01
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Poisson
Operational Risk Analysis
Work in Progress
165/178
165
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
4.2.3 - train derailment involving dangerous goods vehicle carrying ammonia resulting in medium
release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
0
100,00%
0
0
77,88%
0
0
0
0
1
19,47%
0
0
3
2,64%
0
0
10
0,01%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0,25
1,95E-01 7,91E-02 1,33E-03
1
7,67%
7
0,33%
14
0
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
100,00%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
4,17E-01
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Poisson
4.2.4 - train derailment involving dangerous goods vehicle carrying ammonia resulting in large
release
0
1
3
10
30
100
300
Fatalities passengers
Distribution-type
Average
Poisson
0
100,00%
0
0
68,73%
0
0
0
0
1
25,77%
0
0
3
5,44%
0
0
10
0,06%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0,375
2,58E-01 1,63E-01 6,12E-03
1
7,67%
7
0,33%
14
0
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
100,00%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
4,17E-01
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Poisson
Operational Risk Analysis
Work in Progress
166/178
166
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
4.3.1 - train derailment involving dangerous goods vehicle carrying ammonia resulting in no release
Fatalities passengers
0
100,00%
0
0
100,00%
0
0
1
0
0
1
0
0
1
7,67%
3
0
0
3
0
0
7
0,33%
10
0
0
10
0
0
14
0
0
30
0
0
30
0
0
30
0
0
100
0
0
100
0
0
180
0
0
300
0
0
300
0
0
365
0
0
Distribution-type
Average
Poisson
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
100,00%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
3,33E-01
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Poisson
4.3.2 - train derailment involving dangerous goods vehicle carrying ammonia resulting in small
release
0
1
3
10
30
100
300
Fatalities passengers
Distribution-type
Average
Poisson
0
100,00%
0
0
100,00%
0
0
0
0
1
0
0
1
7,67%
0
0
3
0
0
7
0,33%
0
0
10
0
0
14
0
0
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
100,00%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
4,17E-01
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Poisson
Operational Risk Analysis
Work in Progress
167/178
167
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
4.3.3 - train derailment involving dangerous goods vehicle carrying ammonia resulting in medium
release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
0
100,00%
0
0
77,88%
0
0
0
0
1
19,47%
0
0
3
2,64%
0
0
10
0,01%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0,25
1,95E-01 7,91E-02 1,33E-03
1
7,67%
7
0,33%
14
0
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
100,00%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
4,17E-01
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Poisson
4.3.4 - train derailment involving dangerous goods vehicle carrying ammonia resulting in large
release
0
1
3
10
30
100
300
Fatalities passengers
Distribution-type
Average
Poisson
0
100,00%
0
0
68,73%
0
0
0
0
1
25,77%
0
0
3
5,44%
0
0
10
0,06%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0,375
2,58E-01 1,63E-01 6,12E-03
1
7,67%
7
0,33%
14
0
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
100,00%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
4,17E-01
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Poisson
Operational Risk Analysis
Work in Progress
168/178
168
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
4.4.1 - train derailment involving dangerous goods vehicle carrying acids resulting in no release
Fatalities passengers
0
100,00%
0
0
100,00%
0
0
1
0
0
1
0
0
1
36,79%
3
0
0
3
0
0
7
26,42%
10
0
0
10
0
0
14
0,00%
30
0
0
30
0
0
30
0
0
100
0
0
100
0
0
180
0
0
300
0
0
300
0
0
365
0
0
Distribution-type
Average
Poisson
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0
Distribution-type
Average
Poisson
1,00E+00
36,79%
0
3,68E-01 1,85E+00 1,43E-04
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
100,00%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
3,33E-01
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Poisson
4.4.2 - train derailment involving dangerous goods vehicle carrying acids resulting in small release
Fatalities passengers
0
100,00%
0
0
100,00%
0
0
1
0
0
1
0
0
1
0
0
3
0
0
3
0
0
7
0
0
10
0
0
10
0
0
14
0
0
30
0
0
30
0
0
30
0
0
100
0
0
100
0
0
180
0
0
300
0
0
300
0
0
365
0
0
Distribution-type
Average
Poisson
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0
Distribution-type
Average
Poisson
0
100,00%
0
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
100,00%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
4,17E-01
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Poisson
Operational Risk Analysis
Work in Progress
169/178
169
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
4.4.3 - train derailment involving dangerous goods vehicle carrying acids resulting in medium
release
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
0
100,00%
0
0
100,00%
0
0
0
0
1
0
0
1
7,67%
0
0
3
0
0
7
0,33%
0
0
10
0
0
14
0
0
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0
Distribution-type
Average
Poisson
8,33E-02
92,00%
0
7,67E-02 2,30E-02
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
100,00%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
4,17E-01
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Poisson
4.4.4 - train derailment involving dangerous goods vehicle carrying acids resulting in large release
Fatalities passengers
0
100,00%
0
0
100,00%
0
0
1
0
0
1
0
0
1
36,79%
3
0
0
3
0
0
7
26,42%
10
0
0
10
0
0
14
0,00%
30
0
0
30
0
0
30
0
0
100
0
0
100
0
0
180
0
0
300
0
0
300
0
0
365
0
0
Distribution-type
Average
Poisson
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0
Distribution-type
Average
Poisson
1,00E+00
36,79%
0
3,68E-01 1,85E+00 1,43E-04
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
100,00%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
4,17E-01
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Poisson
Operational Risk Analysis
Work in Progress
170/178
170
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
4.5.1 - train derailment involving dangerous goods vehicle carrying flammable liquids resulting in no
release of heptane
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
0
100,00%
0
0
100,00%
0
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0
0
0
0
10
0
0
14
0
0
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0
Distribution-type
Average
Poisson
0
100,00%
0
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
71,65%
0
0
100,00%
0
0
0
0
1
23,88%
0
0
7
4,46%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
3,33E-01
2,39E-01 3,12E-01 3,94E-08
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Poisson
4.5.2 - train derailment involving dangerous goods vehicle carrying flammable liquids resulting in
small release no ignition
0
1
3
10
30
100
300
Fatalities passengers
Distribution-type
Average
Poisson
0
100,00%
0
0
100,00%
0
0
0
0
1
0
0
1
36,79%
0
0
3
0
0
7
26,42%
0
0
10
0
0
14
0,00%
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0
Distribution-type
Average
Poisson
1,00E+00
36,79%
0
3,68E-01 1,85E+00 1,43E-04
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
100,00%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
4,17E-01
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Poisson
Operational Risk Analysis
Work in Progress
171/178
171
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
4.5.3 - train derailment involving dangerous goods vehicle carrying flammable liquids resulting in
small release ignition leading to a bleve
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
0
100,00%
0
0
38,67%
0
0
0
0
1
36,74%
0
0
3
22,98%
0
0
10
1,61%
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0,95
3,67E-01 6,89E-01 1,61E-01 1,79E-07
1
36,79%
7
26,42%
14
0,00%
30
0
0
Distribution-type
Average
Poisson
1,00E+00
36,79%
0
3,68E-01 1,85E+00 1,43E-04
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
100,00%
1,00E+03
0
0
0
0
0
0
0
1
0
0
1
0
0
0
7
0
0
3
0
0
0
14
0
0
10
0
0
0
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
51,39%
1,88E+02
300
100,00%
0
Distribution-type
Average
Poisson
Disruption road
Distribution-type
Average
Poisson
3,65E+02
Fatalities road
2,15E+02
0
0
0
0
0
0
3,00E+02
4.5.5 - train derailment involving dangerous goods vehicle carrying flammable liquids resulting in
medium release leading to no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
Distribution-type
Average
Poisson
0
100,00%
0
0
100,00%
0
0
0
0
1
0
0
1
0
0
0
0
3
0
0
7
0
0
0
0
10
0
0
14
0
0
0
0
30
0
0
30
0
0
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0
Distribution-type
Average
Poisson
0
100,00%
0
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
100,00%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
4,17E-01
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Poisson
Operational Risk Analysis
Work in Progress
172/178
172
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
4.5.6 - train derailment involving dangerous goods vehicle carrying flammable liquids resulting in
medium release leading to ignition and bleve
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
0
100,00%
0
0
38,67%
0
0
0
0
1
36,74%
0
0
3
22,98%
0
0
10
1,61%
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
51,39%
1,88E+02
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0,95
3,67E-01 6,89E-01 1,61E-01 1,79E-07
1
0
0
7
0
0
14
0
0
30
0
0
Distribution-type
Average
Poisson
3,65E+02
0
0
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
100,00%
1,00E+03
0
0
0
0
0
0
0
1
0
0
1
0
0
0
7
0
0
3
0
0
0
14
0
0
10
0
0
0
30
0
0
30
0
0
0
180
0
0
100
0
0
0
365
51,39%
1,88E+02
300
100,00%
0
Distribution-type
Average
Poisson
Disruption road
Distribution-type
Average
Poisson
3,65E+02
Fatalities road
2,15E+02
0
0
0
0
0
0
3,00E+02
4.5.8 - train derailment involving dangerous goods vehicle carrying flammable liquids resulting in
large release leading to no ignition
Fatalities passengers
0
1
3
10
30
100
300
Distribution-type
Average
Poisson
Distribution-type
Average
Poisson
0
100,00%
0
0
100,00%
0
0
0
0
1
0
0
1
14,94%
0
0
3
0
0
7
78,89%
0
0
10
0
0
14
1,19%
0
0
30
0
0
30
0,00%
0
0
100
0
0
180
0
0
0
0
300
0
0
365
0
0
Fatalities employees
Distribution-type
Average
Disruption
Poisson
0
Distribution-type
Average
Poisson
3,00E+00
4,98%
0
1,49E-01 5,52E+00 1,67E-01 2,01E-05
Repair costs
1,00E+03 1,00E+04 1,00E+05 1,00E+06 1,00E+07 1,00E+08 1,00E+09
0
0
0
65,92%
0
0
100,00%
0
0
0
0
1
27,47%
0
0
7
6,61%
0
0
14
0,00%
100,00%
1,00E+07
30
0
0
30
0
0
0
0
180
0
0
100
0
0
0
0
365
0
0
300
0
0
Distribution-type
Average
Poisson
5,00E+06
Disruption road
Distribution-type
Average
Poisson
4,17E-01
2,75E-01 4,63E-01 2,18E-07
1
0
0
3
0
0
10
0
0
Fatalities road
Distribution-type
Average
Poisson
Operational Risk Analysis
Work in Progress
173/178
173
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
12.12 Fire rail
Fatalities passengers
Scenario
5.1.1
5.1.2
5.1.3
5.1.4
5.1.5
5.1.6
5.1.7
5.1.8
5.1.9
5.1.10
5.1.11
5.1.12
5.2.1
5.2.2
5.2.3
5.3.1
5.3.2
5.3.3
5.3.4
5.4.1
5.4.2
5.4.3
5.5.1
5.5.2
5.5.3
5.5.4
5.6.1
5.6.2
5.6.3
0
1,00E+00
1,00E+00
1,00E+00
1,00E+00
1,00E+00
1,00E+00
1,00E+00
1,00E+00
9,63E-01
9,63E-01
9,63E-01
9,63E-01
1,00E+00
1,00E+00
1,00E+00
1,00E+00
1,00E+00
1,00E+00
1,00E+00
1,00E+00
1,00E+00
1,00E+00
1,00E+00
1,00E+00
9,98E-01
9,98E-01
1,00E+00
1,00E+00
1,00E+00
1
0
0
0
0
0
0
0
0
3,59E-02
3,59E-02
3,59E-02
3,59E-02
0
0
0
0
0
1,00E-04
1,00E-04
0
0
0
0
0
1,99E-03
1,99E-03
0
0
0
3
0
0
0
0
0
0
0
0
6,91E-04
6,91E-04
6,91E-04
6,91E-04
0
0
0
0
0
5,00E-09
5,00E-09
0
0
0
0
0
2,00E-06
2,00E-06
0
0
0
10
0
0
0
0
0
0
0
0
8,28E-08
8,28E-08
8,28E-08
8,28E-08
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
30
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
100
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
300
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
0
Mean
0
0
0
0
0
0
0
0
3,80E-02
3,80E-02
3,80E-02
3,80E-02
0
0
0
0
0
1,00E-04
1,00E-04
0
0
0
0
0
2,00E-03
2,00E-03
0
0
0
Operational Risk Analysis
Work in Progress
174/178
174
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Fatalities employees
Scenario
5.1.1
5.1.2
5.1.3
5.1.4
5.1.5
5.1.6
5.1.7
5.1.8
5.1.9
5.1.10
5.1.11
5.1.12
5.2.1
5.2.2
5.2.3
5.3.1
5.3.2
5.3.3
5.3.4
5.4.1
5.4.2
5.4.3
5.5.1
5.5.2
5.5.3
5.5.4
5.6.1
5.6.2
5.6.3
0
1,00000
1,00000
1,00000
1,00000
1,00000
1,00000
1,00000
1,00000
0,99923
0,99923
0,99923
0,99923
1,00000
1,00000
1,00000
1,00000
1,00000
1,00000
1,00000
1,00000
1,00000
1,00000
1,00000
1,00000
0,99996
0,99996
1,00000
1,00000
1,00000
1
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00076
0,00076
0,00076
0,00076
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00004
0,00004
0,00000
0,00000
0,00000
3
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00001
0,00001
0,00001
0,00001
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
10
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
30
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
100
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
300
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
0,00000
Mean
0
0
0
0
0
0
0
0
8,00E-04
8,00E-04
8,00E-04
8,00E-04
0
0
0
0
0
2,11E-06
2,11E-06
0
0
0
0
0
4,21E-05
4,21E-05
0
0
0
Operational Risk Analysis
Work in Progress
175/178
175
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
Repair costs
Fire size
1
2,5
8
15
20
30
50
200
350
Repair costs [Euro] - fire inside enclosed tunnel
1,00E+03 1,00E+04 1,00E+05 1,00E+06
1,00E+07
1,00E+08
8,61E-01 1,39E-01 1,26E-09
0
0
0
7,33E-04 9,54E-01 4,52E-02
0
0
0
0
6,42E-04 9,50E-01 4,90E-02
0
0
0
1,01E-06 5,49E-01 4,51E-01
2,92E-07
0
0
0
1,12E-01 8,88E-01
1,26E-04
0
0
0
1,22E-04 8,86E-01
1,14E-01
0
0
0
0
7,56E-05
8,61E-01
1,39E-01
0
0
0
0
1,12E-01
8,88E-01
0
0
0
0
4,01E-04
9,36E-01
1,00E+09
0
0
0
0
0
0
1,26E-09
1,26E-04
6,39E-02
Mean
2.250
14.062
144.000
506.250
900.001
2.024.998
22.499.986
90.000.053
157.500.132
Fire size 1,00E+03 1,00E+04
1
1,00E+00
0
2,5
9,55E-01 4,51E-02
15
1,01E-06 5,49E-01
30
0
1,22E-04
200
0
0
350
0
0
Disruption
Fire size
1
2,5
8
15
20
30
50
200
350
Fire size
1
2,5
8
15
20
30
50
200
350
0
8,38E-01
7,71E-01
7,27E-01
6,60E-01
3,13E-01
2,78E-01
7,48E-01
2,50E-01
2,50E-01
Repair costs [Euro] - fire on landsides
1,00E+05 1,00E+06
1,00E+07
1,00E+08
0
0
0
0
0
0
0
0
4,51E-01 2,92E-07
0
0
8,86E-01 1,14E-01
0
0
0
1,12E-01
8,88E-01
1,26E-04
0
4,01E-04
9,36E-01
6,39E-02
Mean
1,00E+09
0
0
0
0
0
0
1.000
1.406
50.625
202.500
9.000.005
15.750.013
Disruption [days] - fire inside enclosed tunnel
1
7
14
30
1,39E-01 2,30E-02
0
0
1,67E-01 6,18E-02 1,24E-07
0
1,68E-01 1,05E-01 2,21E-06
0
1,46E-01 1,93E-01 7,41E-05
0
1,02E-02 5,01E-01 1,75E-01
9,65E-04
2,09E-04 1,29E-01 5,12E-01
8,09E-02
0
0
1,66E-08
2,93E-03
0
0
0
0
0
0
0
0
Disruption [days] - fire
1
7
3,63E-02 7,67E-04
8,58E-02 5,60E-03
1,28E-01 1,74E-02
1,50E-01 3,21E-02
1,62E-01 4,83E-02
1,69E-01 8,29E-02
1,82E-02 5,34E-01
2,09E-04 1,29E-01
2,09E-04 1,29E-01
- Incident tube
180
365
0
0
0
0
0
0
0
0
0
0
1,62E-07
0
2,50E-01
0
7,50E-01
7,02E-05
7,50E-01
7,02E-05
Mean
0,3
0,6
0,9
1,5
6,0
10,5
45,0
135,0
135,0
0
9,63E-01
9,09E-01
8,55E-01
8,18E-01
7,90E-01
7,48E-01
3,41E-01
2,78E-01
2,78E-01
inside enclosed tunnel - Non incident tube
14
30
180
365
0
0
0
0
0
0
0
0
0
0
0
0
4,06E-09
0
0
0
3,33E-08
0
0
0
6,12E-07
0
0
0
1,06E-01
2,48E-04
0
0
5,12E-01
8,09E-02
1,62E-07
0
5,12E-01
8,09E-02
1,62E-07
0
Mean
0,04
0,13
0,25
0,38
0,50
0,75
5,25
10,50
10,50
Fire size
1
2,5
15
0
8,38E-01
7,71E-01
7,48E-01
1
1,39E-01
1,67E-01
1,69E-01
Disruption [days] - fire on landsides
7
14
30
180
2,30E-02
0
0
0
6,18E-02 1,24E-07
0
0
8,29E-02 6,12E-07
0
0
365
0
0
0
Mean
0,30
0,60
0,75
Operational Risk Analysis
Work in Progress
176/178
176
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
13. REFERENCES
[1]
[2]
[3]
[4]
[5]
[6]
[7]
[8]
RAT 64233-001-6 ORA, ORA
Accident Frequencies, June 2014
RAT 64232-002-0 ORA Hazard Identification, October 2009
RAT 64235-001-1 ORA - Design Report, November 2010
RAT 64231-001-2 ORA Risk Management Plan, January 2010
Interactive Traffic Statistics, Statistics from Danish Road Directorate (VIS)
RAT 532-055-0 The case for suppression, December 2009
Pedestrian Simulation Software, www.legion.com
Fehmarnbelt Fixed Link. Conditions in the Fehmarnbelt. Risk Assessment. Femern Bælt A/S
September 2010
Fehmarn Vessel Traffic Prognosis, Rogge Marine Consulting G.M.B.H., RMC 720801, July 2008
[9]
[10]
Risk Evaluation Criteria,
SAFEDOR 2005. Revision 3, 2007
[11]
Transportøkonomiske Enhedspriser - til brug for samfundsøkonomiske analyser,
version 1,
2. August 2009. Institut for Transport, DTU.
http://www.dtu.dk/upload/institutter/dtu%20transport/modelcenter/transportoekonomiske%20enhedspriser/transpo
rtoekonomiske%20enhedspriser%20vers%201%202%20aug09.xls
[12]
Finansiel Analyse, Fast Forbindelse over Femern Bælt,
Udarbejdet af Femern Bælt A/S for
Transportministeriet, September 2008.
[13] 931100-ST085.0114-001,”
The Øresund Link
- Operational Risk Analysis
ORA-2008”,
December 2008
[14] 931100-ST084.0101-001,”
Risk Assessment of Ordinary Road and Railway Accidents”.
[15] RAT-1311-010-2, Conceptual Design Technical Report, November 2010
[16] RAT 6724-001-1 Fehmarnbelt Fixed Link Conceptual Fire safety Strategy for the Tunnel,
September 2013
[17] QRA Pro, Taylor Associates ApS, 2011.
[18] DNV Technica, Technical Note on Human Impact Criteria, 2001.
[19] RAT 6721-001-0 Safety and Rescue Plan, March 2010
[20] RAT 537-001-0 Maintenance Analysis, March 2010
[21] RAV 511-007-1 Timetable Technical Note
[22] Commission Decision of 23 April 2012 on the second set of common safety targets as regards
the rail system, (2012/226/EU)
[23] RAT 542-027 1 Design Water Levels, 2009/10/29
[24] ATKINS; RAM requirements
Tunnel, Railway Infrastructure in Tunnel, May 2012
Operational Risk Analysis
Work in Progress
177/178
177
TRU, Alm.del - 2014-15 (1. samling) - Endeligt svar på spørgsmål 287: Spm. om der er udarbejdet en risikoanalyse med henblik på en brand i den kommende Femern Bælt-tunnel, og i bekræftende fald bedes den sendt til udvalget, til transportministeren
FEHMARNBELT FIXED LINK
TUNNEL DESIGN SERVICES
[25] COMMISSION REGULATION (EC) No 352/2009 of 24 April 2009 on the adoption of a common
safety method on risk evaluation and assessment as referred to in Article 6(3)(a) of Directive
2004/49/EC of the European Parliament and of the Council
[26] Guide for the application of the Commission Regulation on CSM on risk assessment
[27] Reference year for the traffic forecast, Femern Memo, SSI, 19 oct 2011
[28] RAT 64238-001-5 Risk Acceptance Criteria, June 2014
[29] Fatalities versus FWSI, LSC, 5 March 2014
[30] Commission Decision of 5 June 2012 on the adoption of a common safety method for
assessment of achievement of safety targets, (2009/460/EU)
[31] Fehmarn Fixed Link, Management of Railway Hazards, Appendix B
Risk Evaluation
Criteria, rev. 0 2012.07.03
[32] European Union Rail System
– TSI “Safety In Railway Tunnels”, version 4, 18/12/2012
[33] Railway Hazard Identification Workshops:
i.
Workshop 1, considering normal operation, February 2010.
ii.
Workshop 2, considering operation under fall-back procedures 9 March 2010,
(responsible for 1 & 2: ATKINS)
iii.
Workshop 3, considering Operation and Human Factor-issue, 7 November 2013,
(responsible: LSC and Railway Dept.)
[34] European Railway Accident Information Links, http://erail.era.europa.eu/investigations.aspx,
2013-08-01
[35] Railway Tunnel Safety
Risk Analysis of Emergency Scenarios, Conclusive Report RAT 6729-
321-3
[36]
RAT 64236-001-2 Dangerous Goods forecast, June 2014
Operational Risk Analysis
Work in Progress
178/178
178
